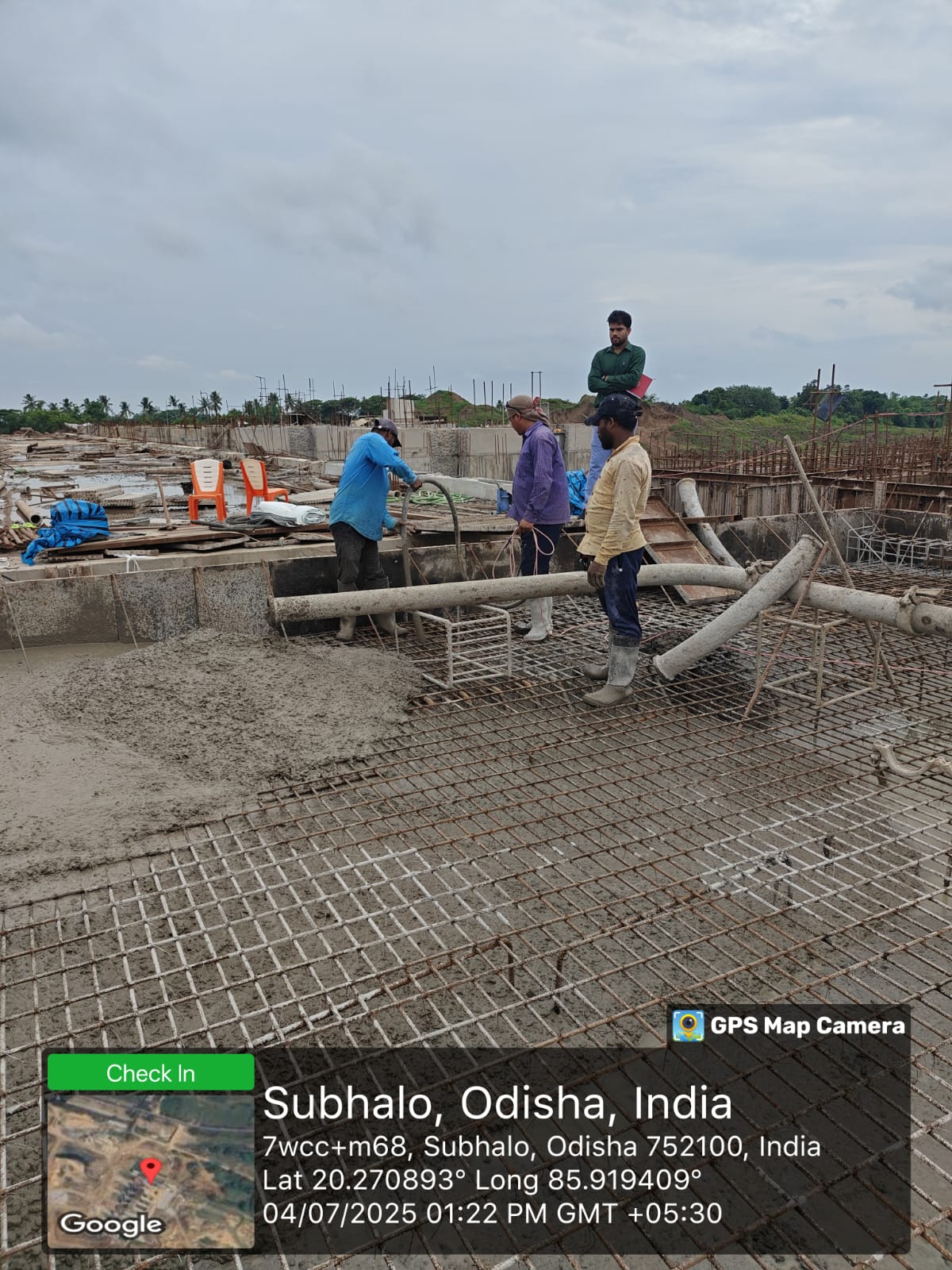

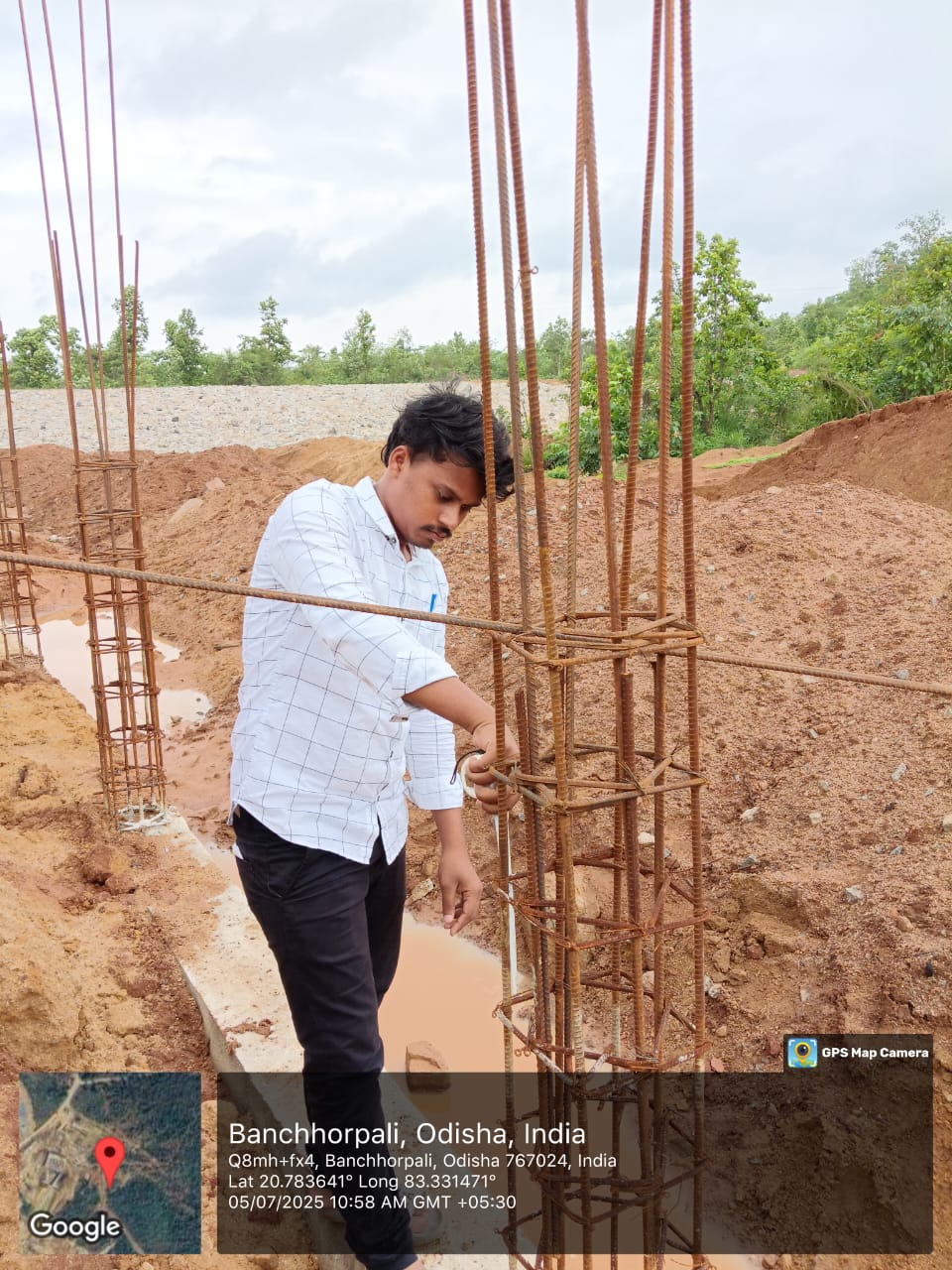

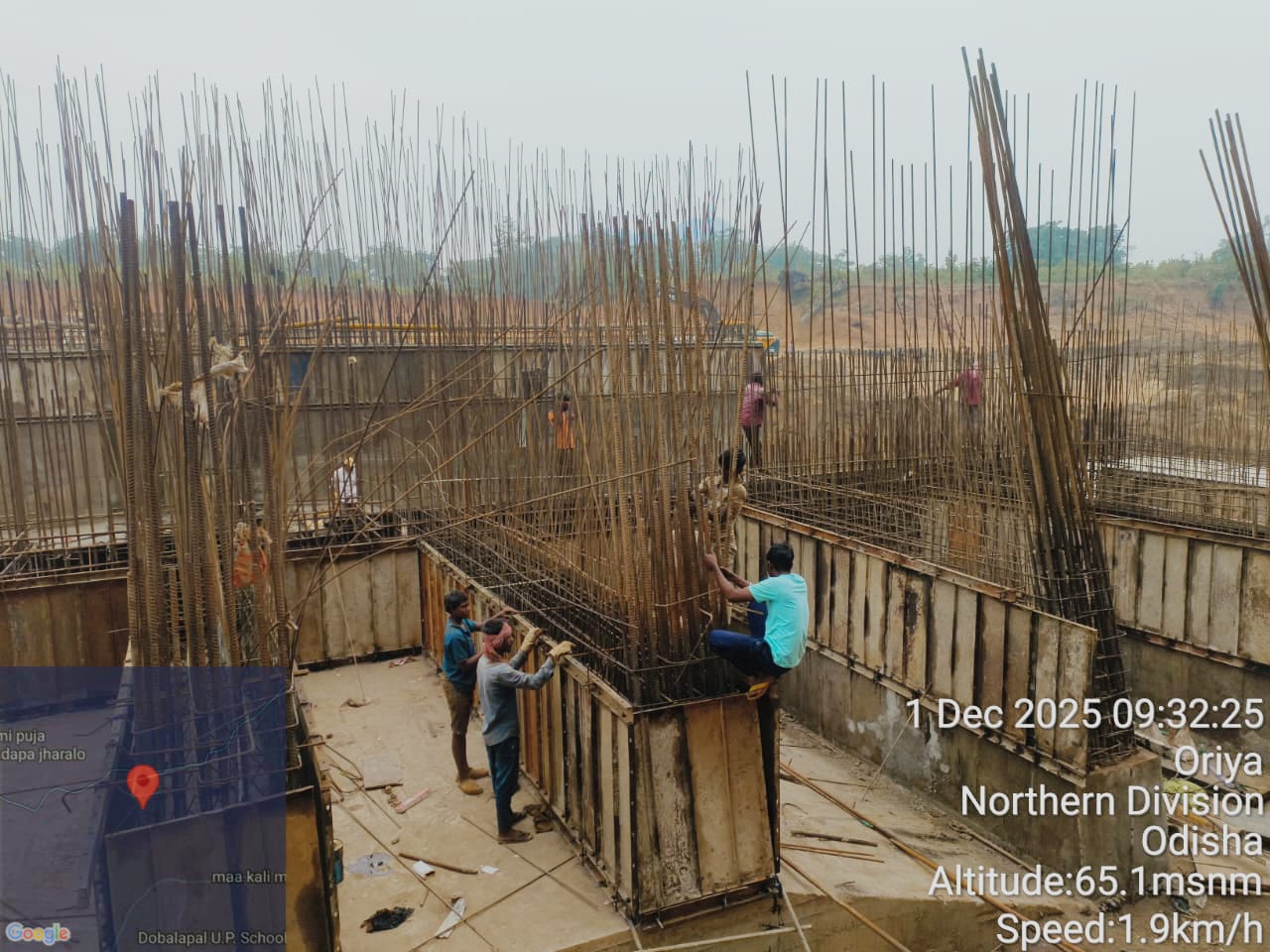

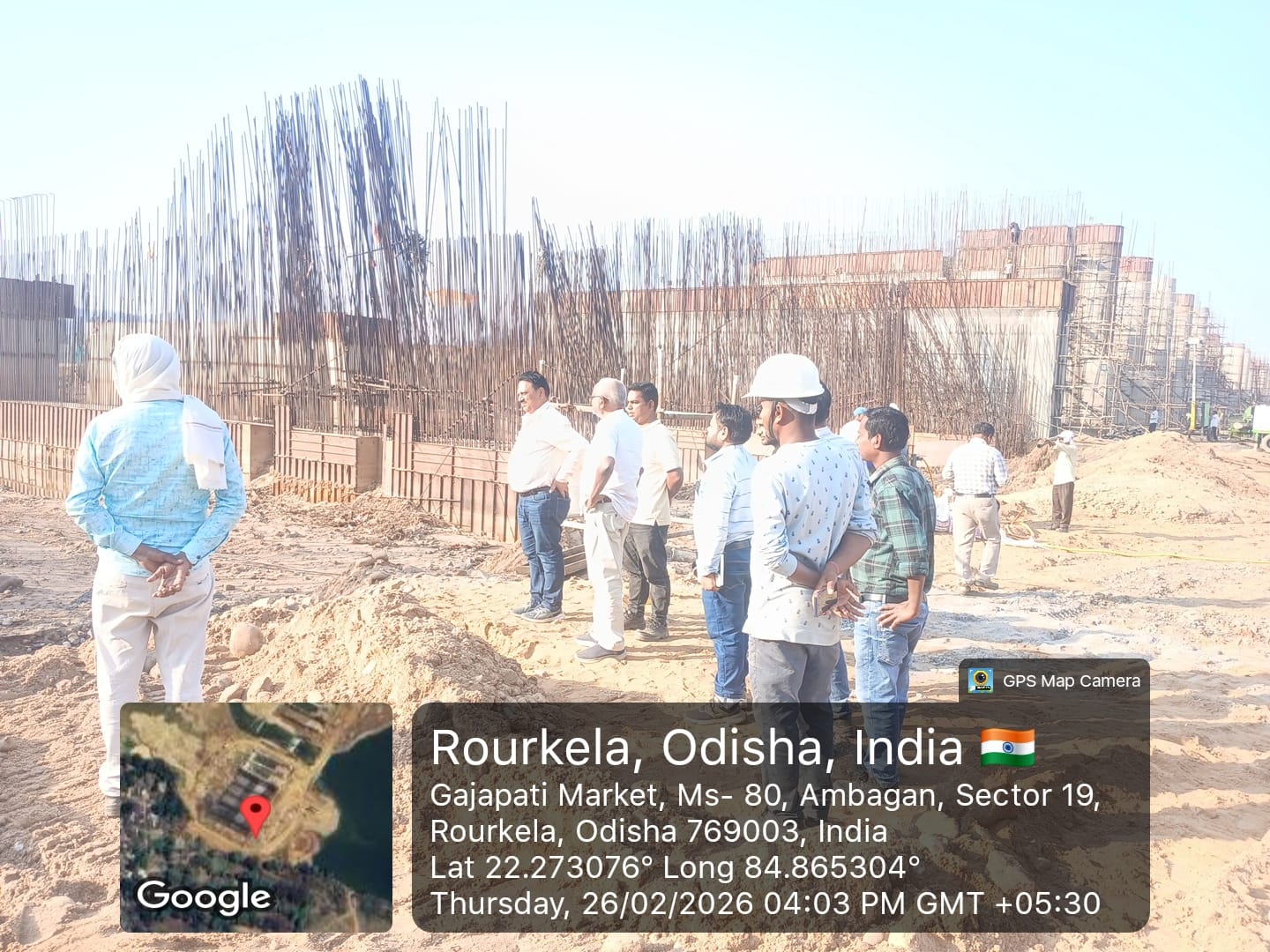

GOVERNMENT OF ODISHA

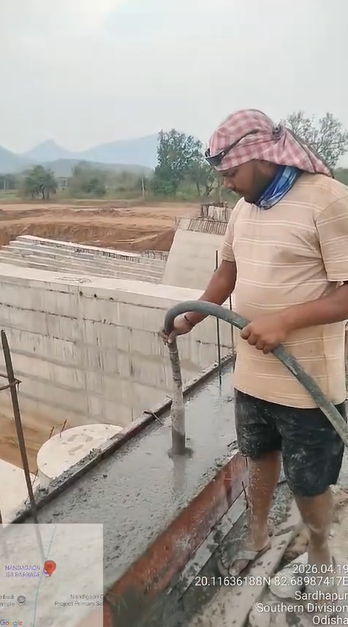

DEPARTMENT OF WATER RESOURCES

PMIS for ISS/MMIPs/UGPL Projects

Total No of Schemes – 53 nos ( ISS-46, MMIPs-6, UGPL-1 )

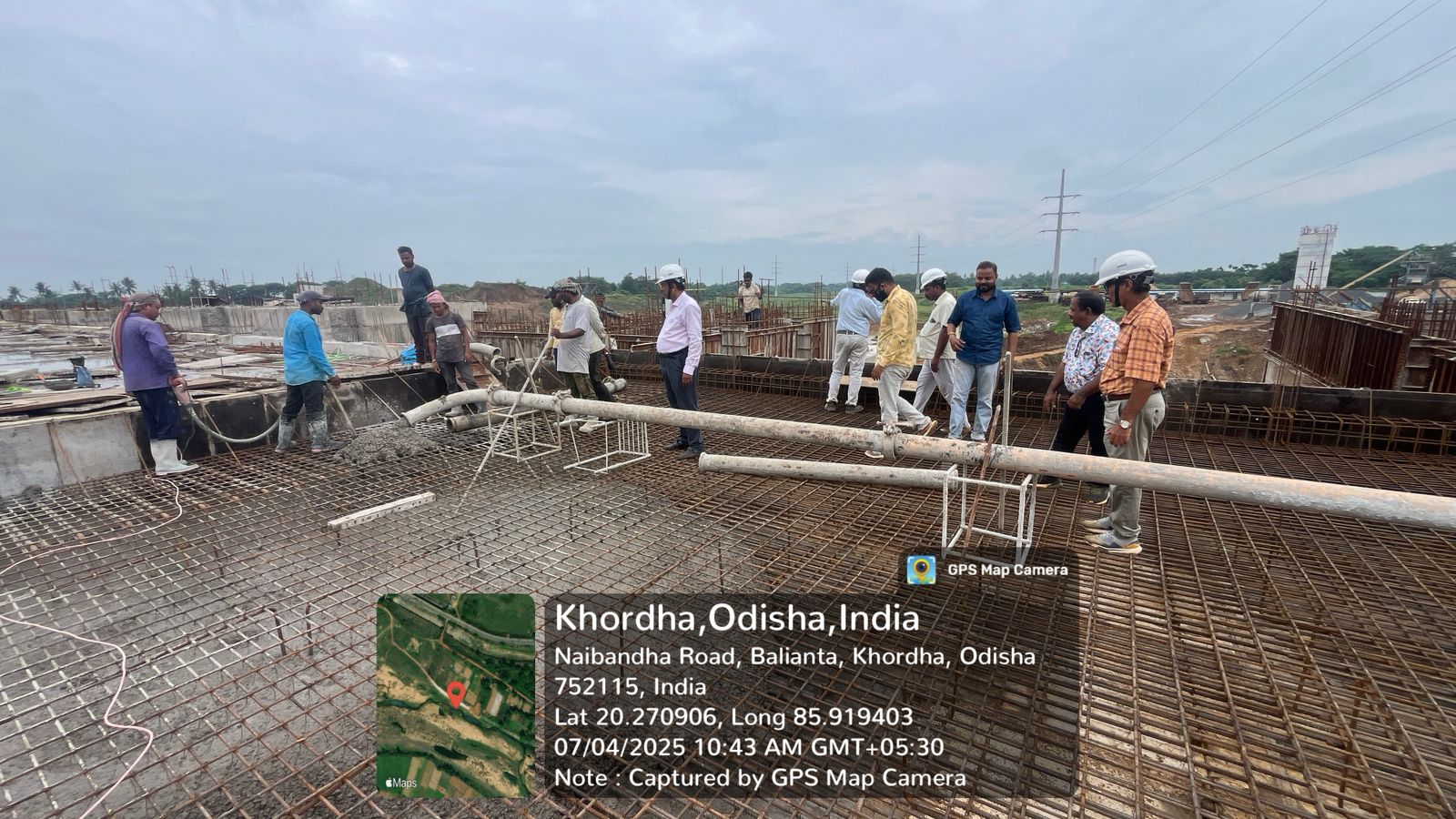

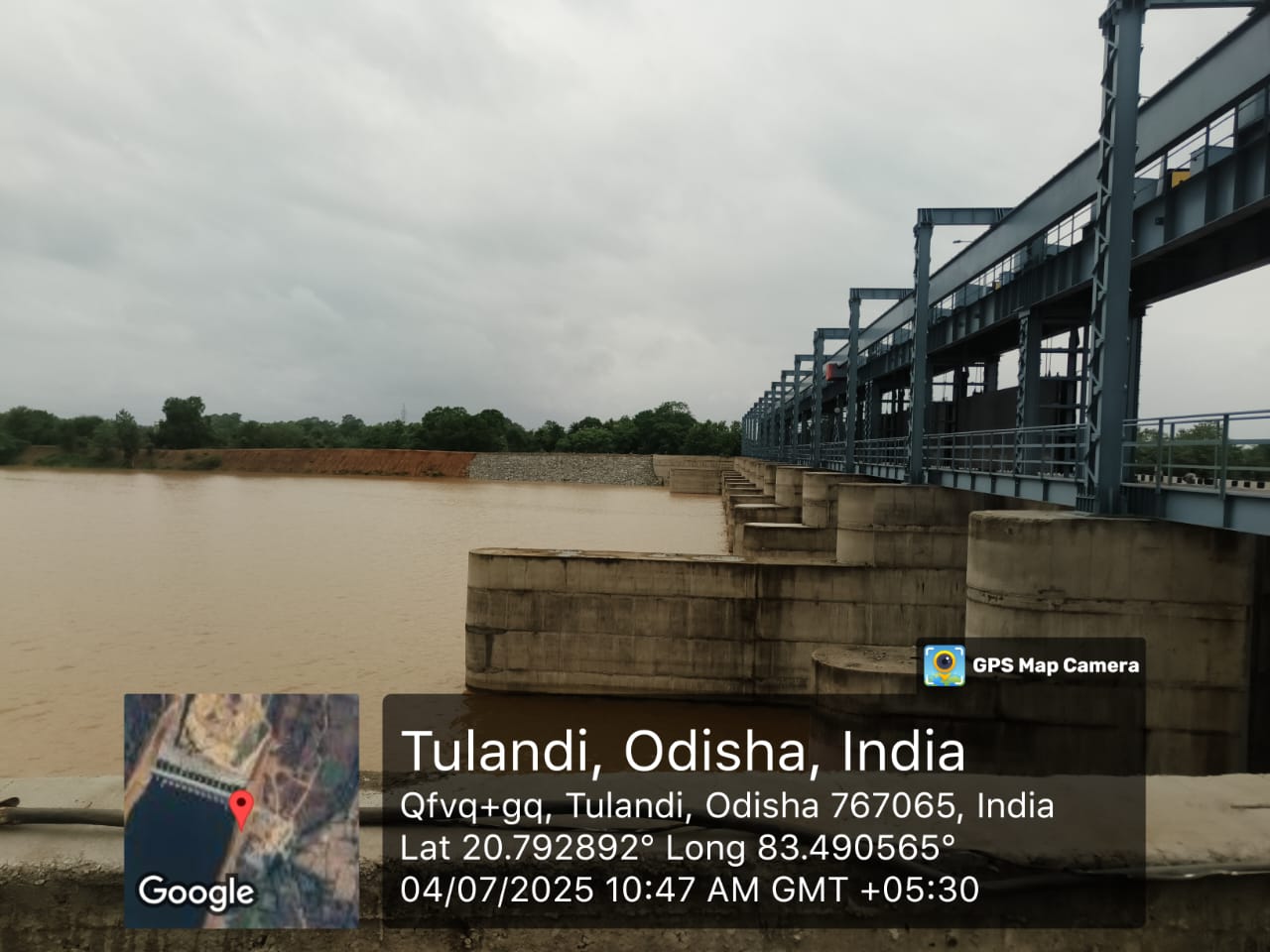

1/100

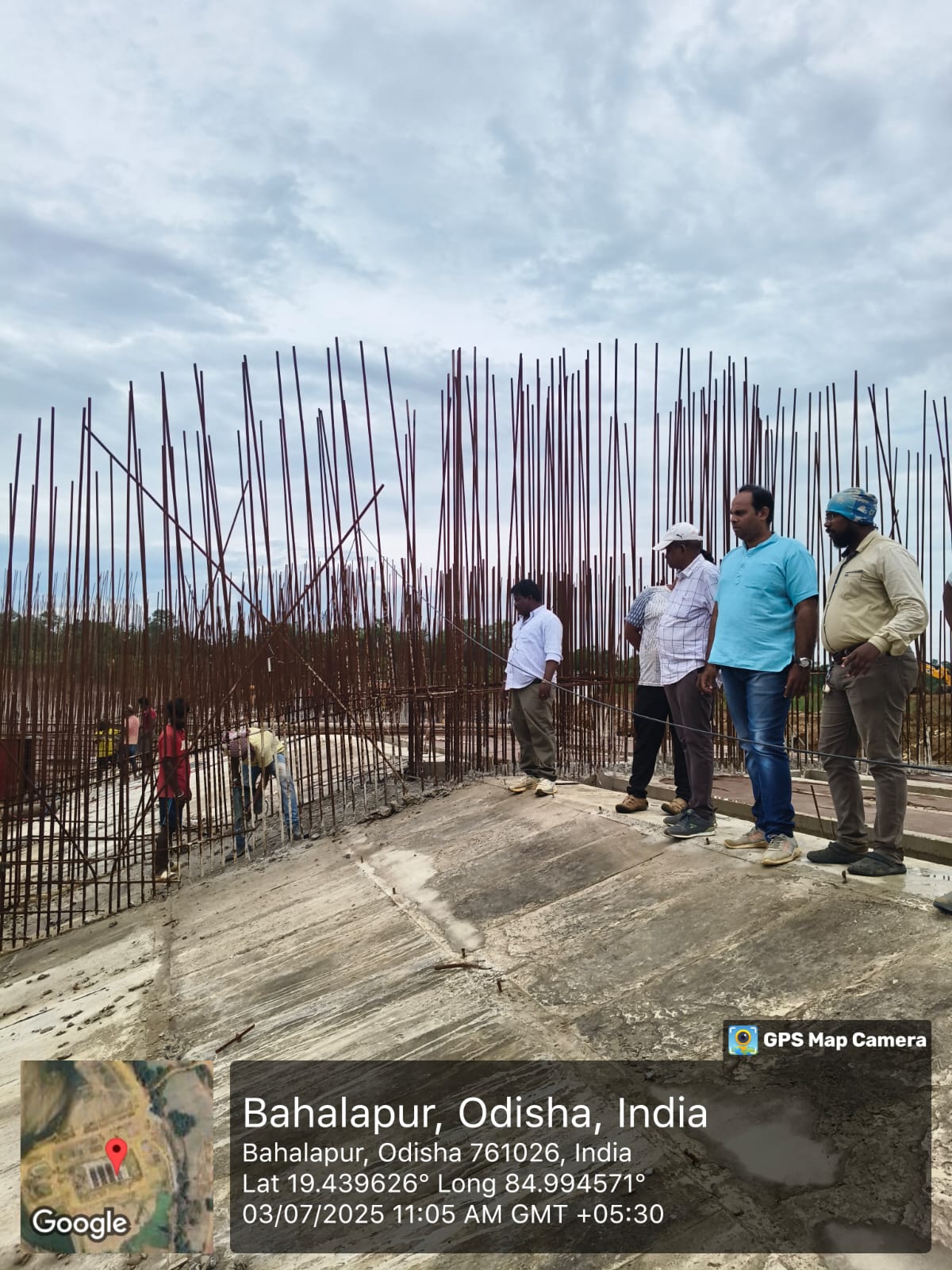

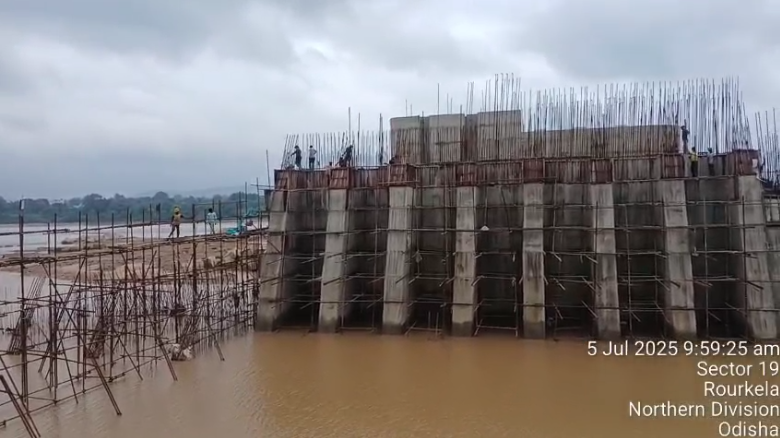

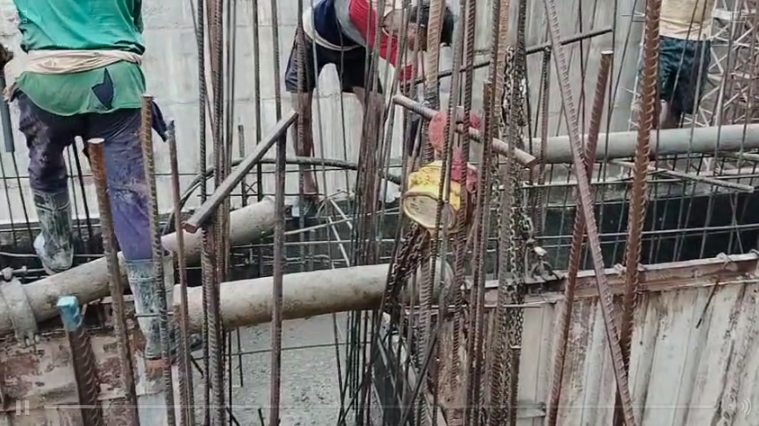

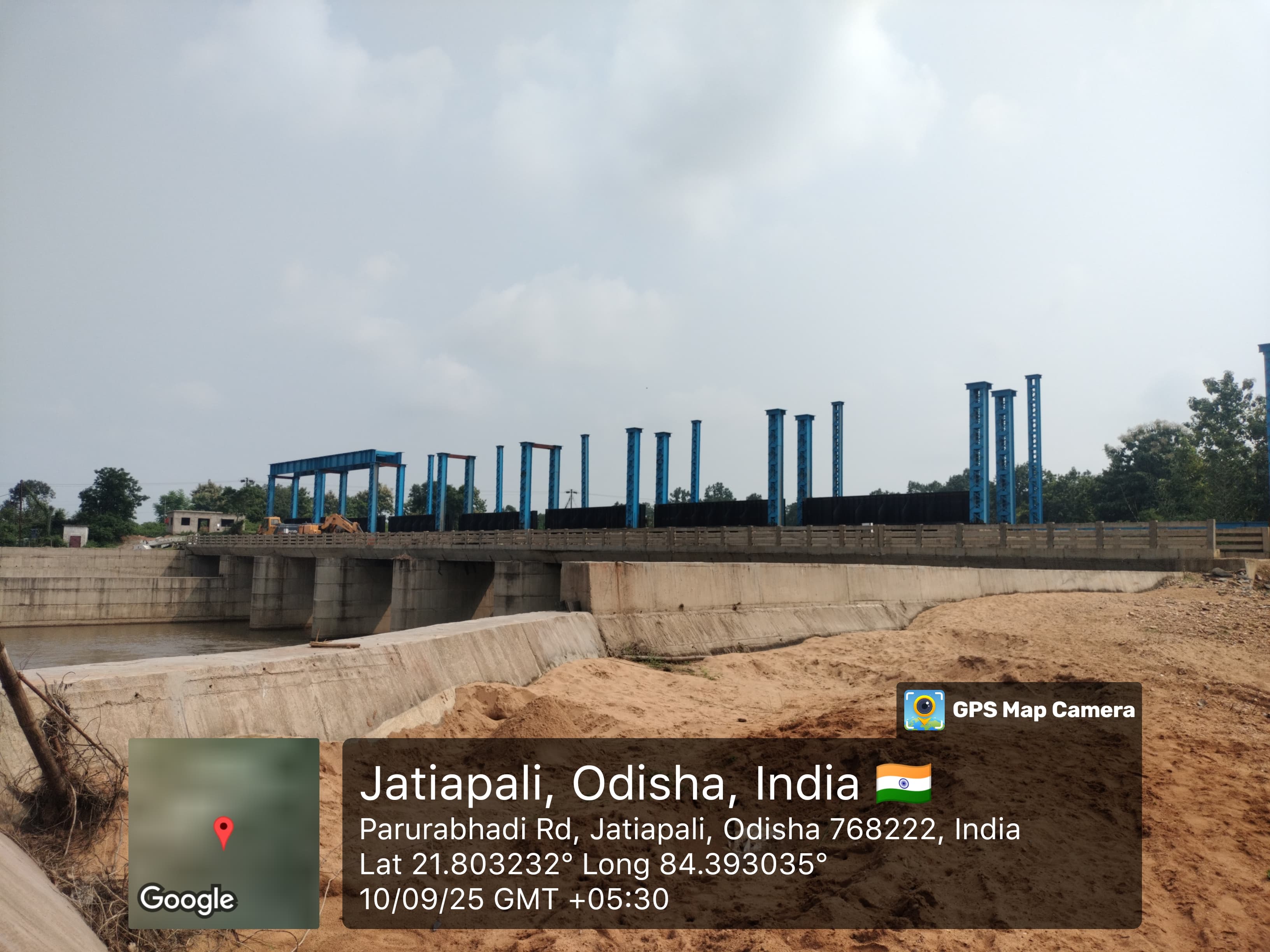

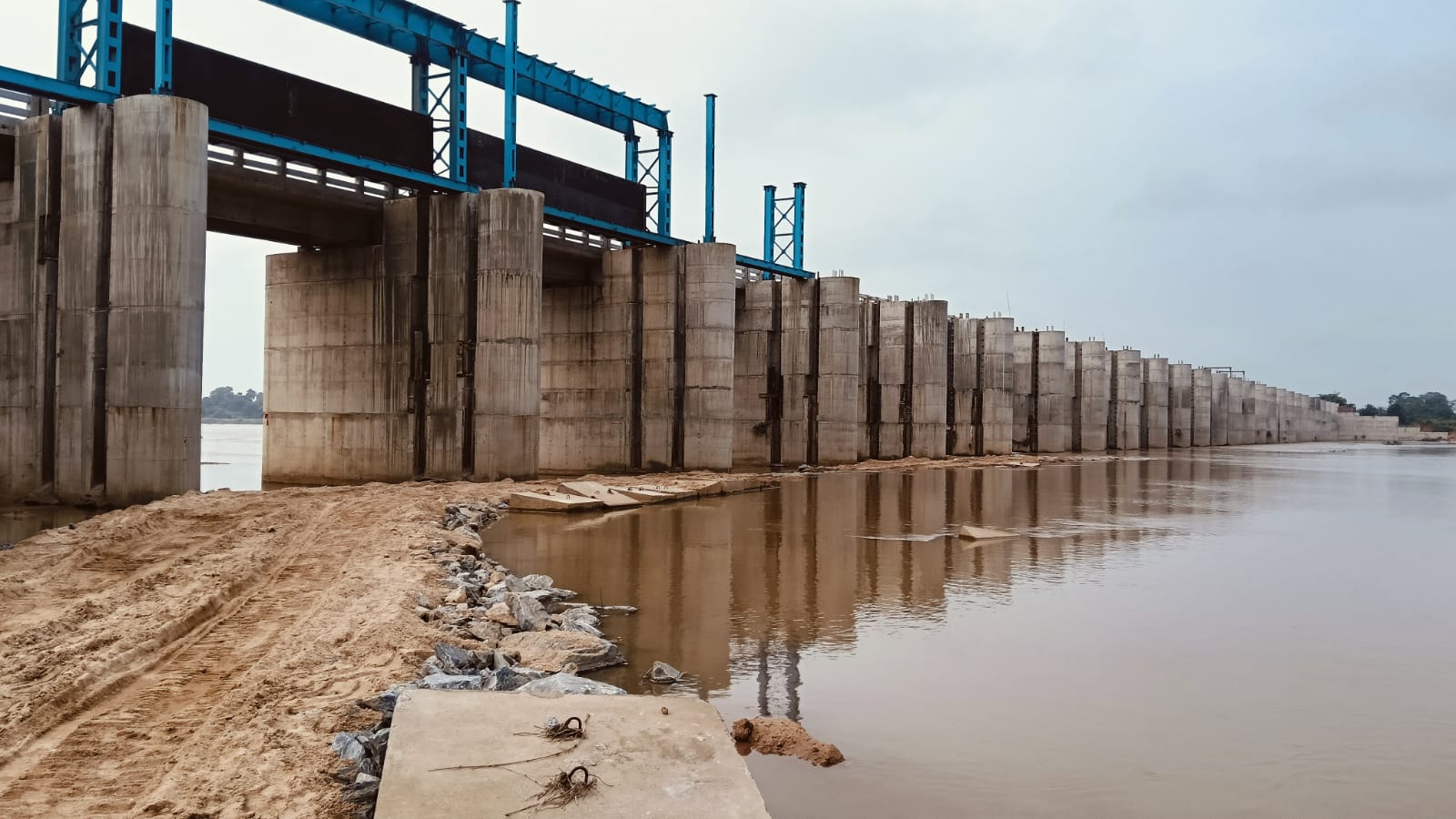

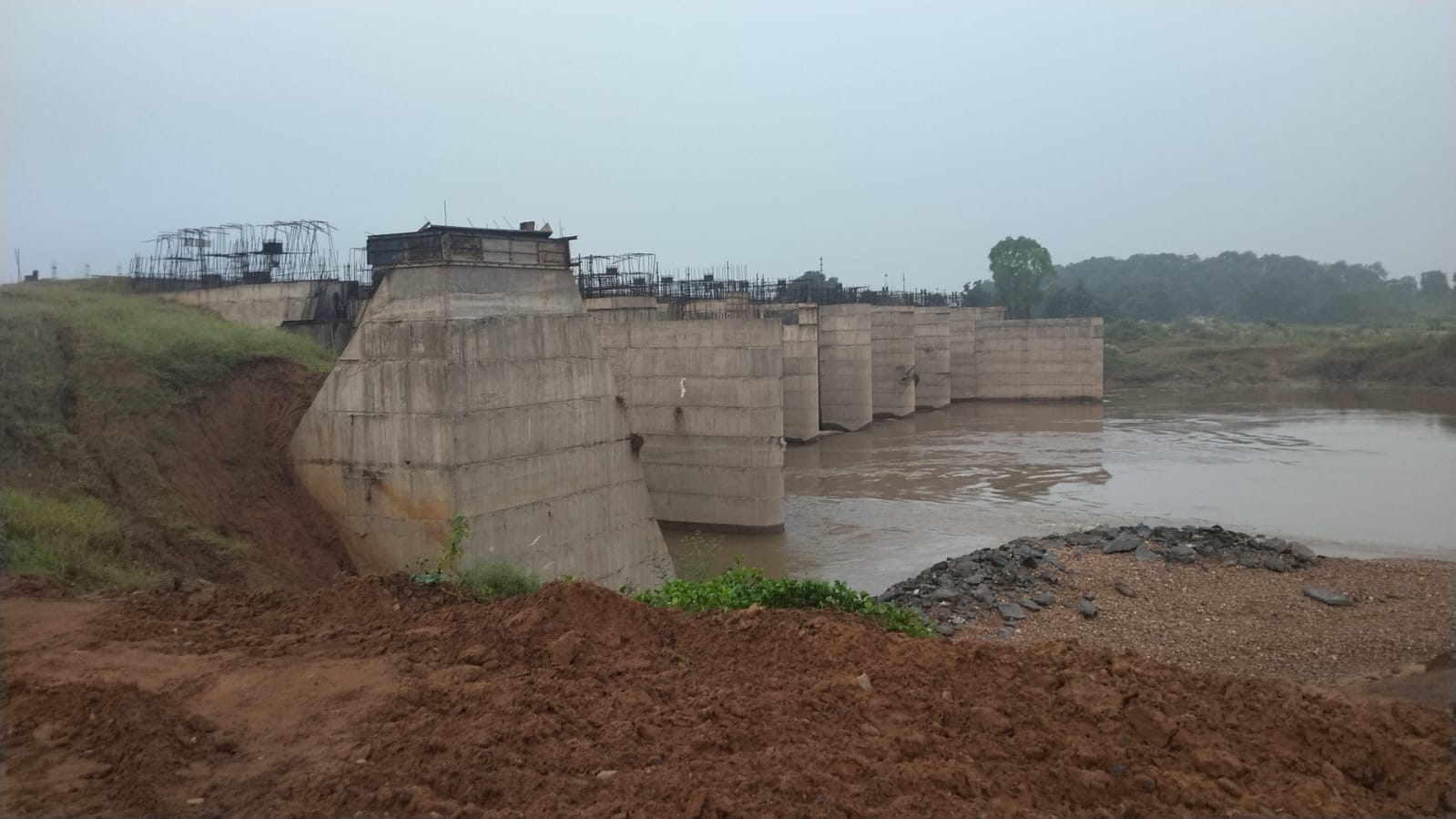

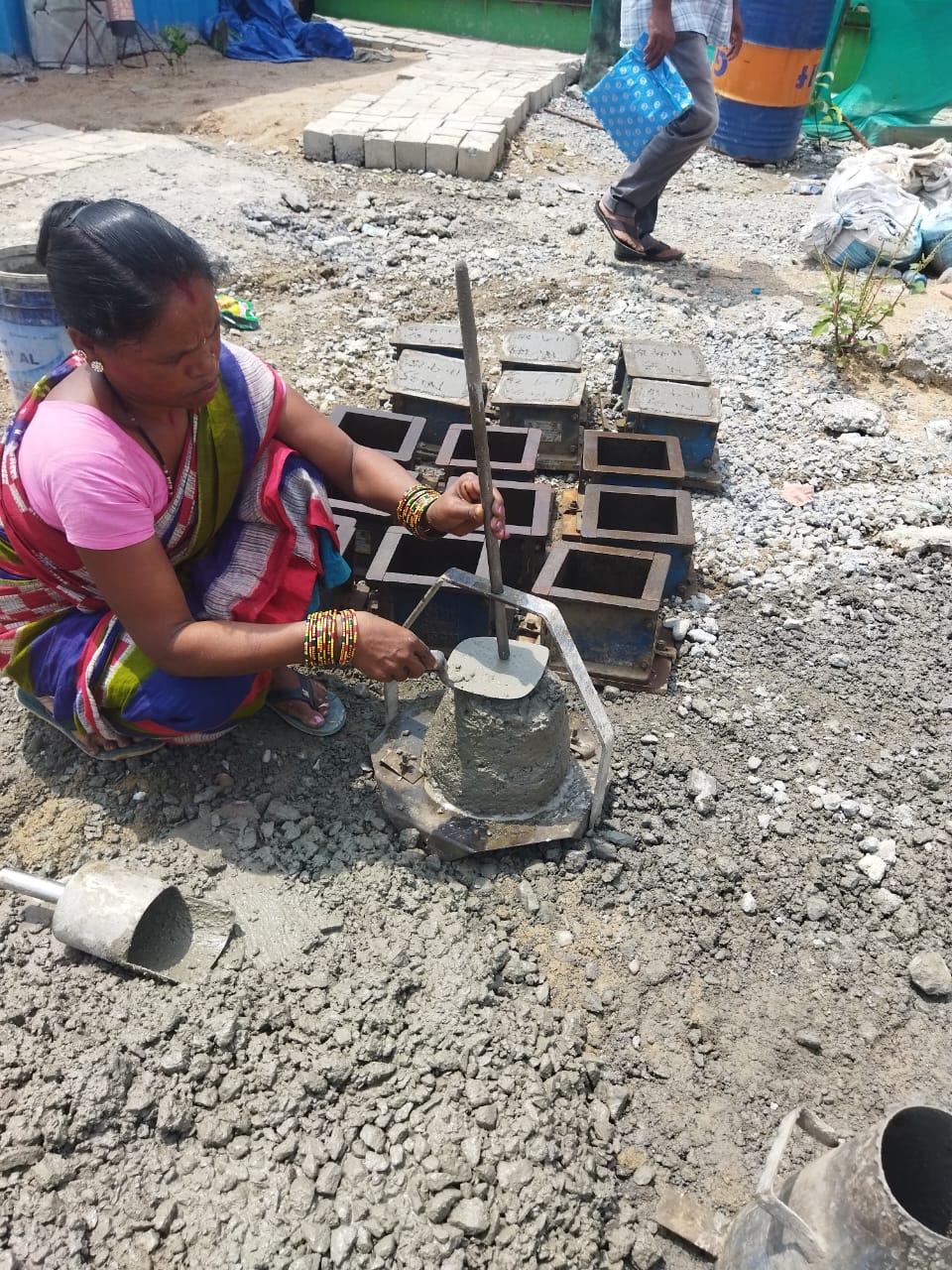

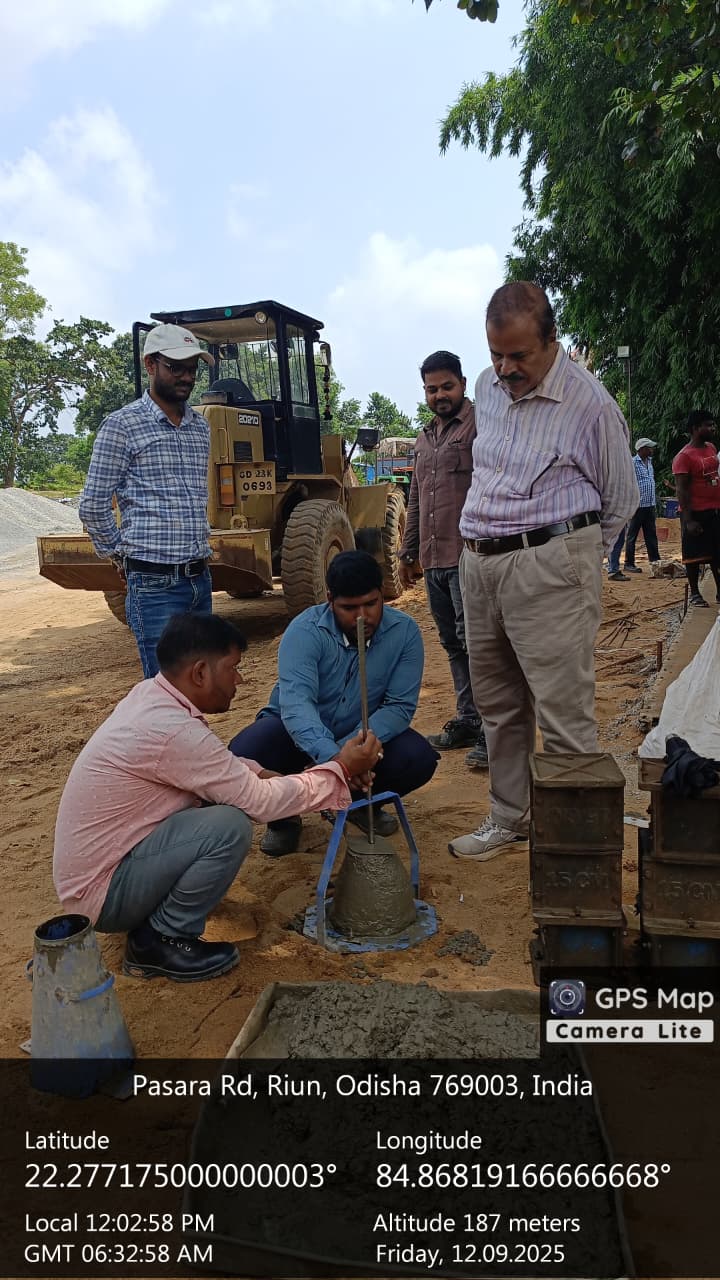

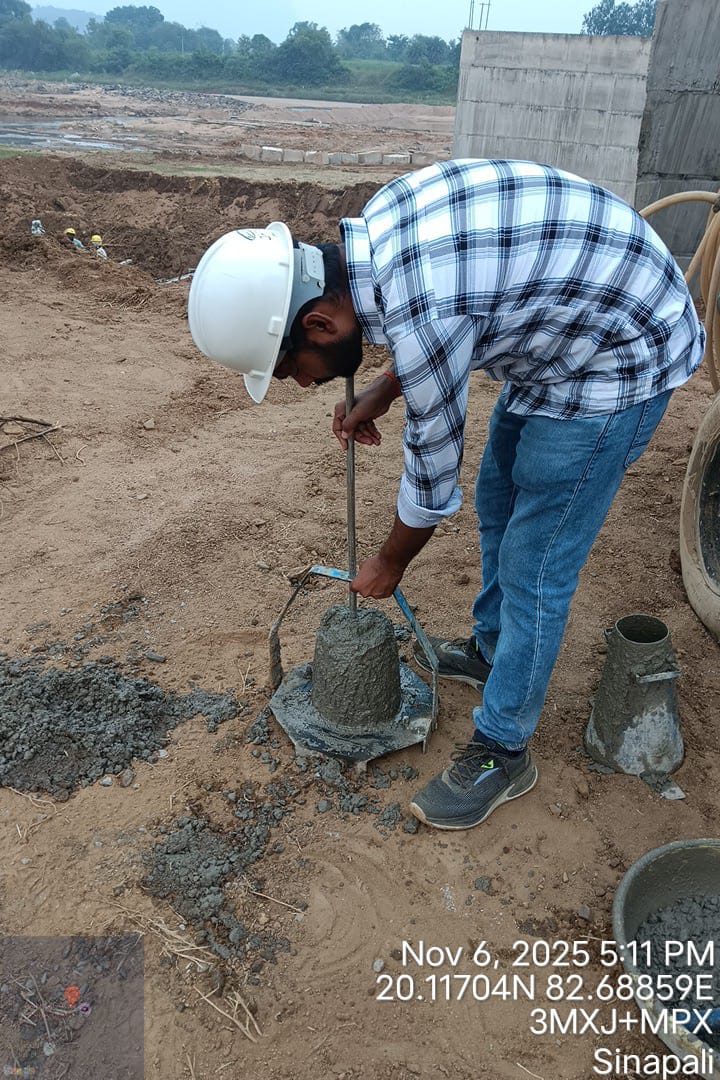

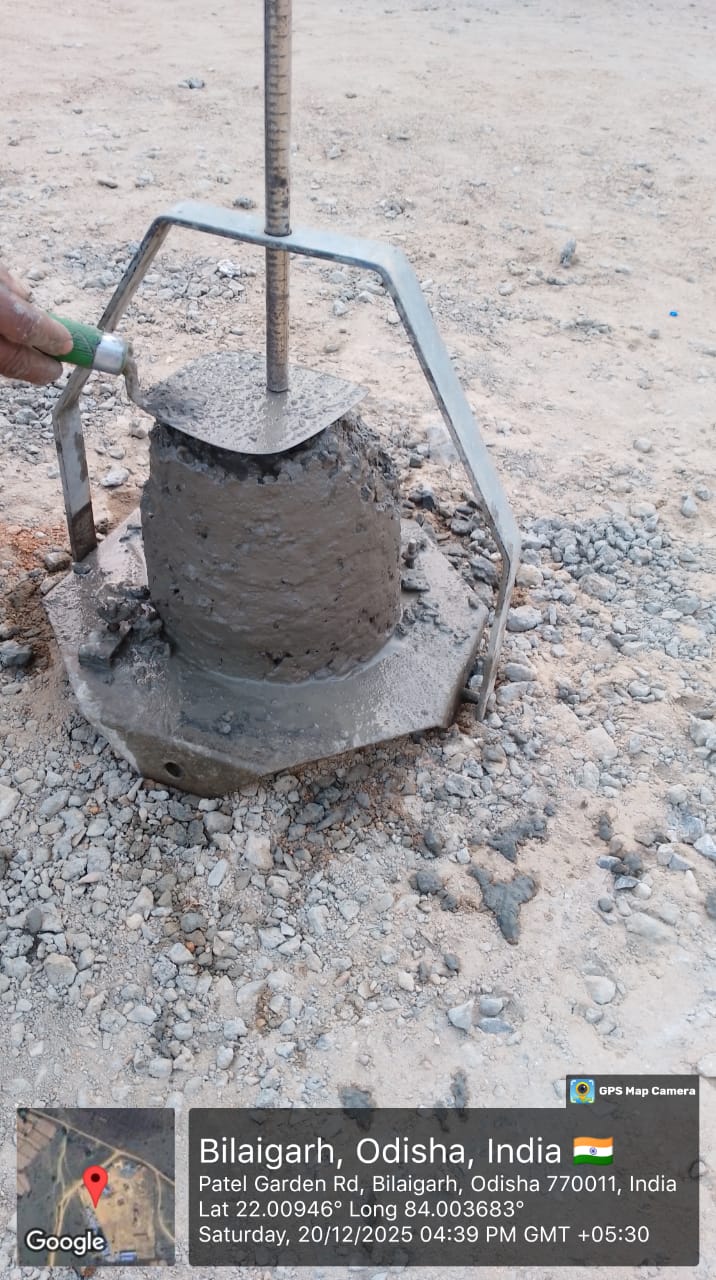

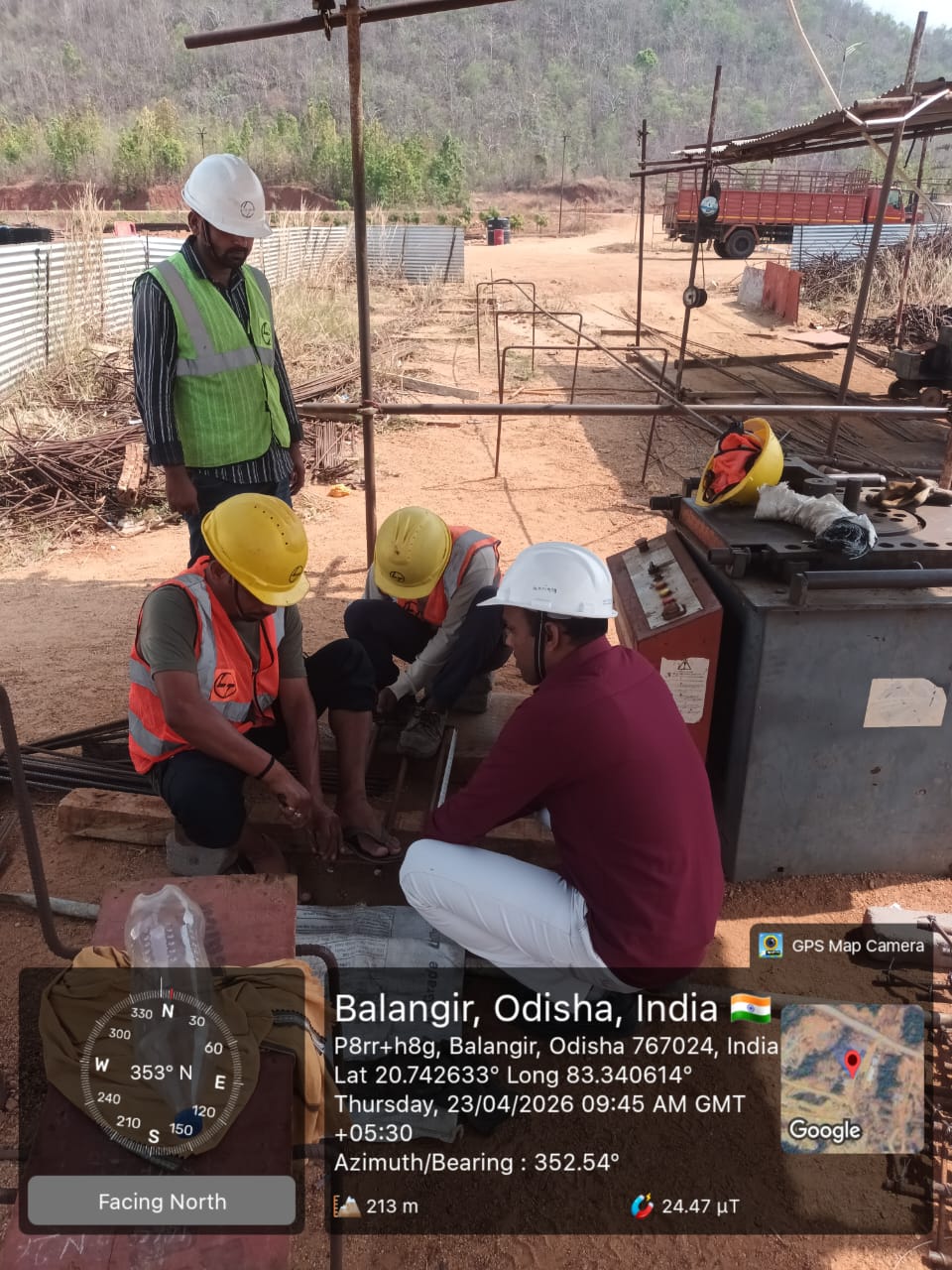

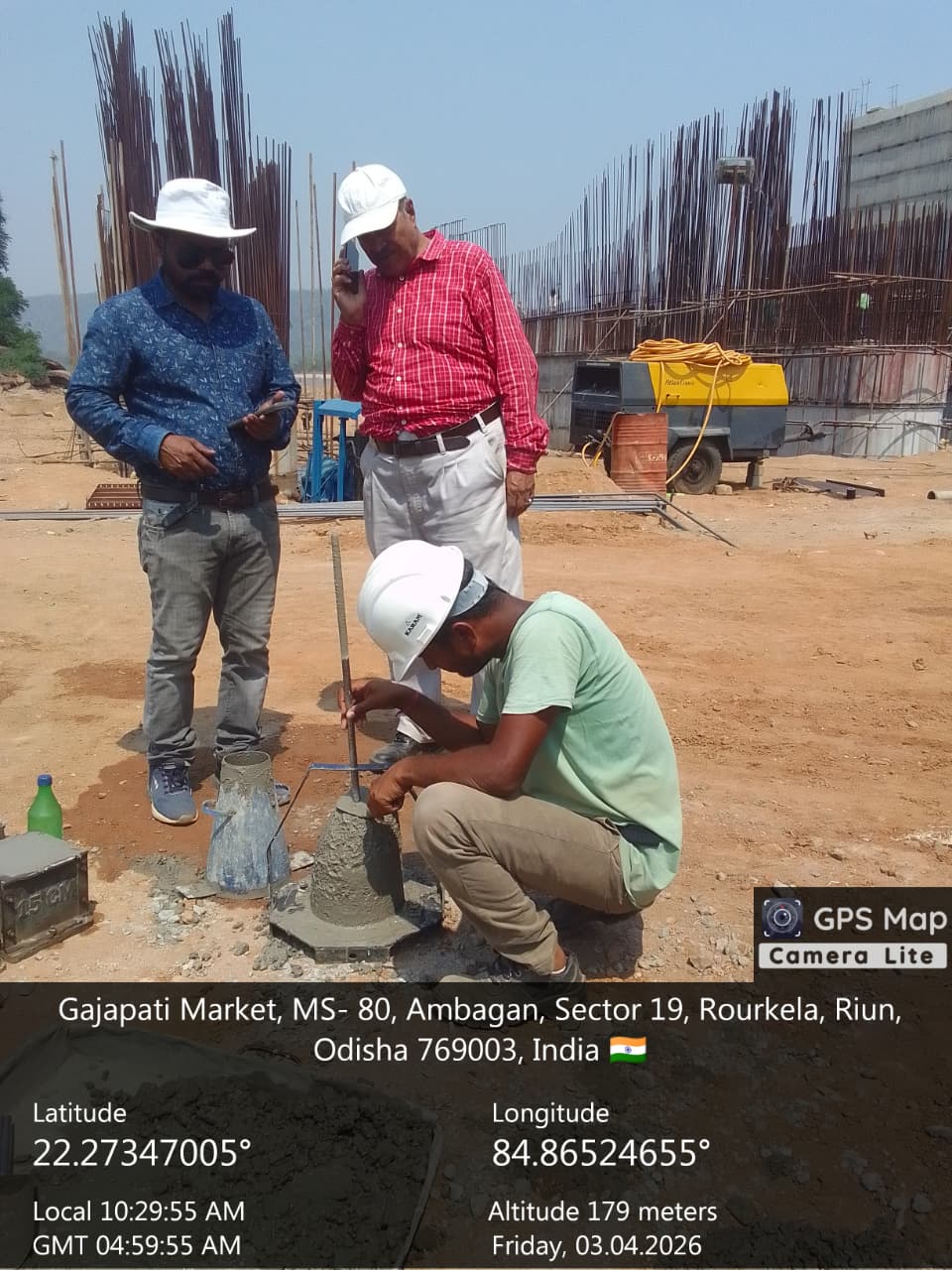

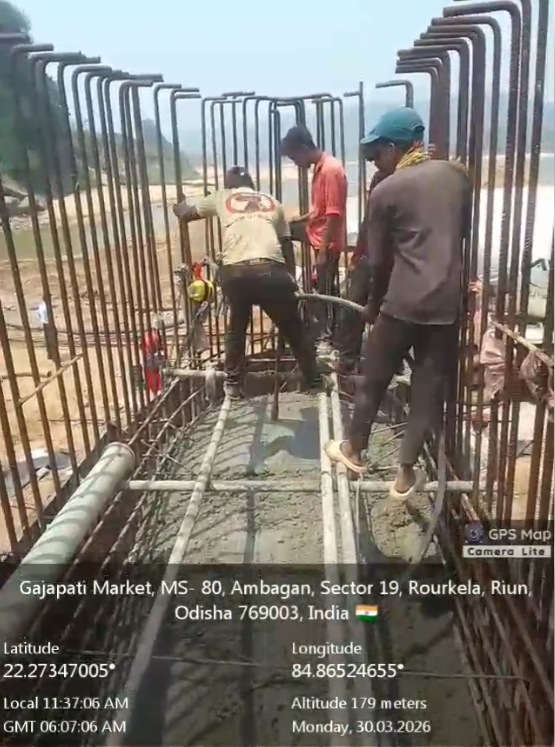

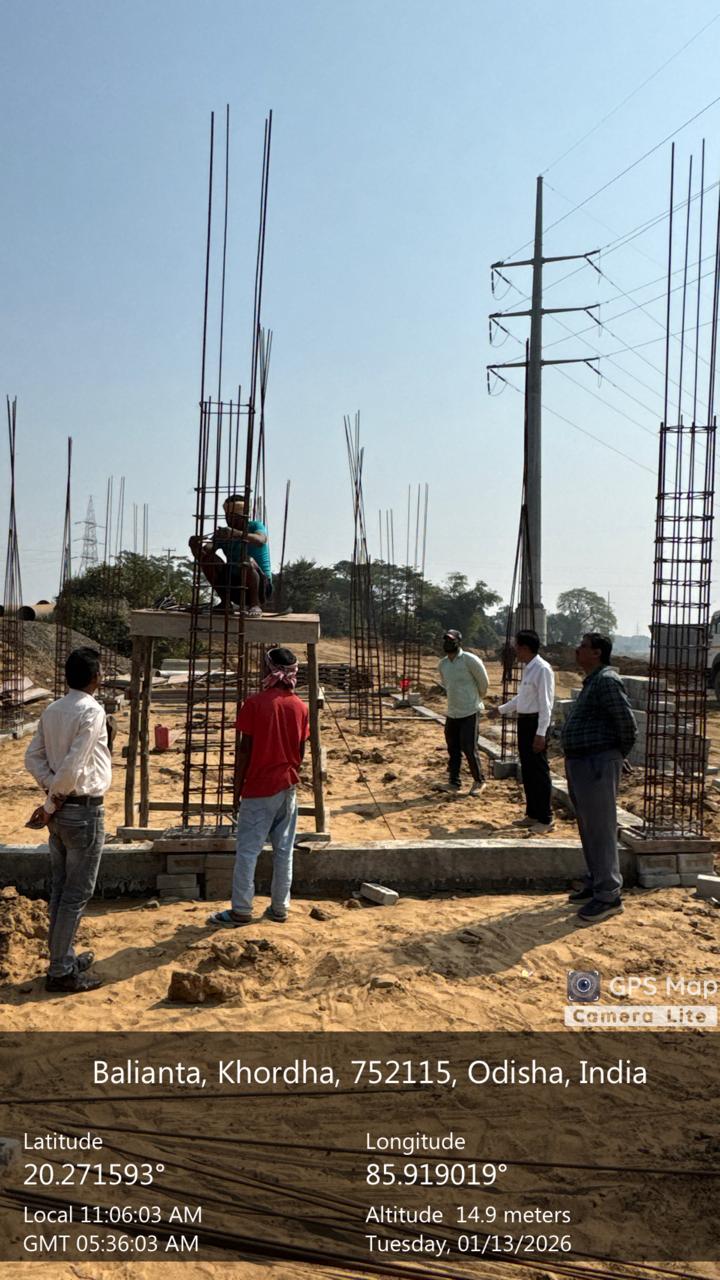

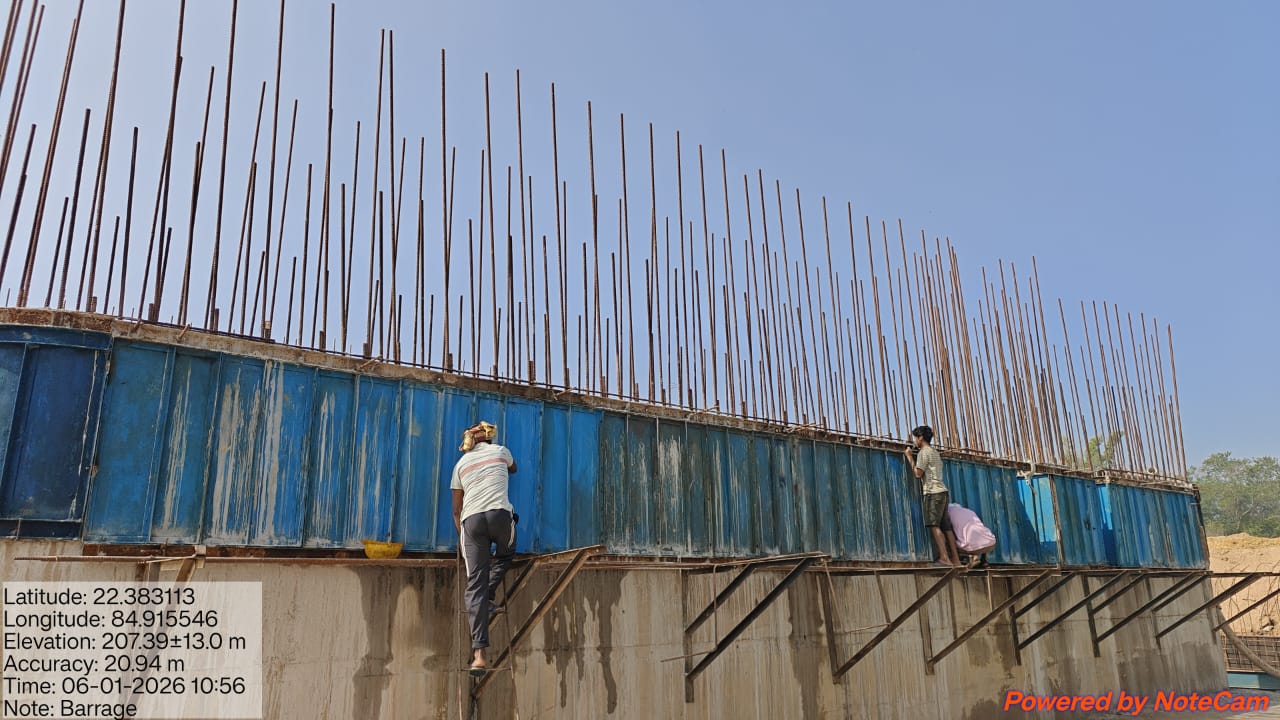

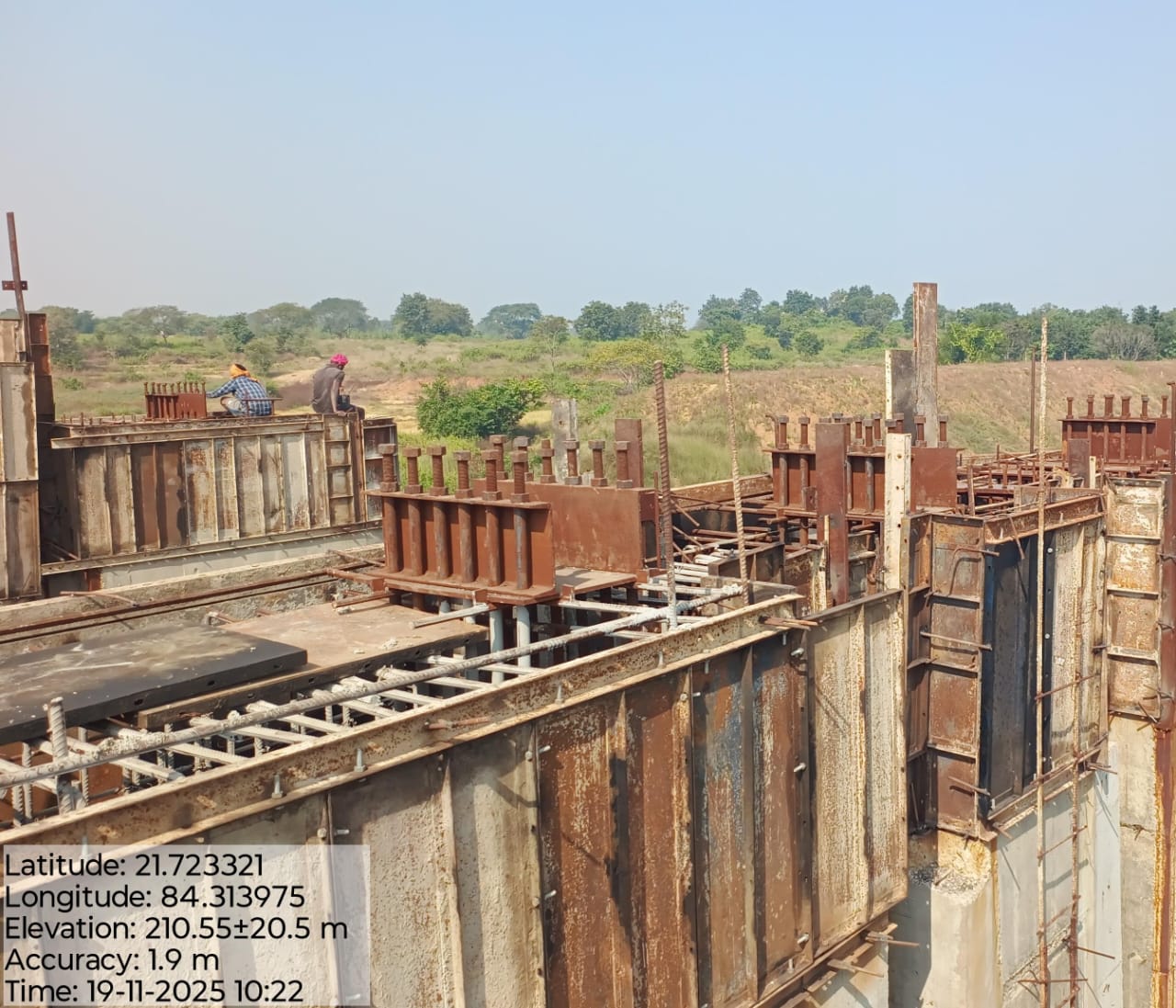

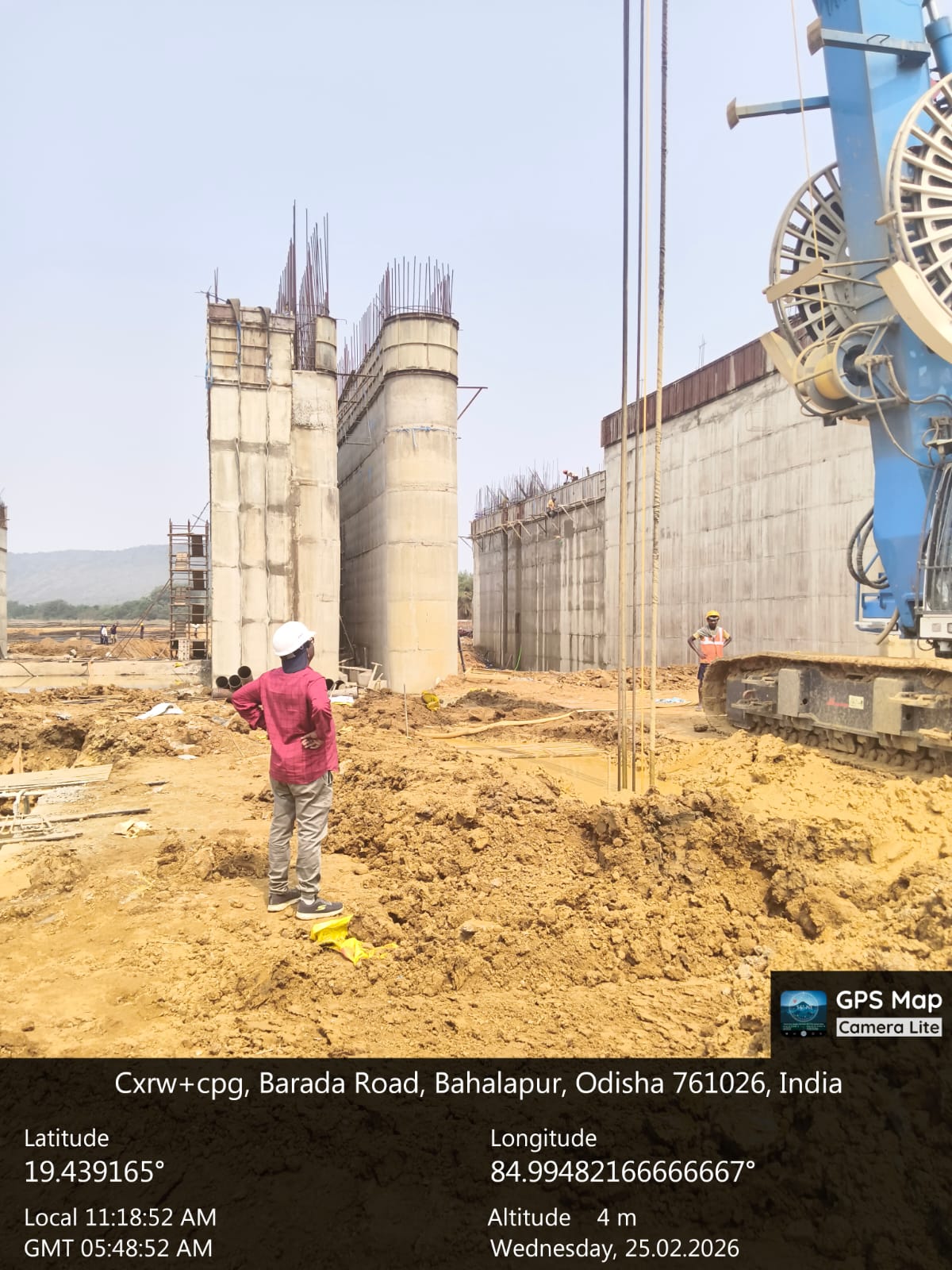

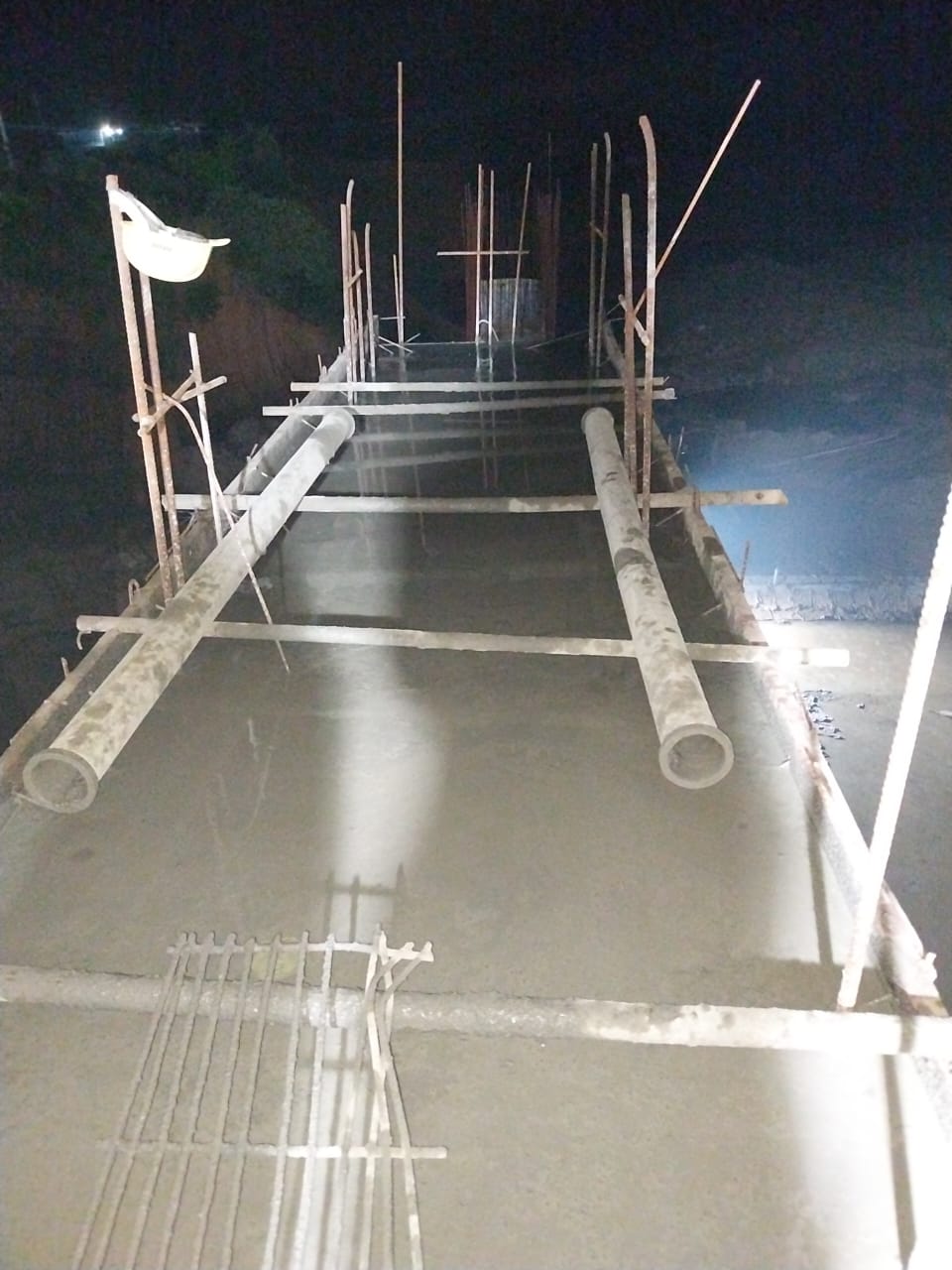

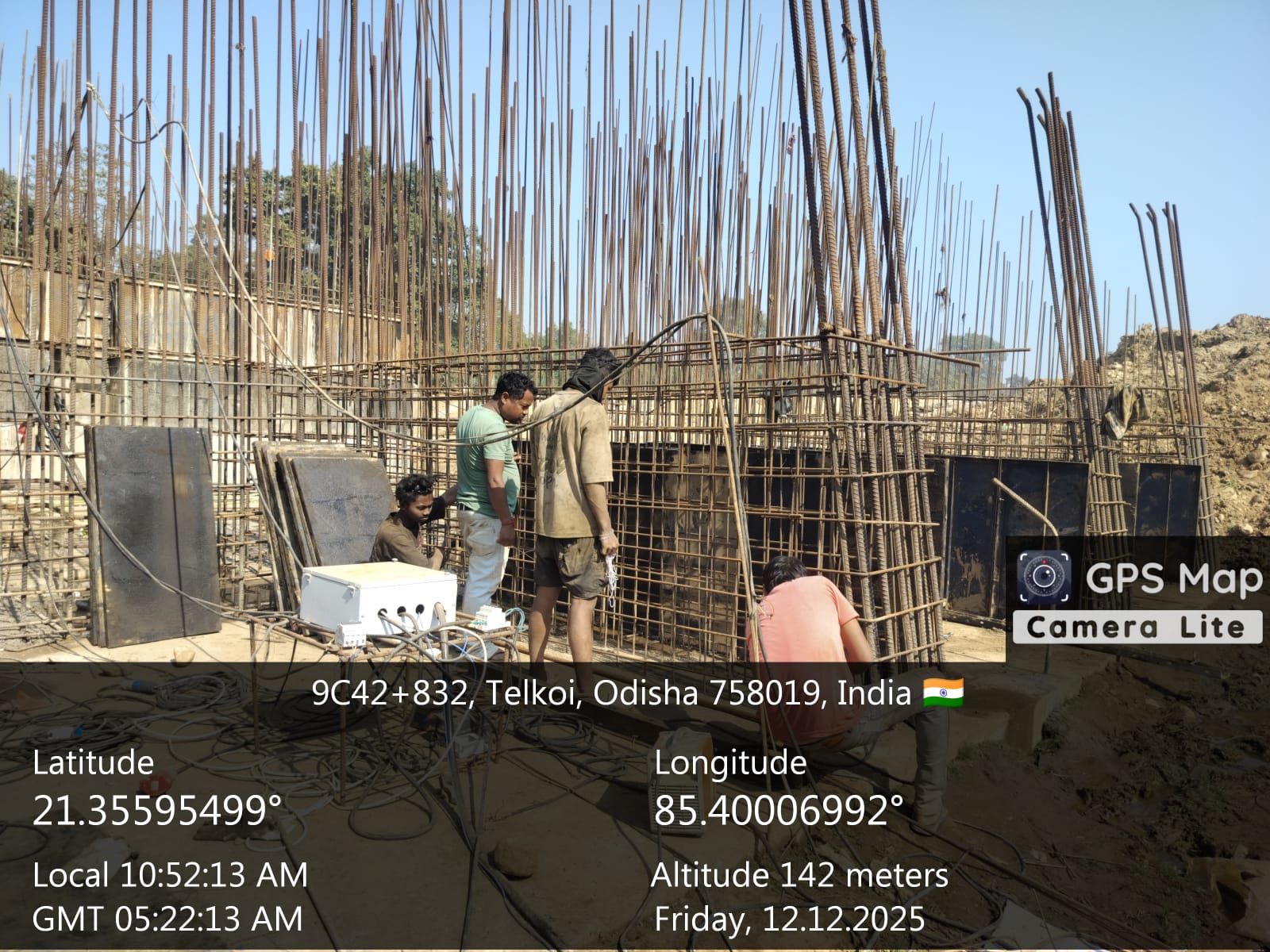

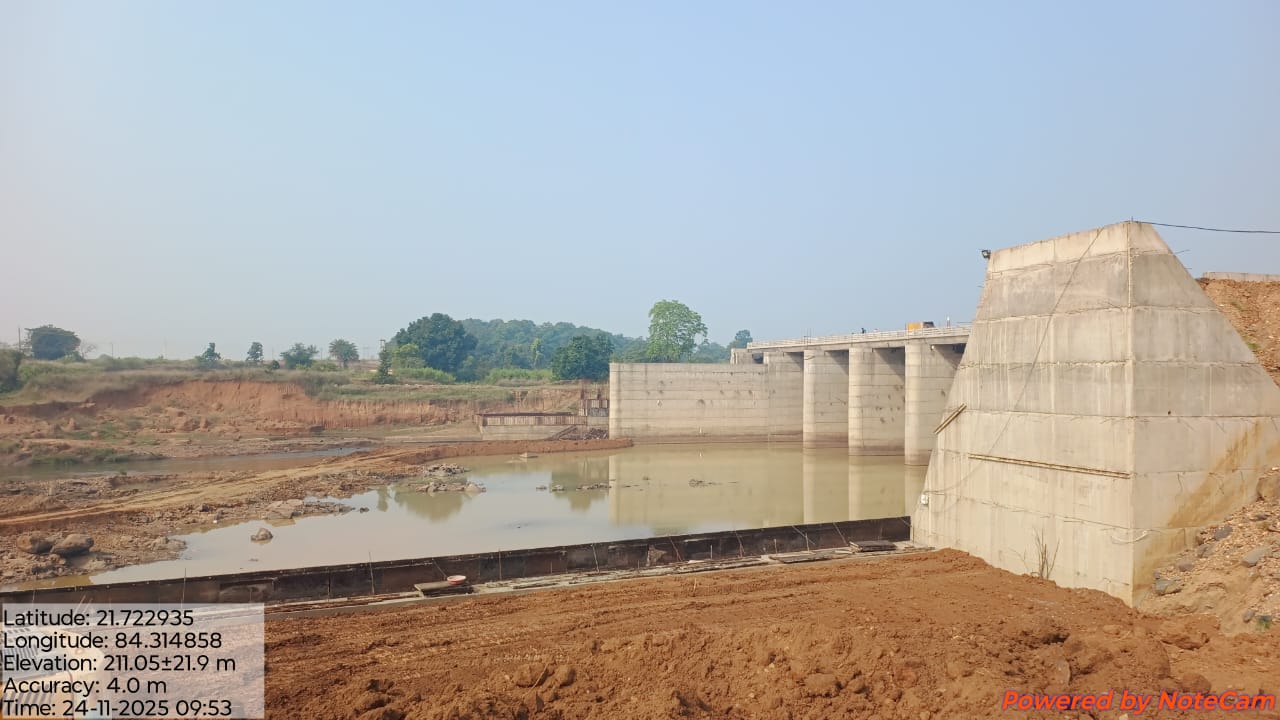

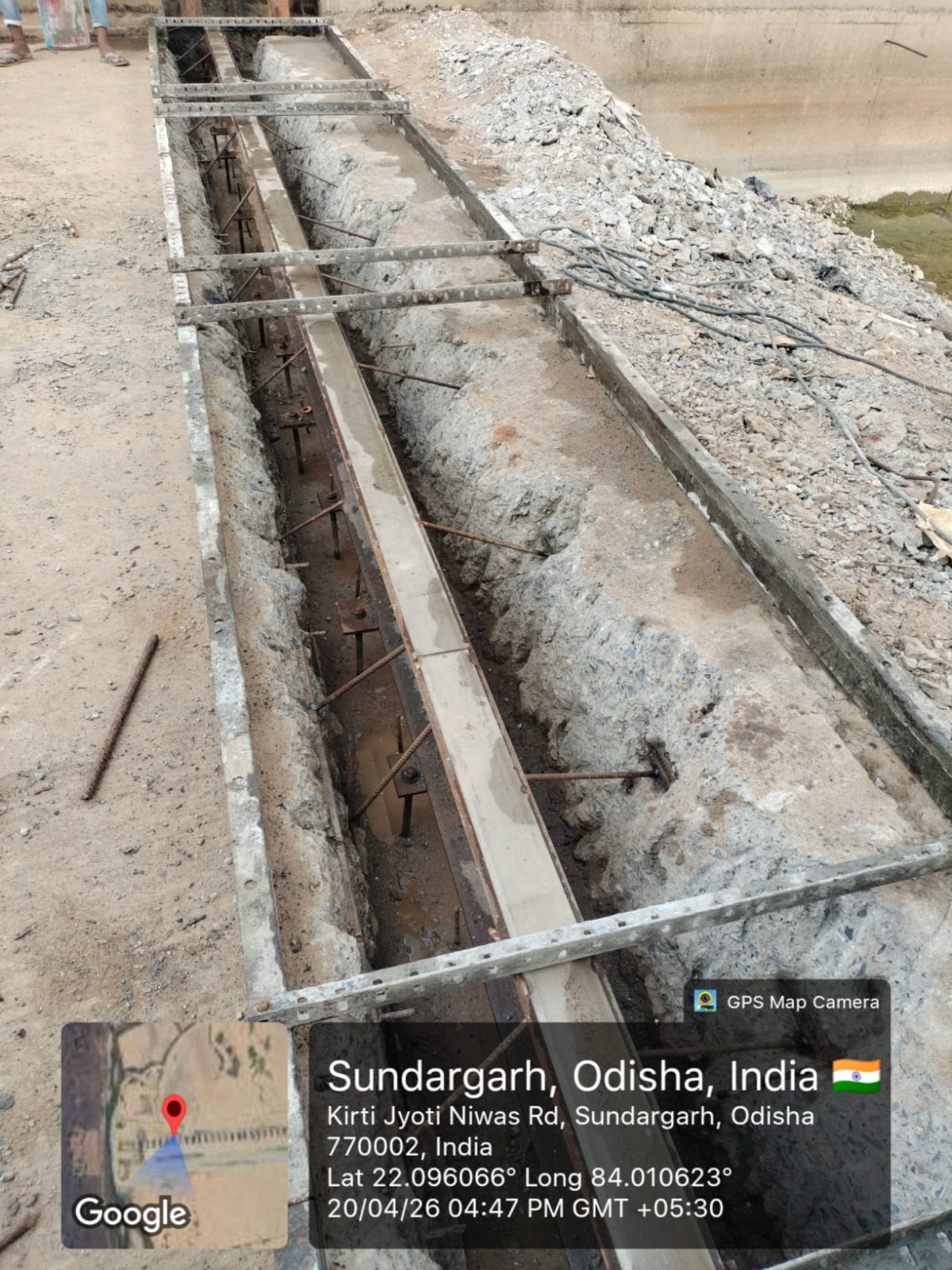

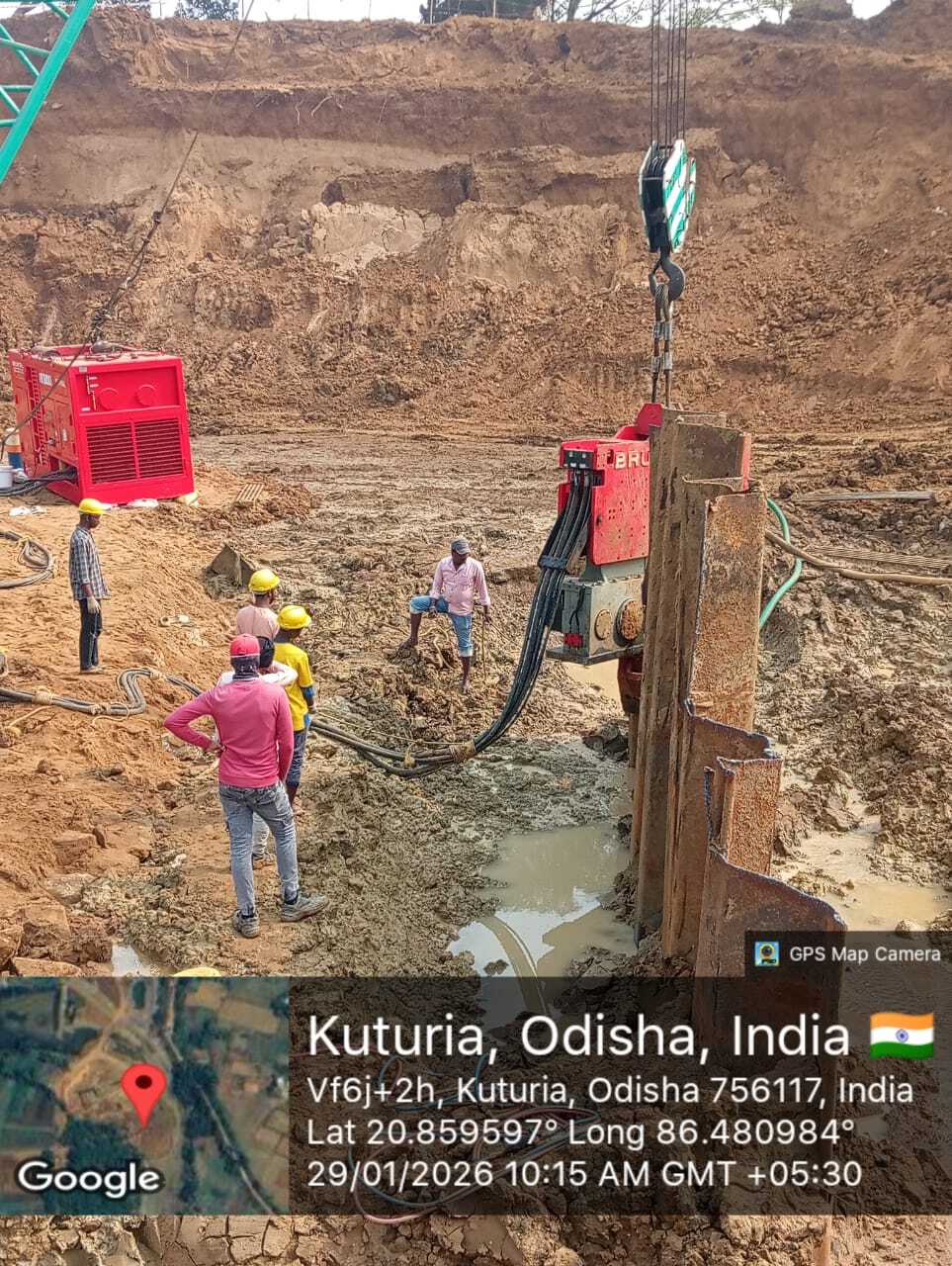

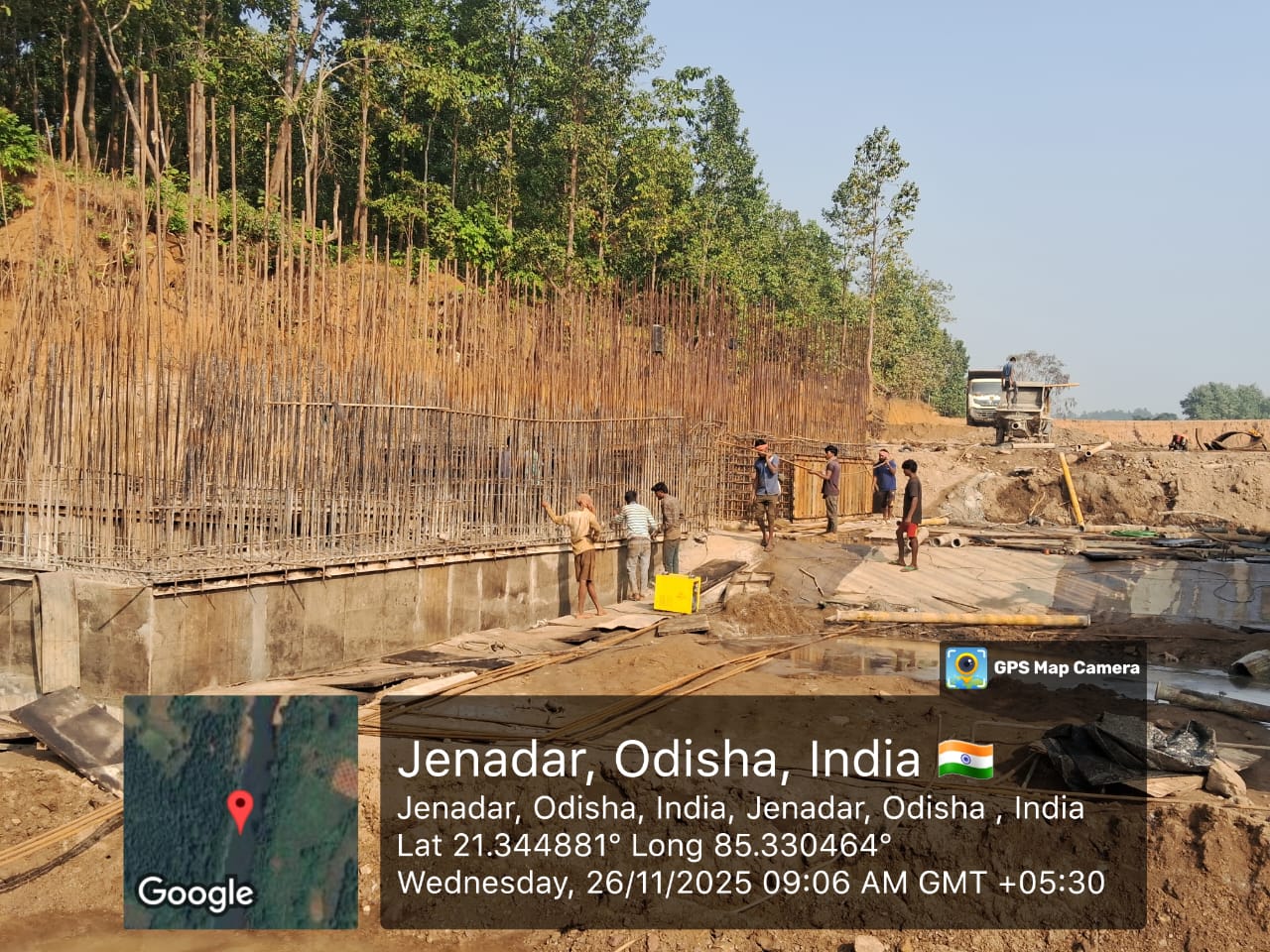

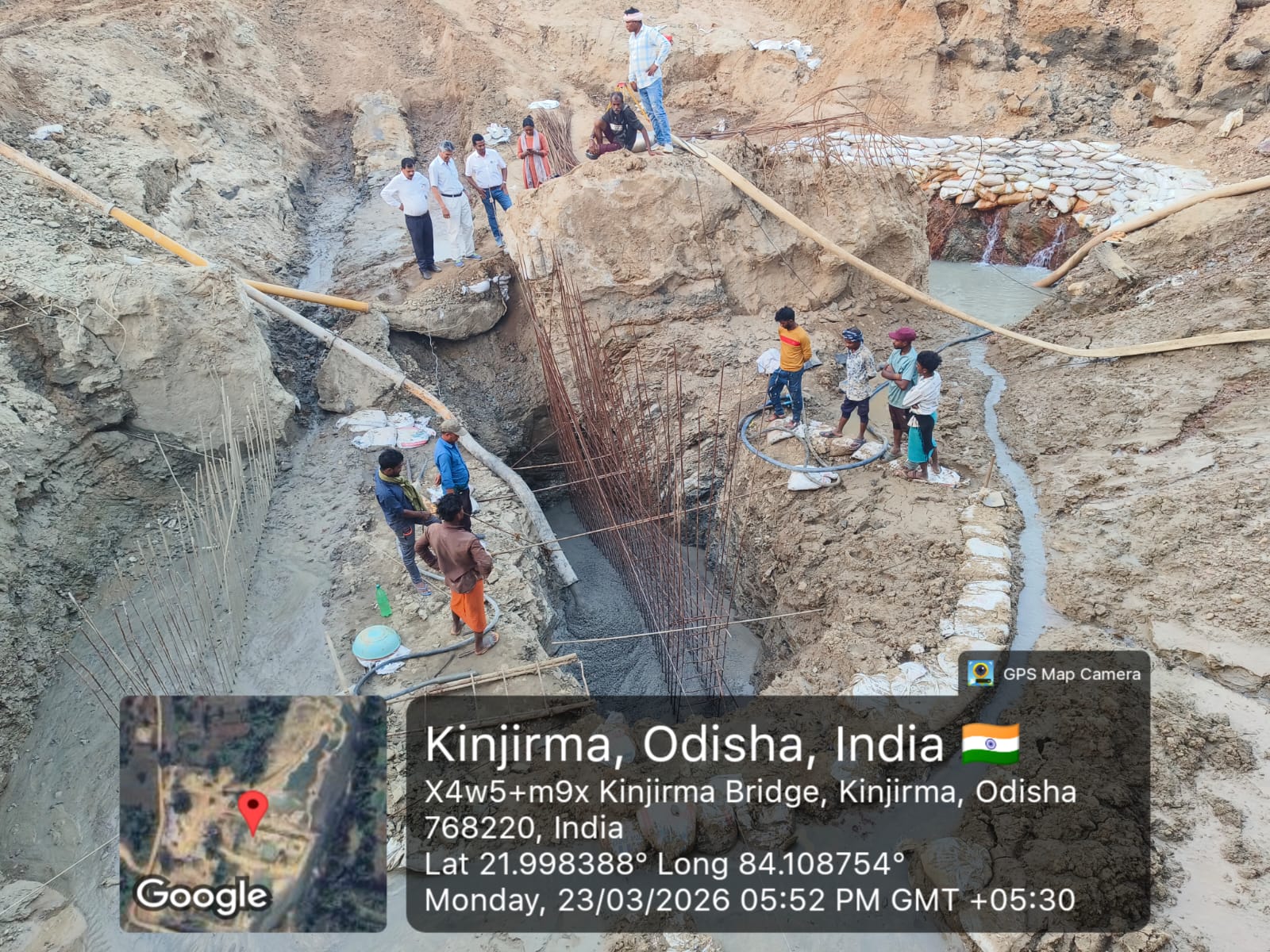

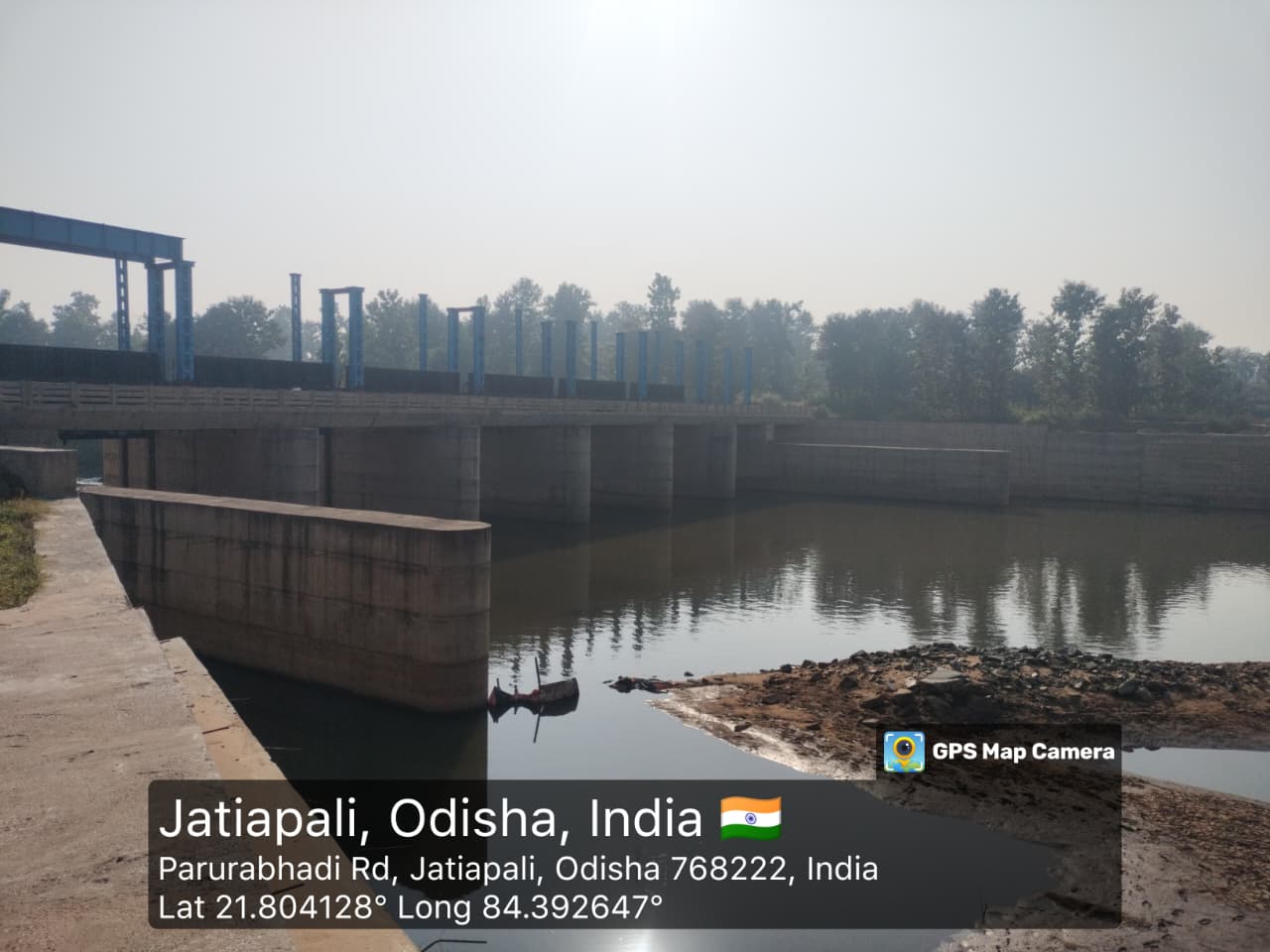

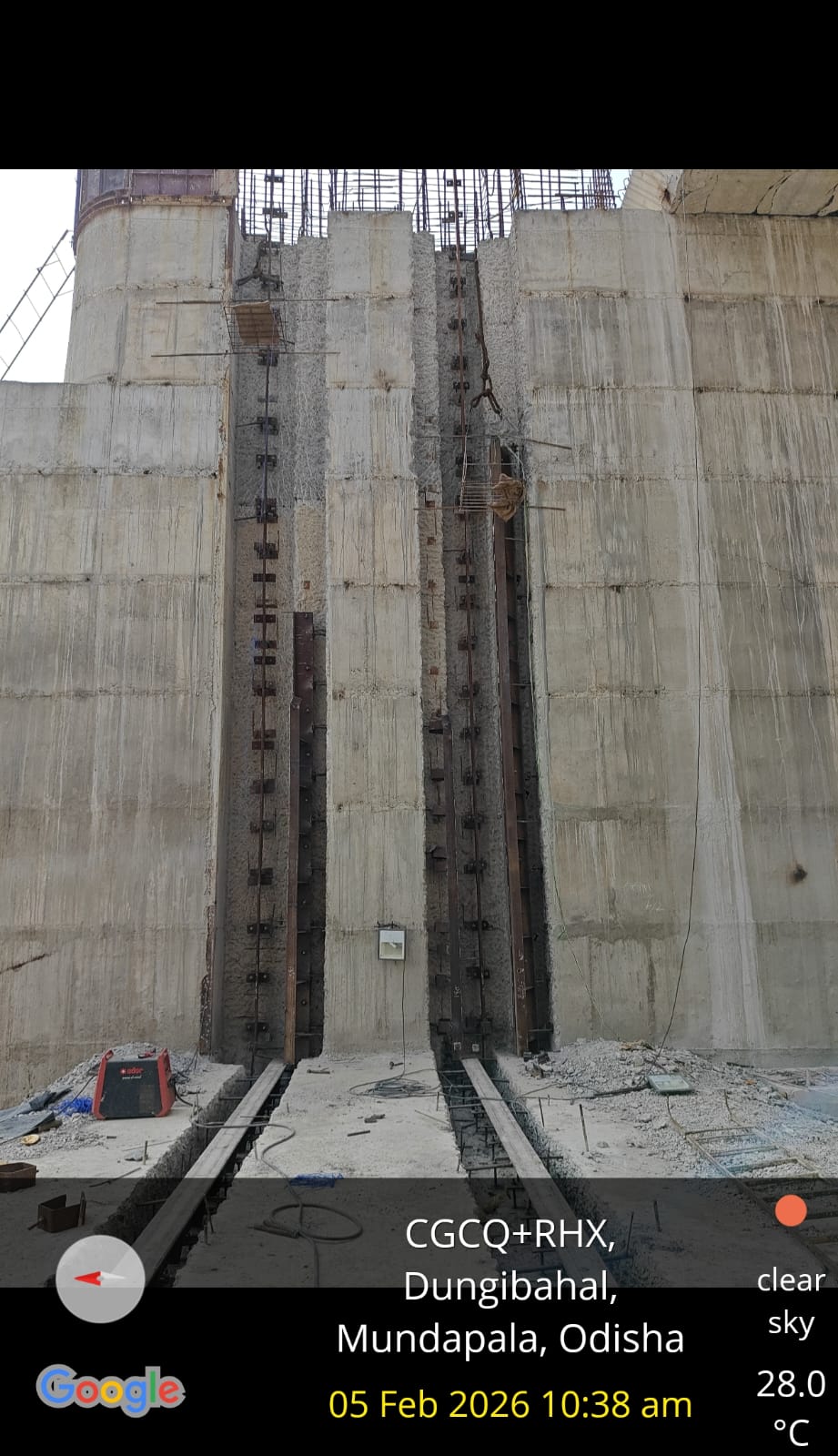

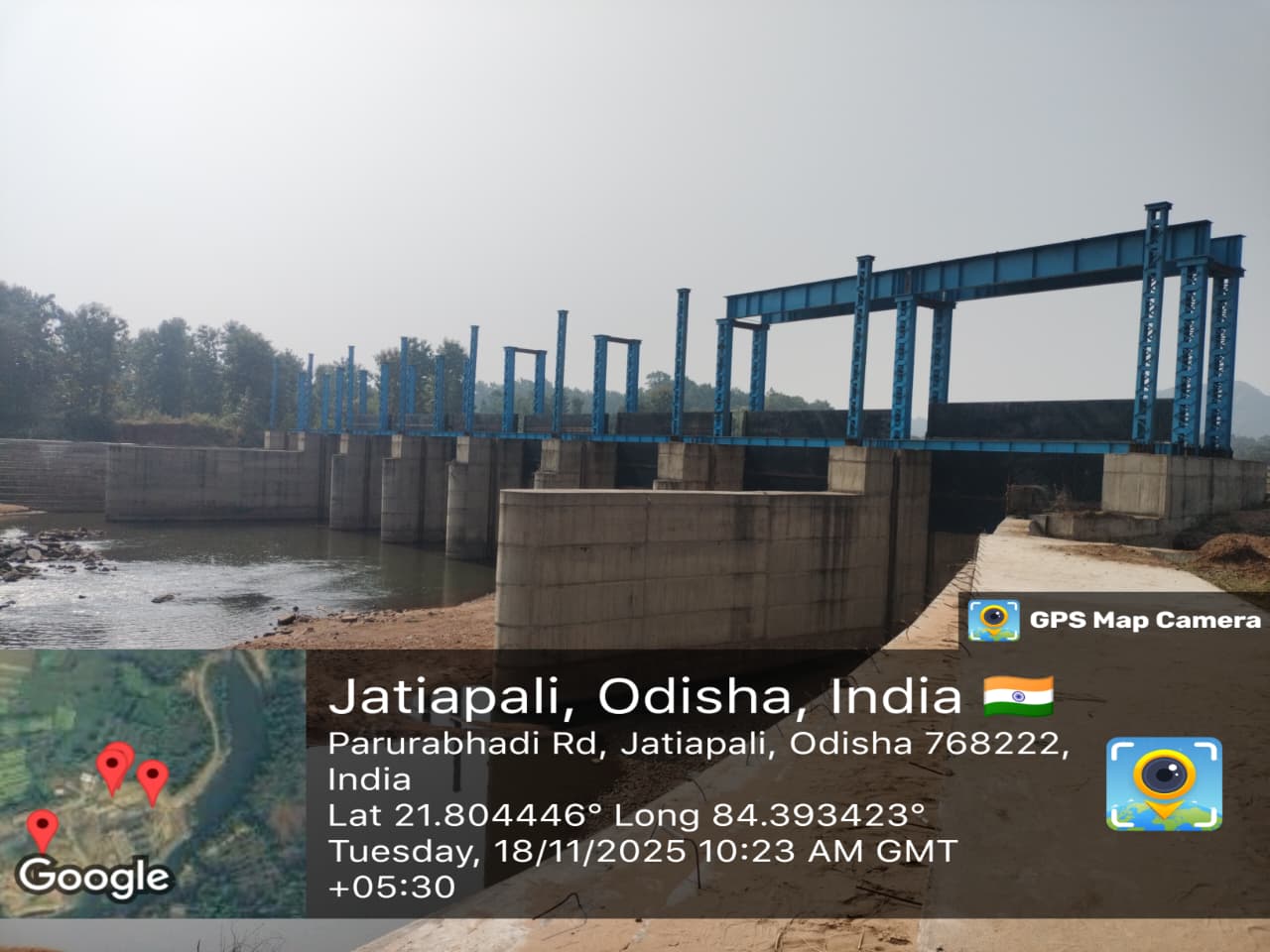

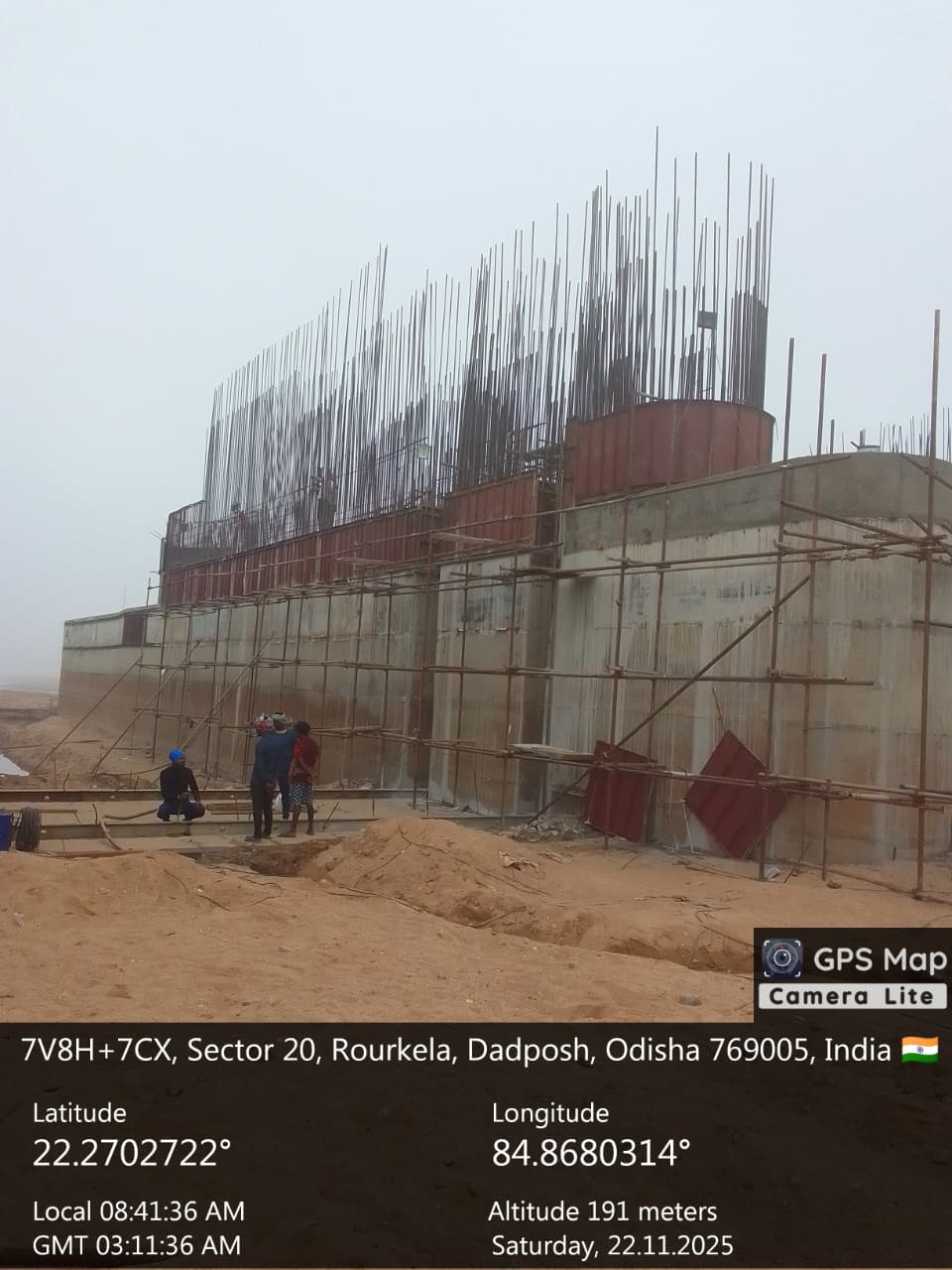

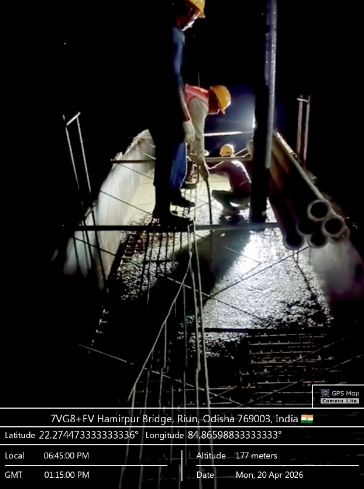

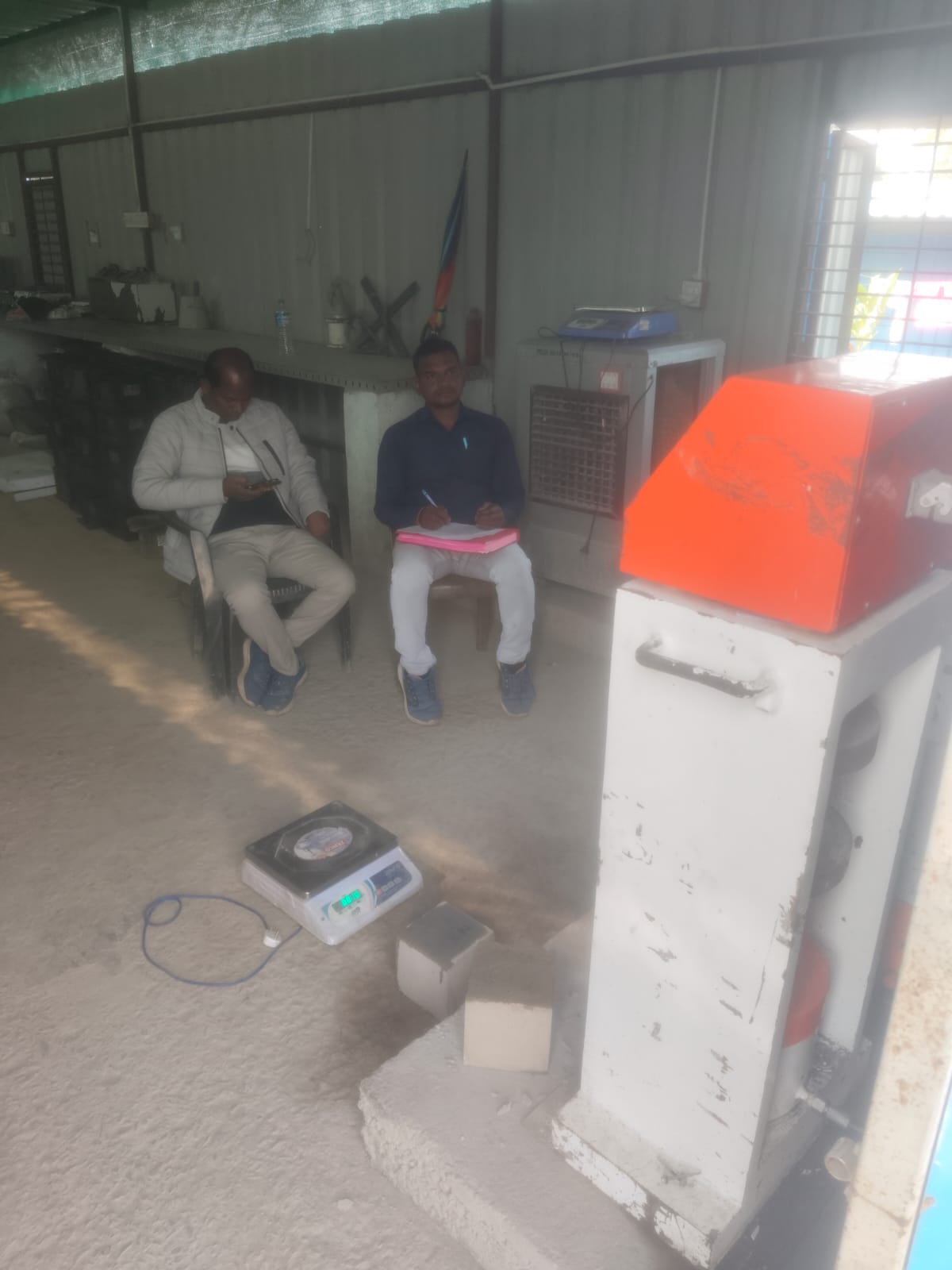

Instream Storage Structure, Dhanei

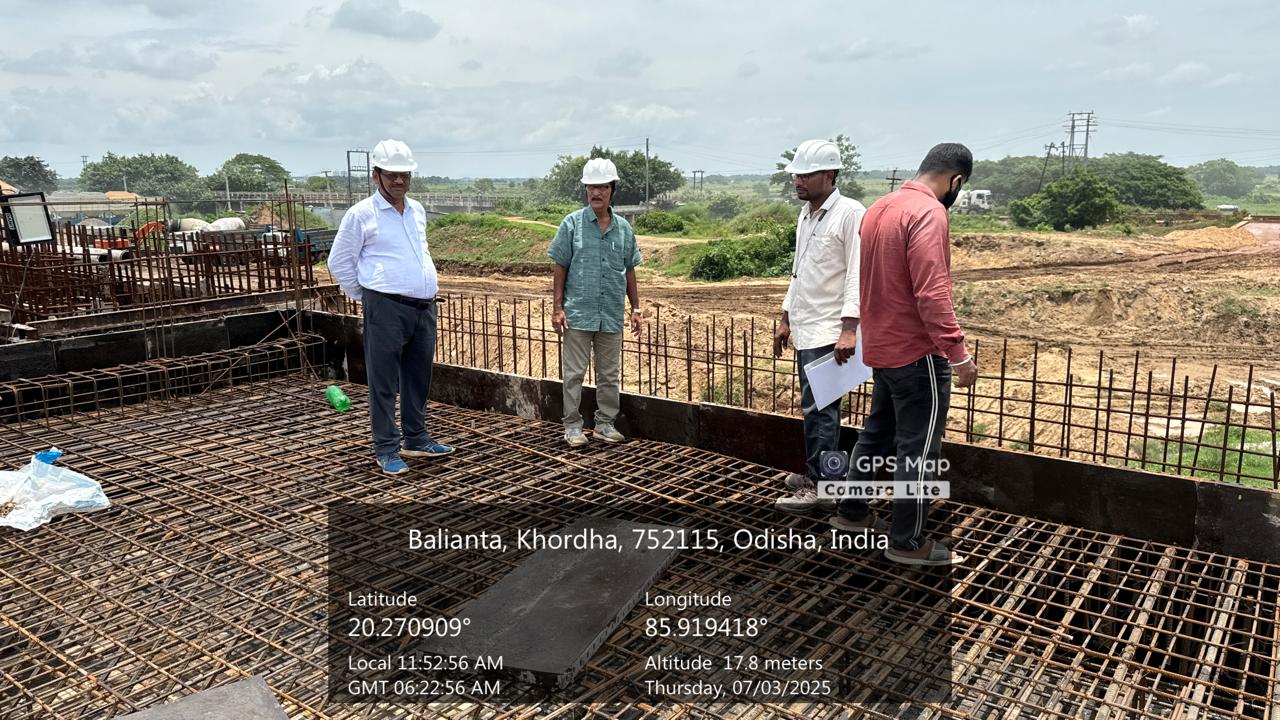

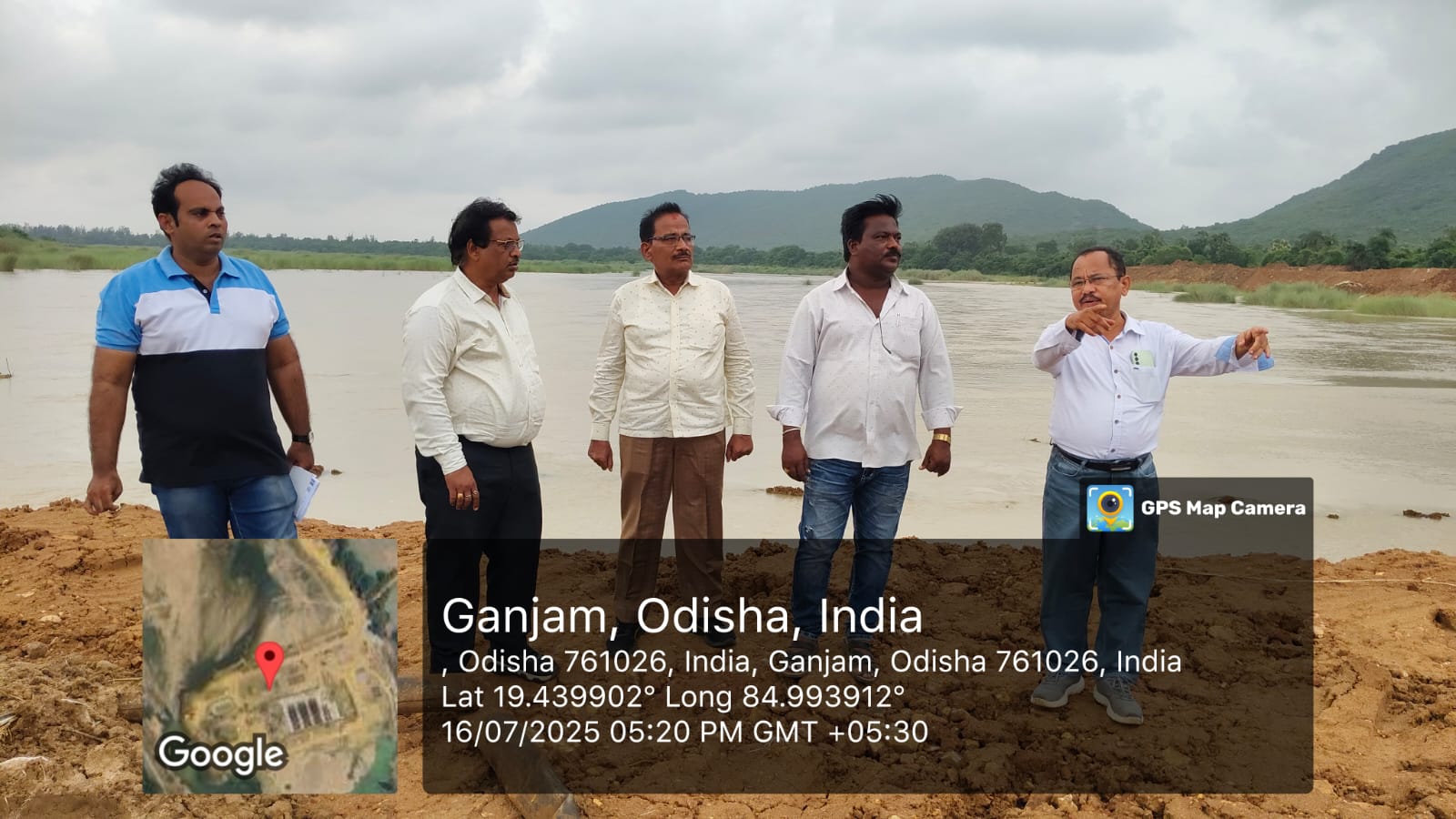

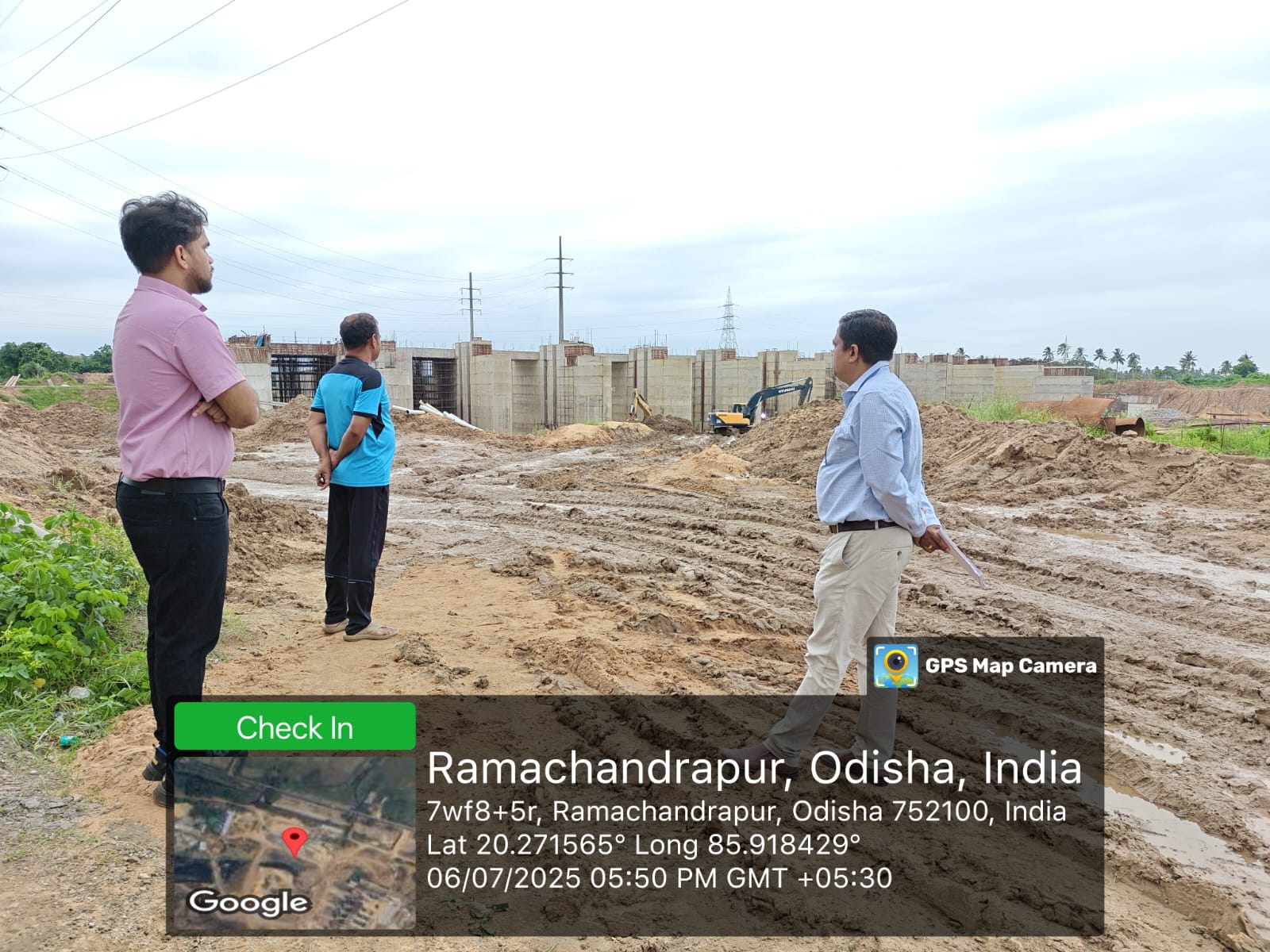

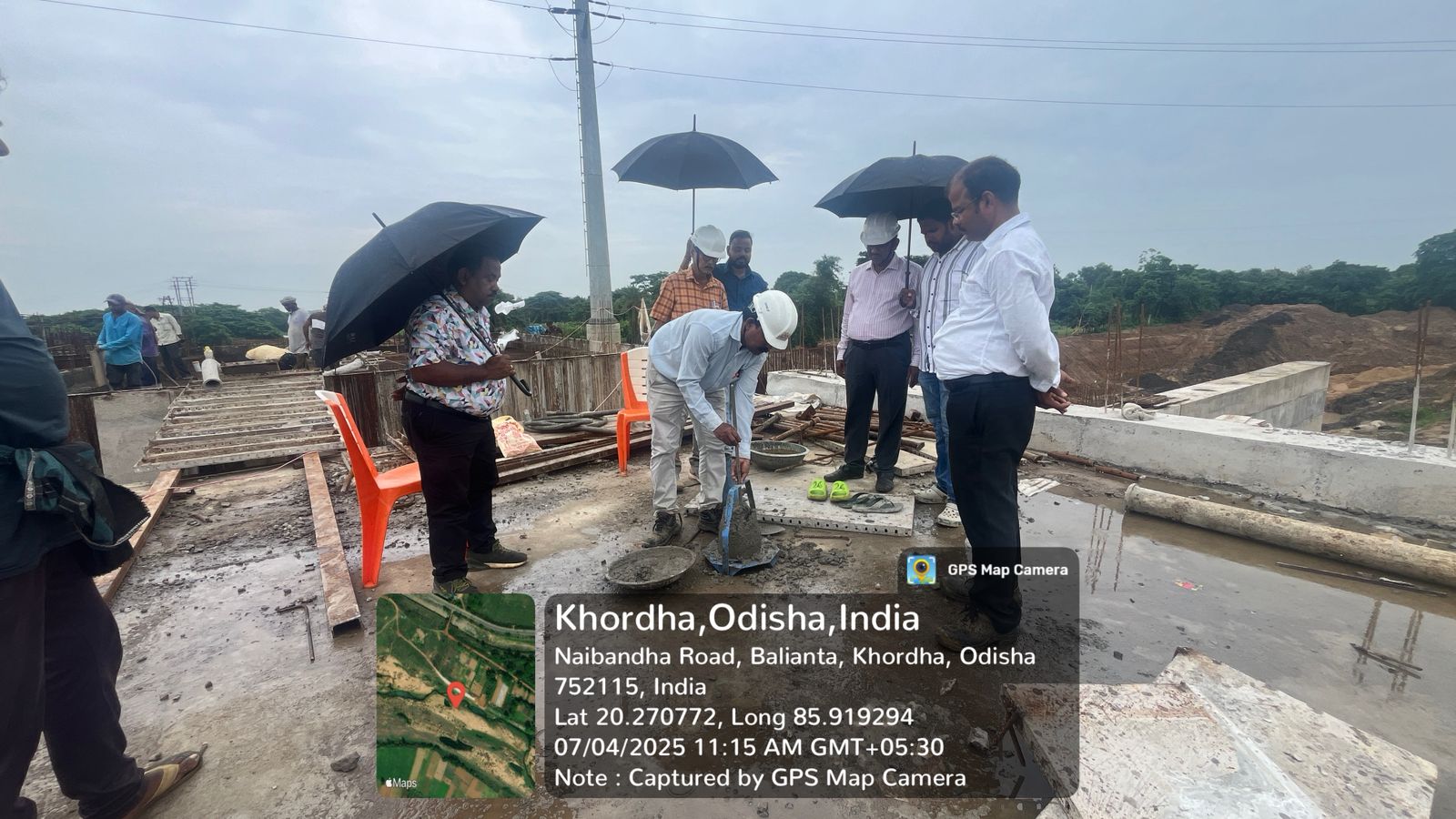

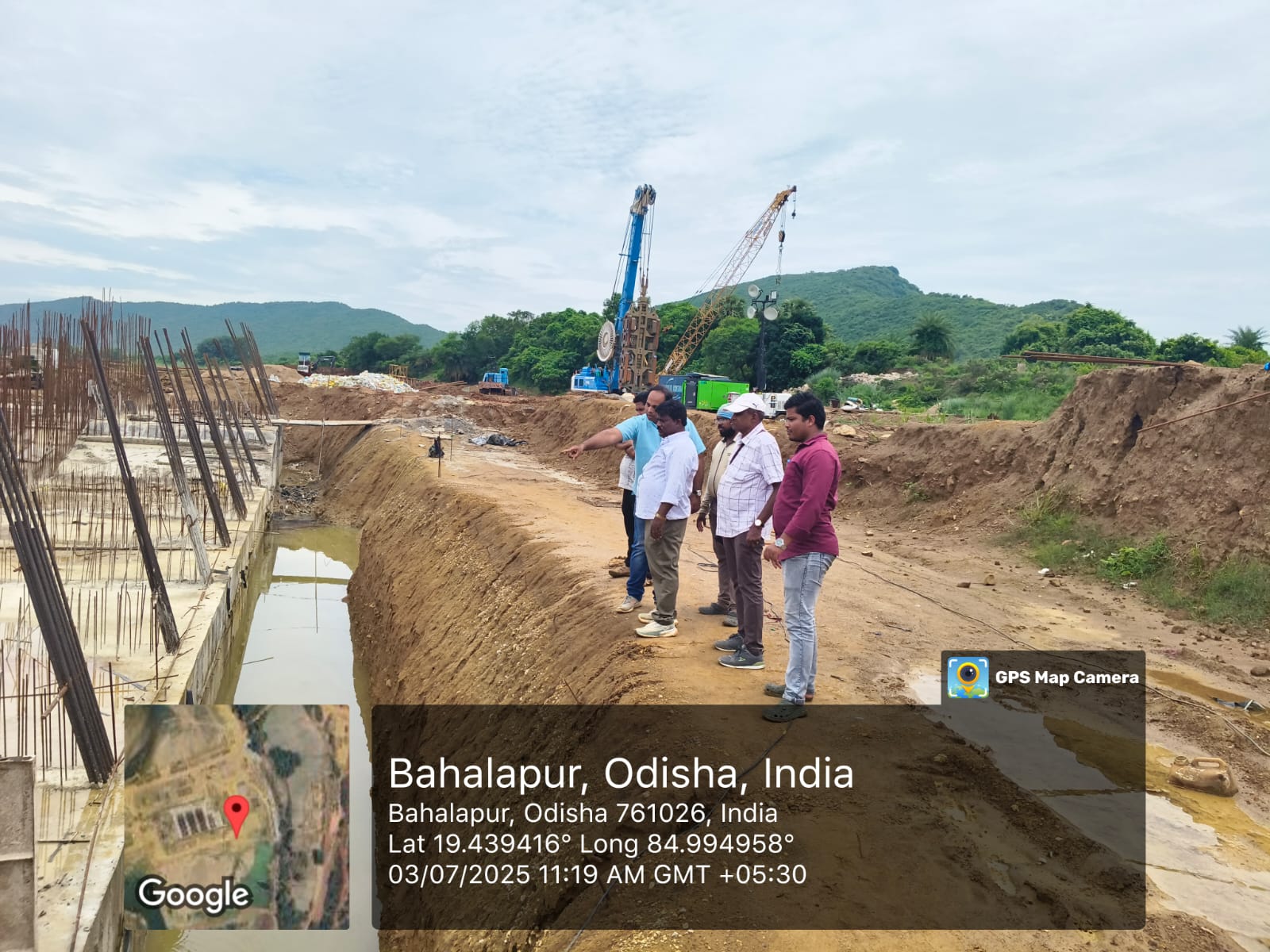

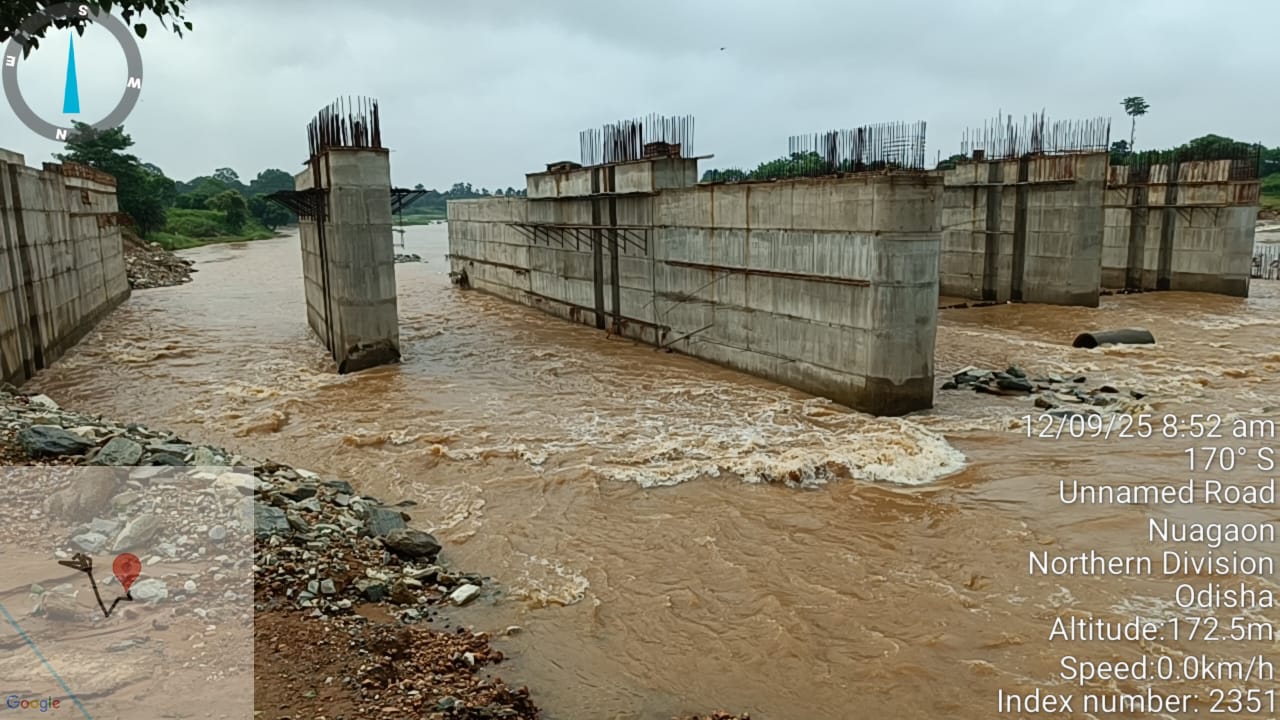

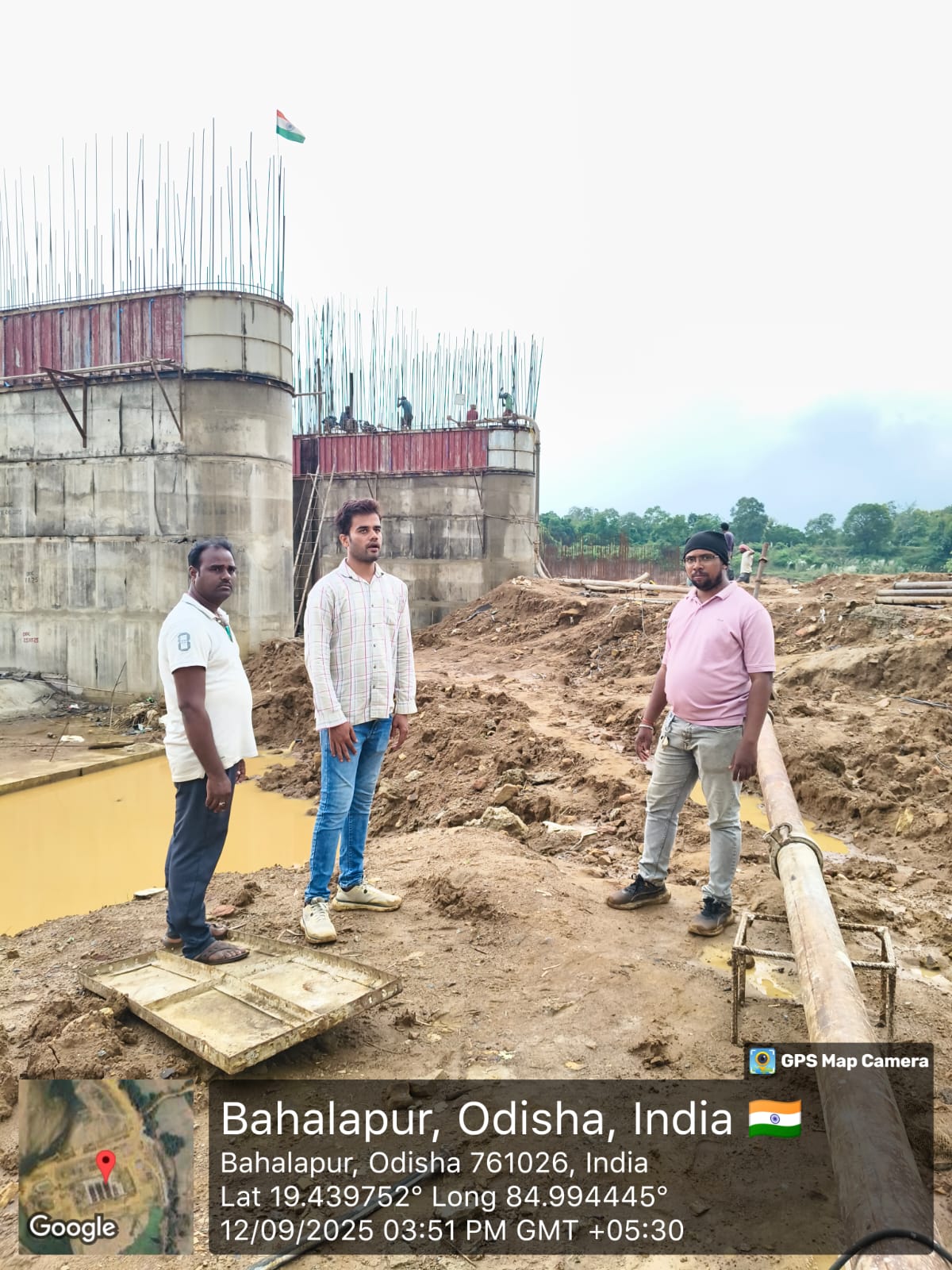

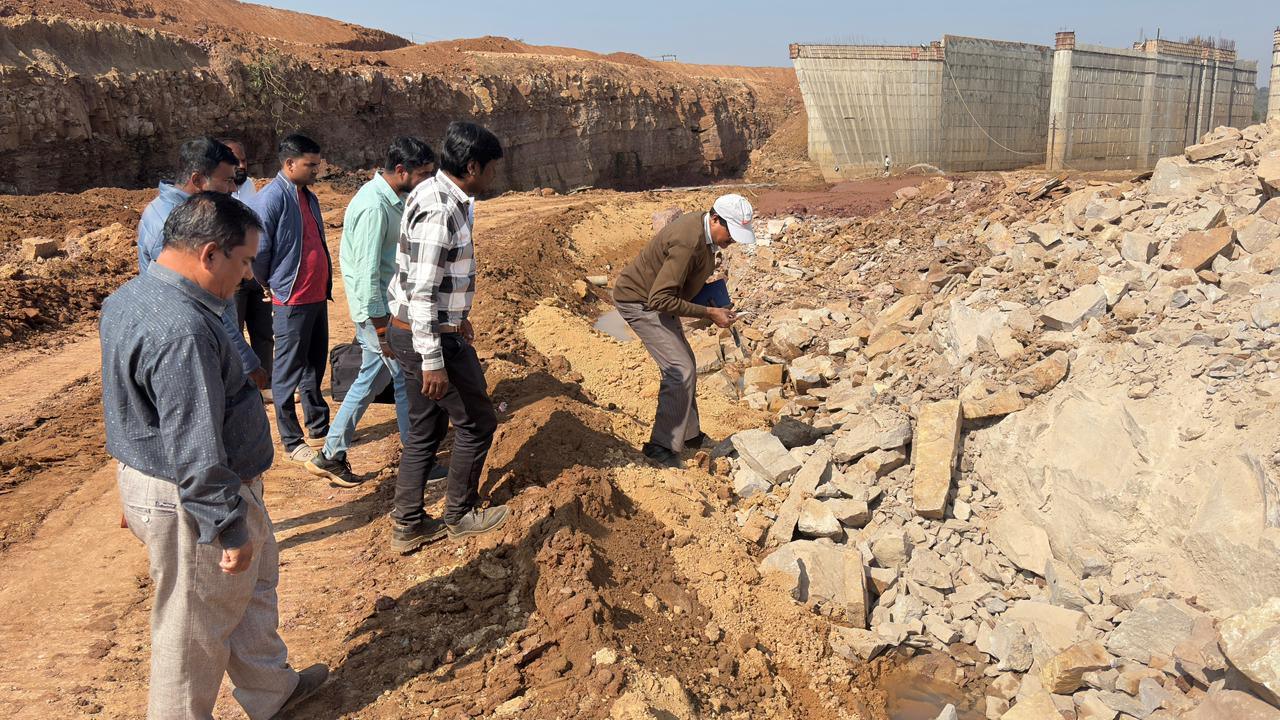

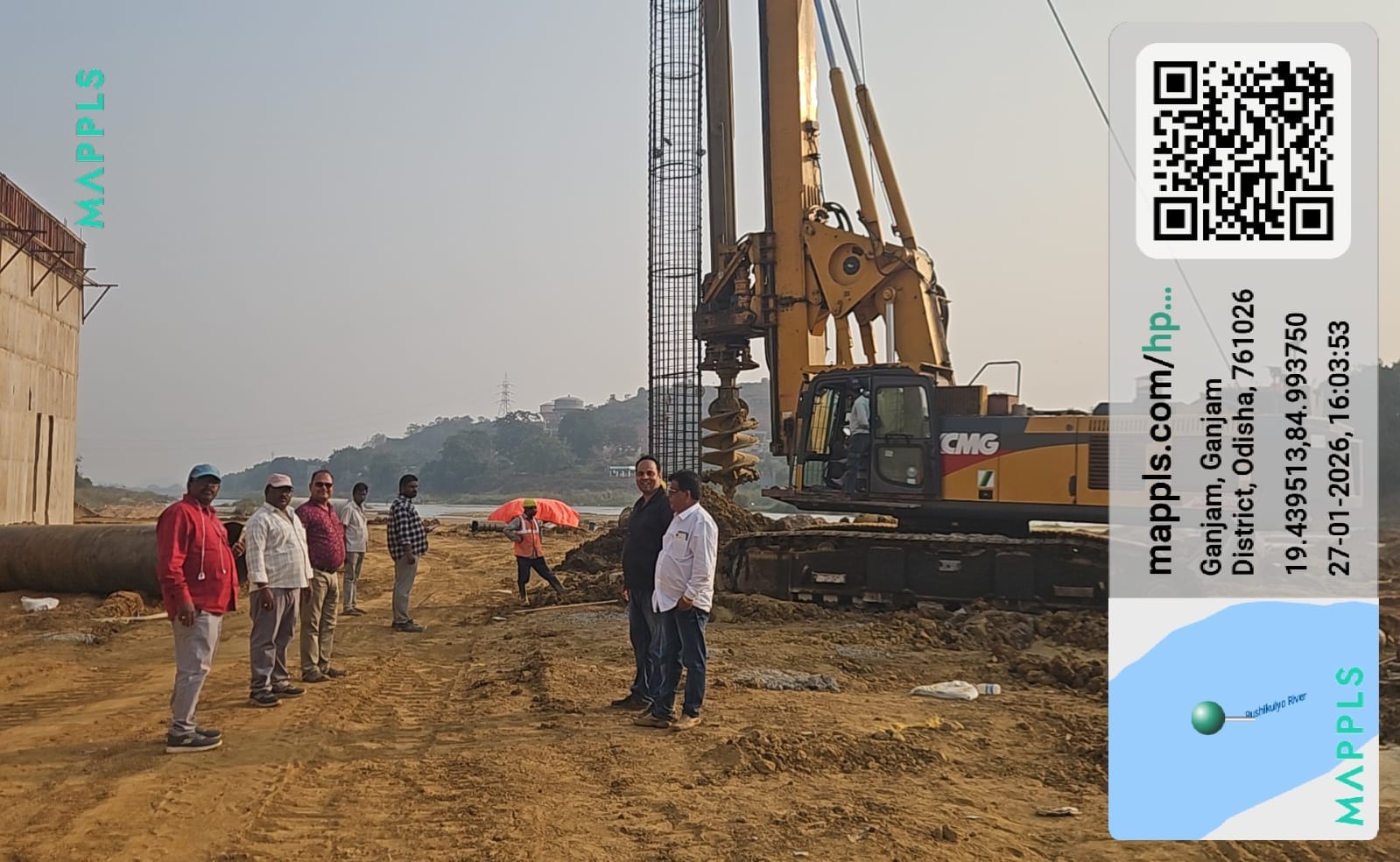

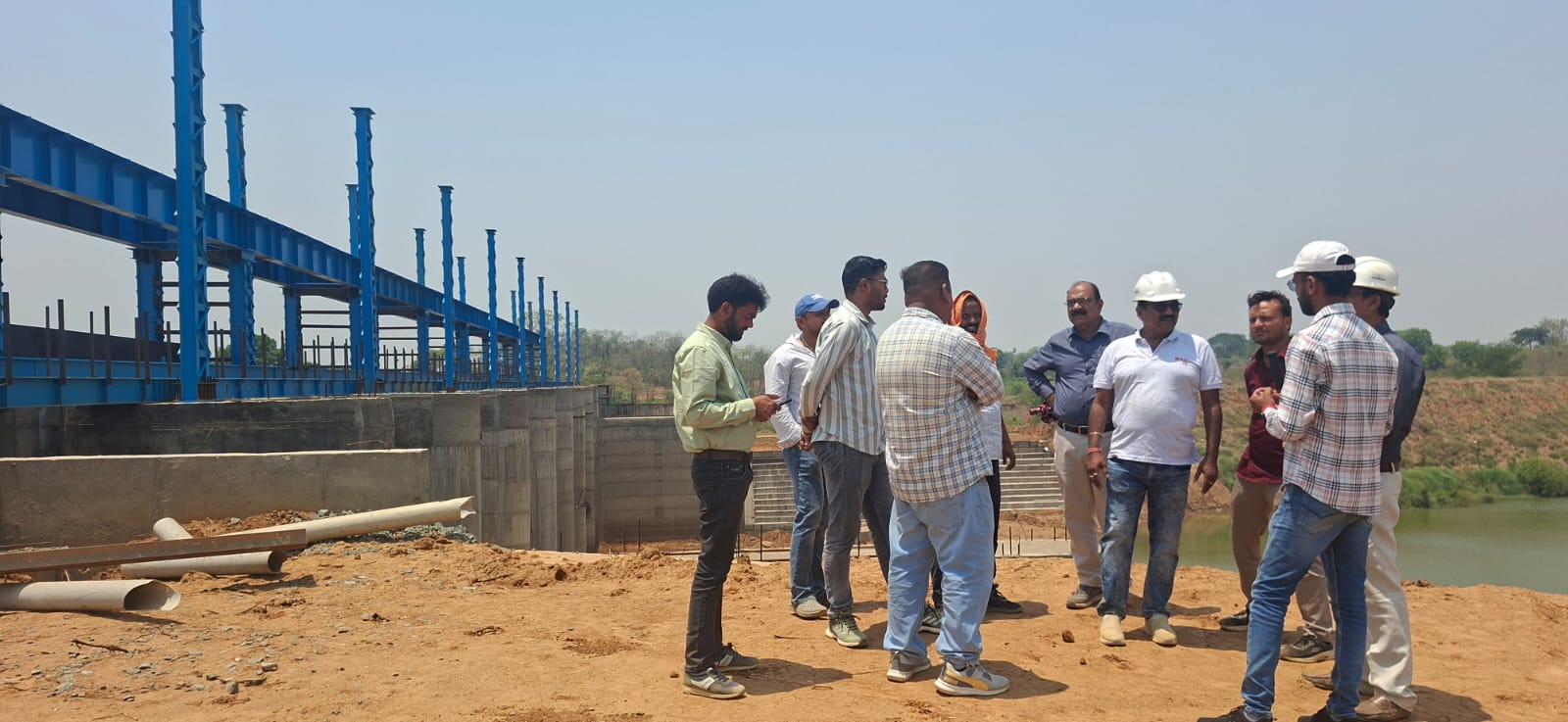

Visit of SD Expert, PMC to RI Laxmana Pali, RI Chirikipada and SDO, Dhanei during the visit to ISS Sanabargam today (24.9.2026). Updated them on the latest status of land acquisition and made discussion on re-demarcation of private land scheduled for 01.10.2026, and the Collector’s letter(letter no:619 dt:1.9.26) to the Tahasildar, Polasara regarding demarcation of Government land by deploying revenue team.
2/100

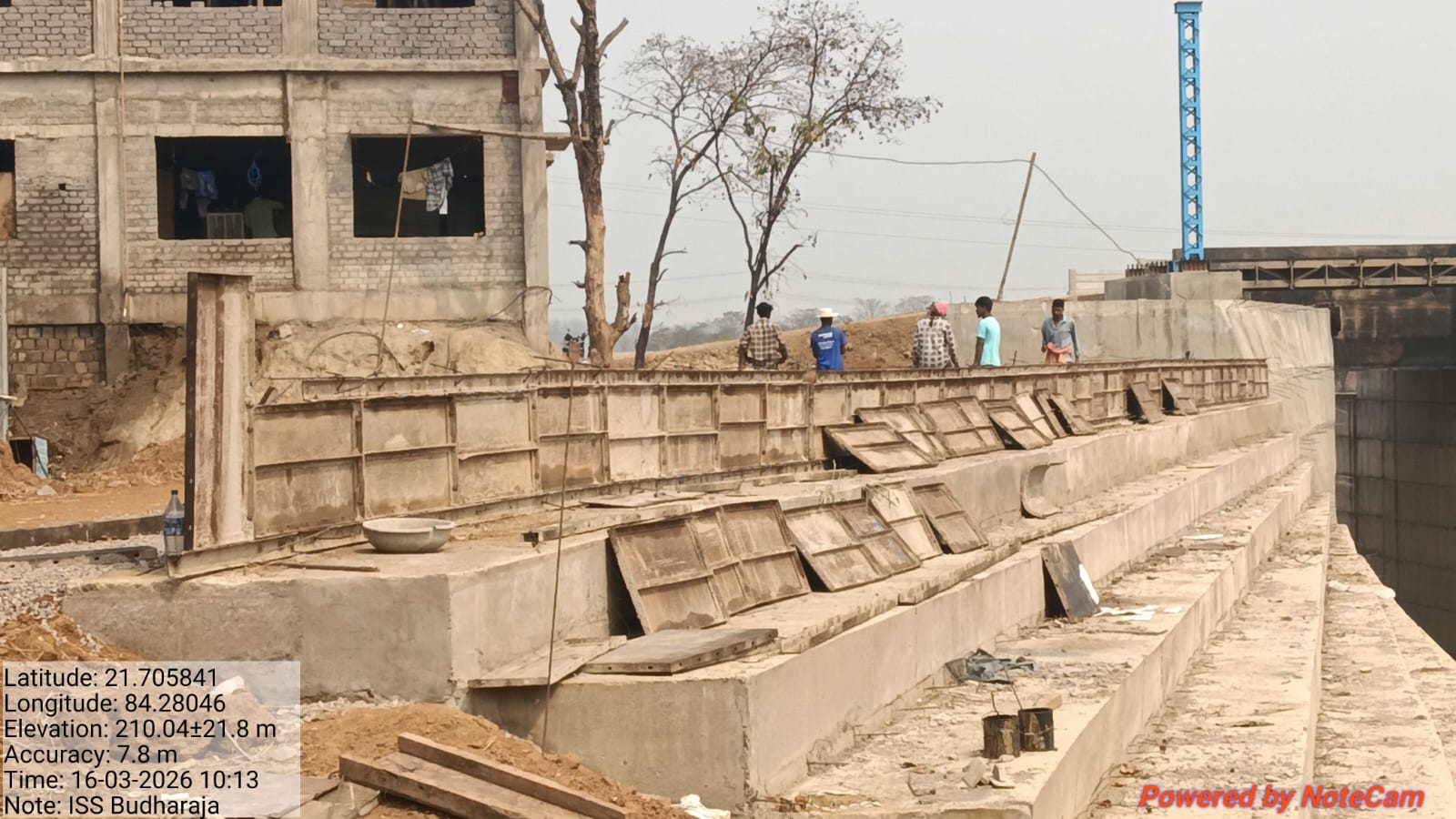

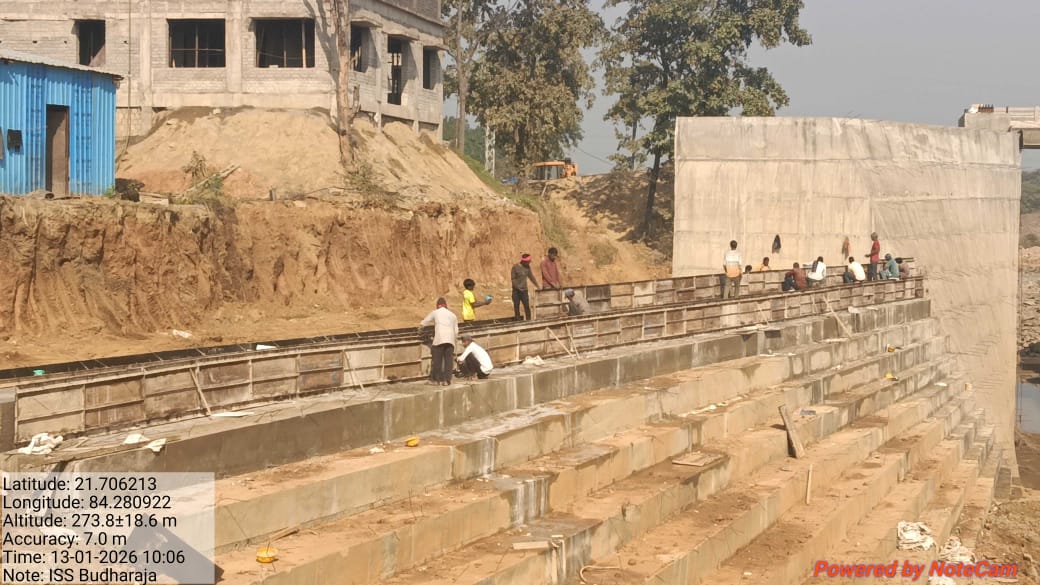

Instream Storage Structure, Dhanei
Visit of SD Expert, PMC to RI Laxmana Pali, RI Chirikipada and SDO, Dhanei during the visit to ISS Sanabargam today (24.9.2026). Updated them on the latest status of land acquisition and made discussion on re-demarcation of private land scheduled for 01.10.2026, and the Collector’s letter(letter no:619 dt:1.9.26) to the Tahasildar, Polasara regarding demarcation of Government land by deploying revenue team.
3/100
Instream Storage Structure, Dhanei

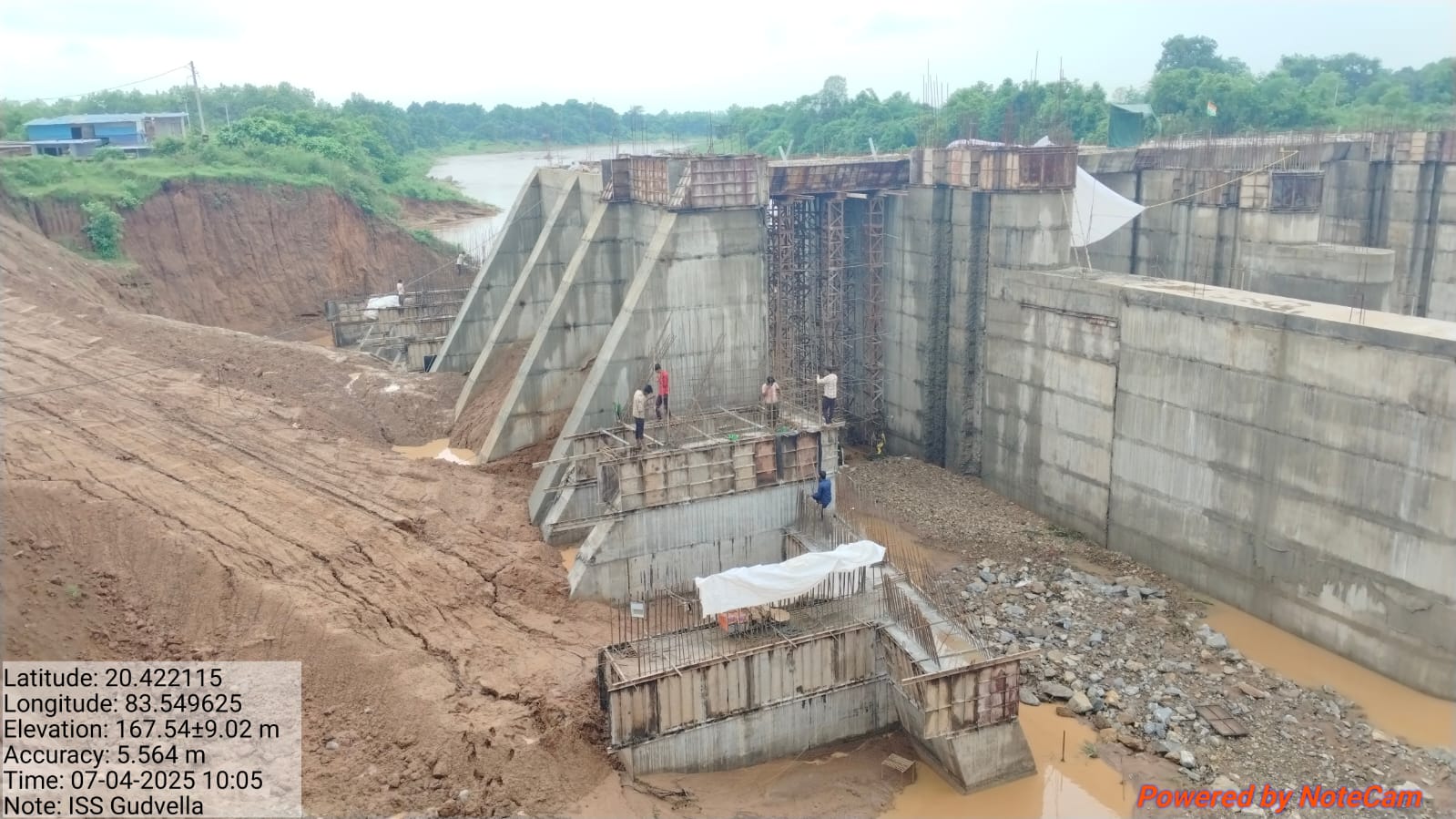

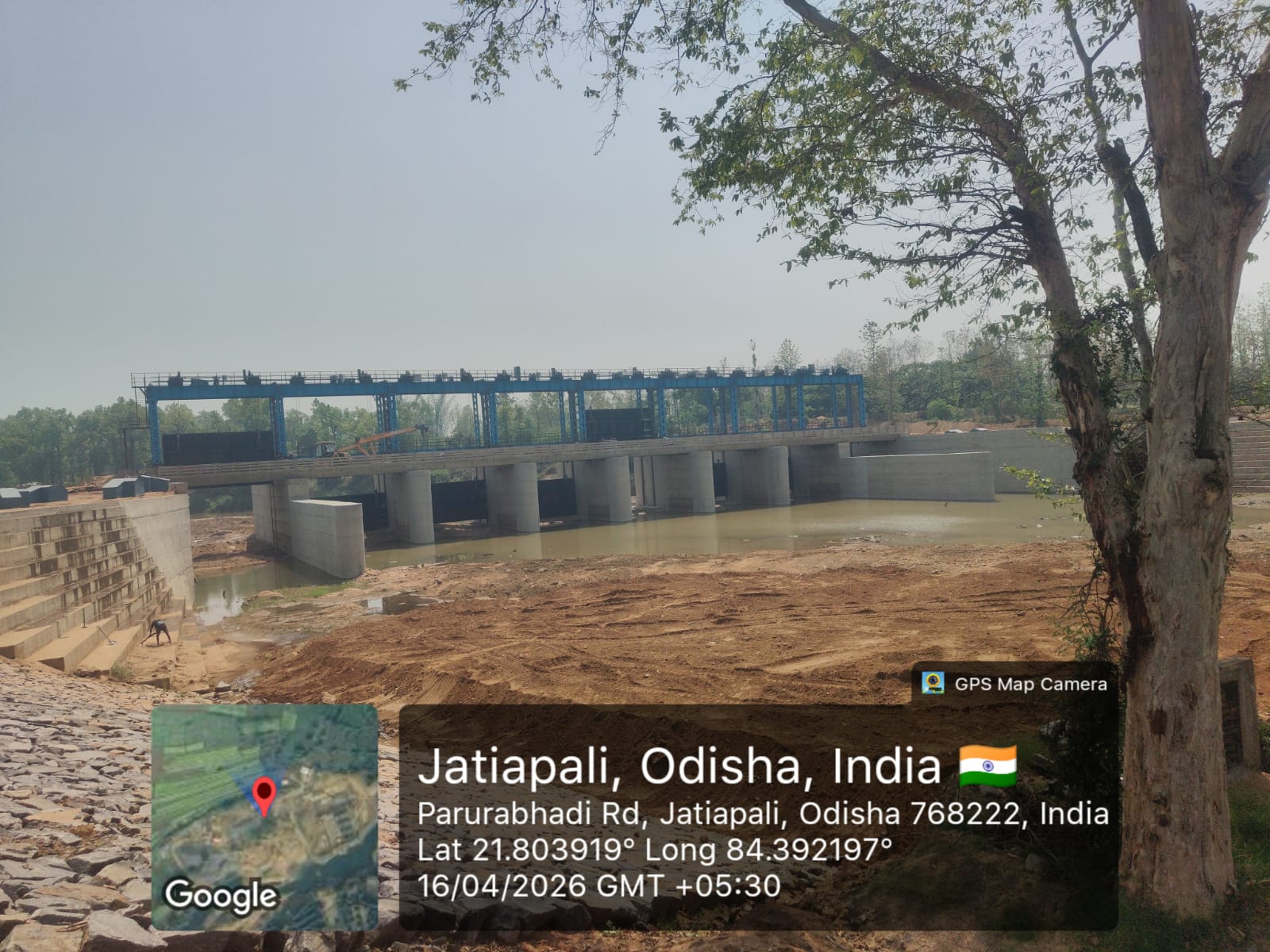

Visit of SD Expert, PMC to RI Laxmana Pali, RI Chirikipada and SDO, Dhanei during the visit to ISS Sanabargam today (24.9.2026). Updated them on the latest status of land acquisition and made discussion on re-demarcation of private land scheduled for 01.10.2026, and the Collector’s letter(letter no:619 dt:1.9.26) to the Tahasildar, Polasara regarding demarcation of Government land by deploying revenue team.
4/100

Instream Storage Structure, KansariGanda
24.09.26

5/100
Instream Storage Structure, KansariGanda
24.09.26
6/100
Instream Storage Structure, KansariGanda
24.09.26
7/100
Instream Storage Structure, KansariGanda
24.09.26
8/100

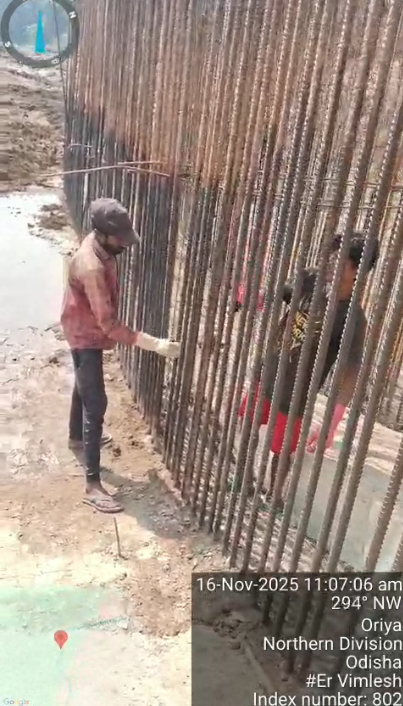

Instream Storage Structure, KansariGanda
22.09.26
9/100
Instream Storage Structure, KansariGanda

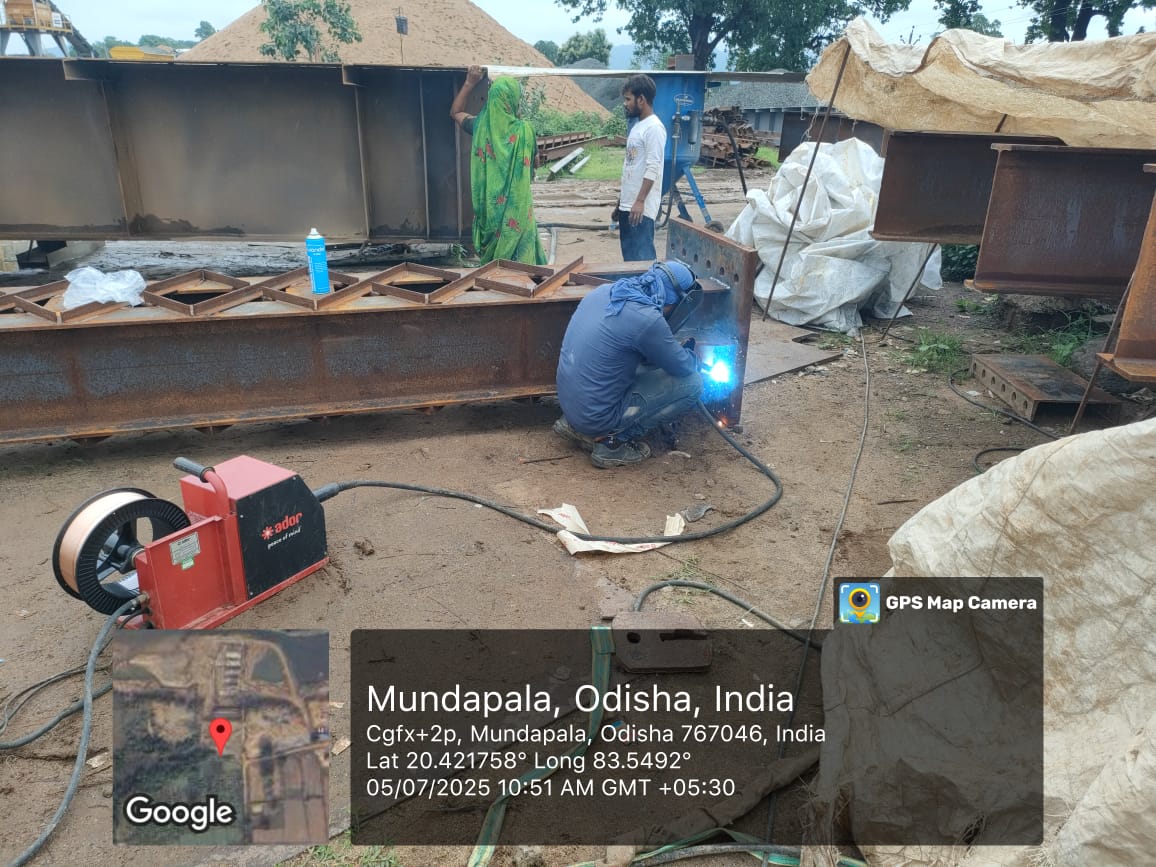

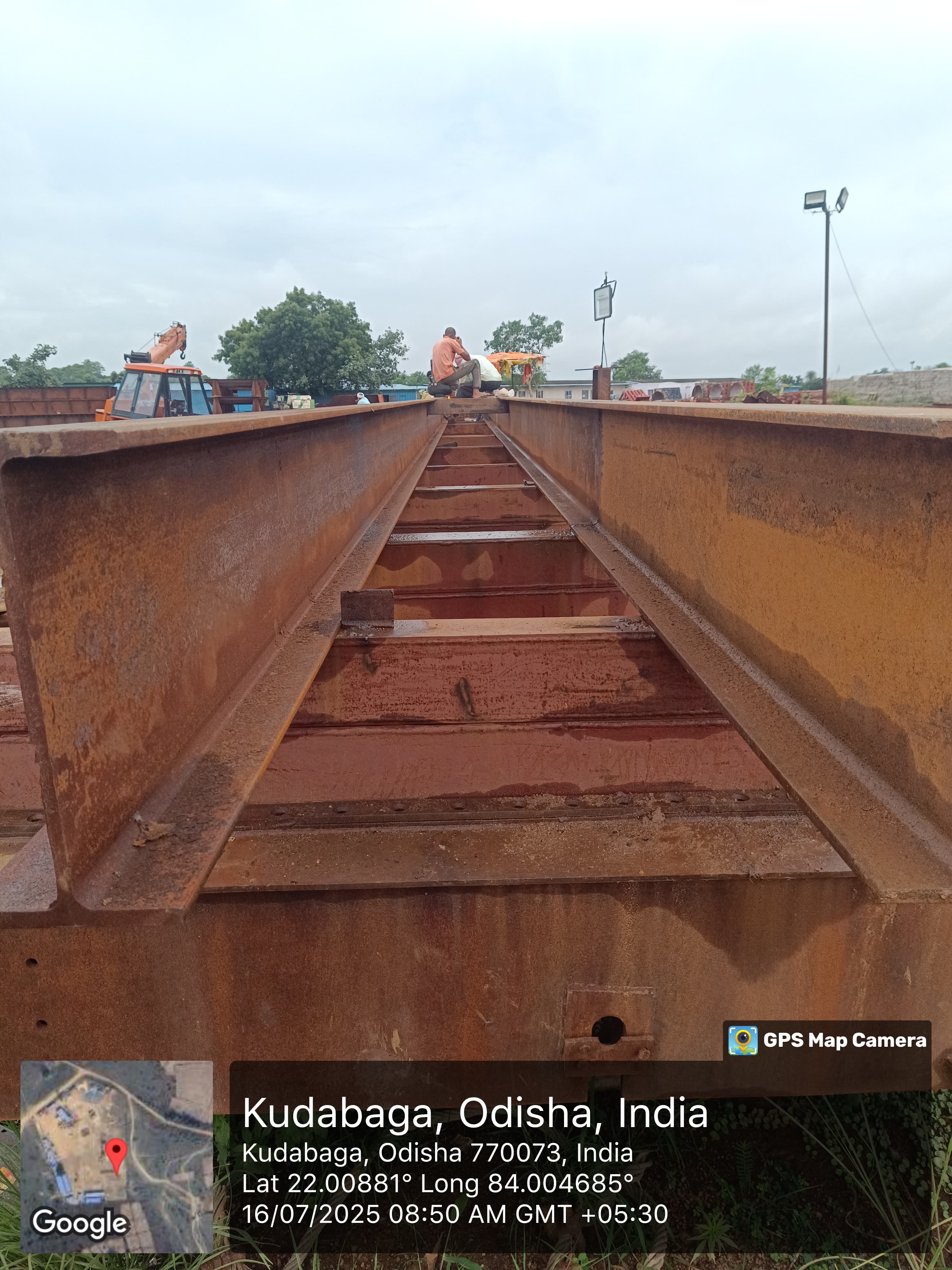

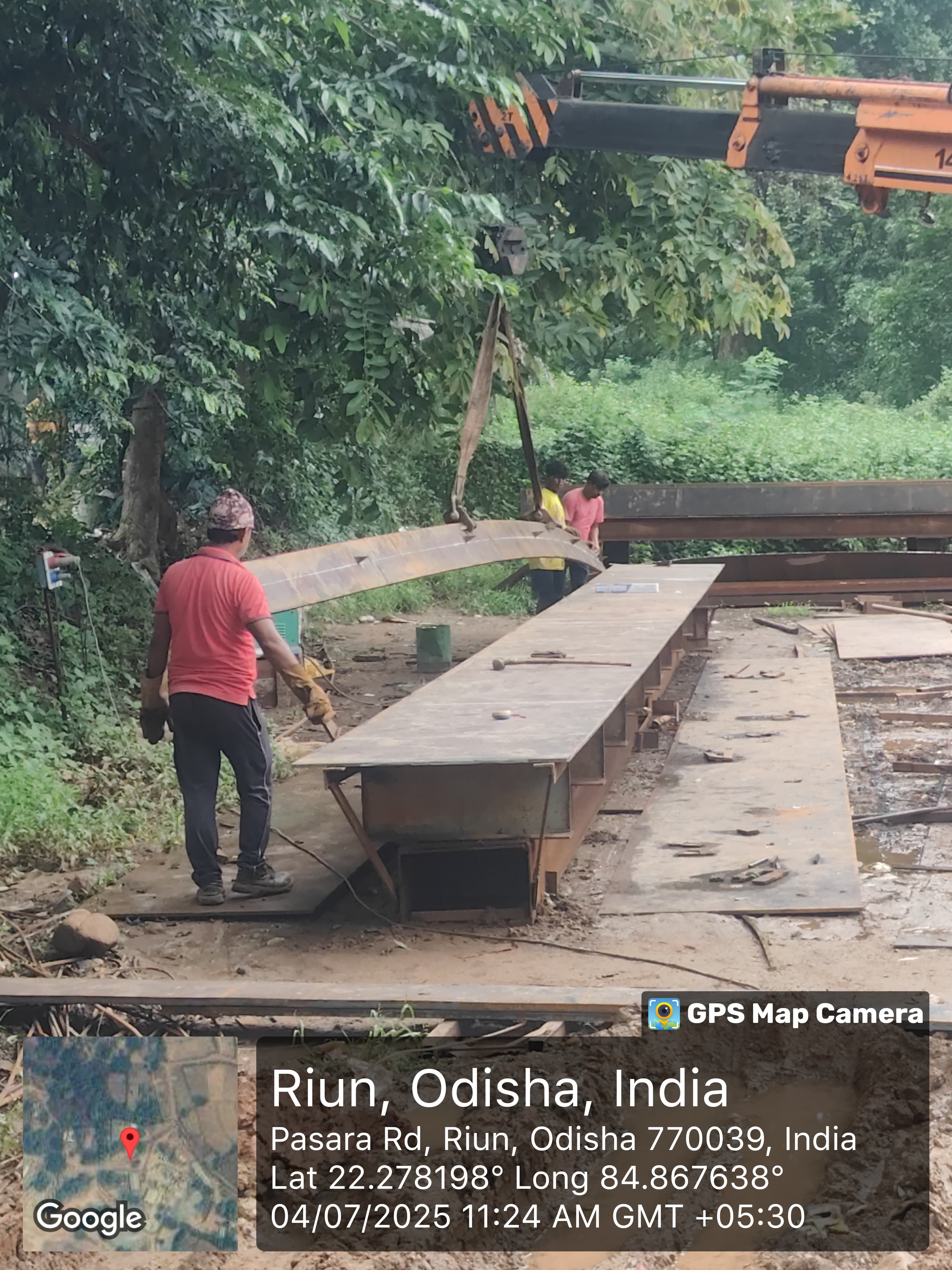

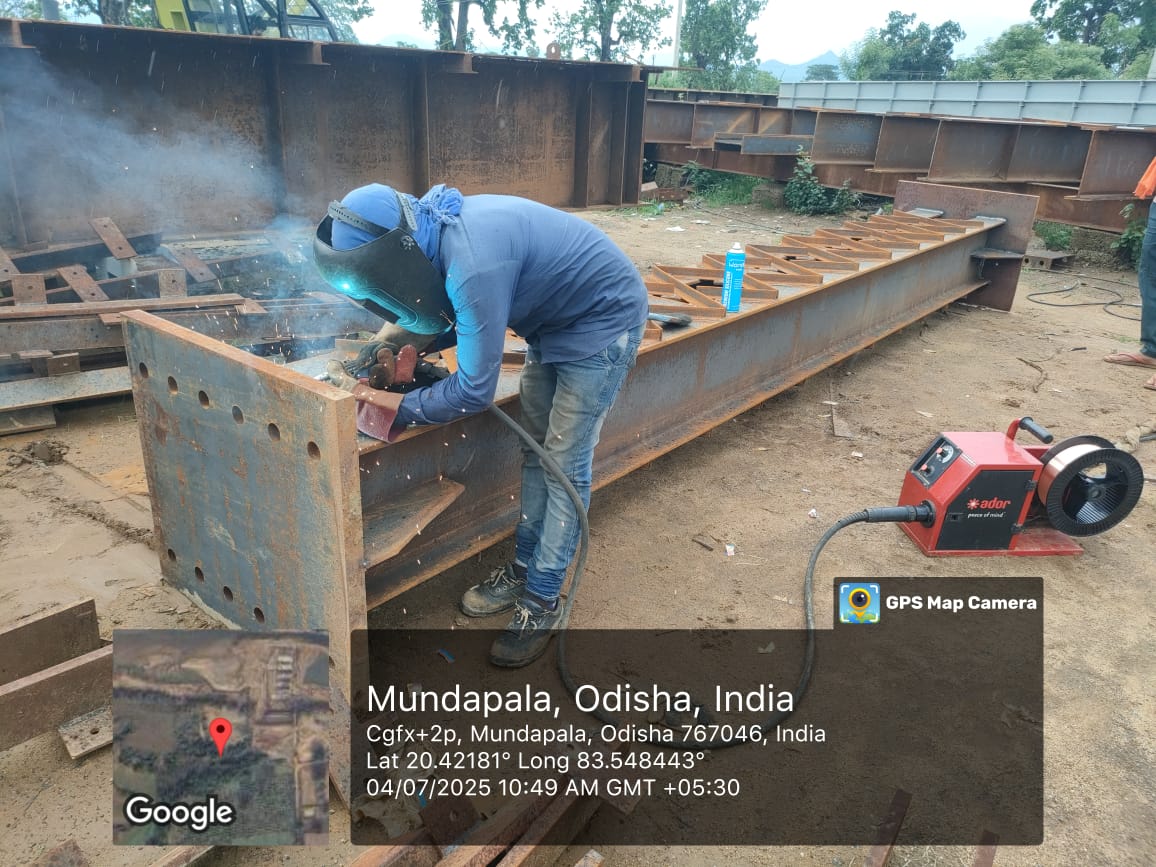

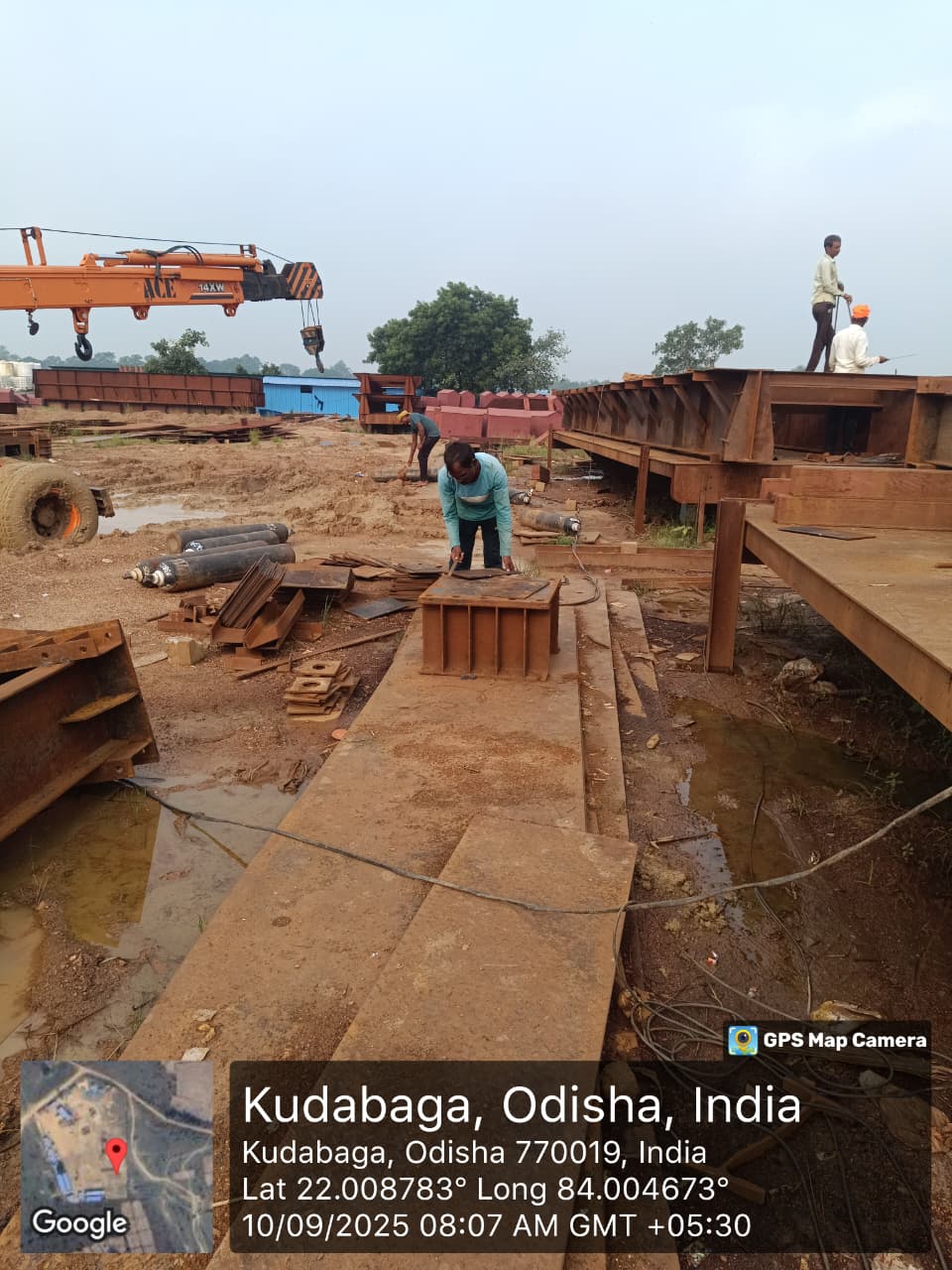

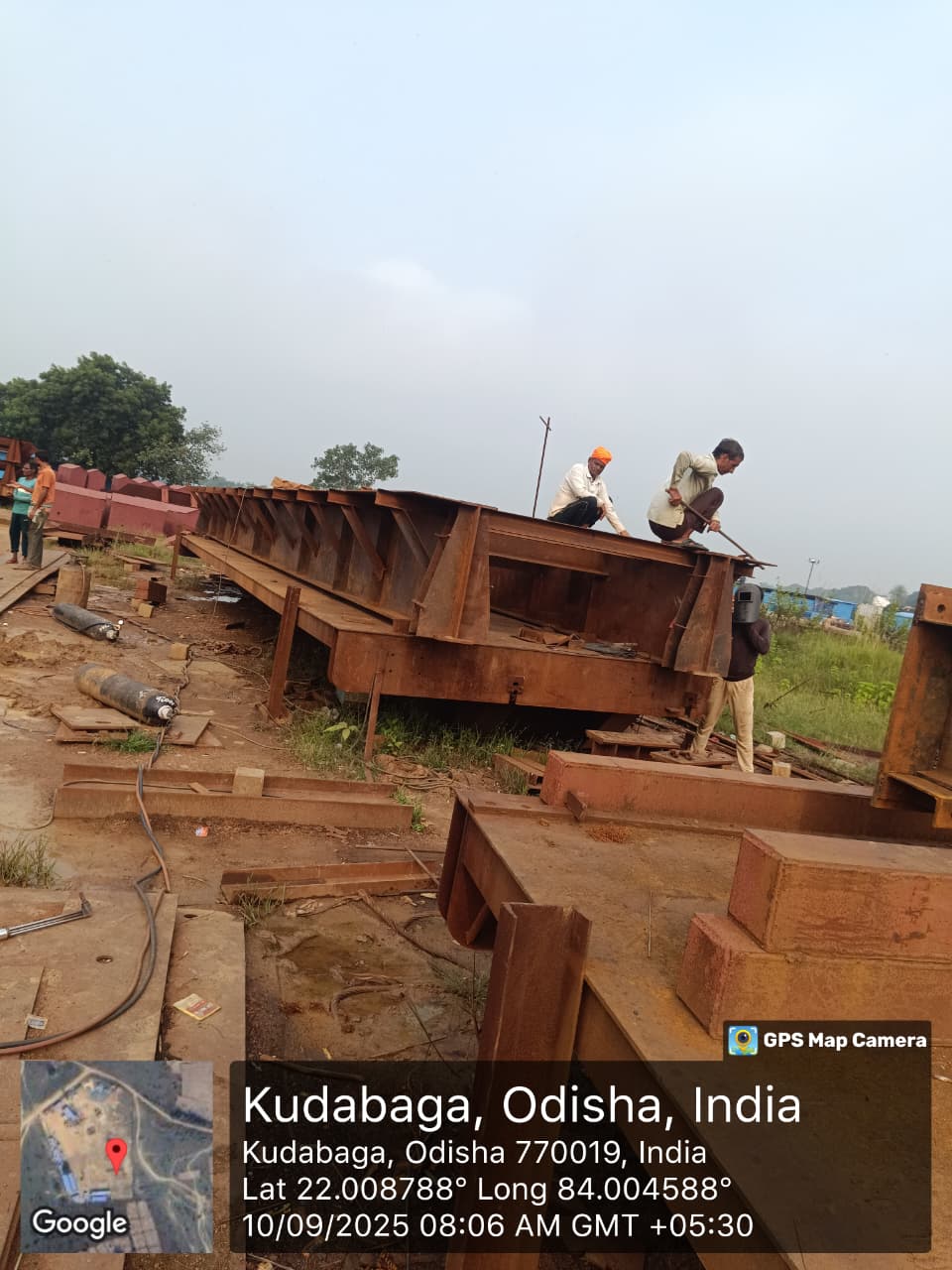

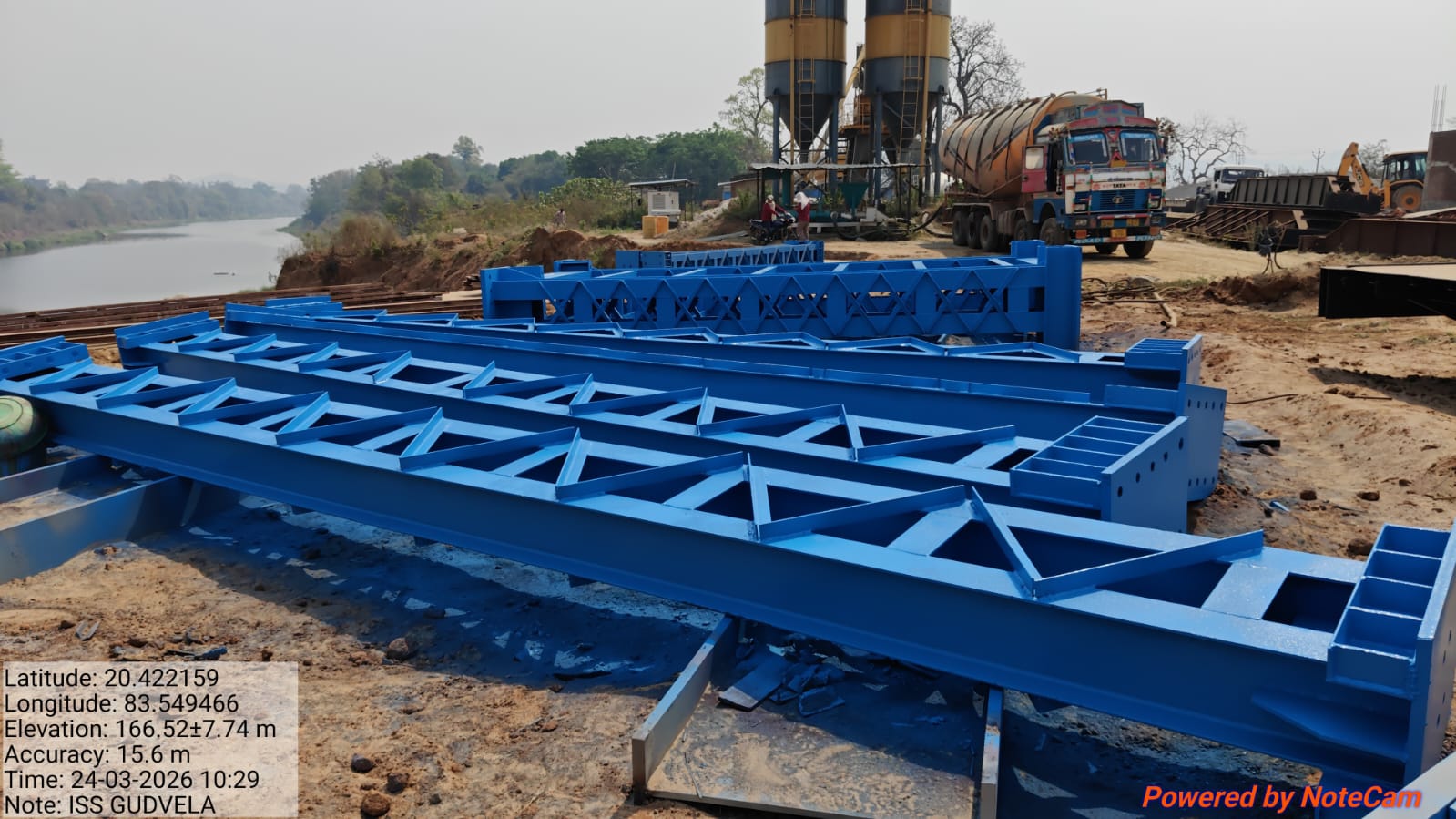

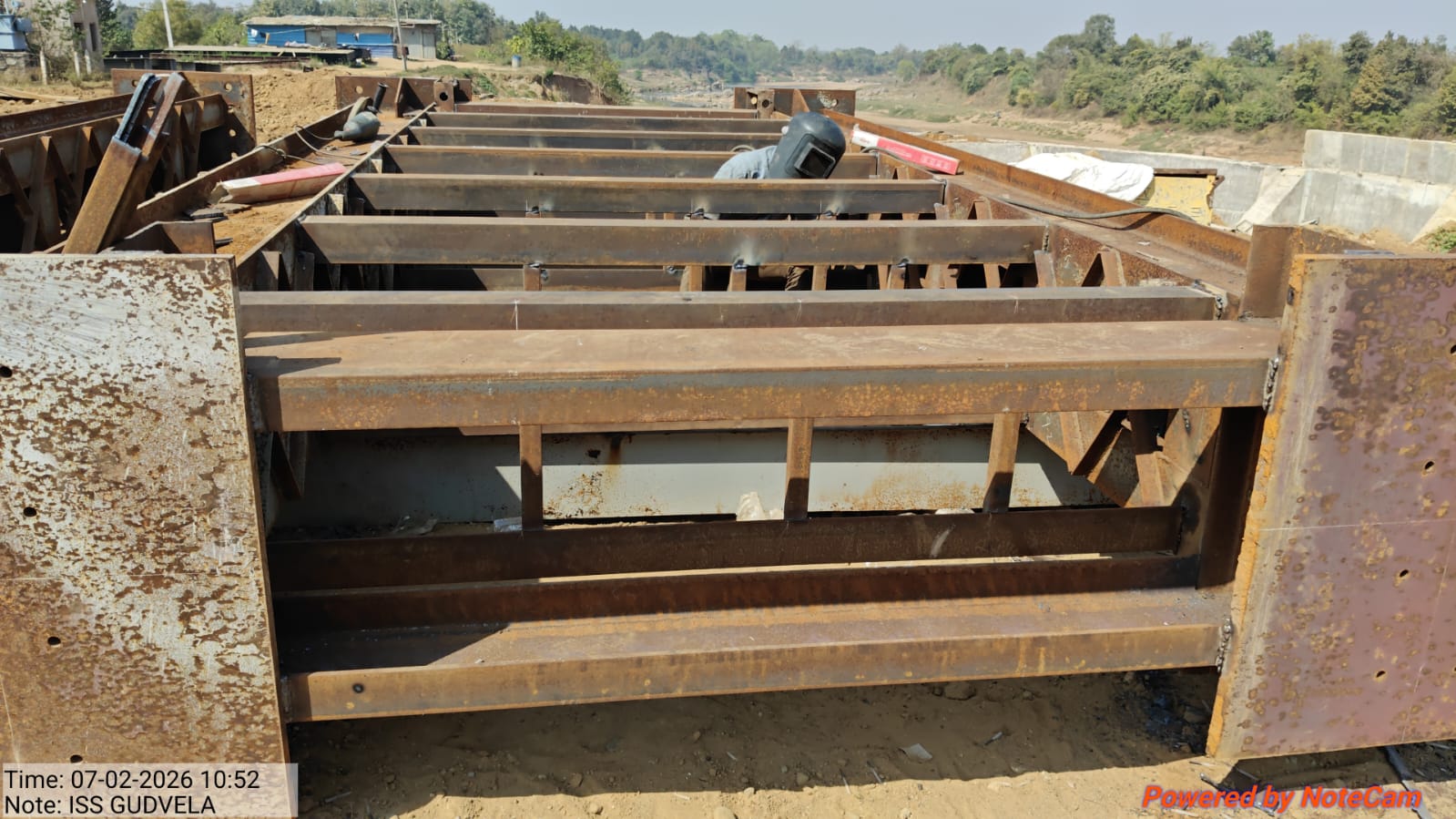

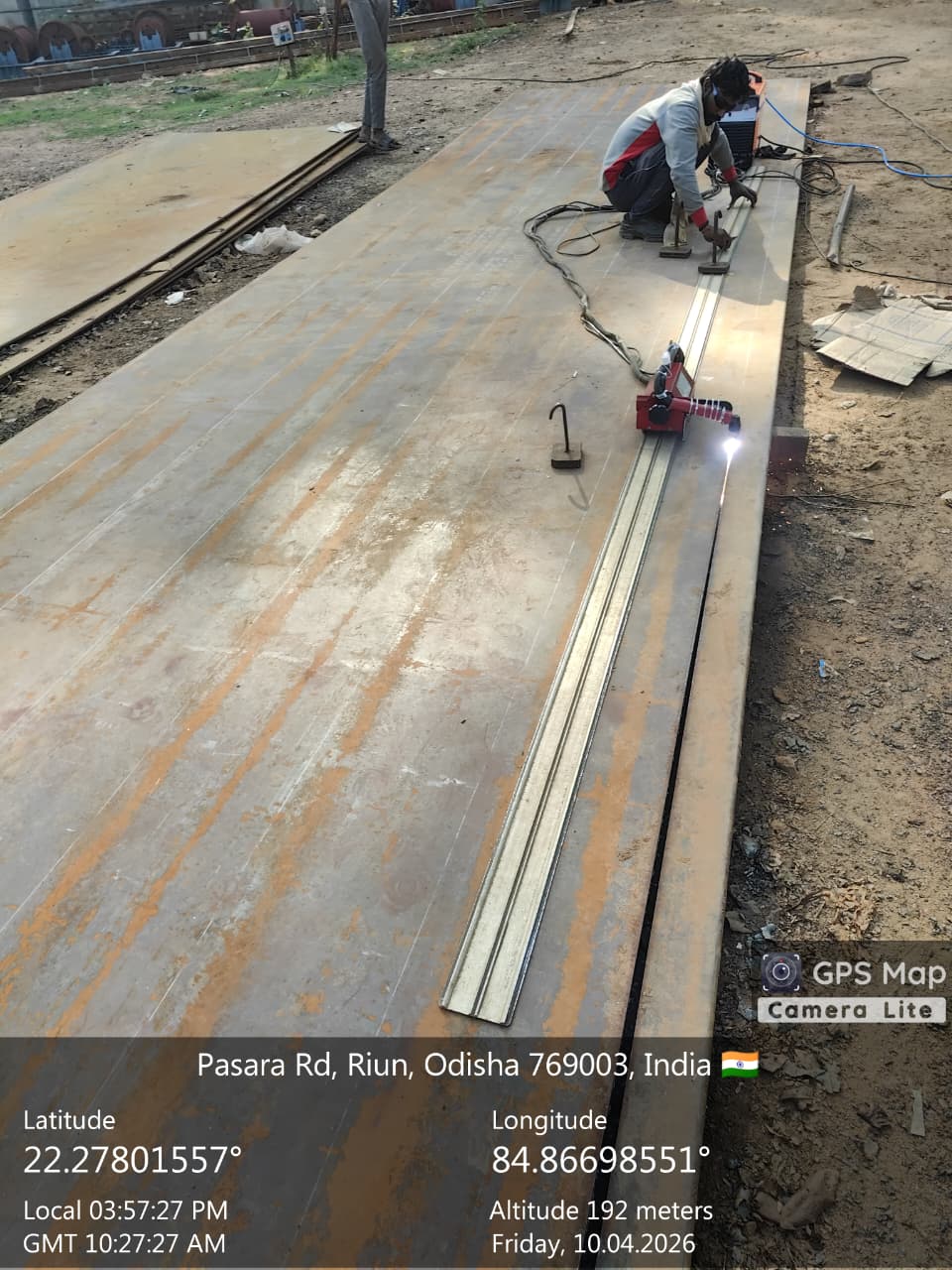

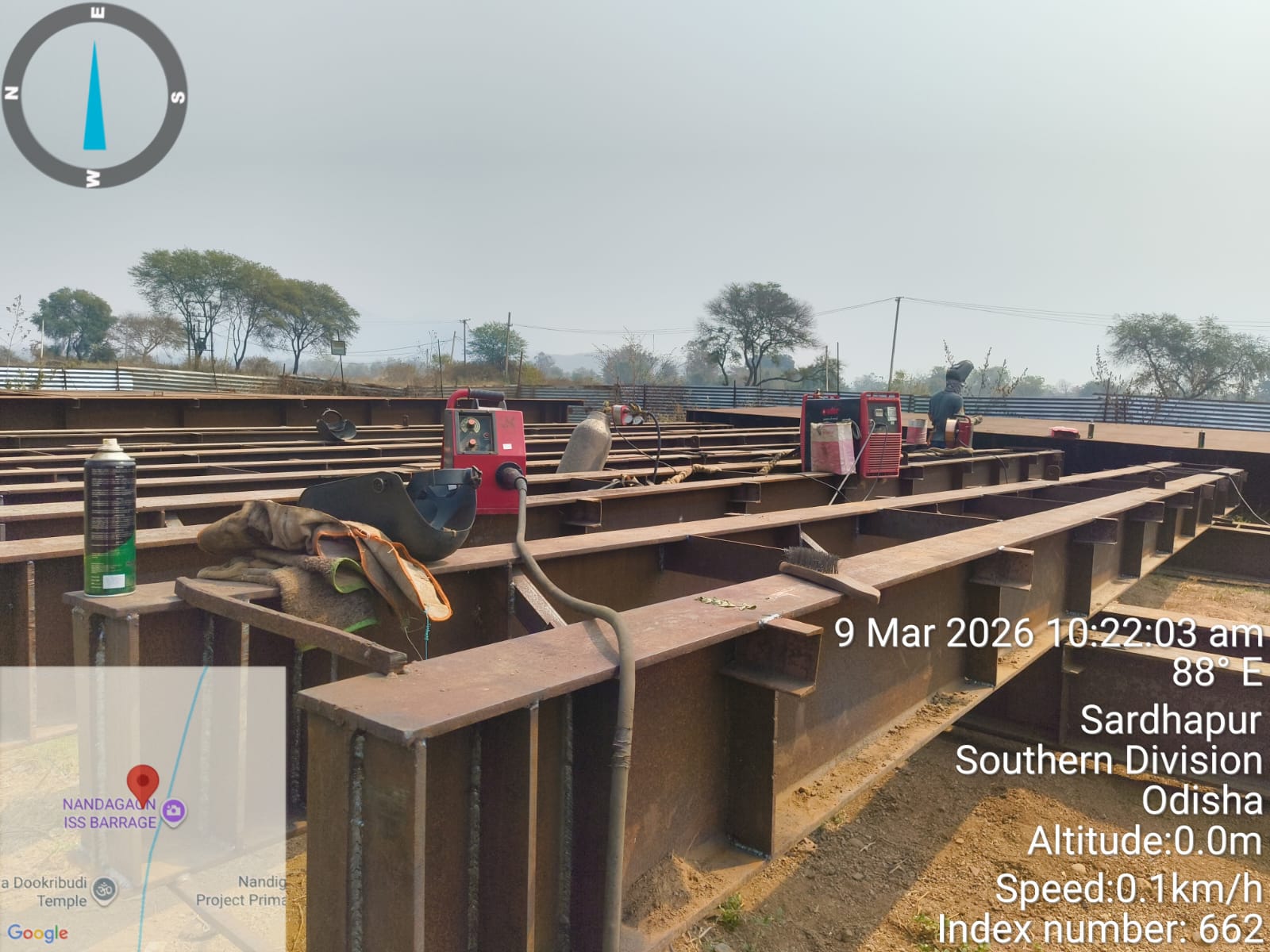

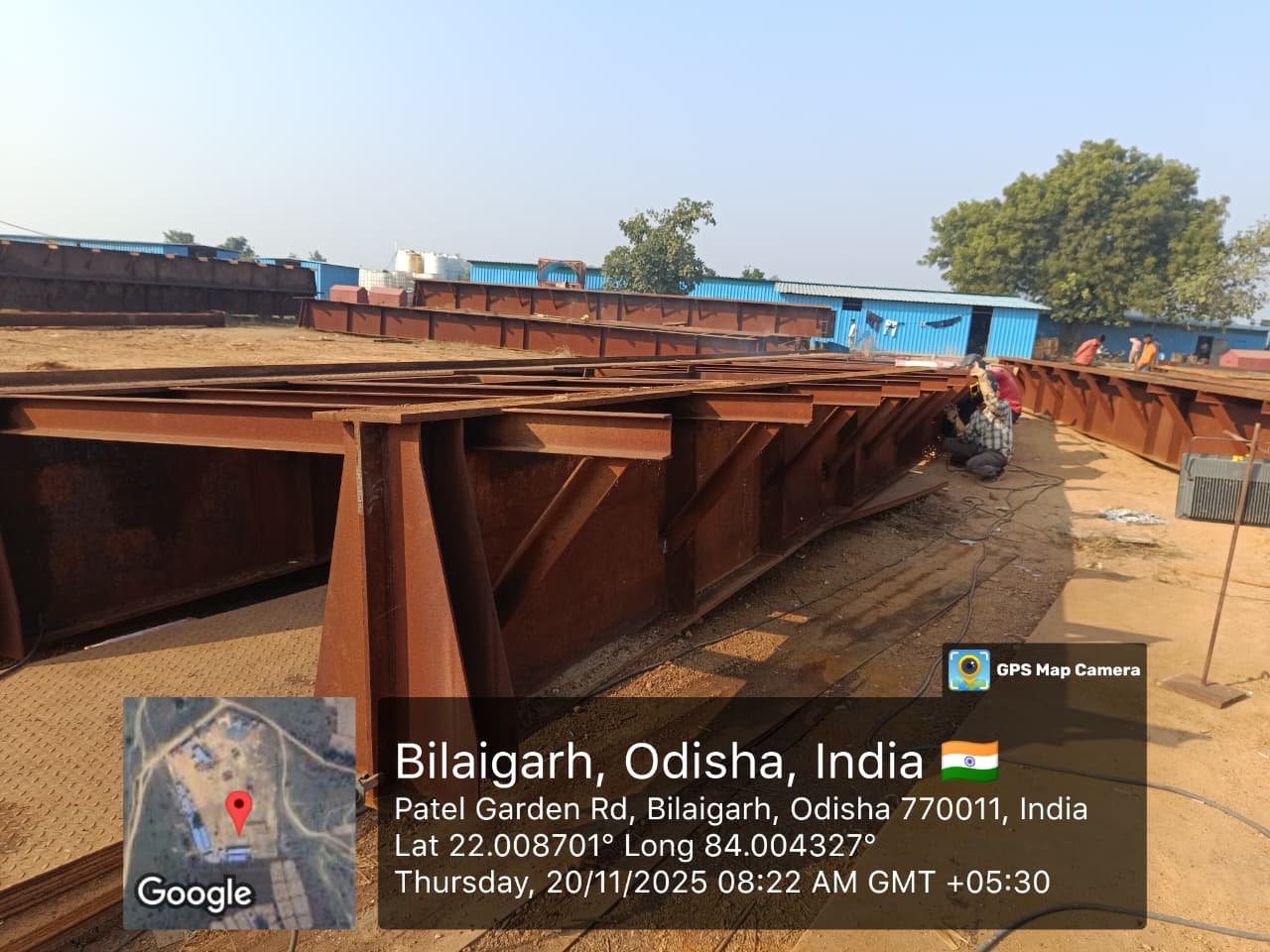

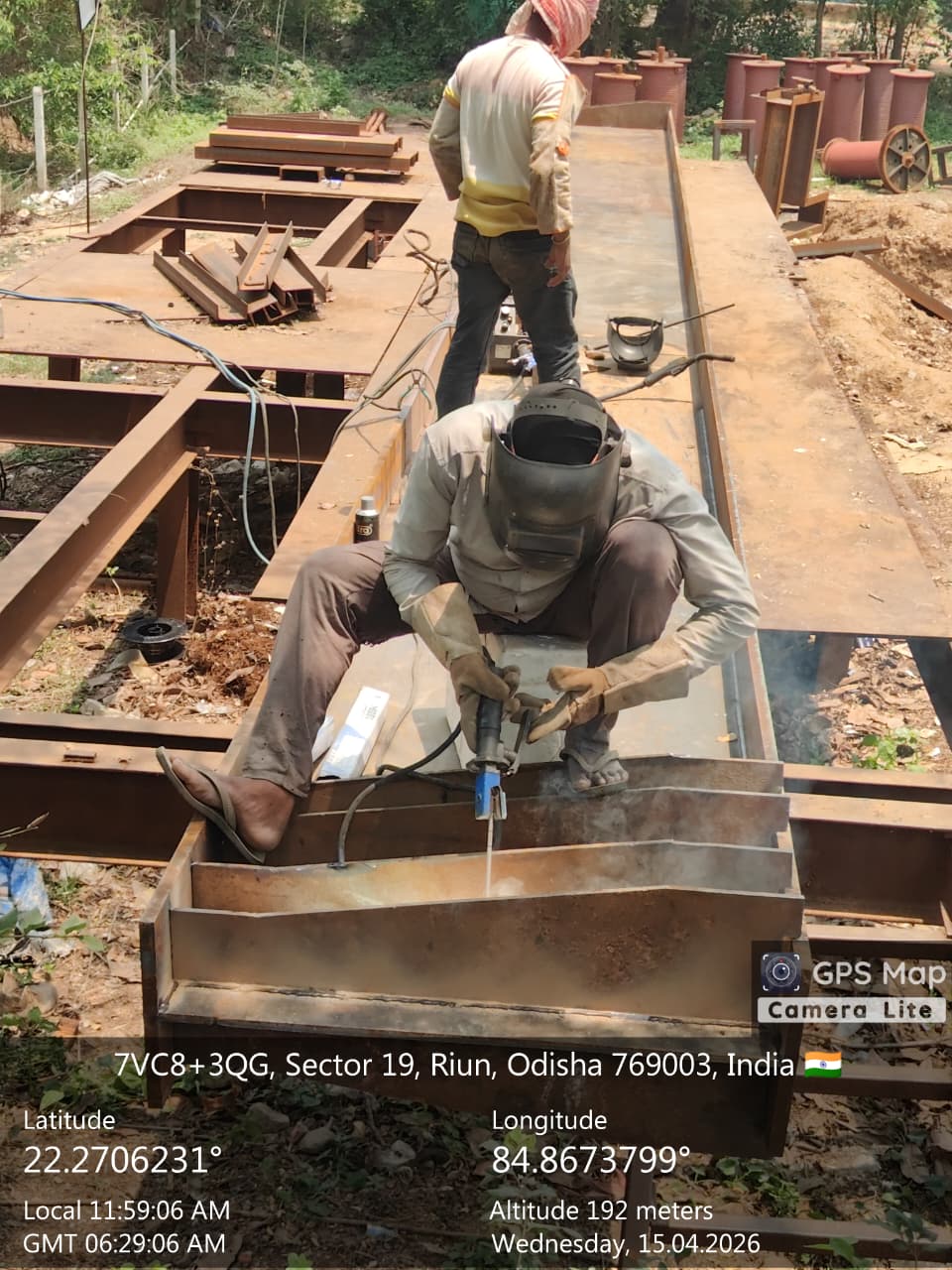

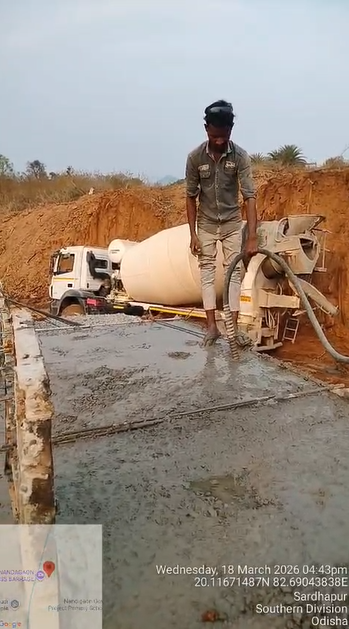

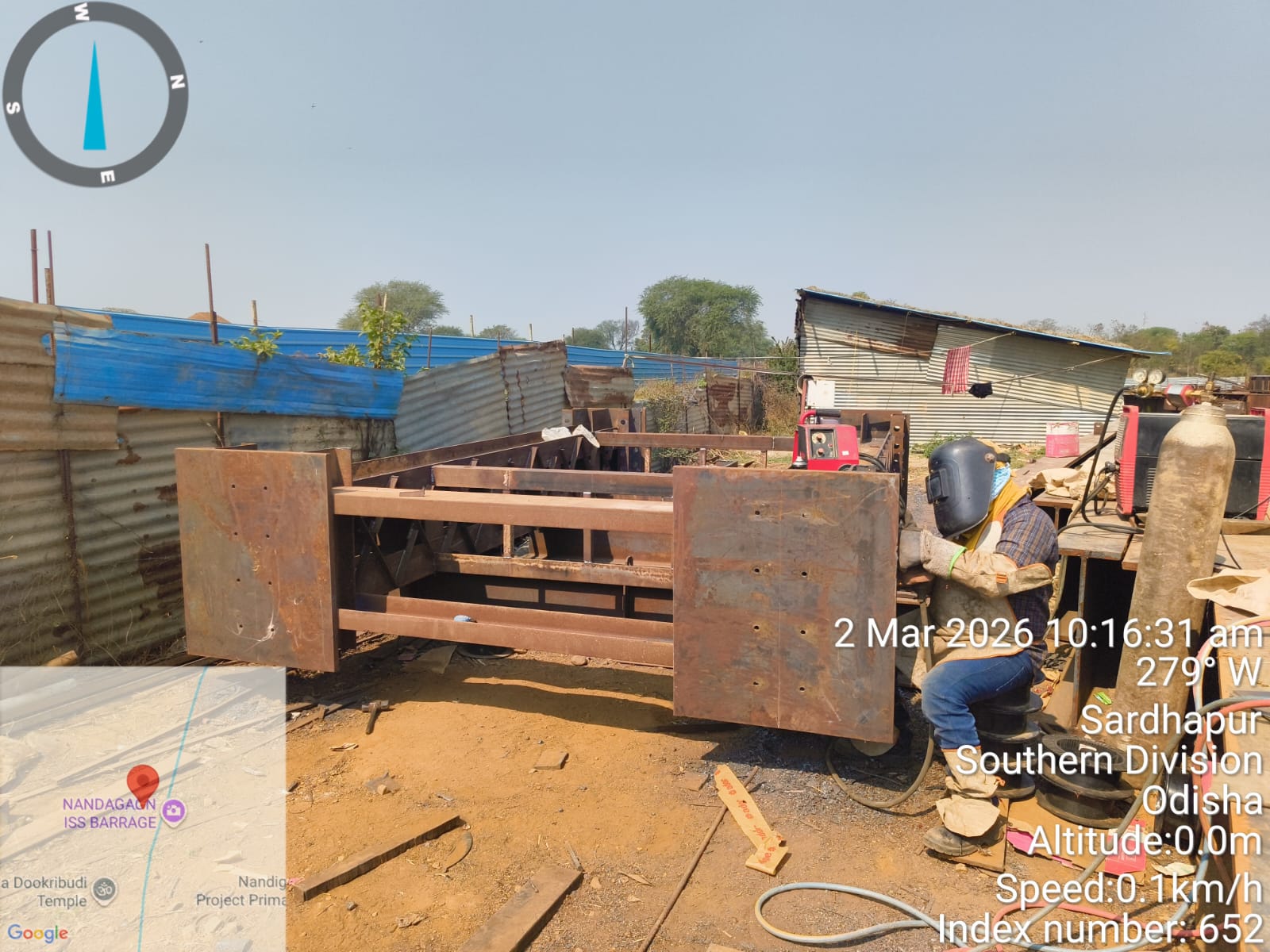

Mechanical Gate and Trestle fabrication work in progress
10/100

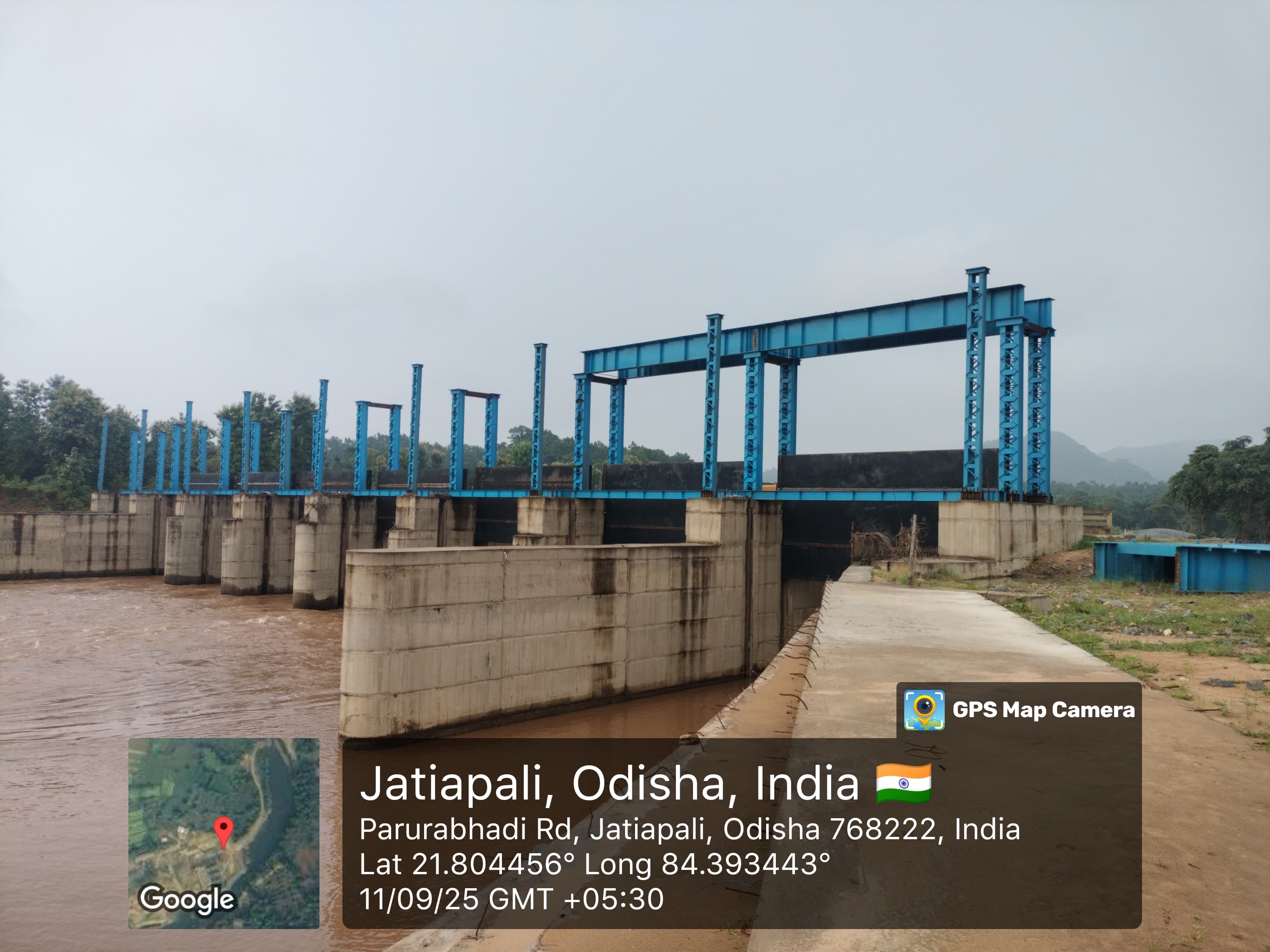

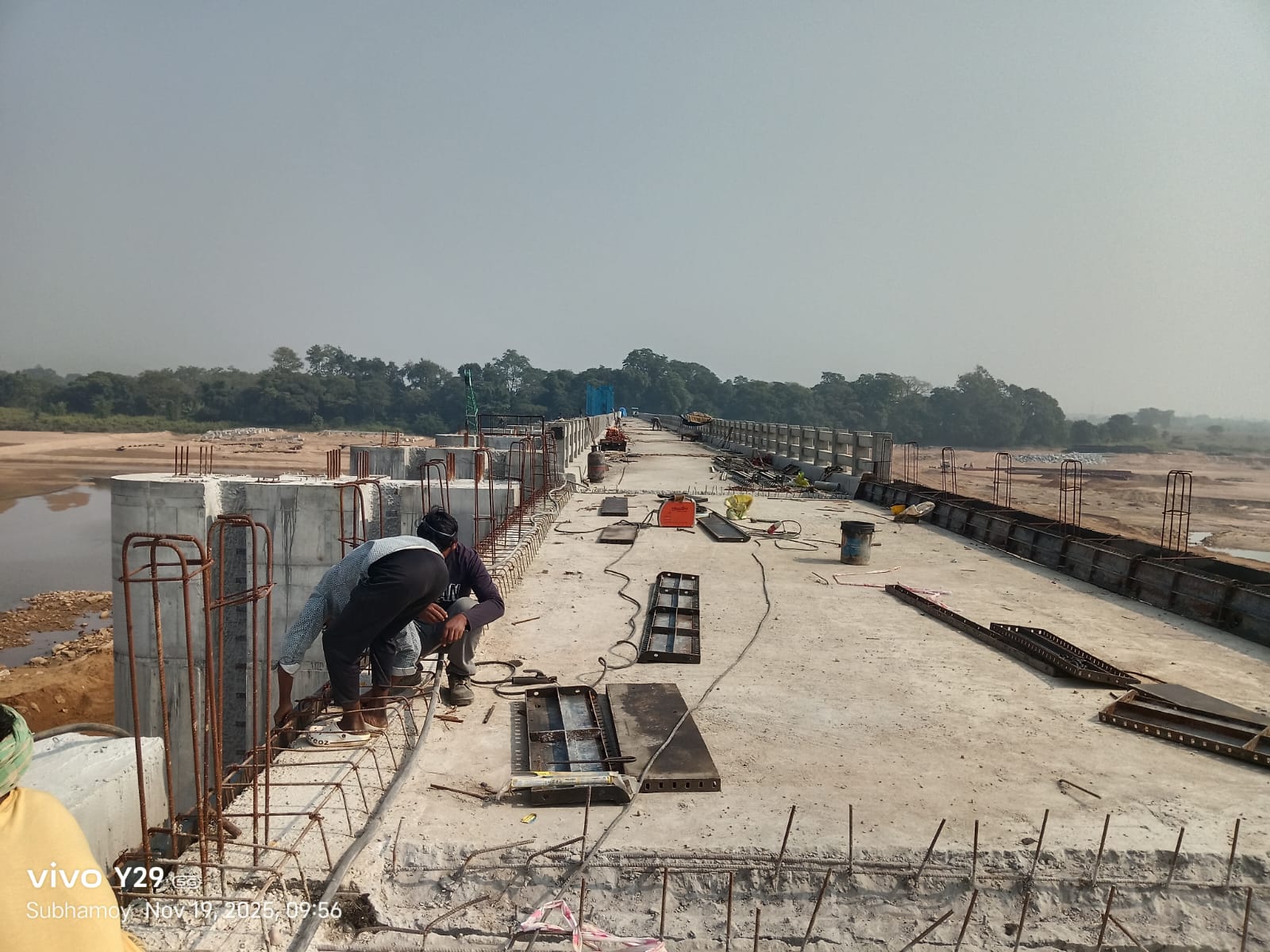

Instream Storage Structure, KansariGanda

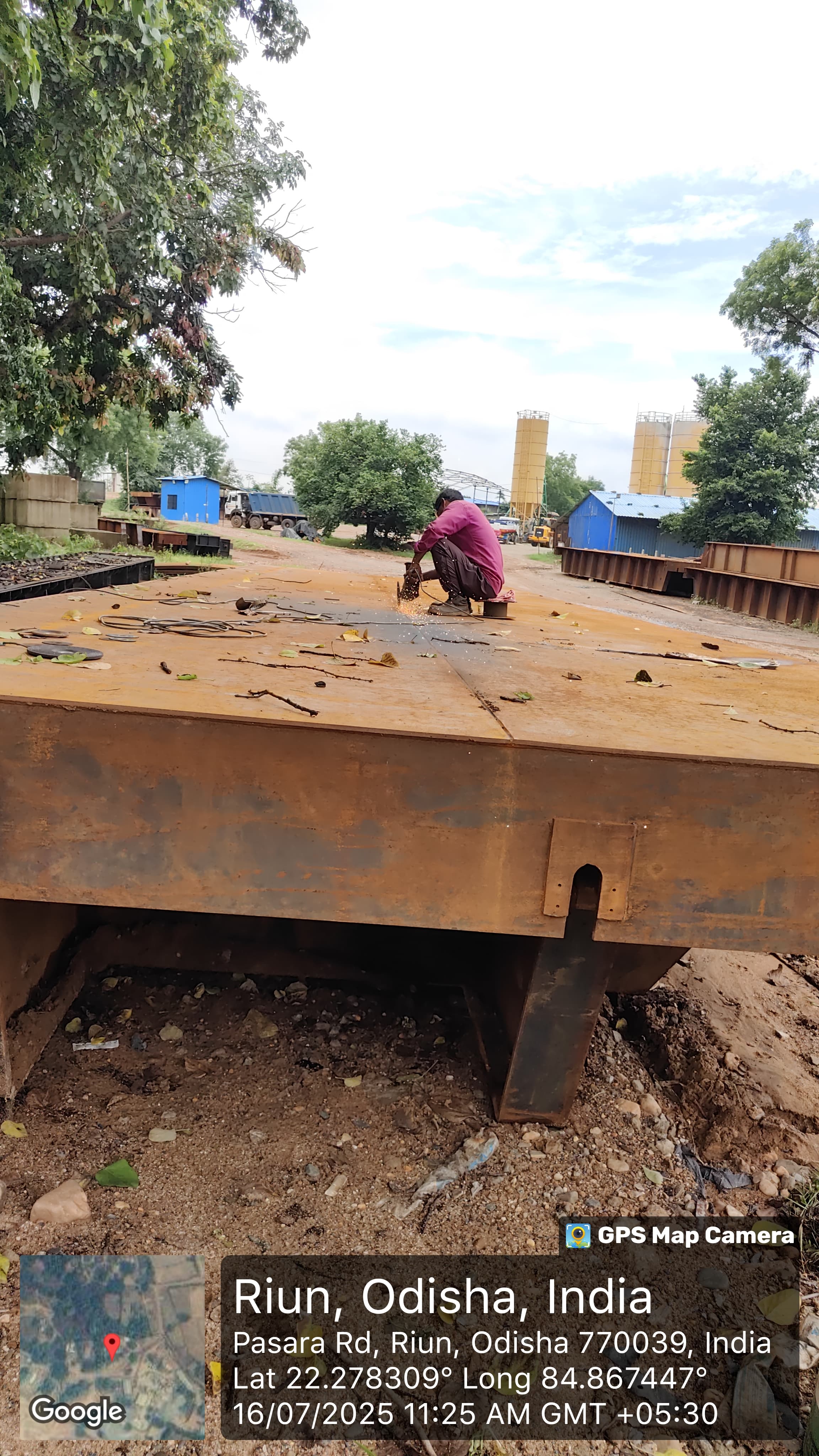

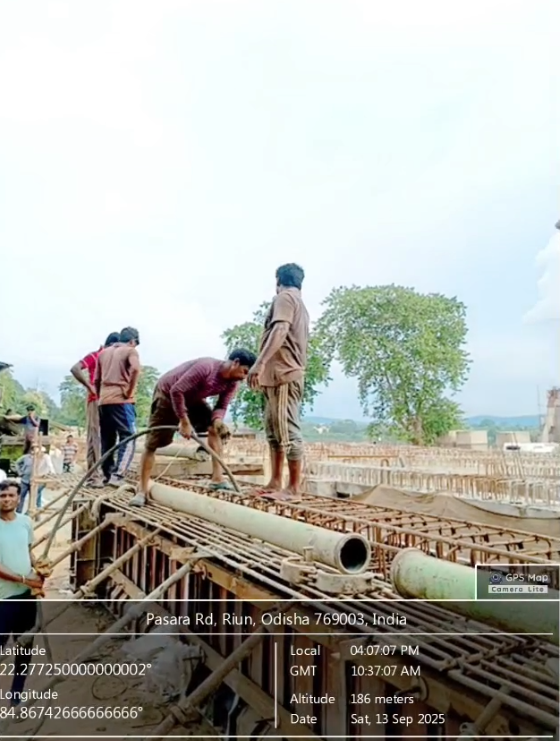

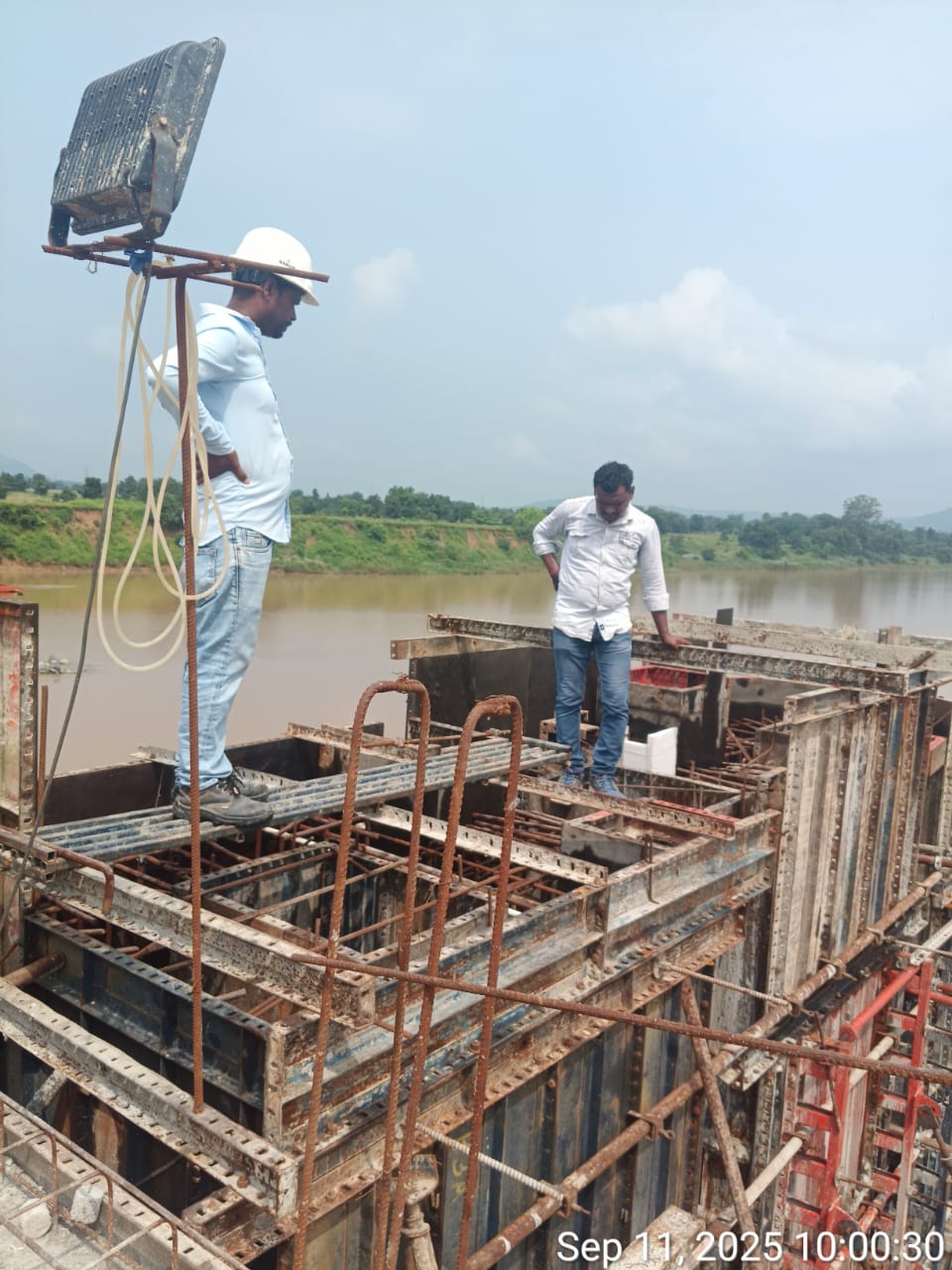

11.09.26
11/100

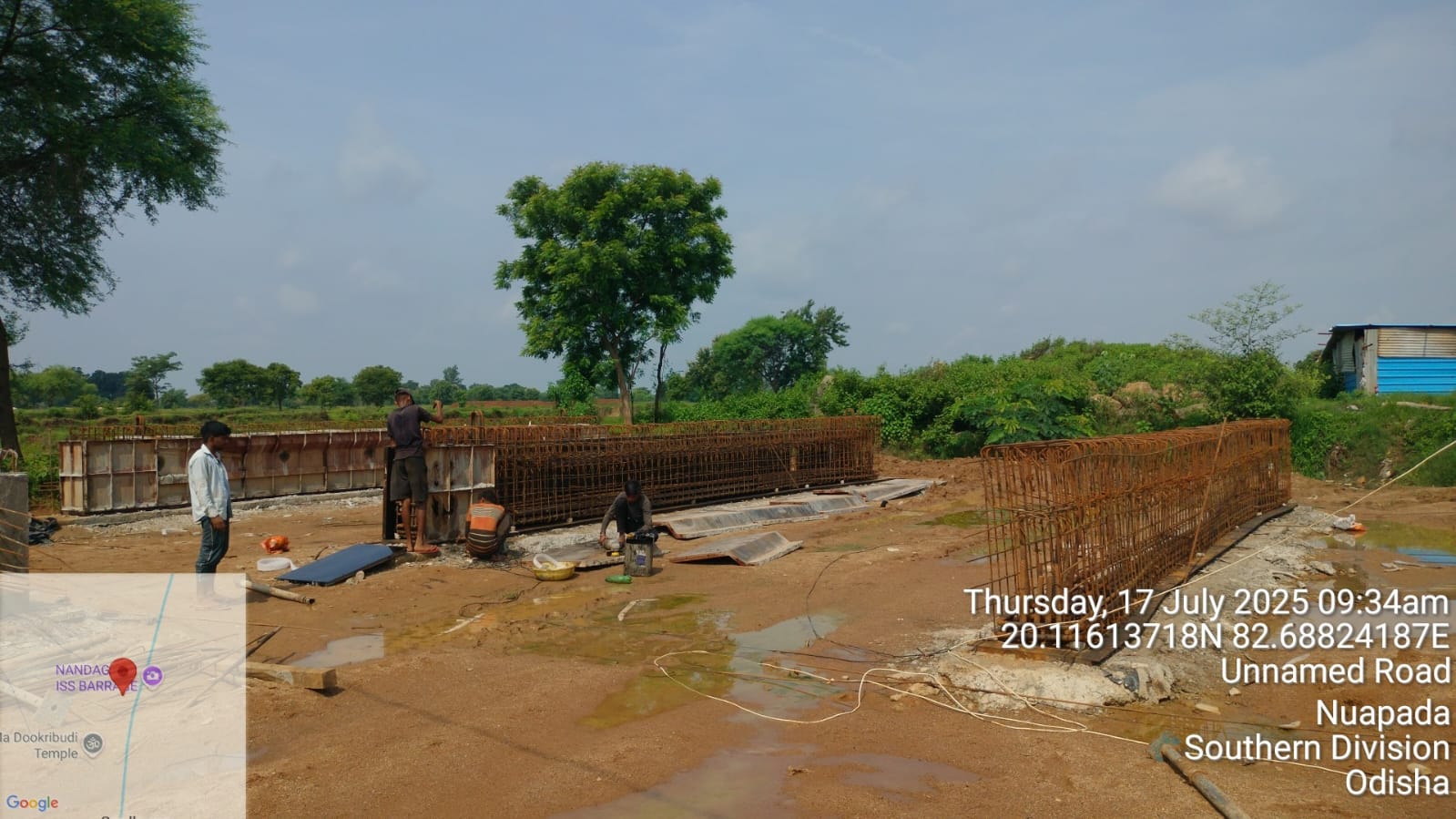

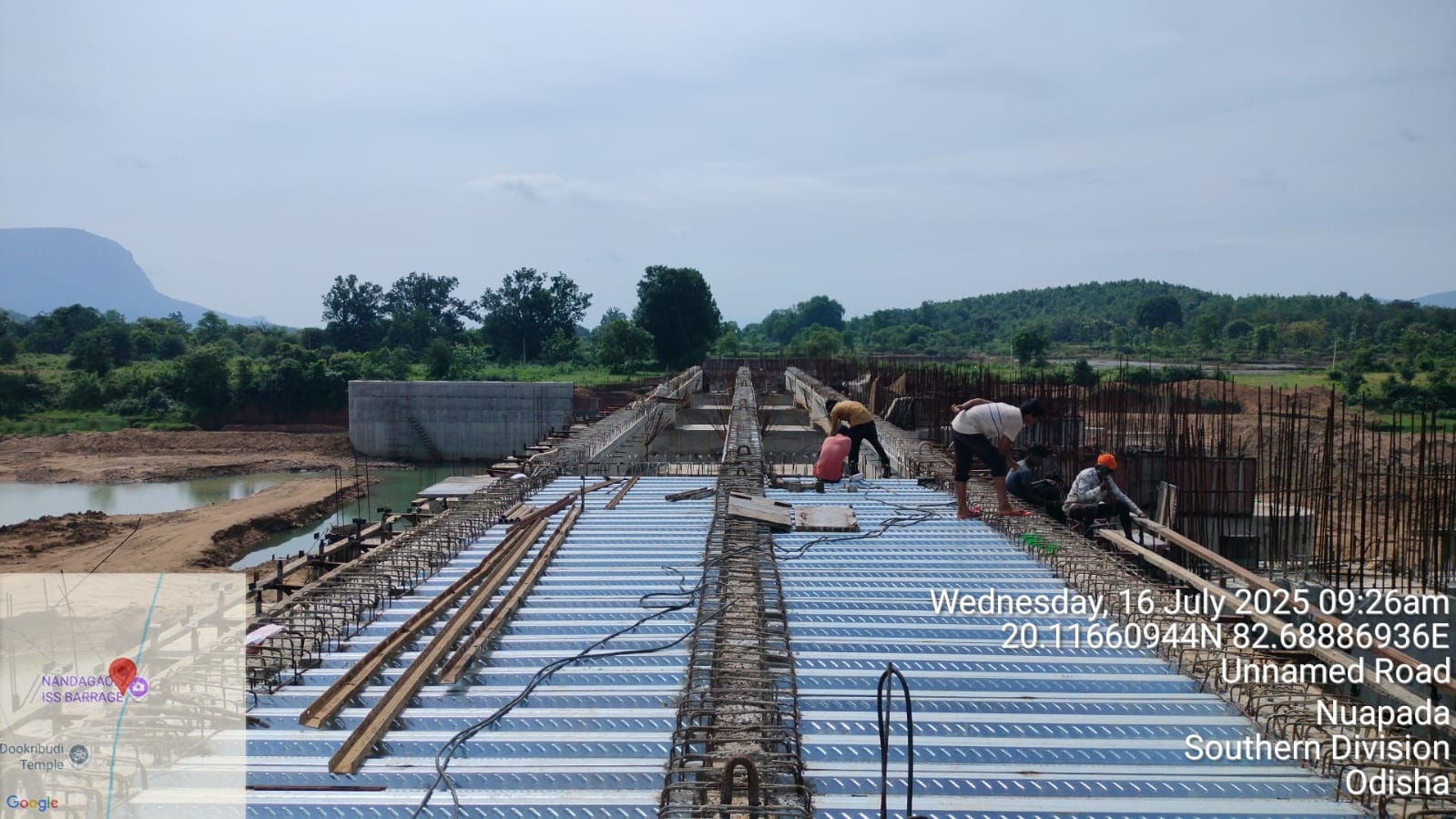

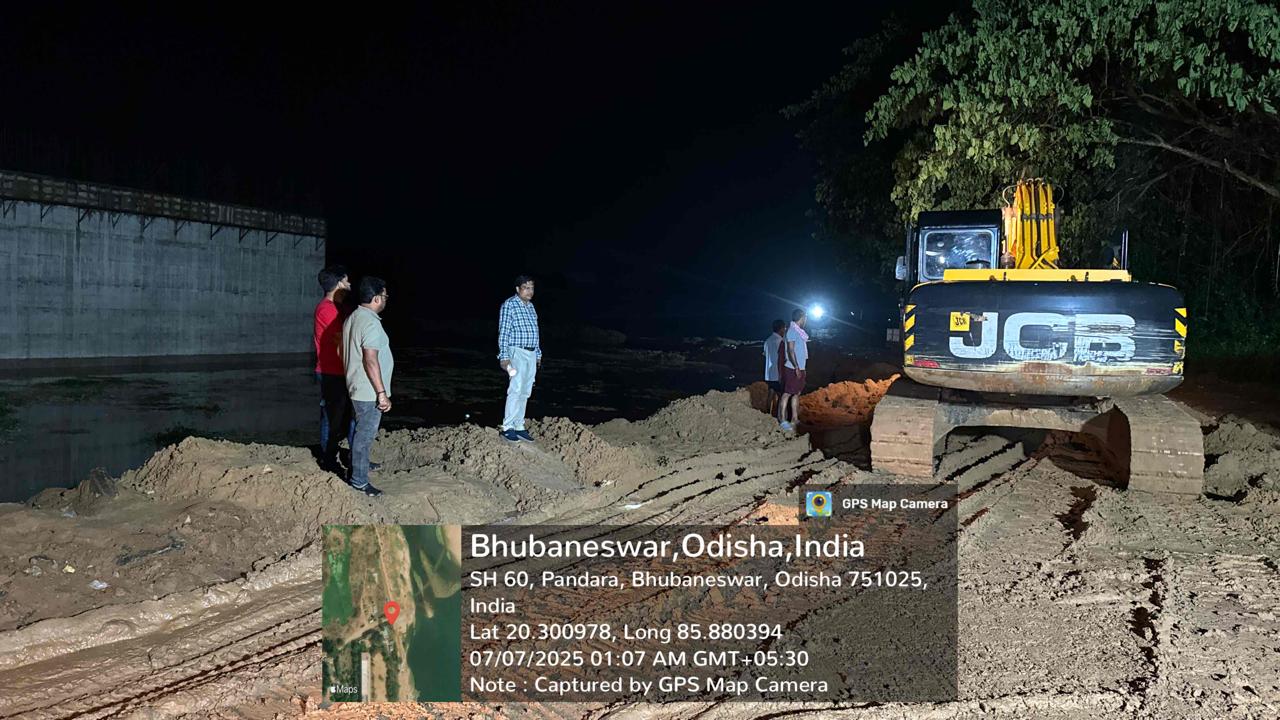

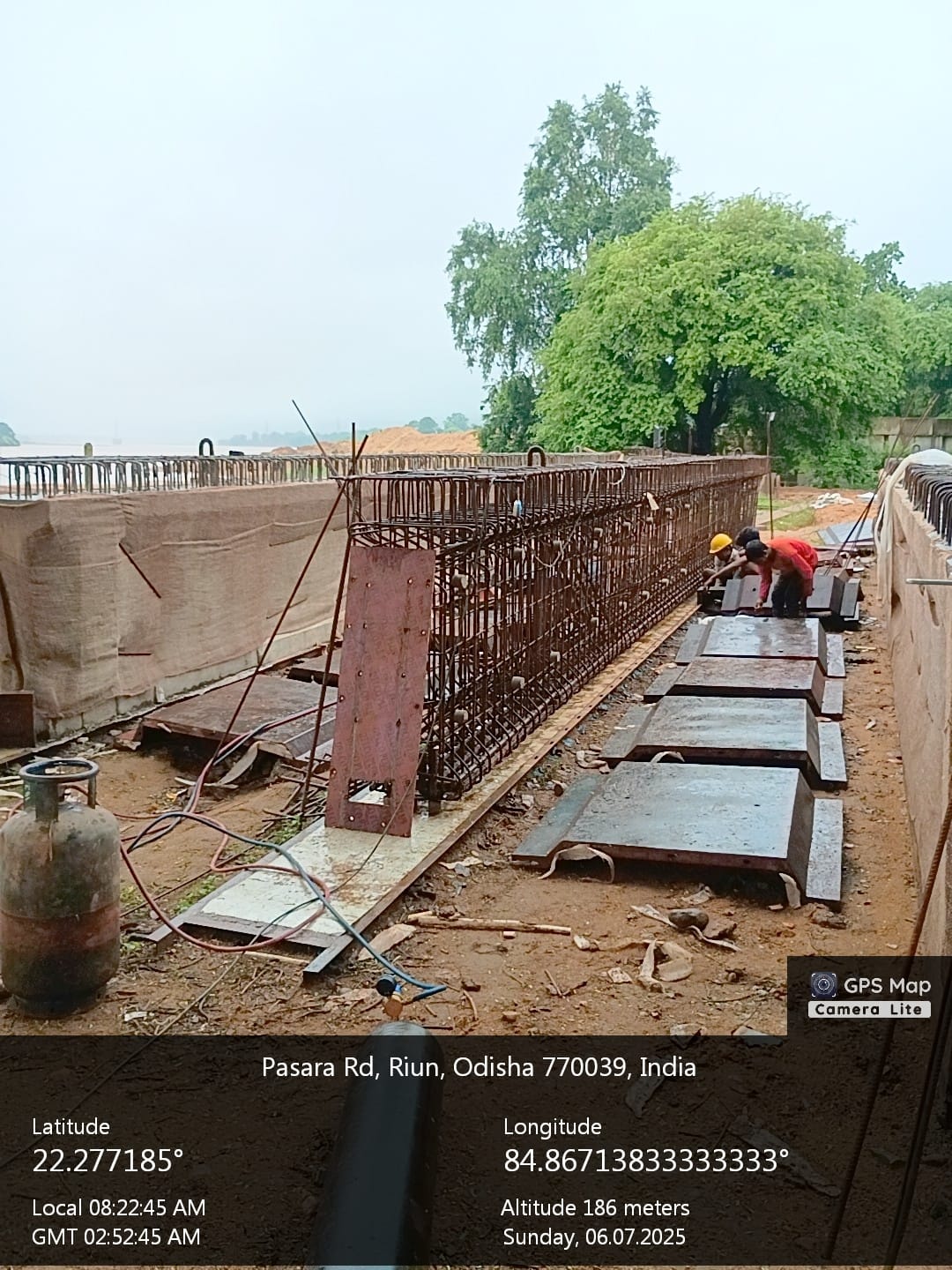

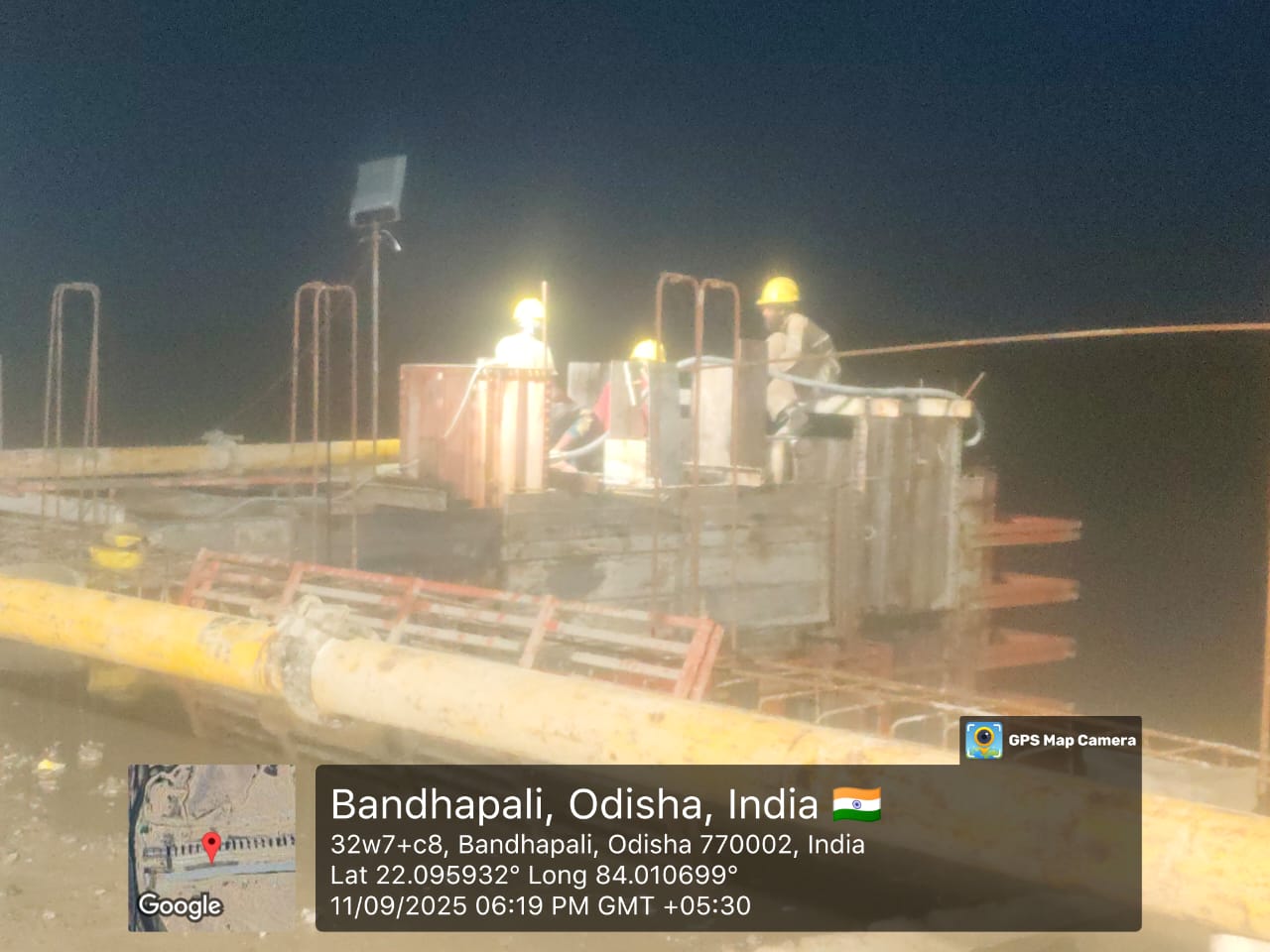

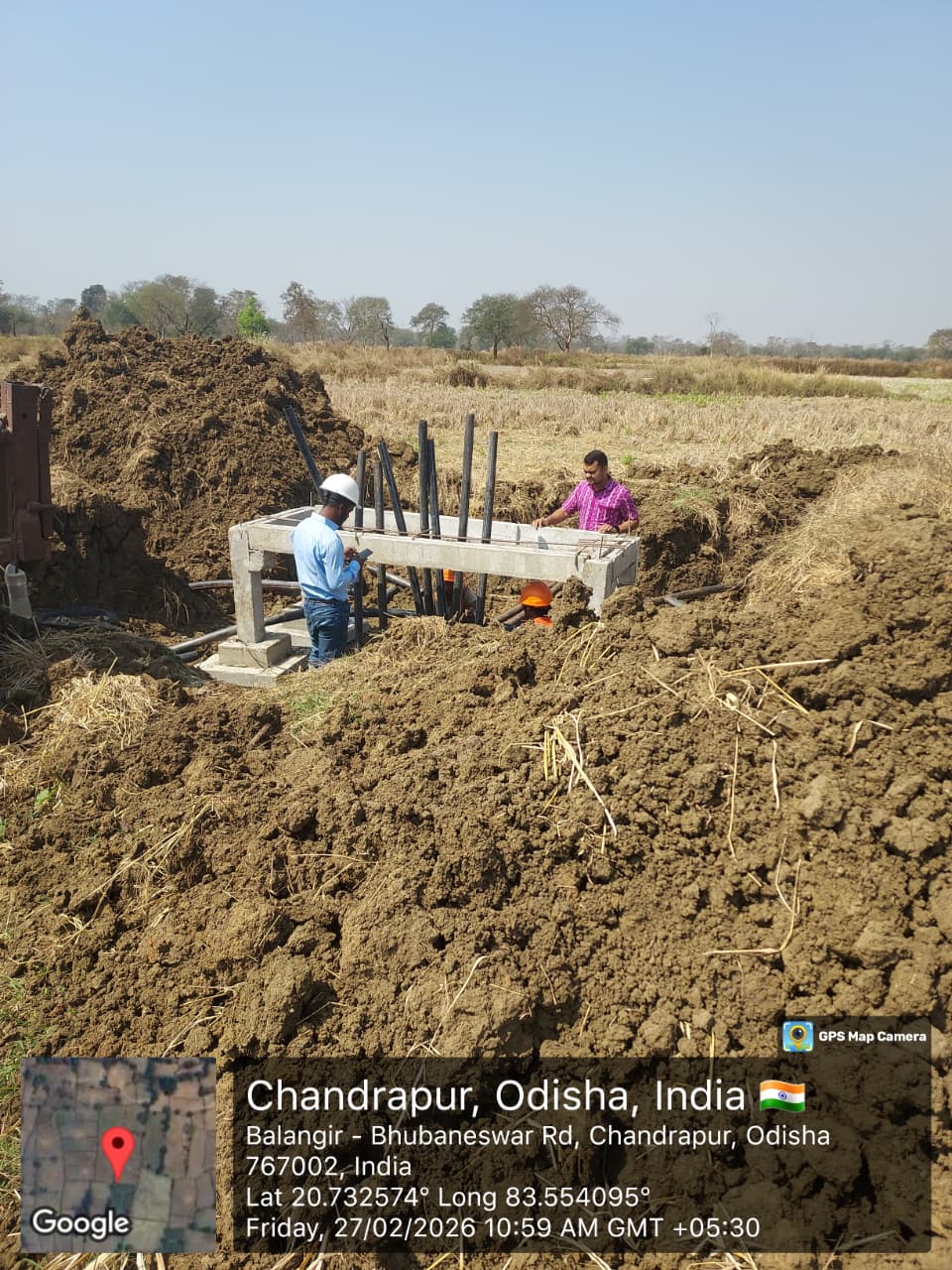

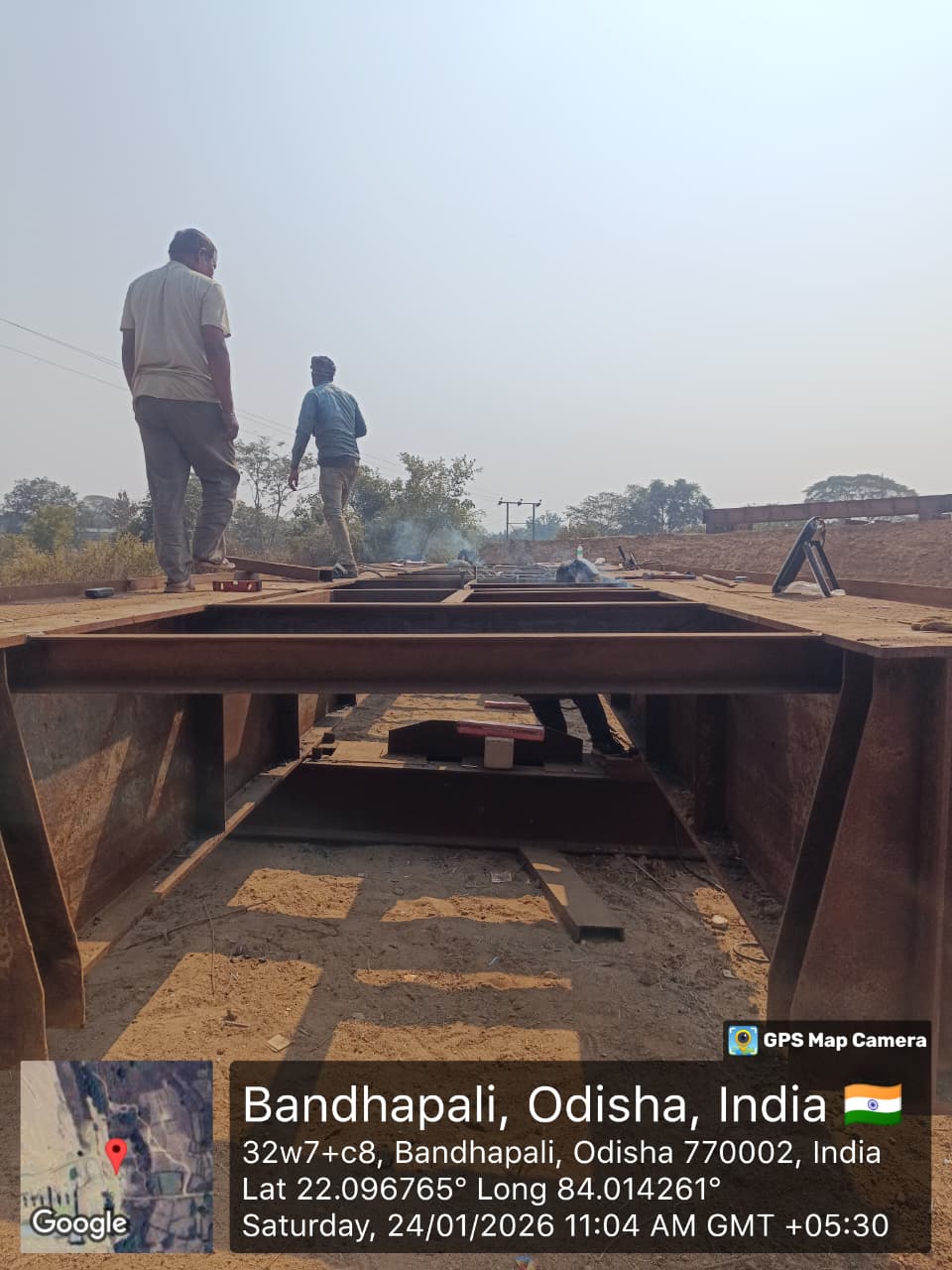

Instream Storage Structure, KansariGanda

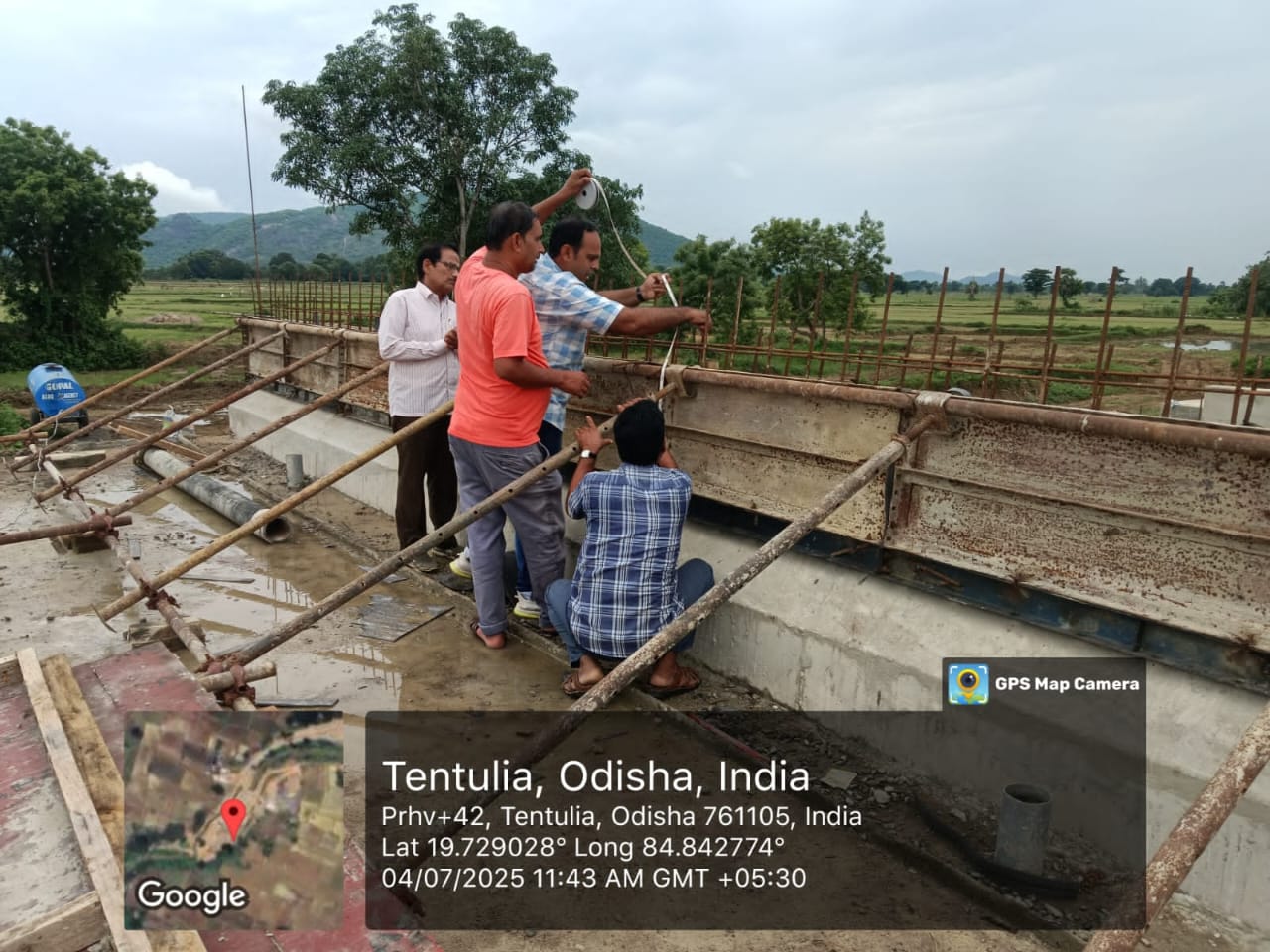

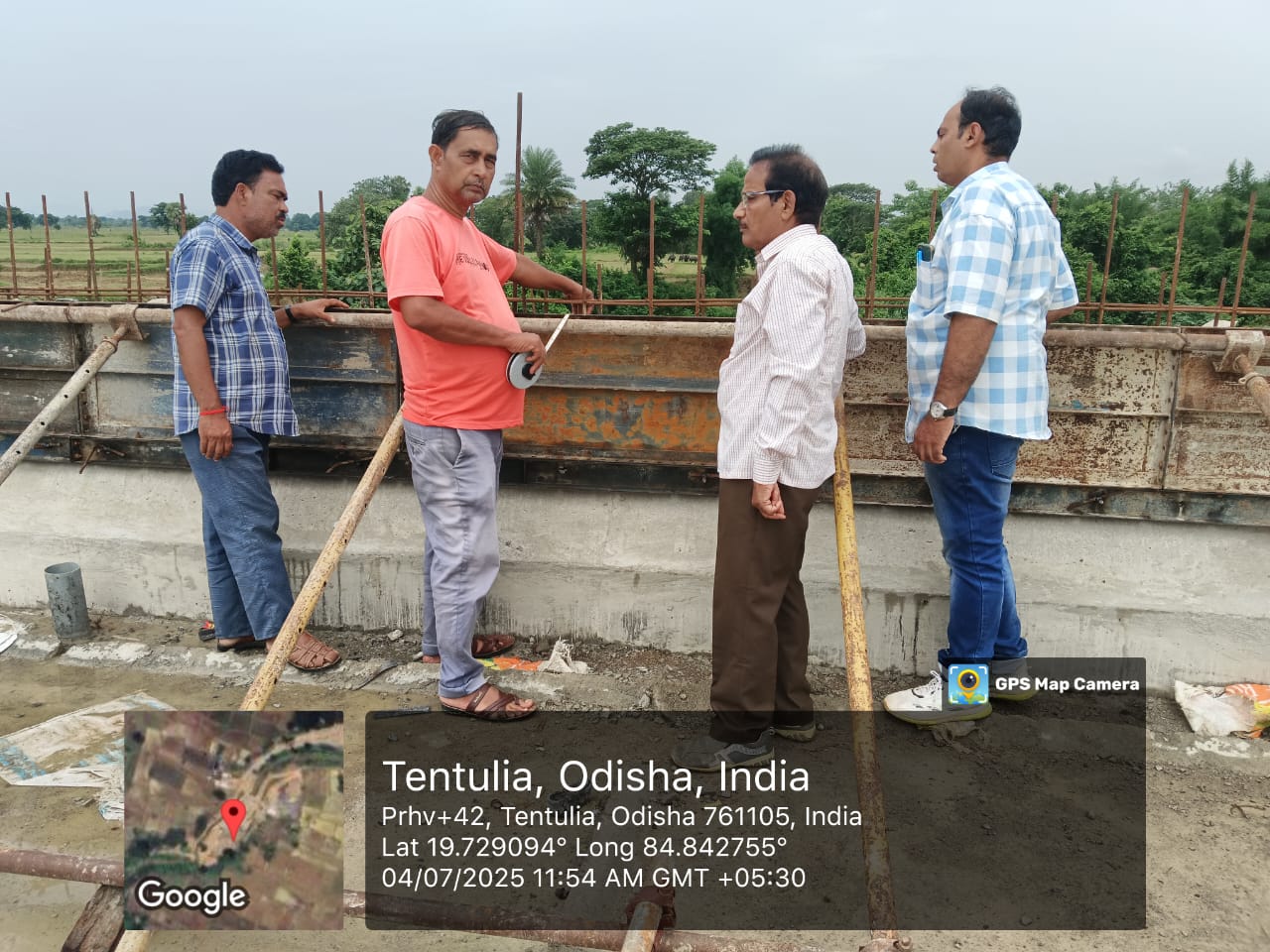

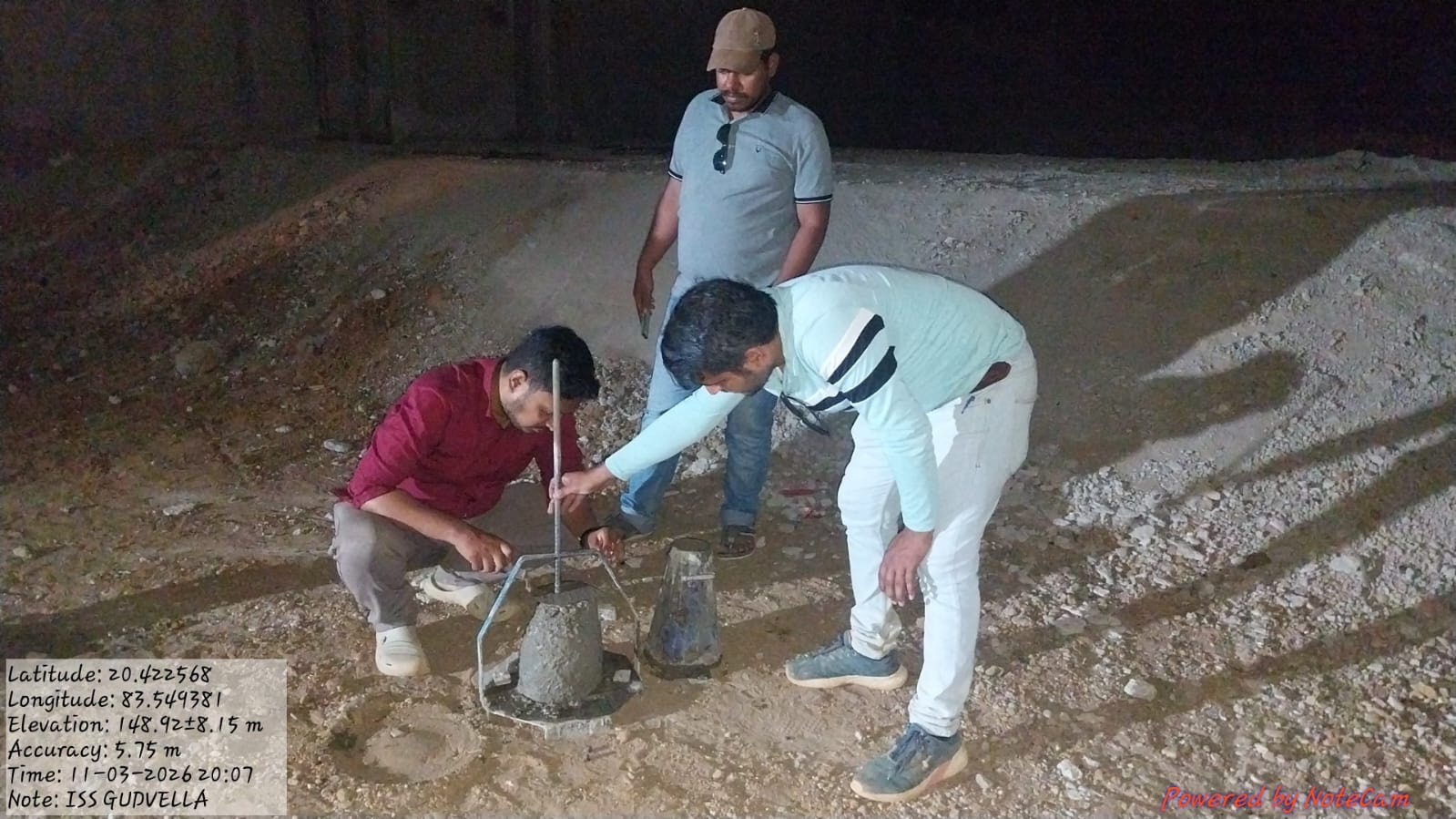

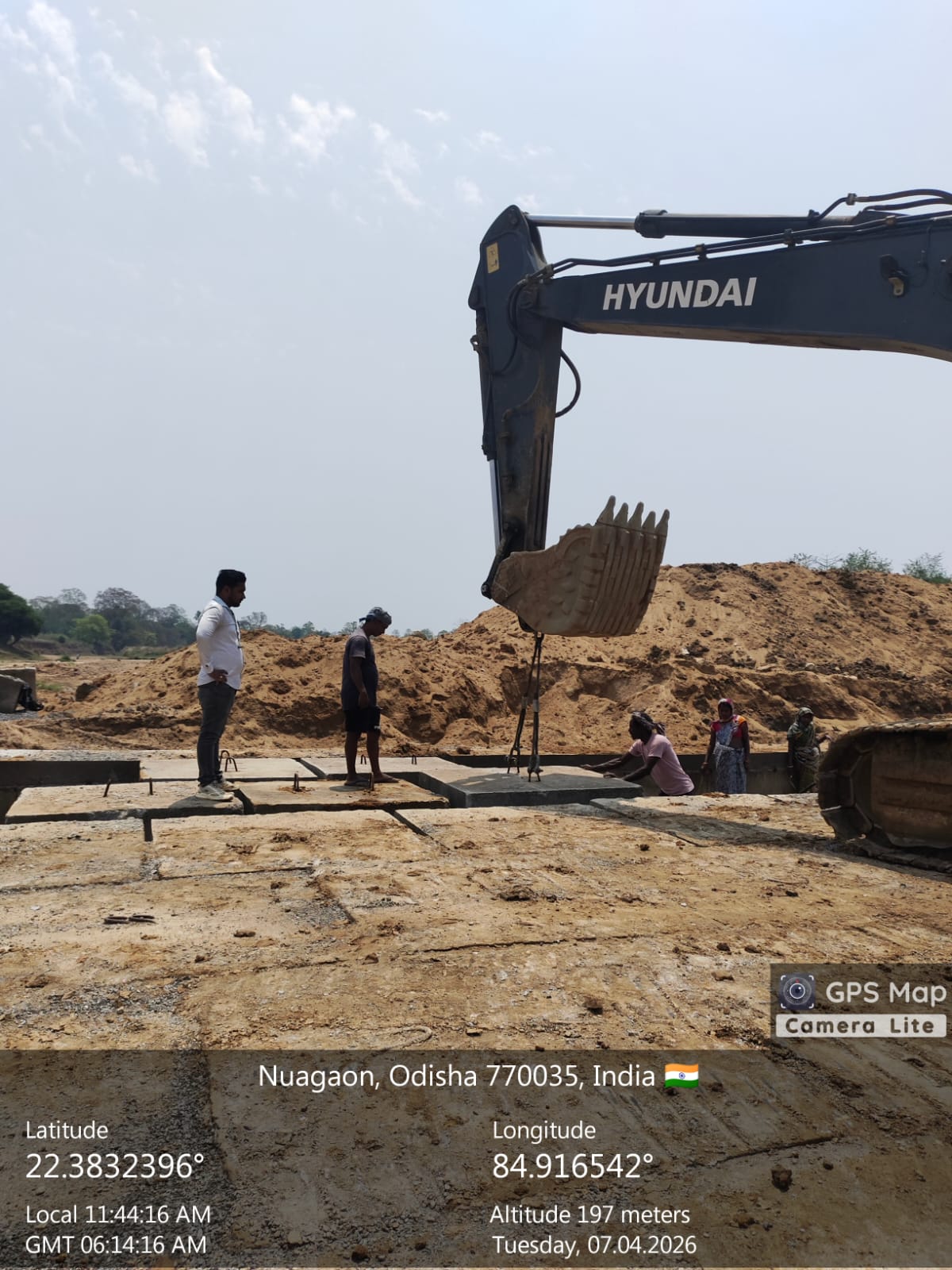

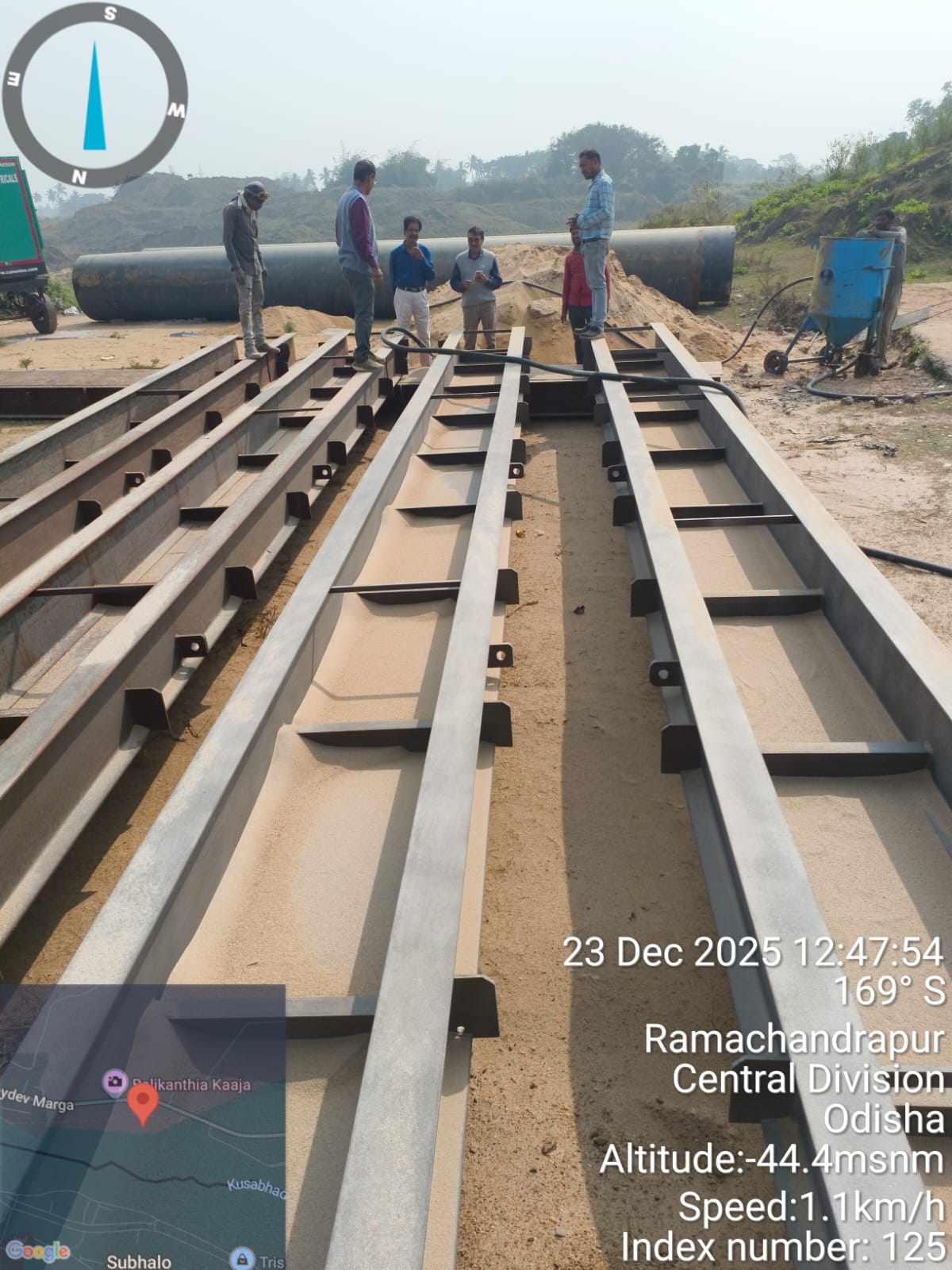

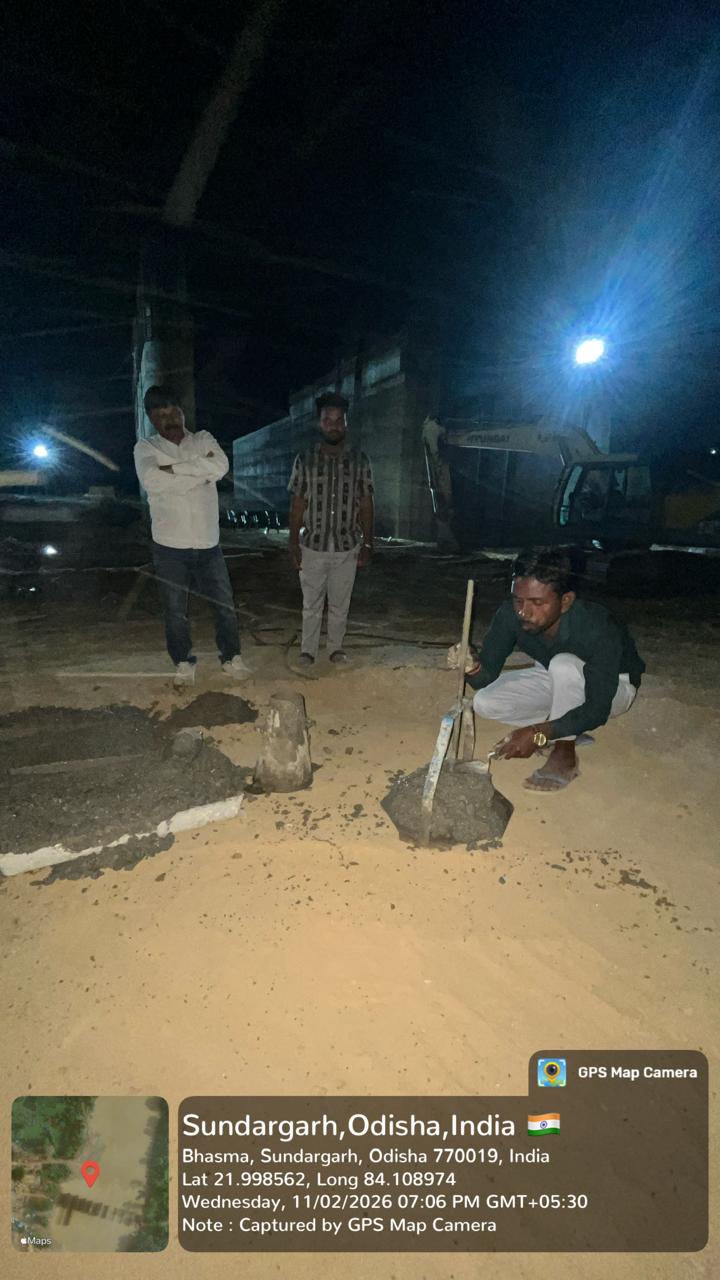

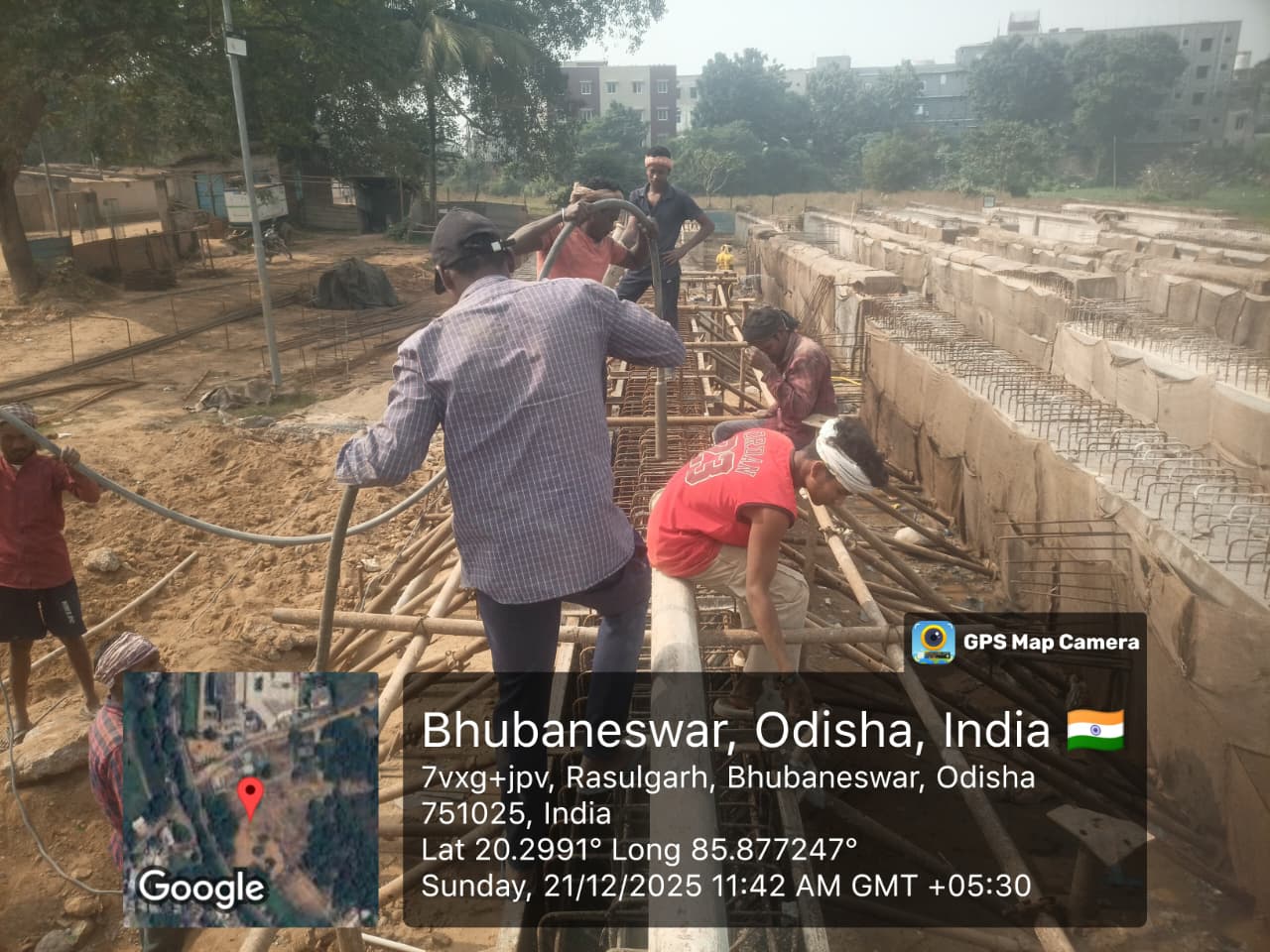

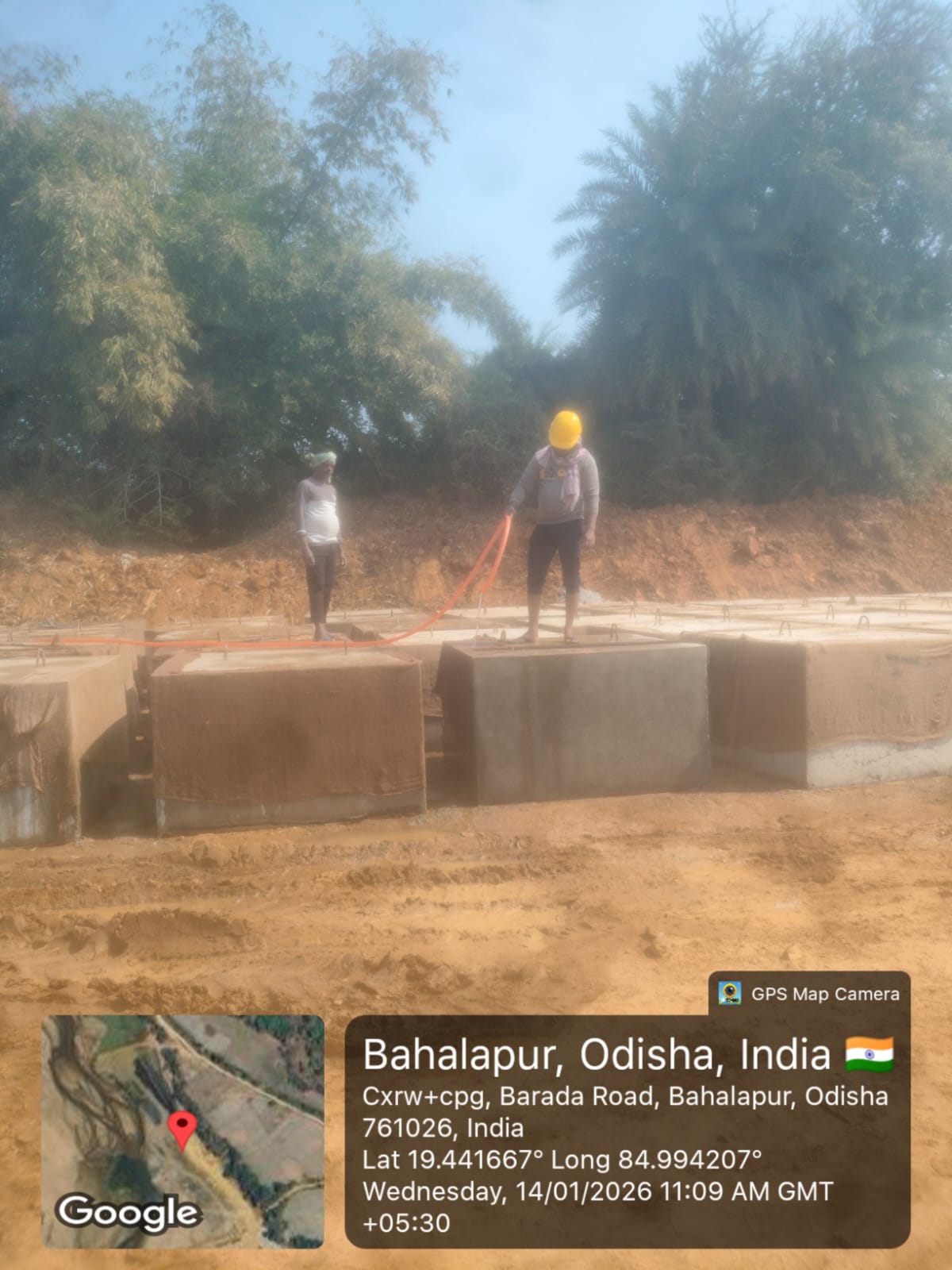

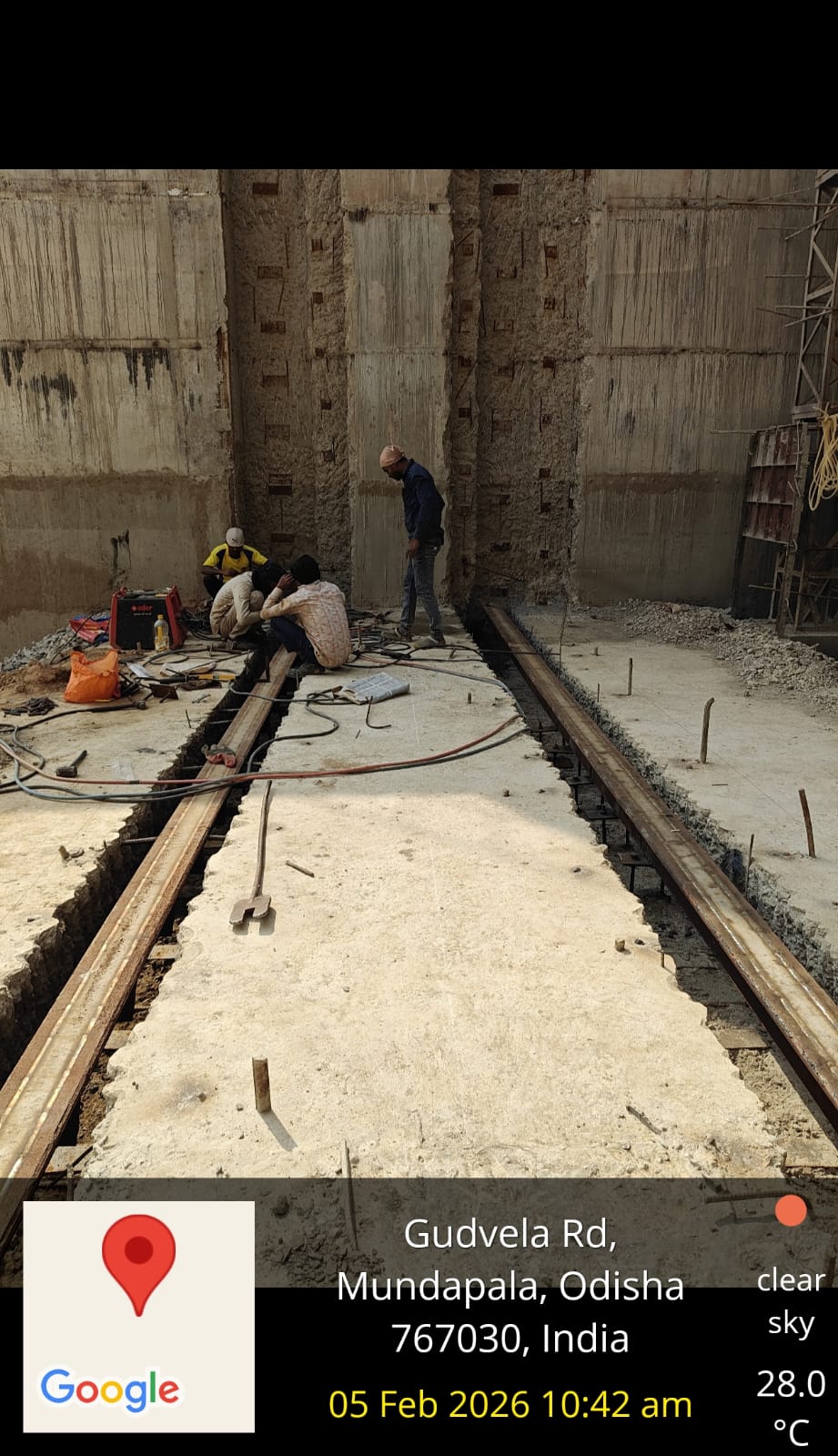

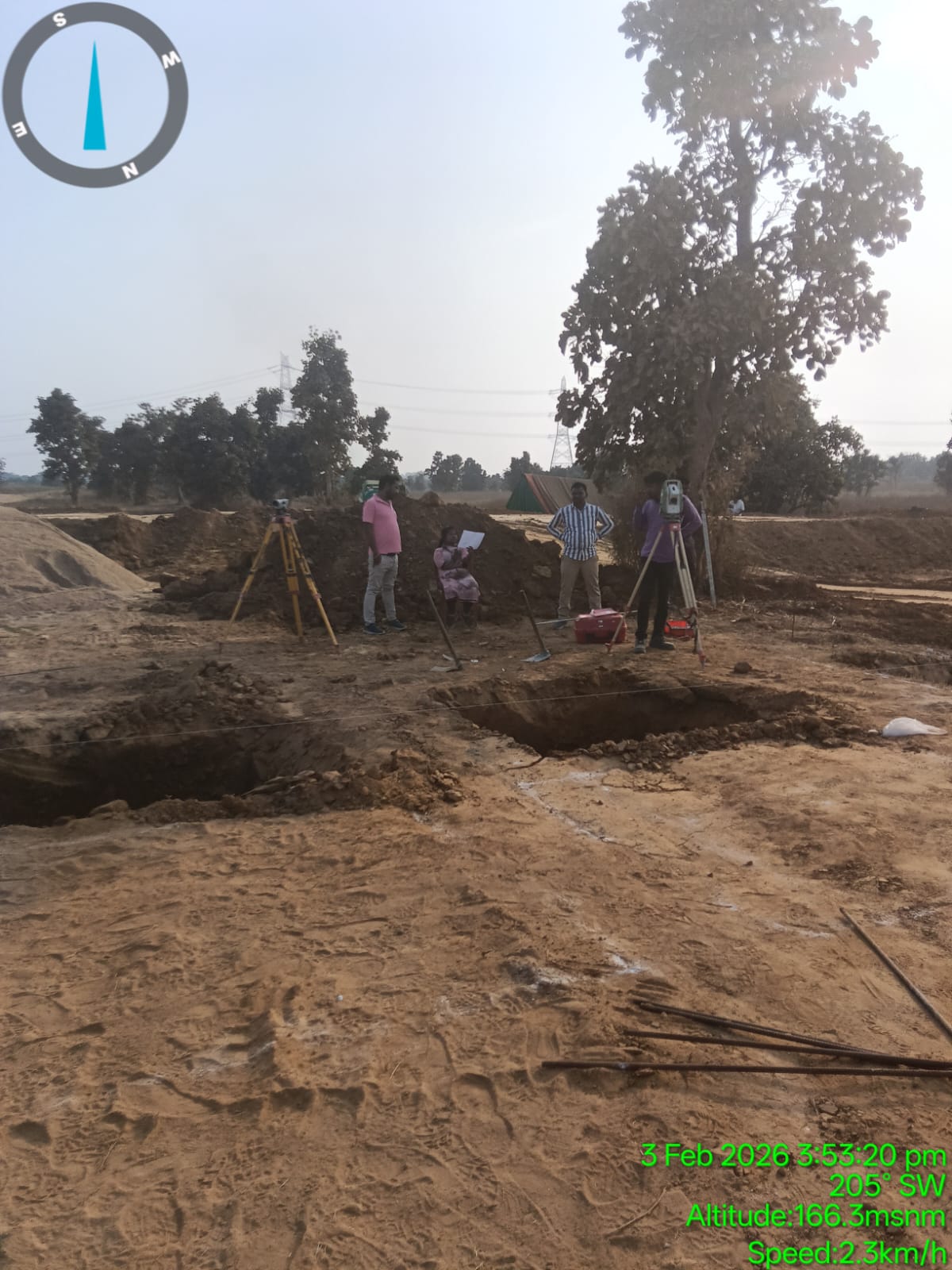

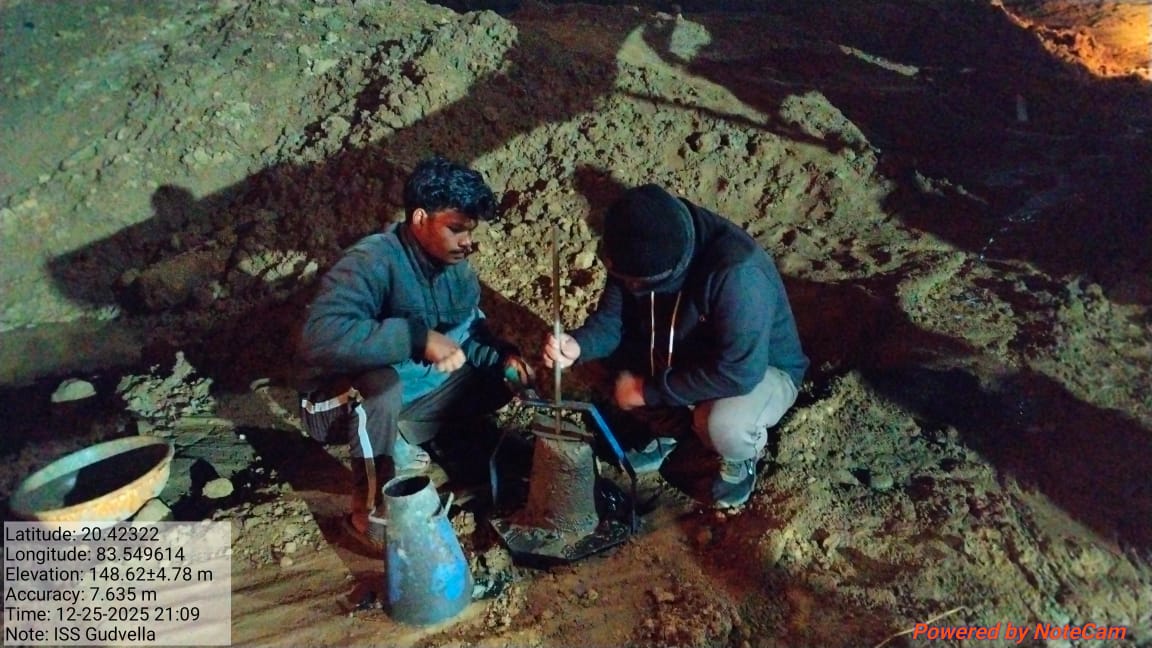

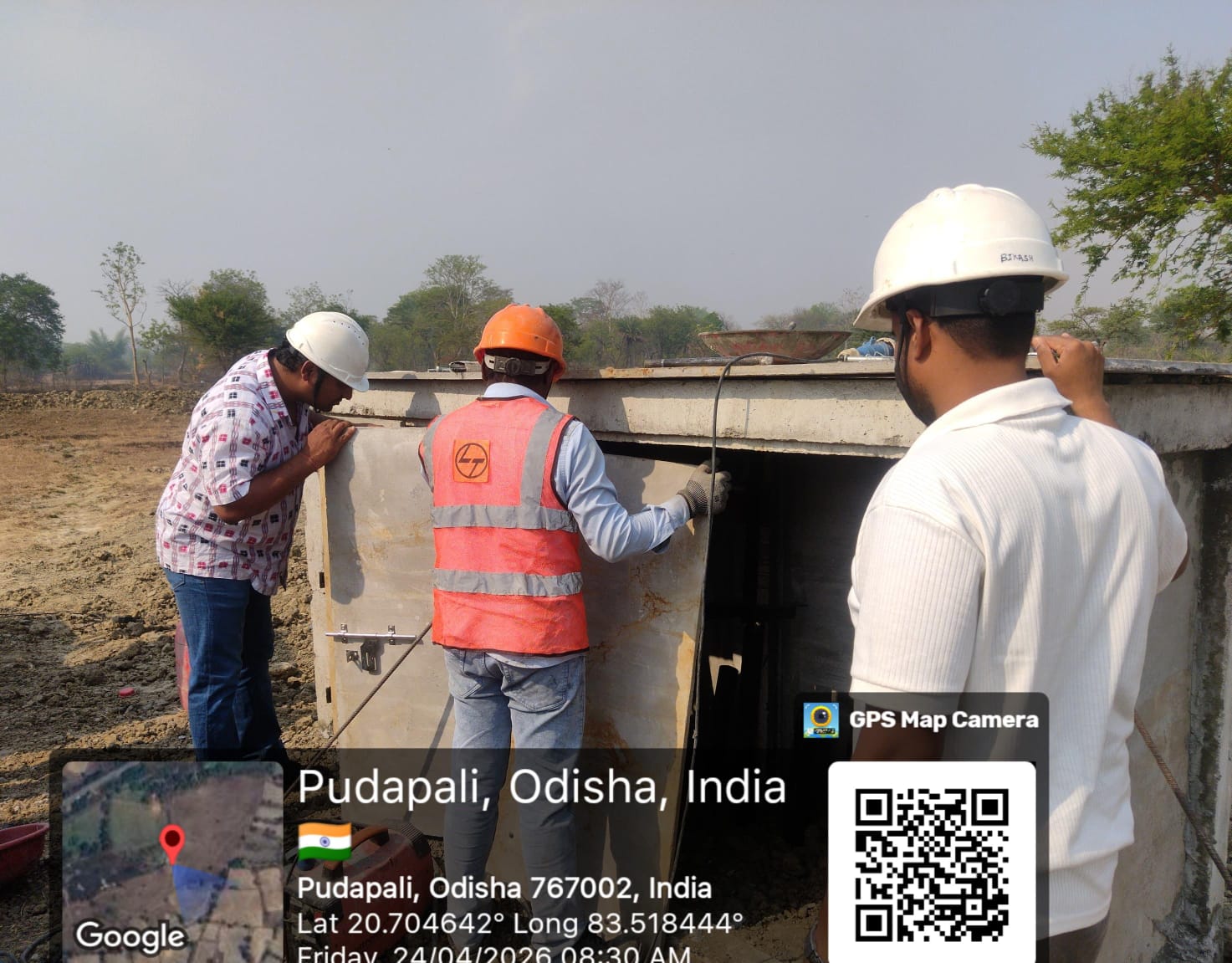

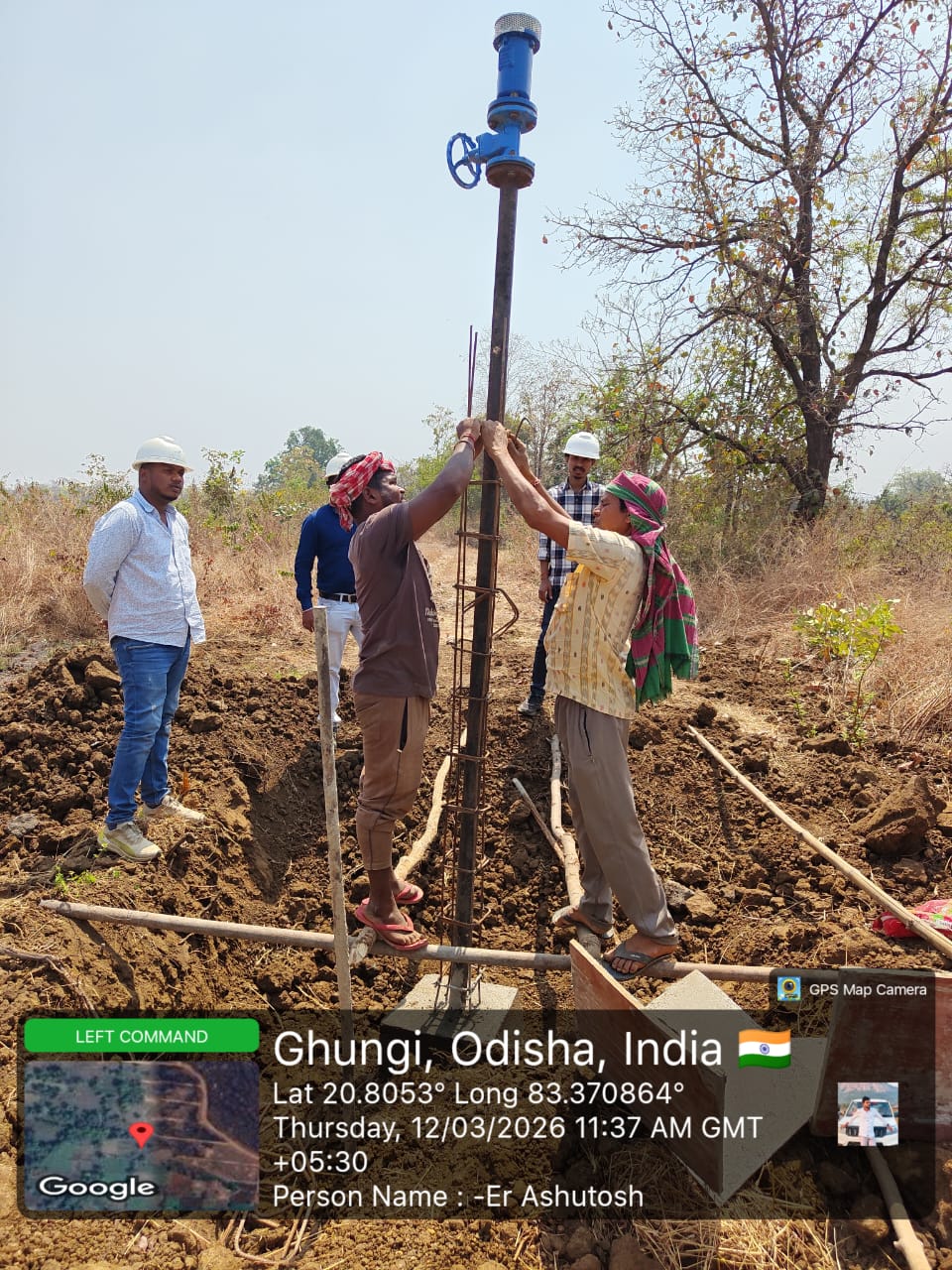

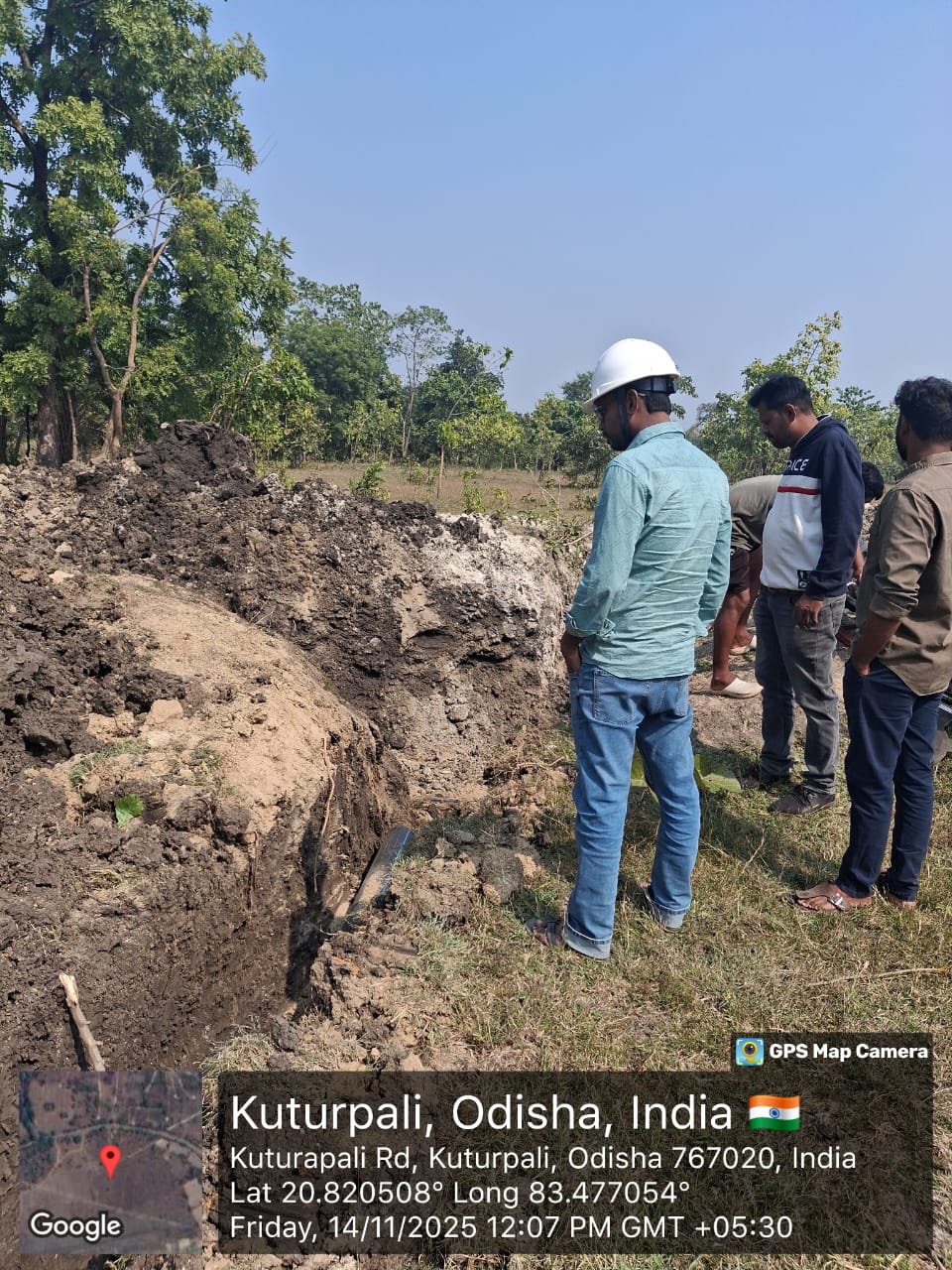

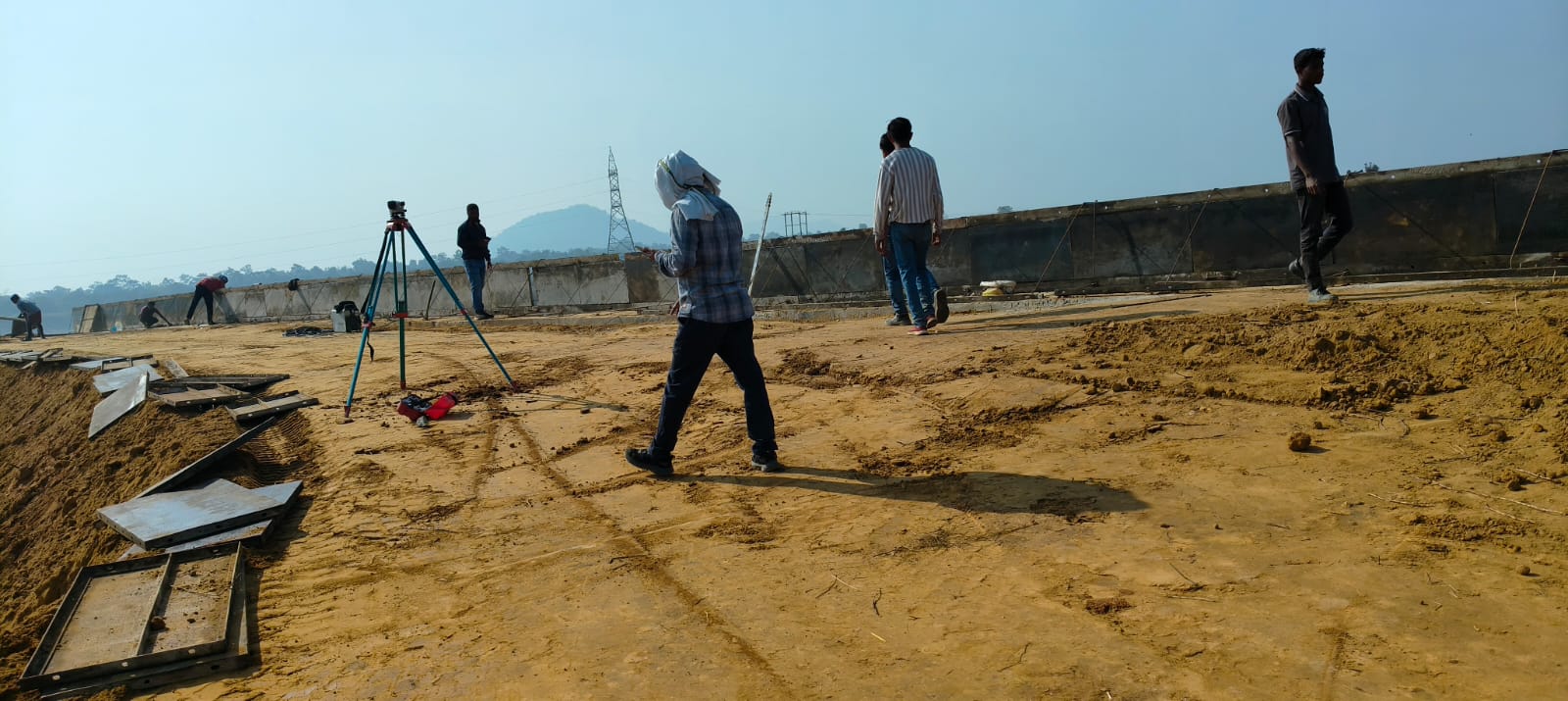

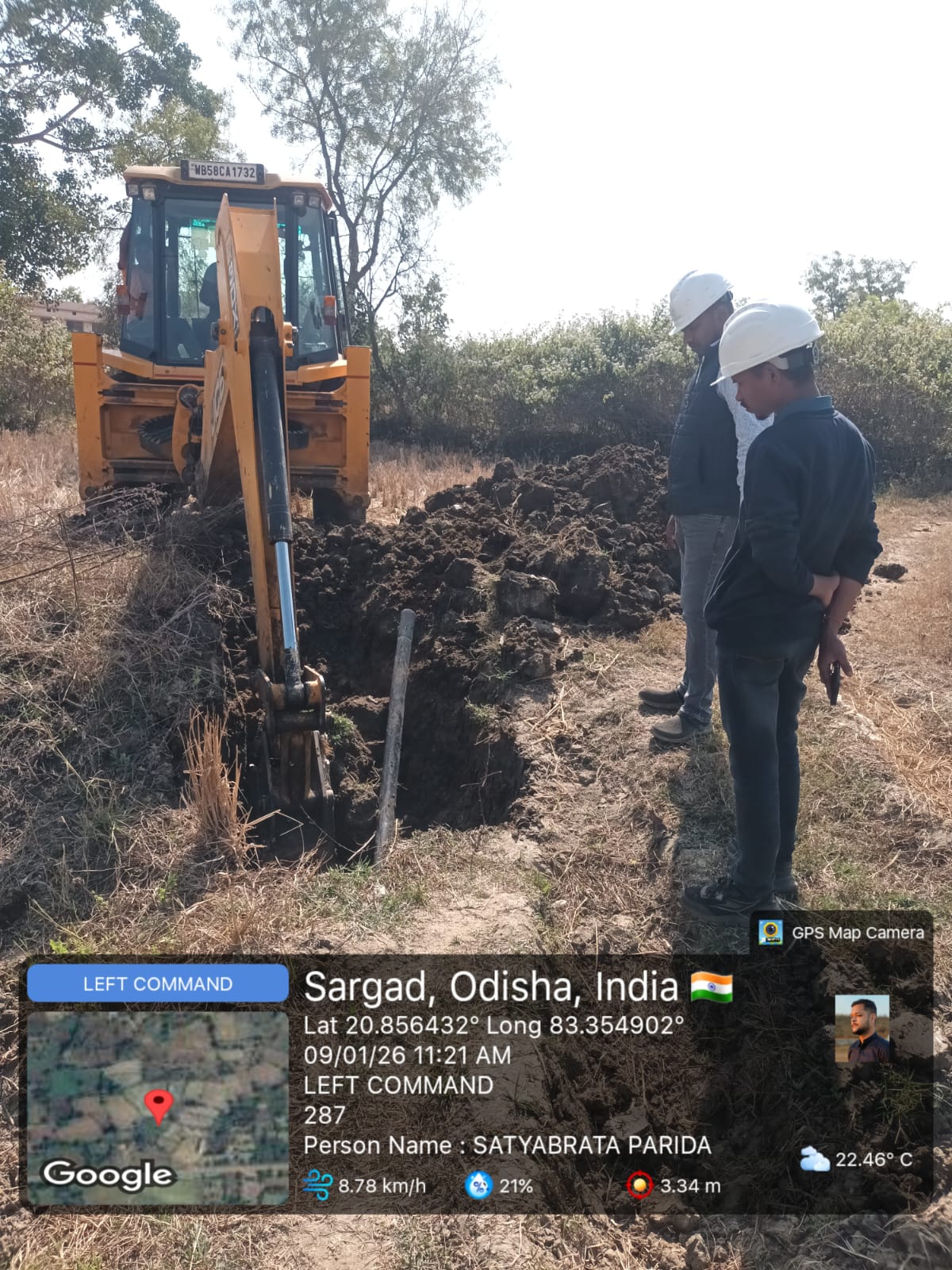

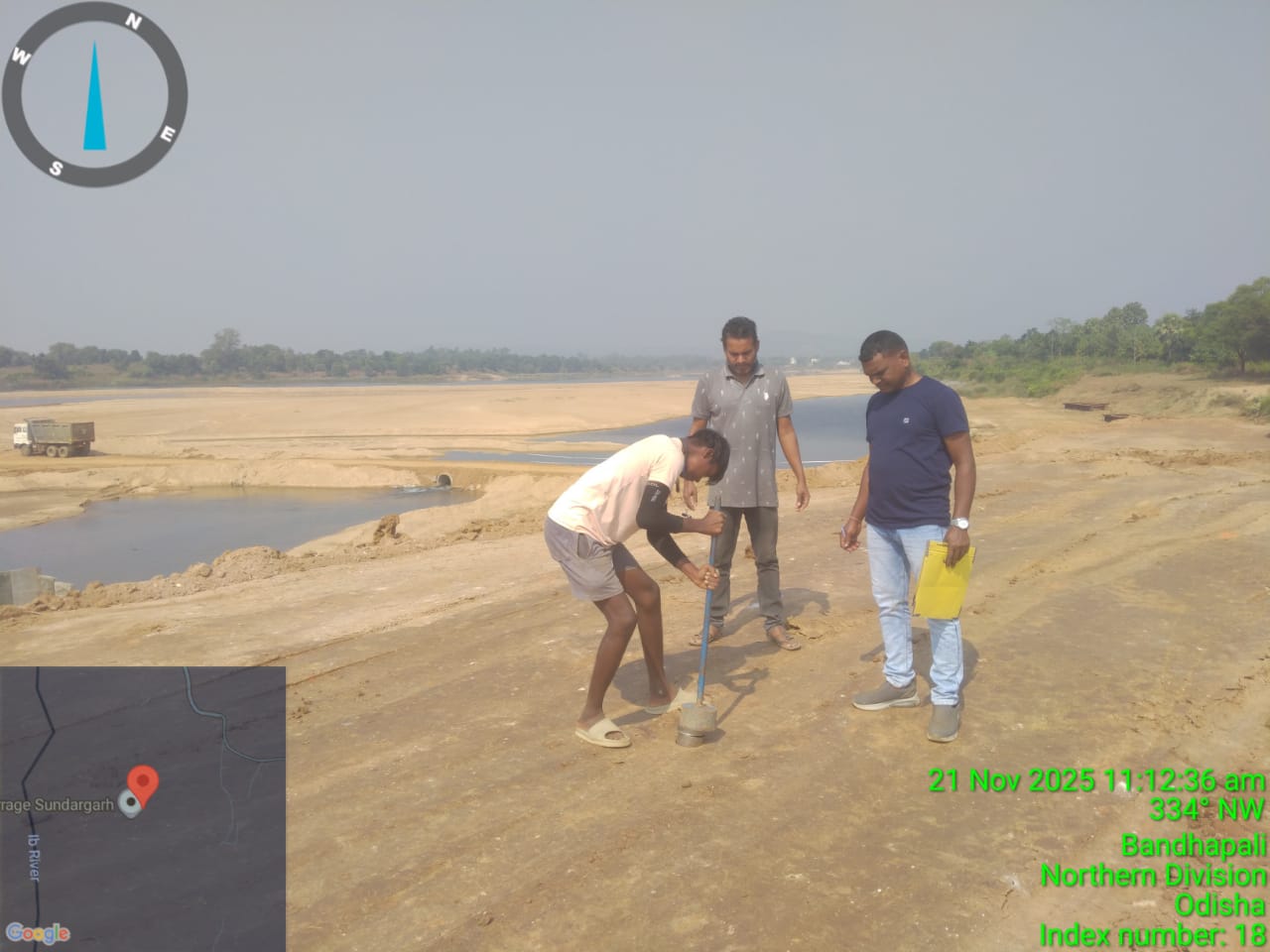

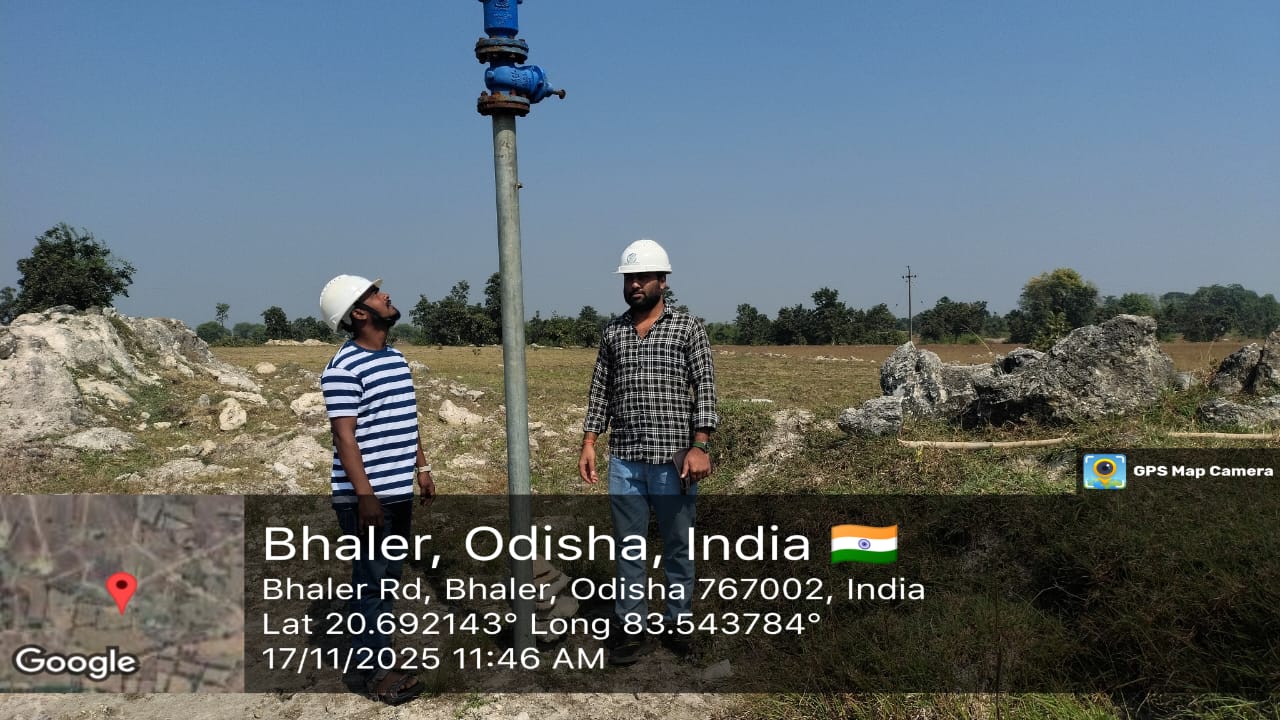

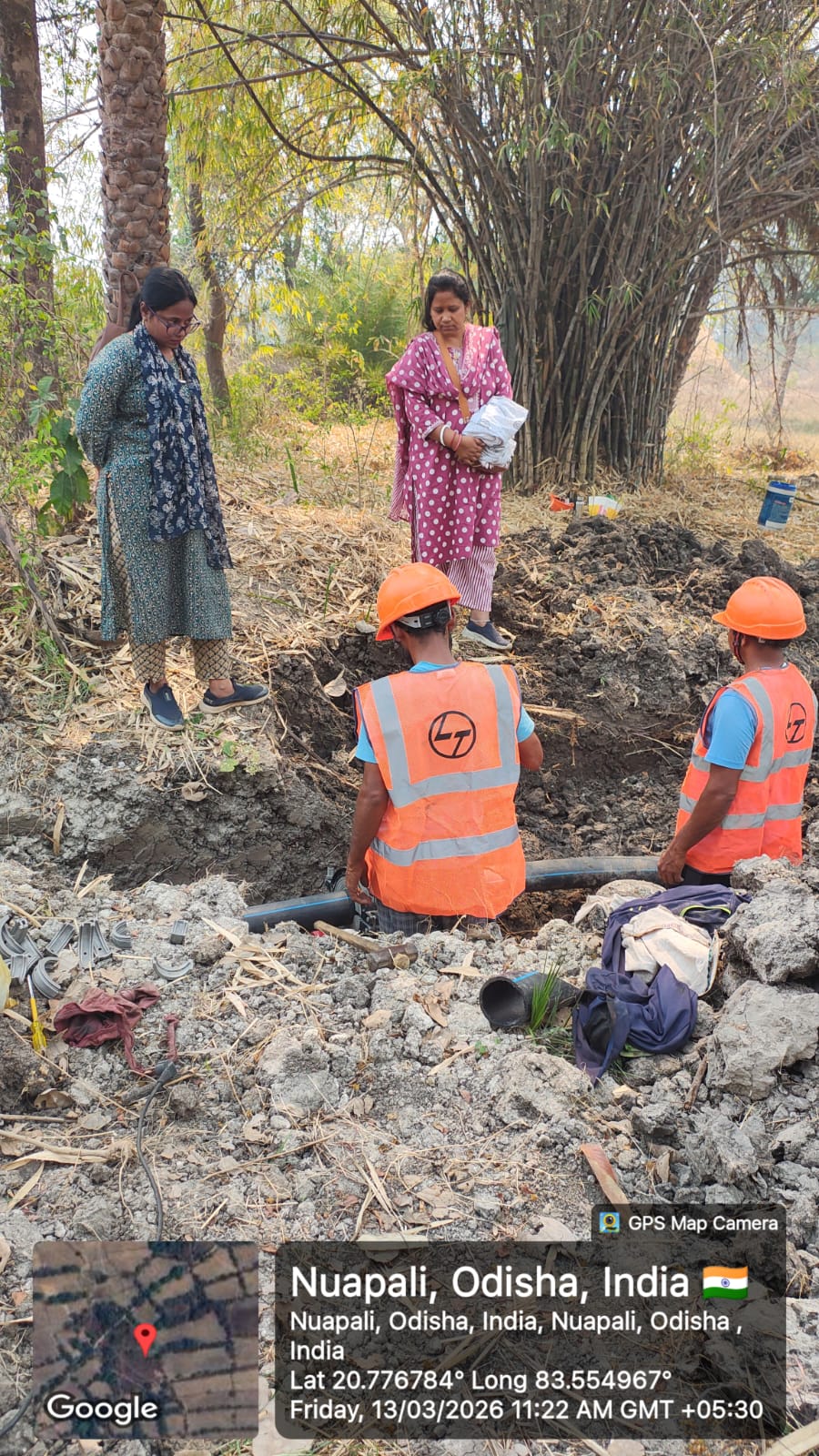

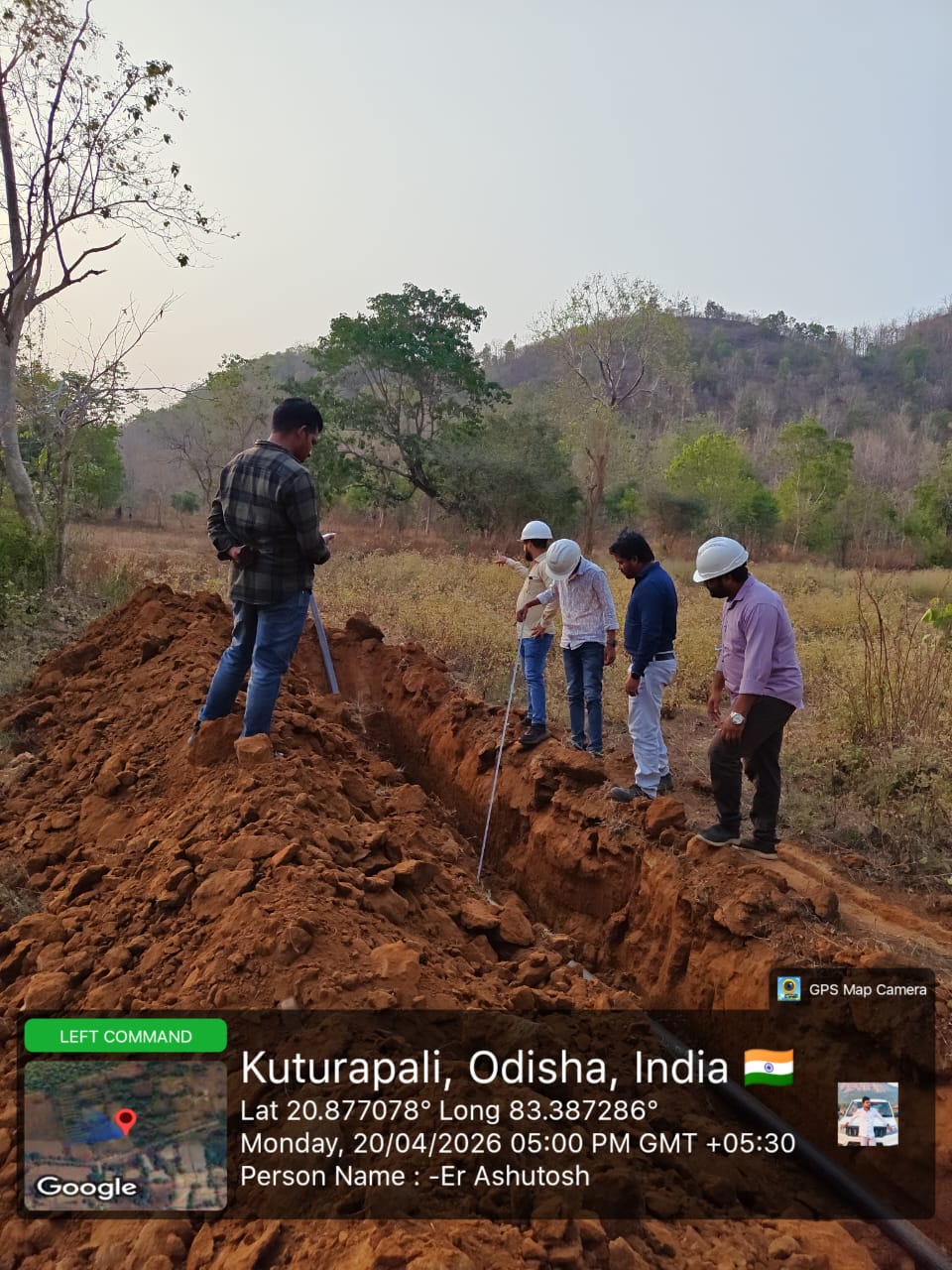

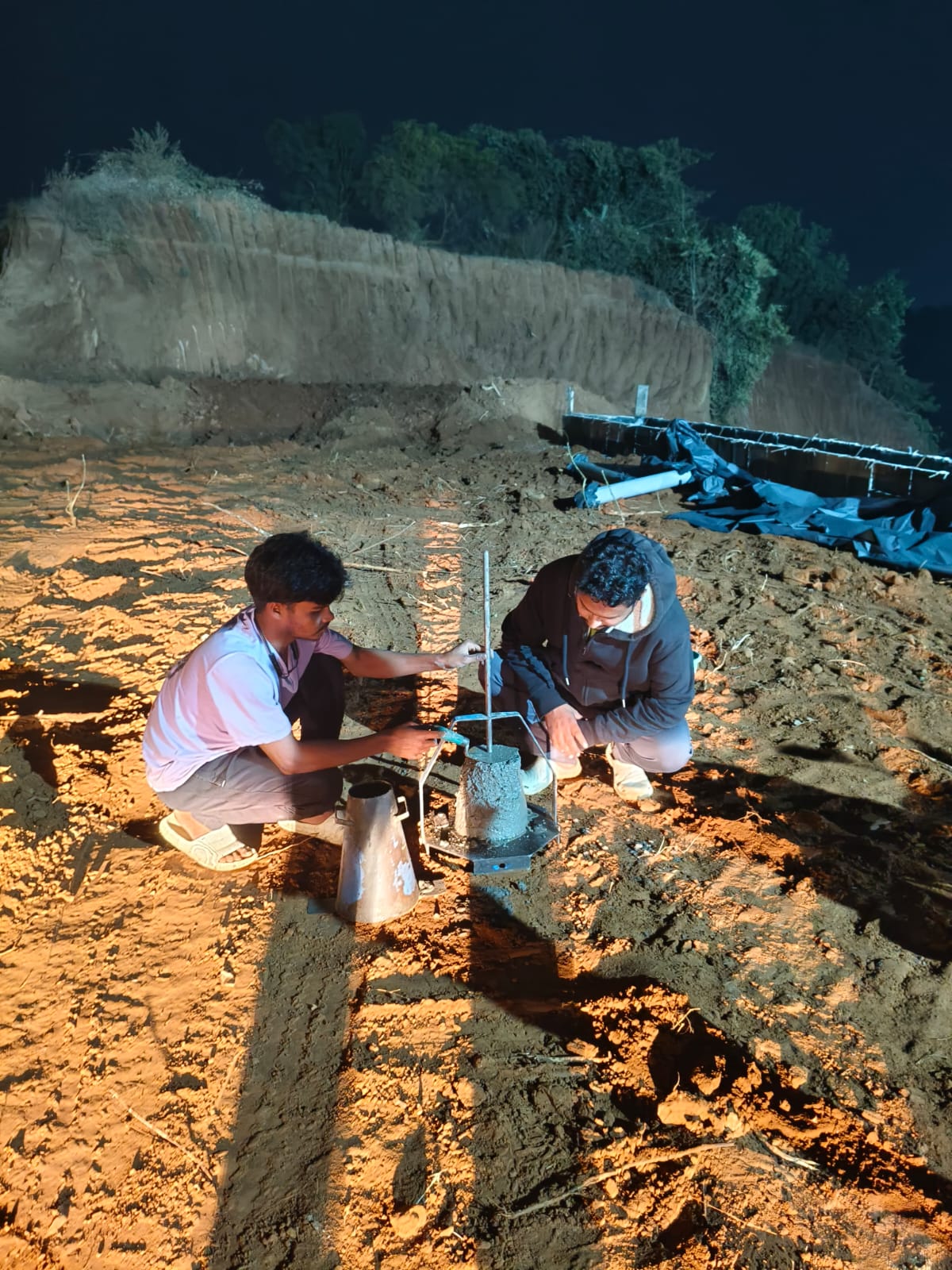

Demarcation Update – UDS pur Mauja Date: 09.09.2026 Demarcation for UDS pur Mauja continued today in the presence of Sarapancha and the villagers. During re-demarcation, it was observed that certain government lands have been converted into private patta land on the ground. As these latest ground-level changes are not yet reflected in revenue records/maps, such discrepancies surfaced during spot verification, carried out in the presence of the land holders. As per standard practice, boundary pegs with red flags have been fixed at the demarcation points.
12/100
Instream Storage Structure, KansariGanda

Demarcation Update – UDS pur Mauja Date: 09.09.2026 Demarcation for UDS pur Mauja continued today in the presence of Sarapancha and the villagers. During re-demarcation, it was observed that certain government lands have been converted into private patta land on the ground. As these latest ground-level changes are not yet reflected in revenue records/maps, such discrepancies surfaced during spot verification, carried out in the presence of the land holders. As per standard practice, boundary pegs with red flags have been fixed at the demarcation points.

13/100

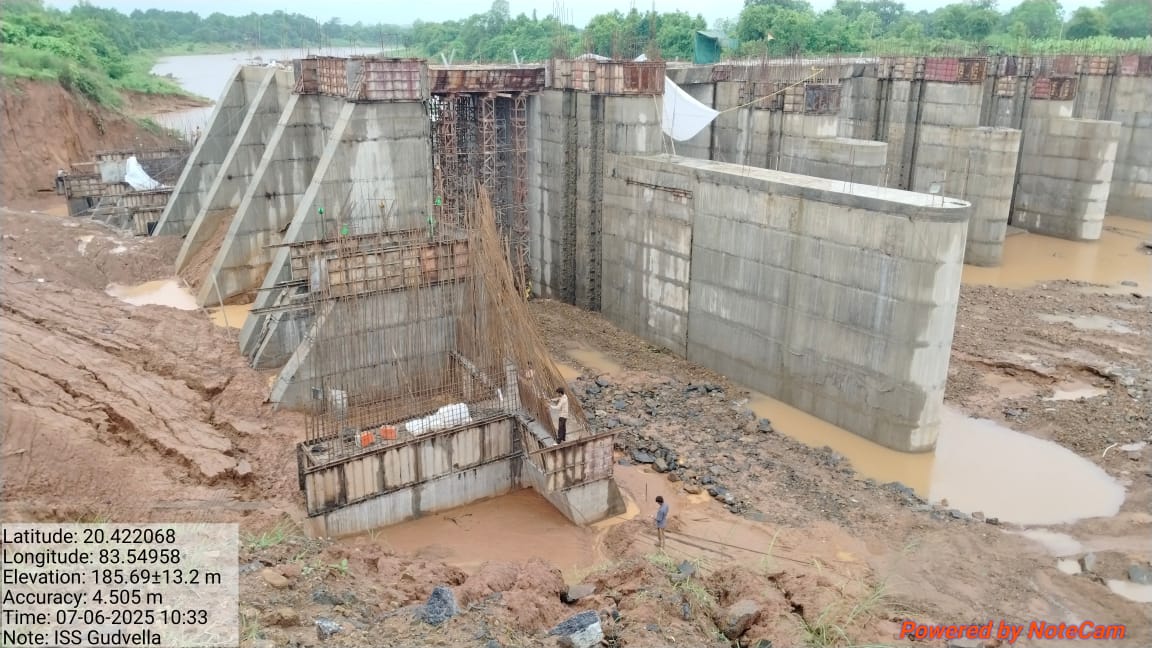

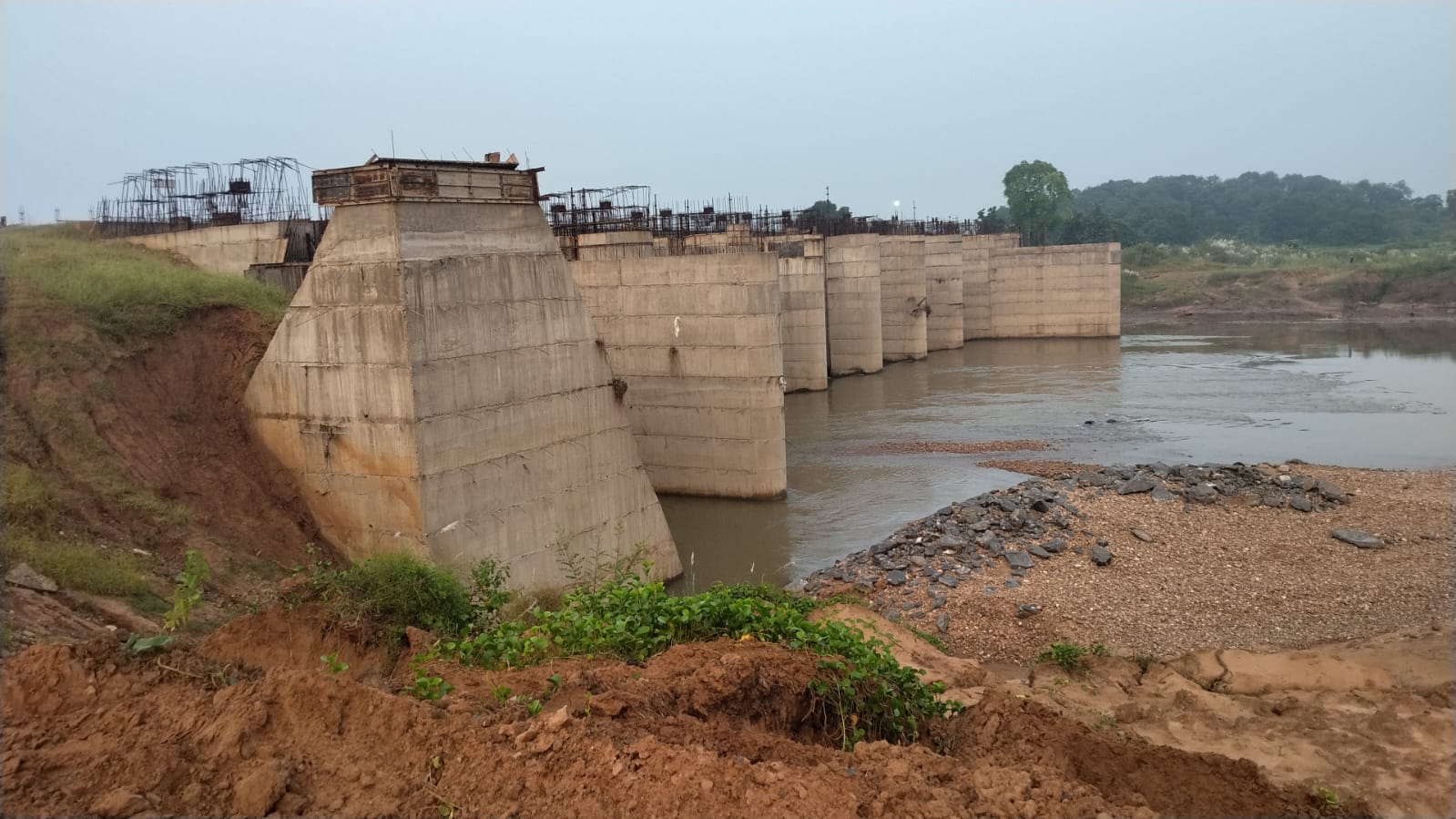

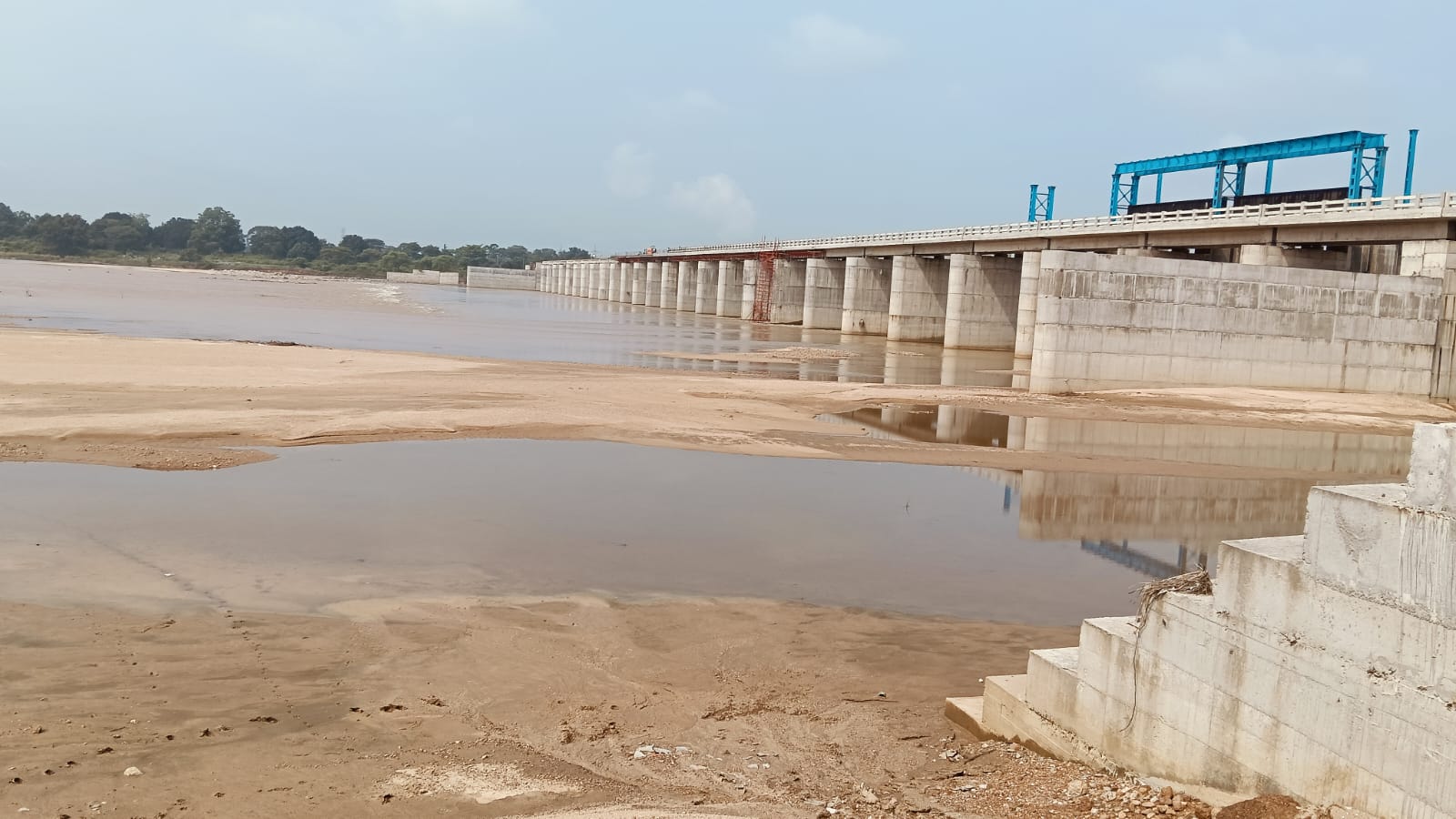

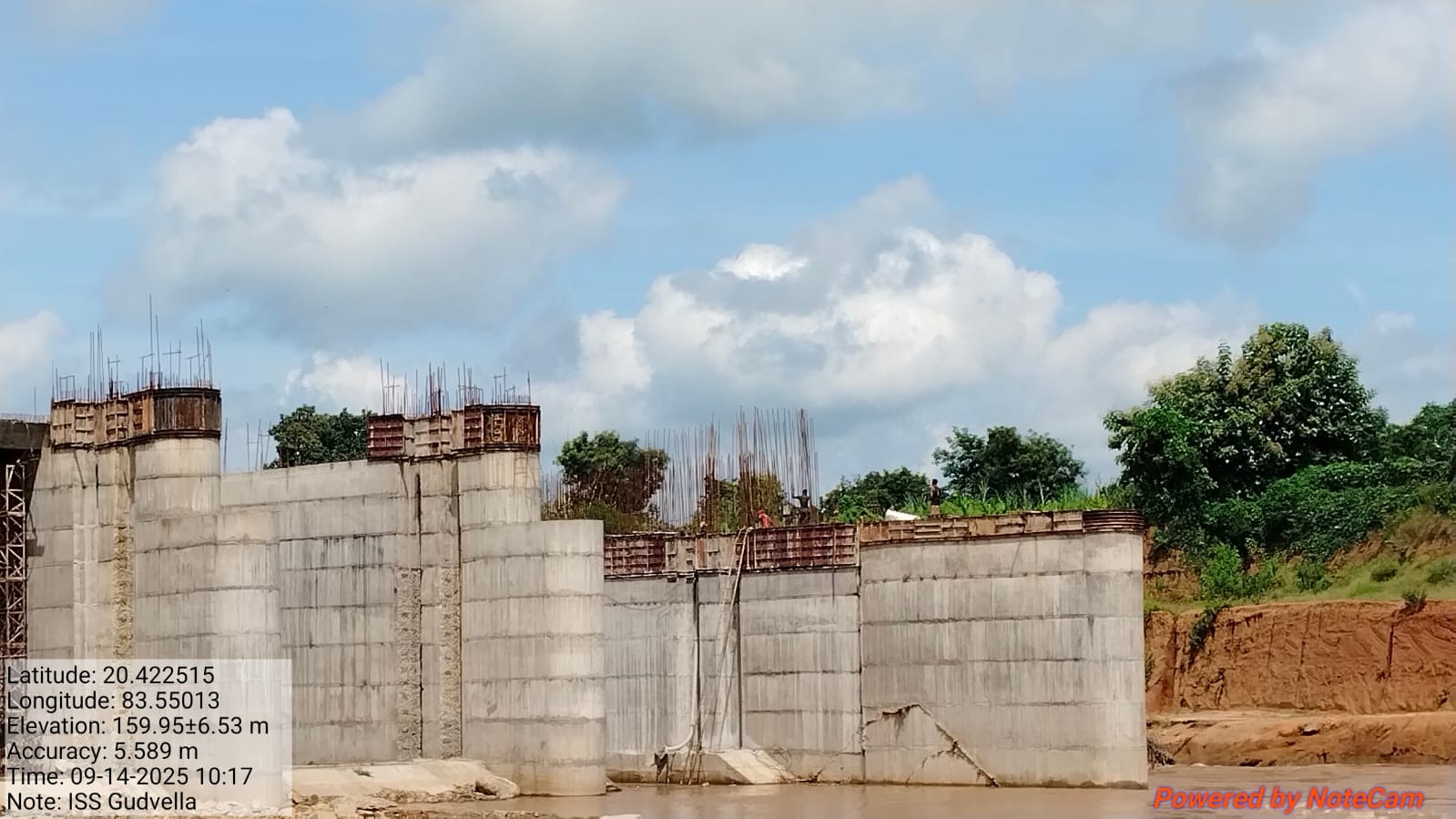

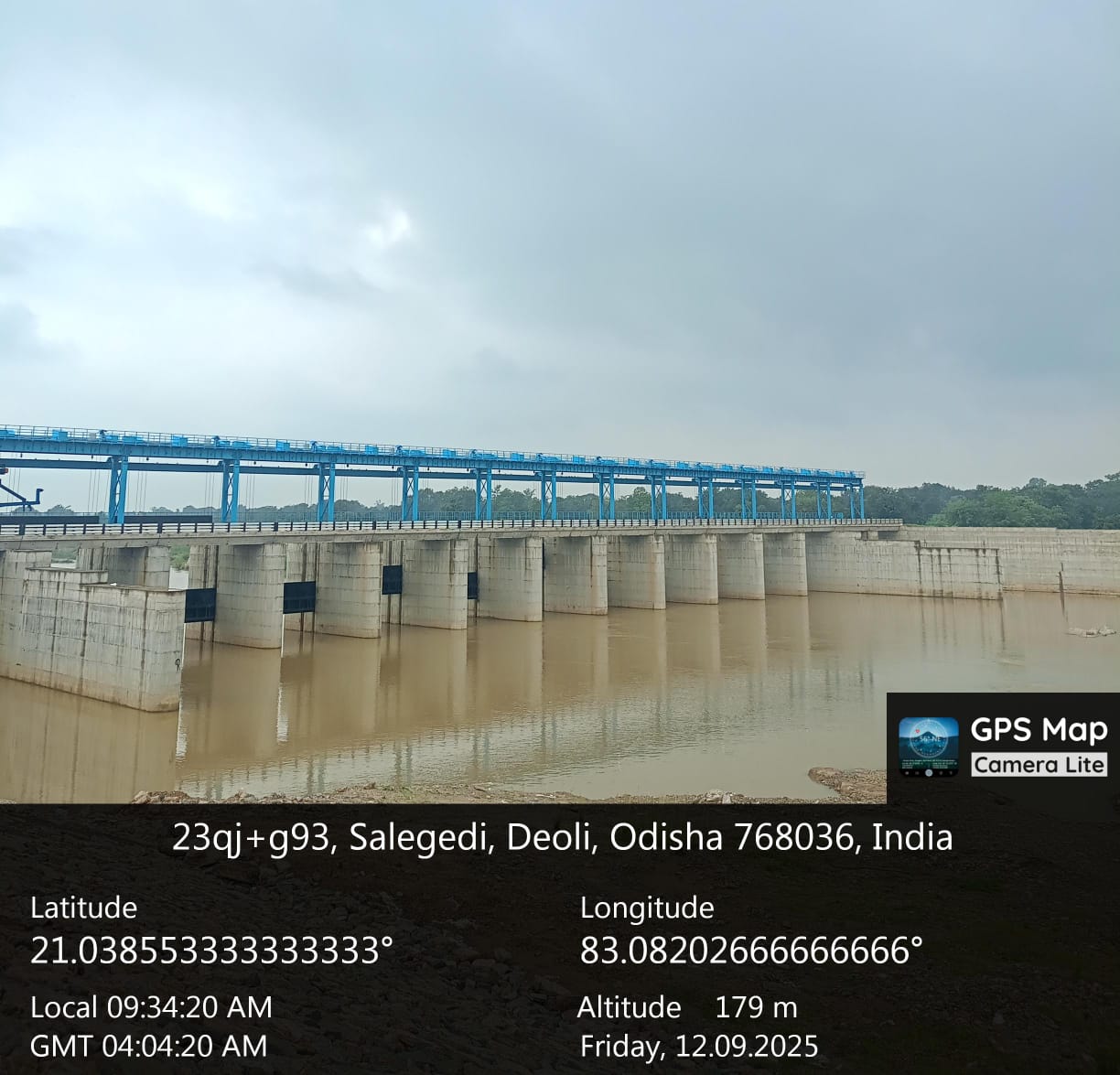

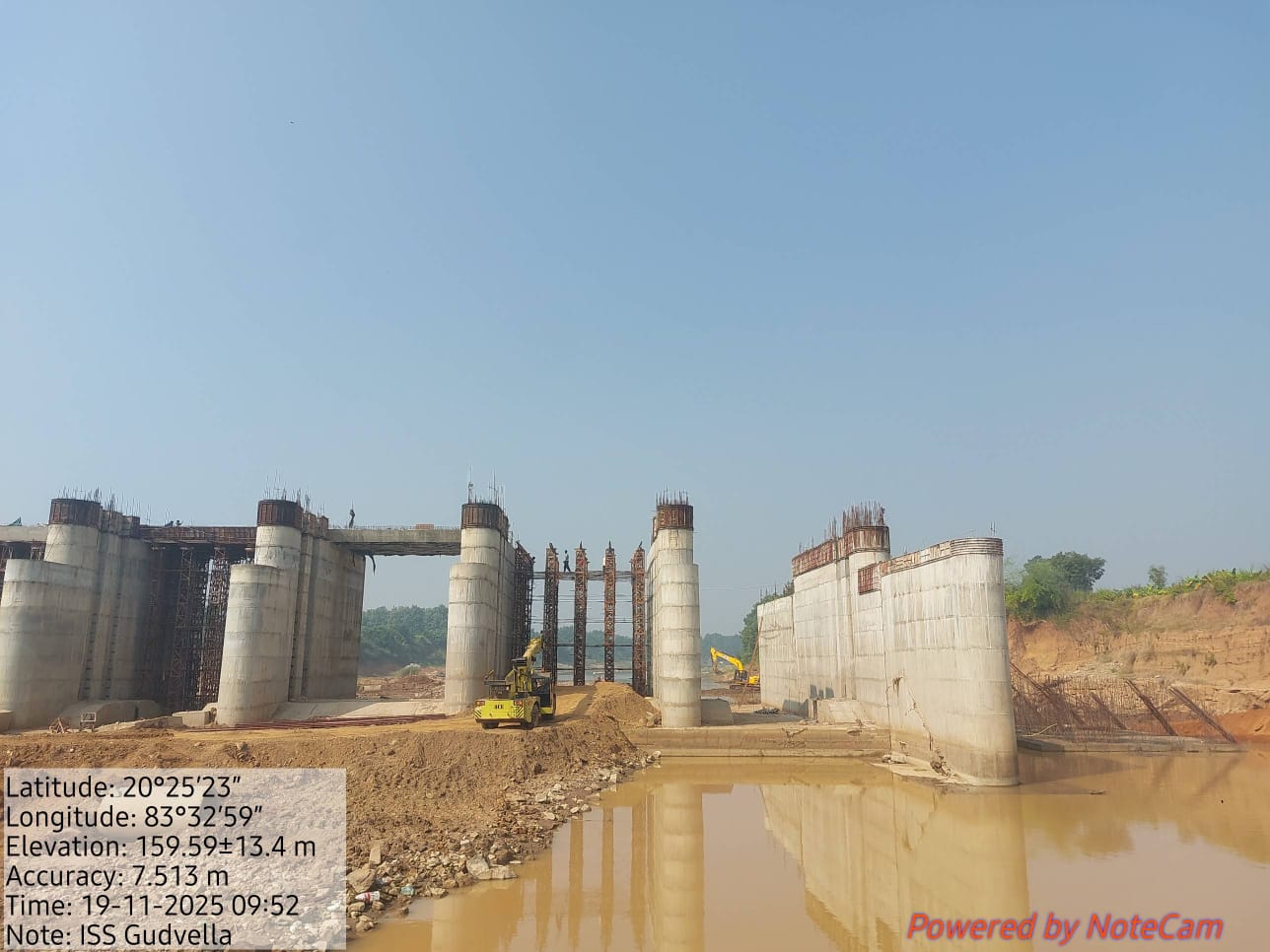

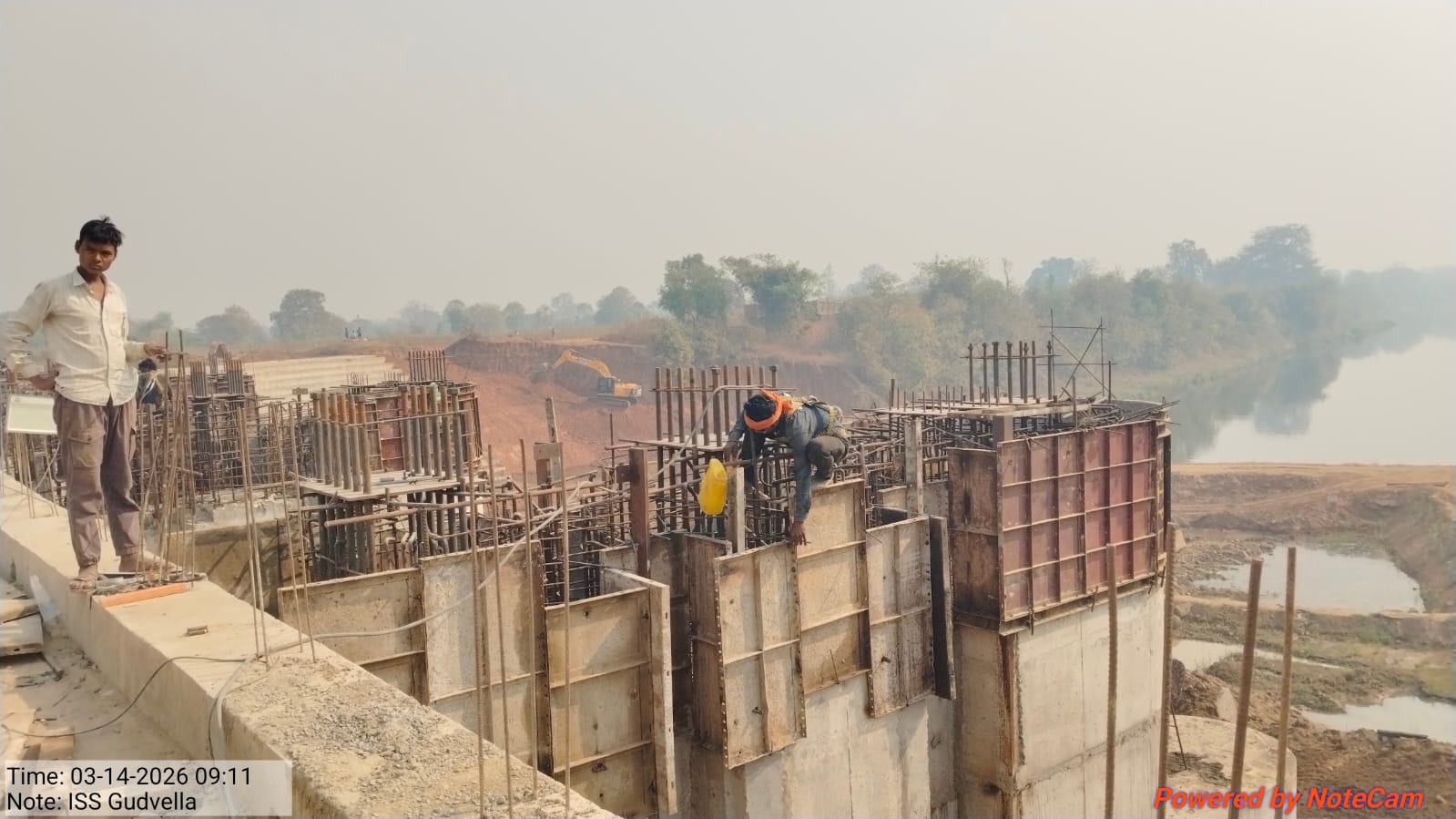

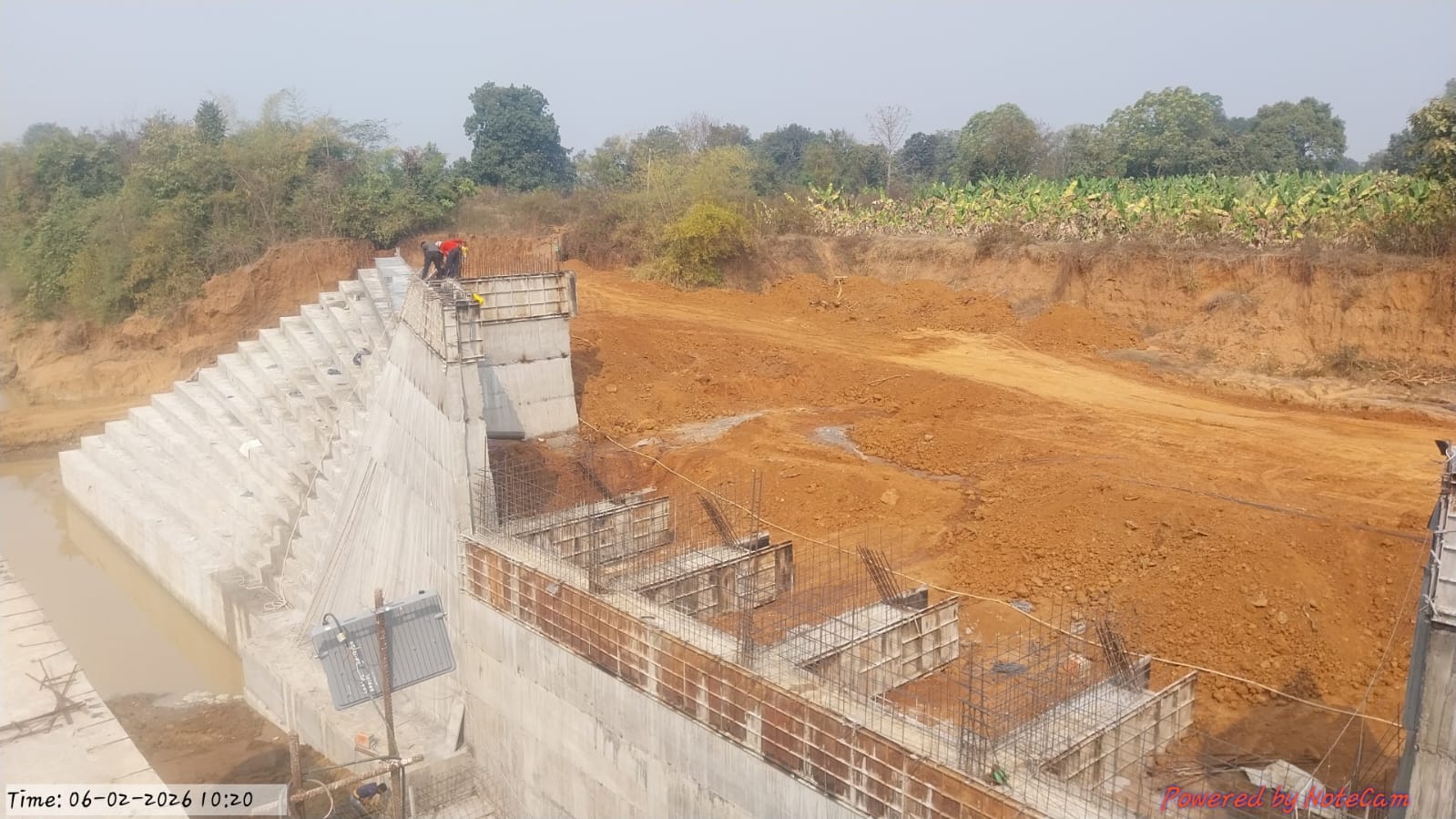

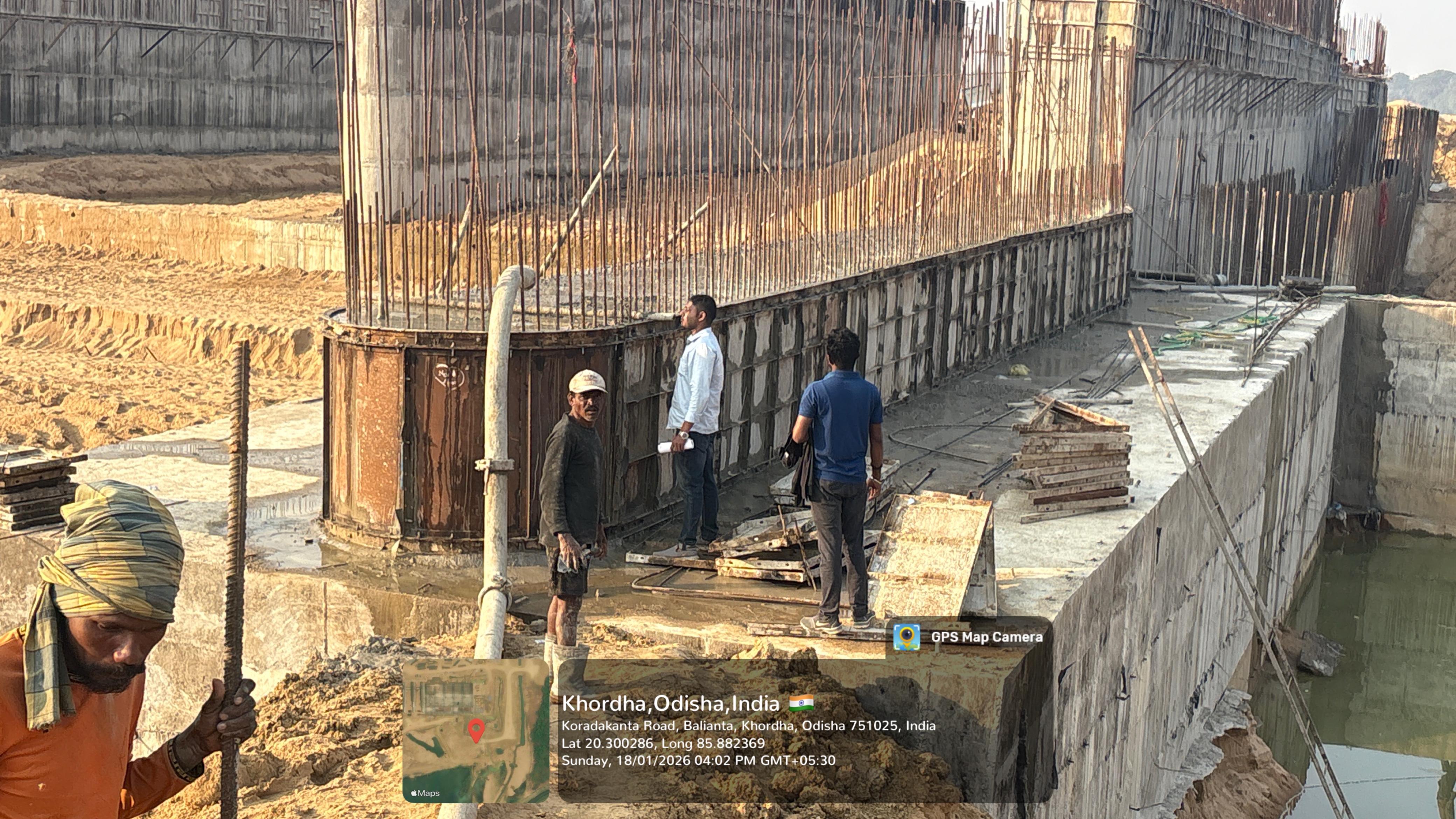

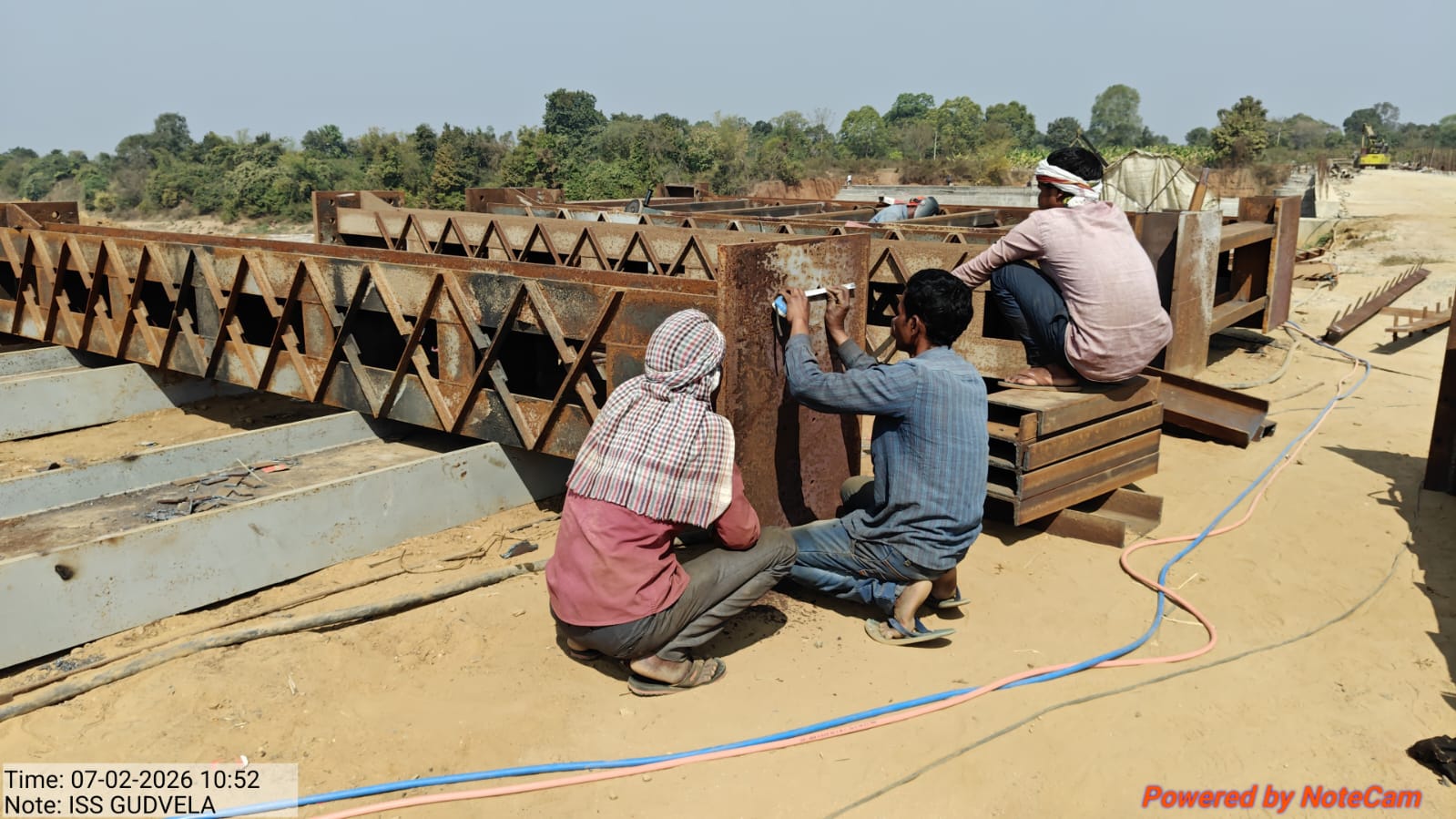

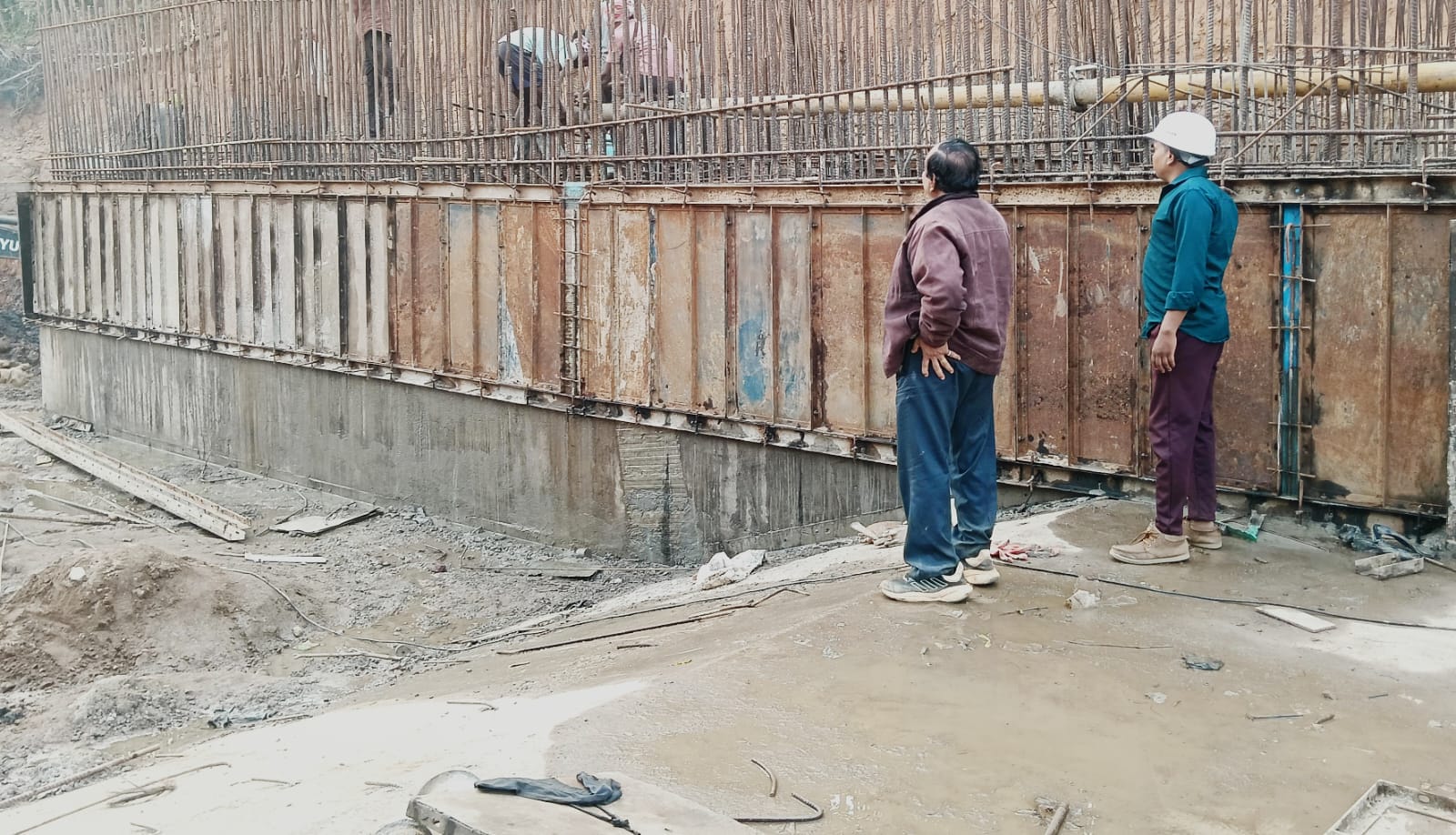

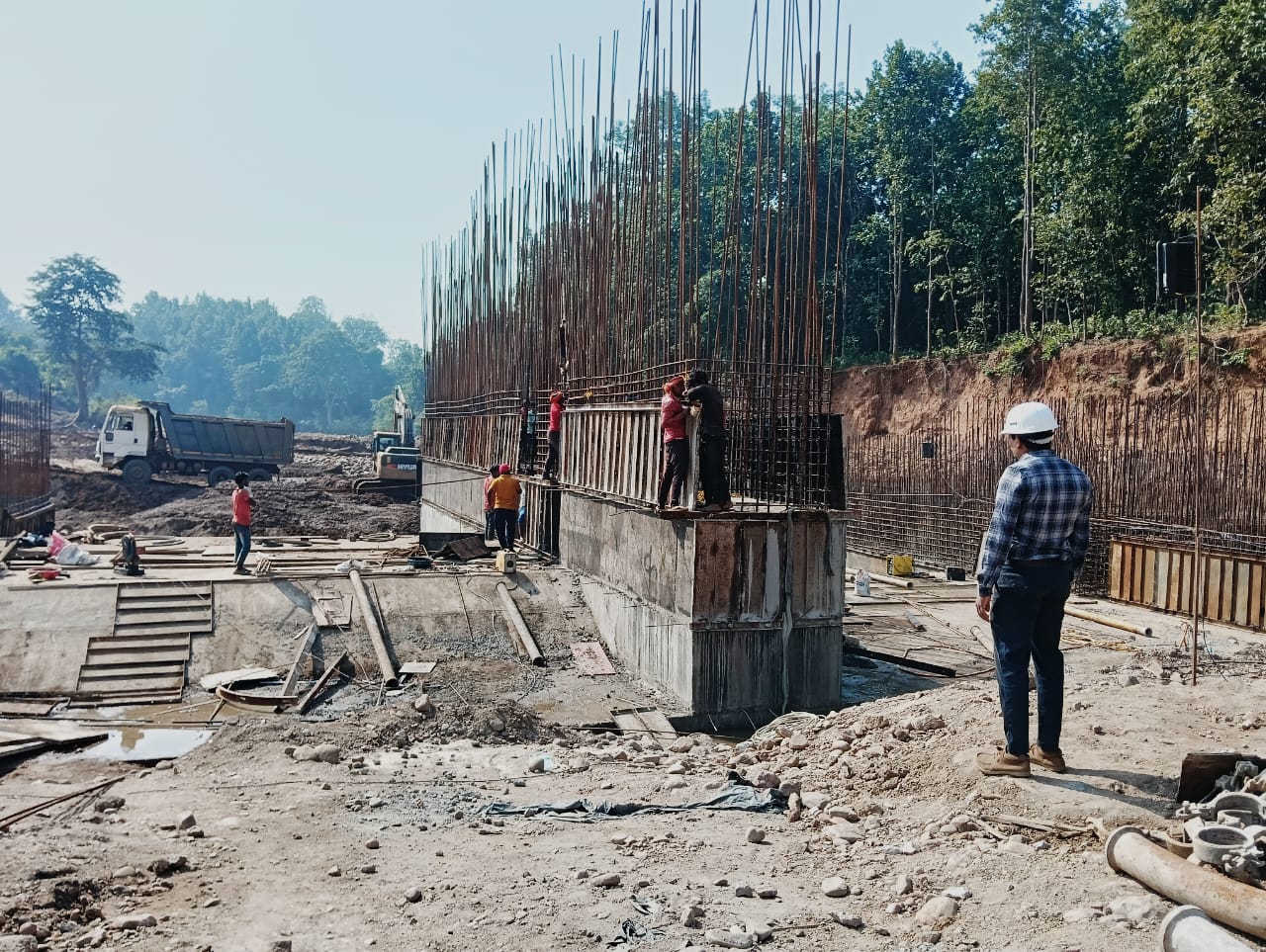

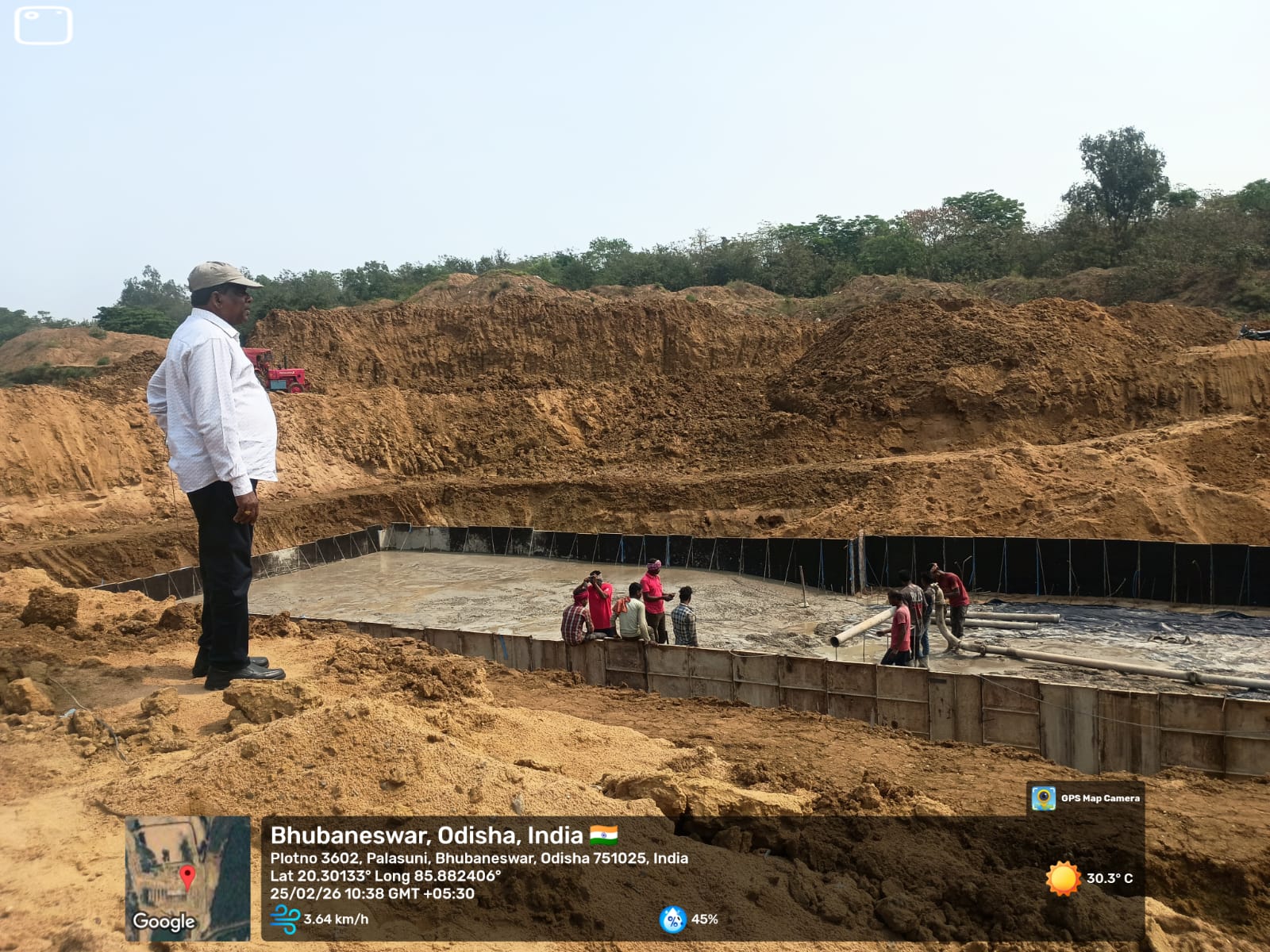

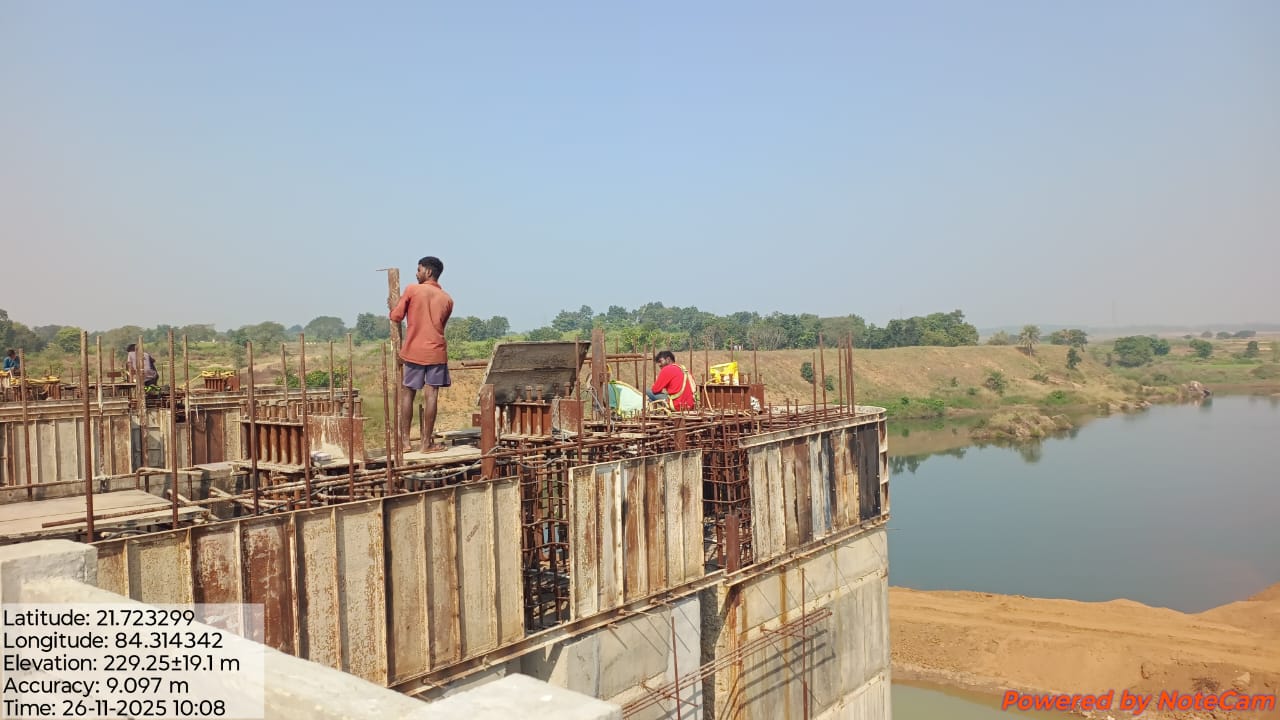

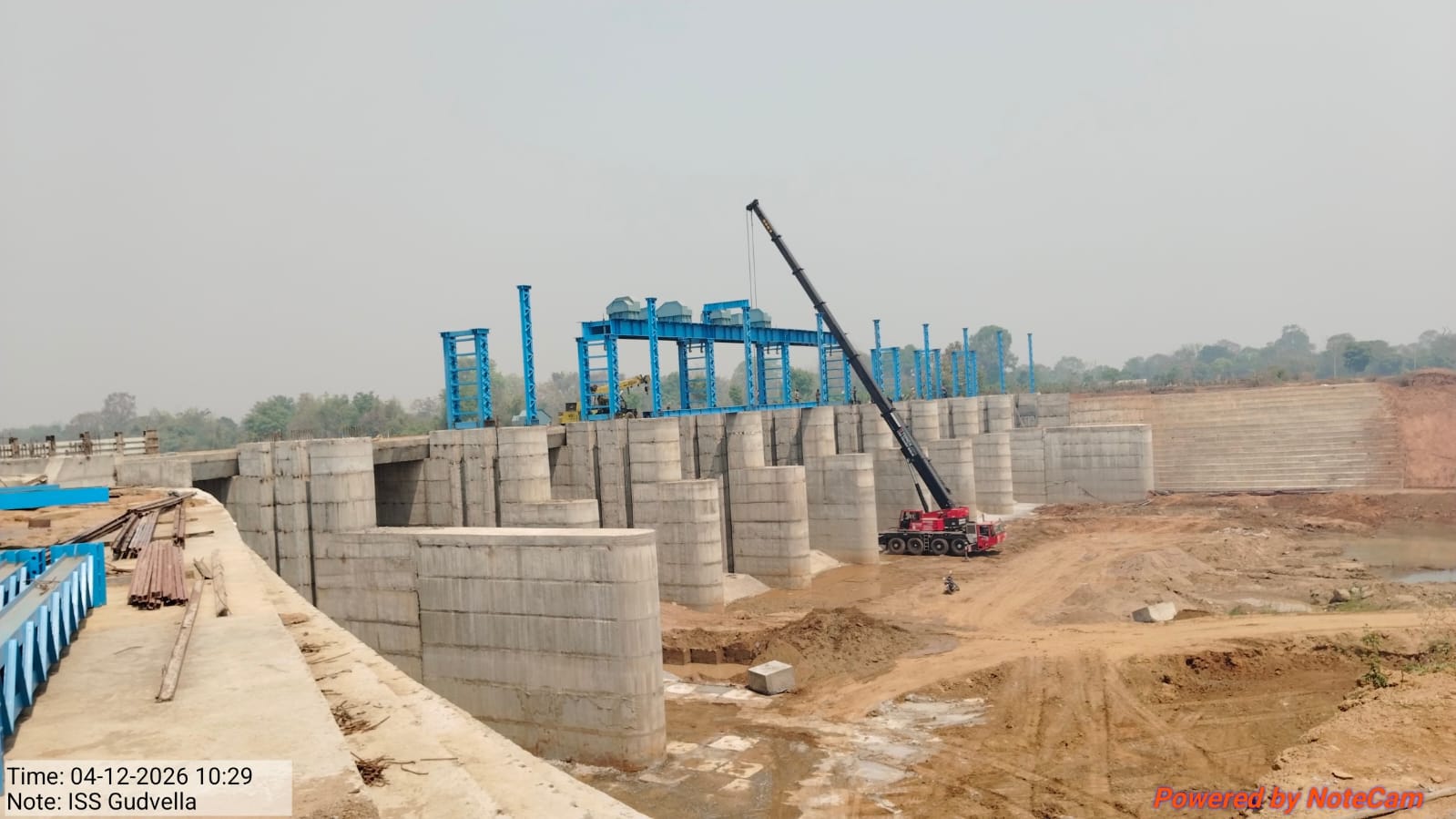

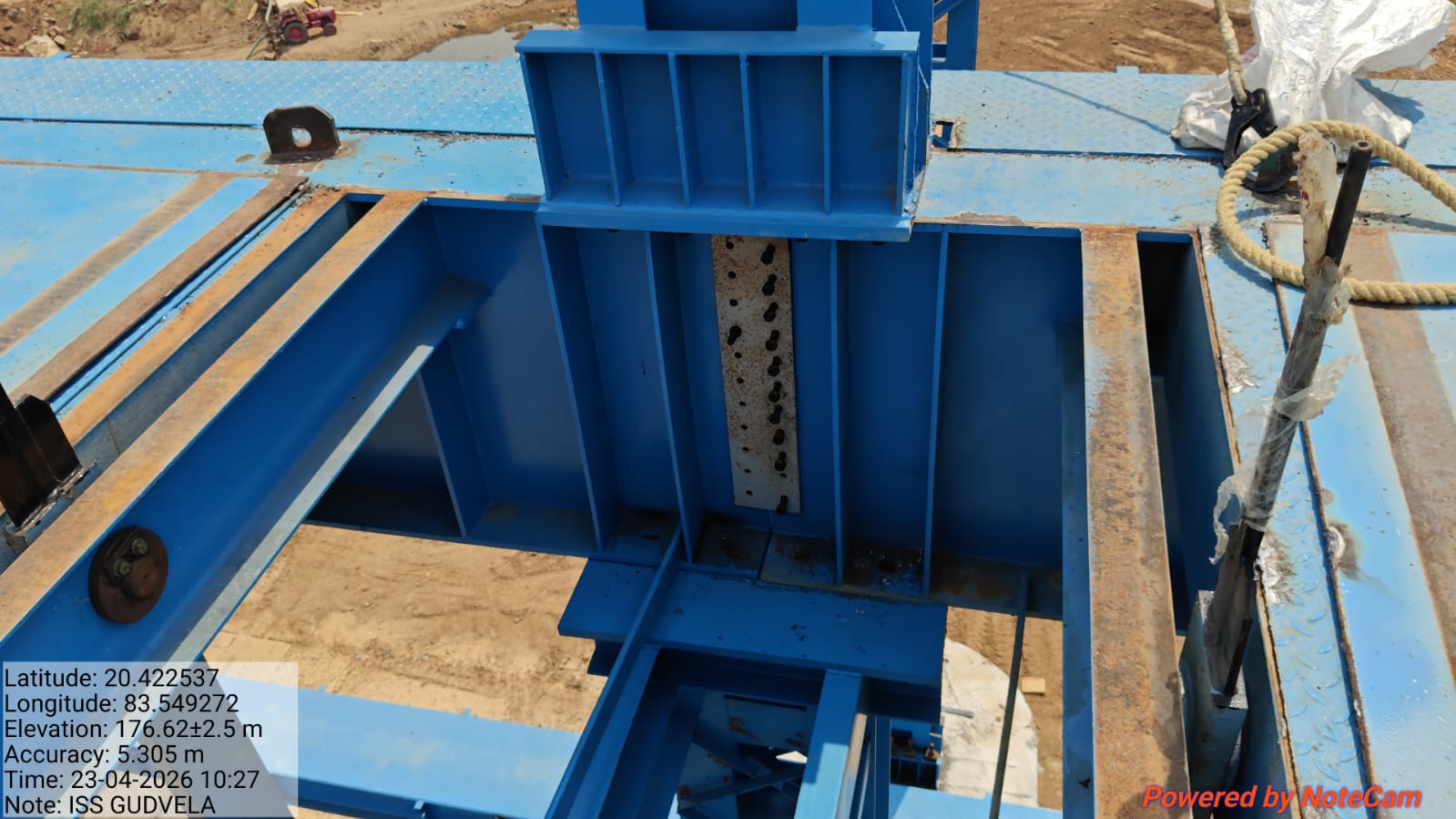

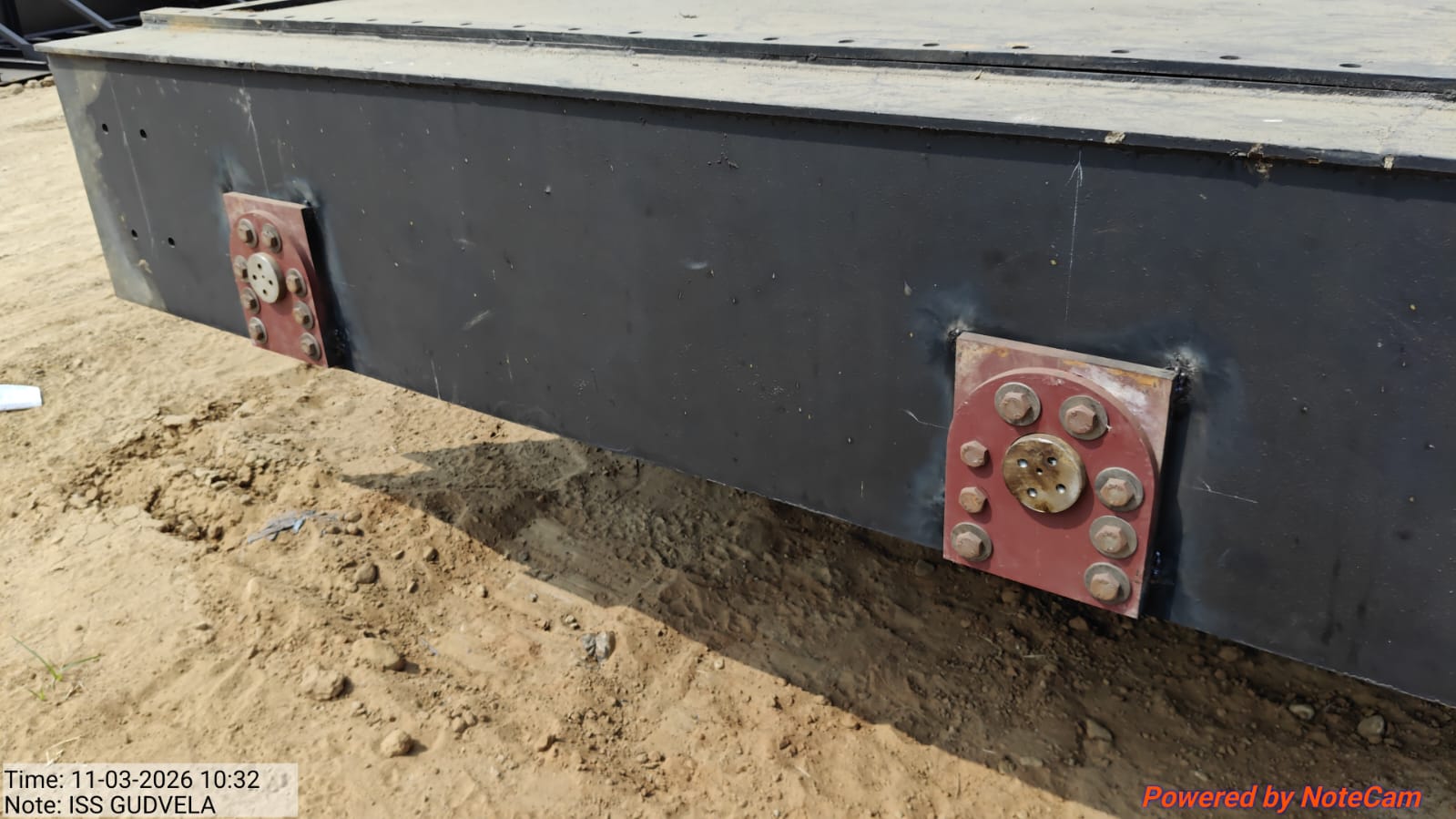

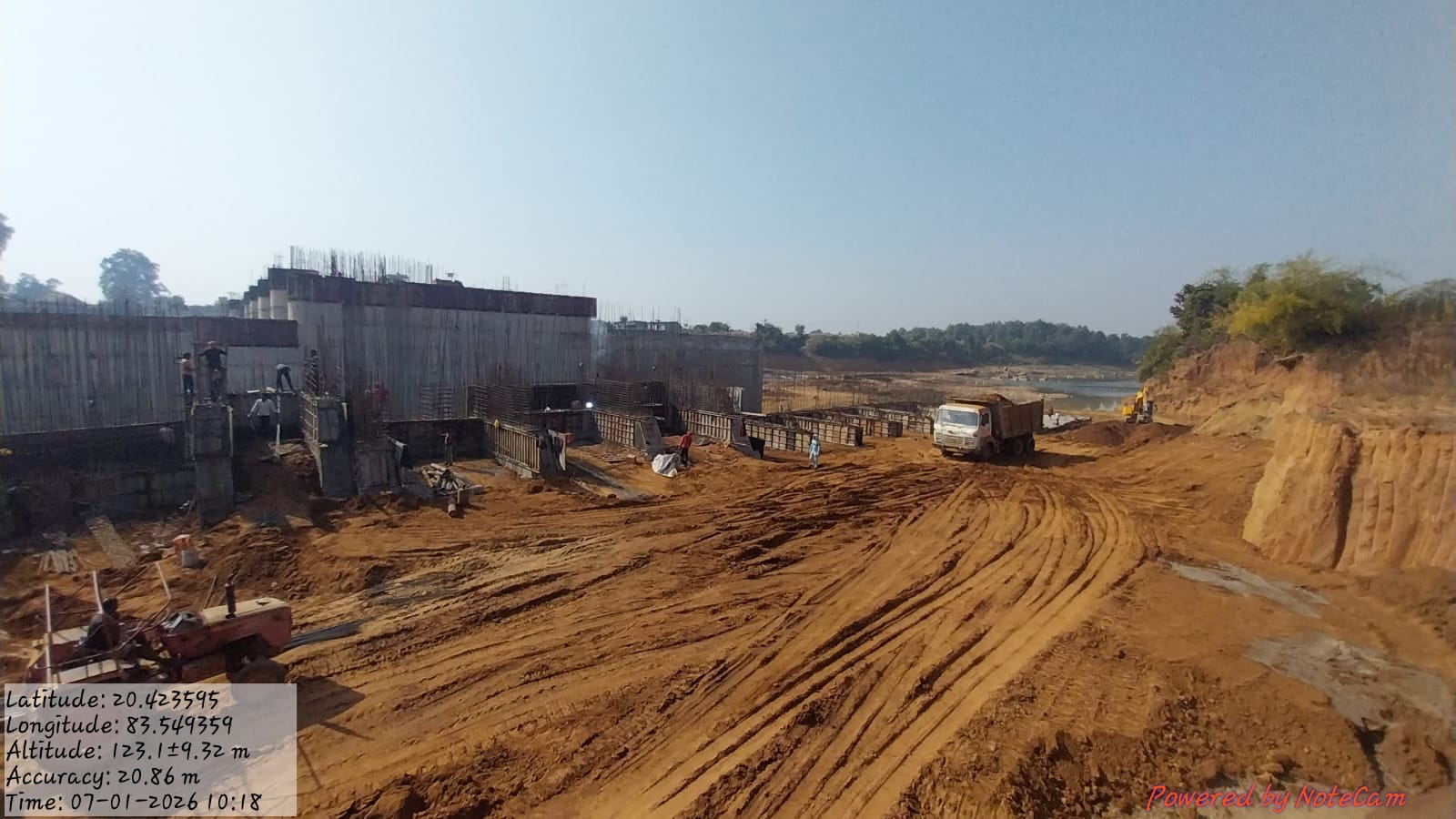

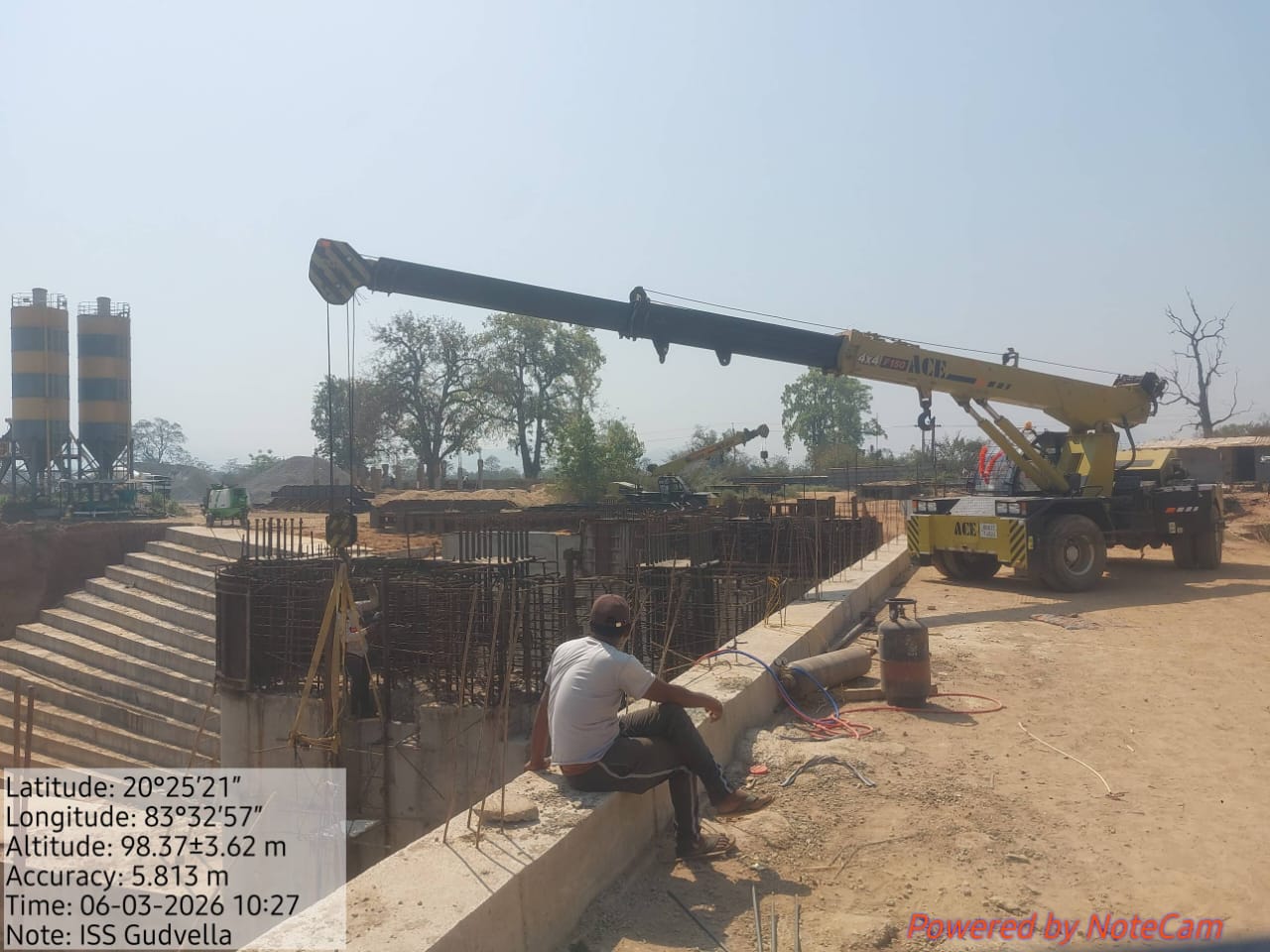

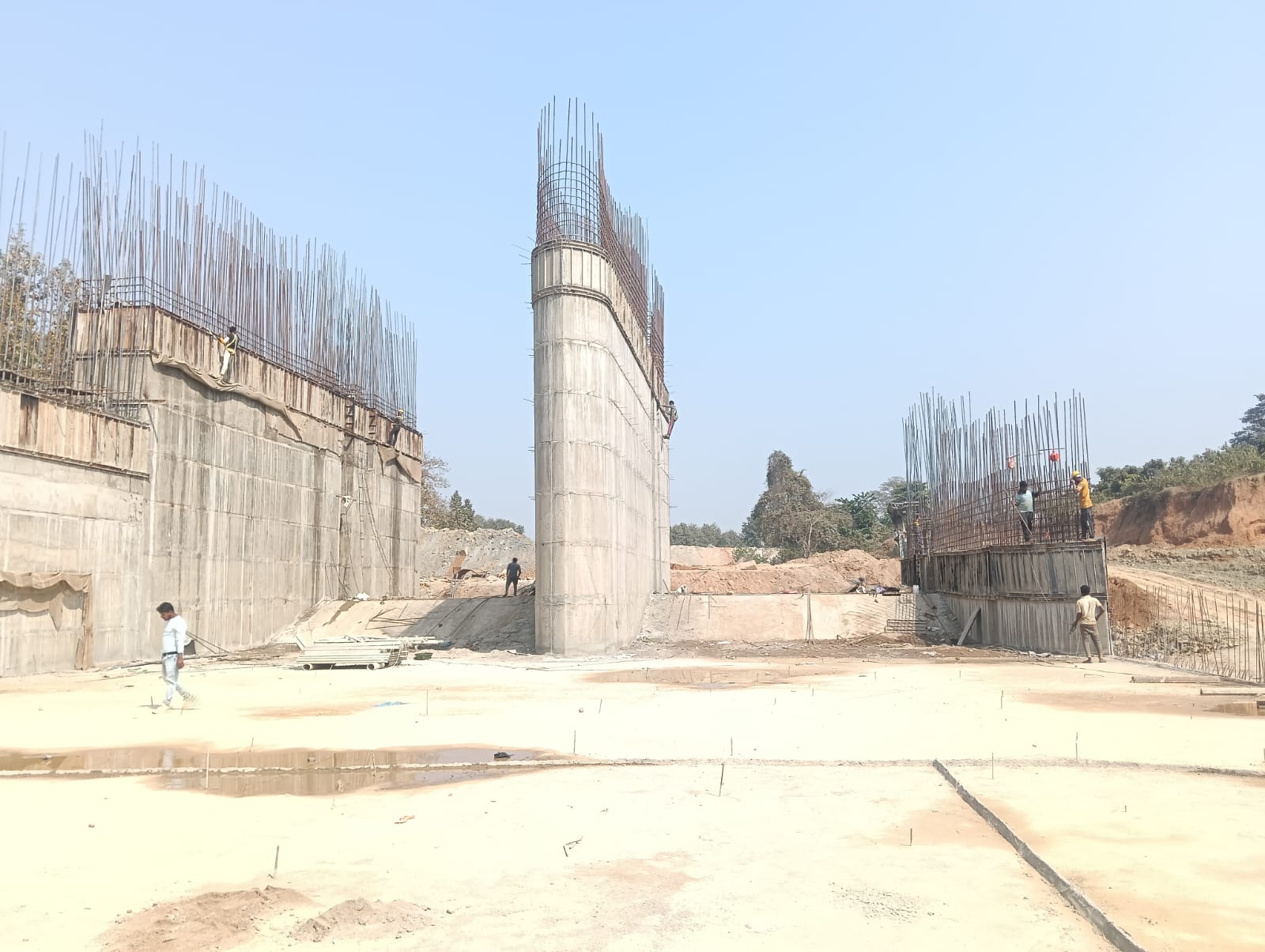

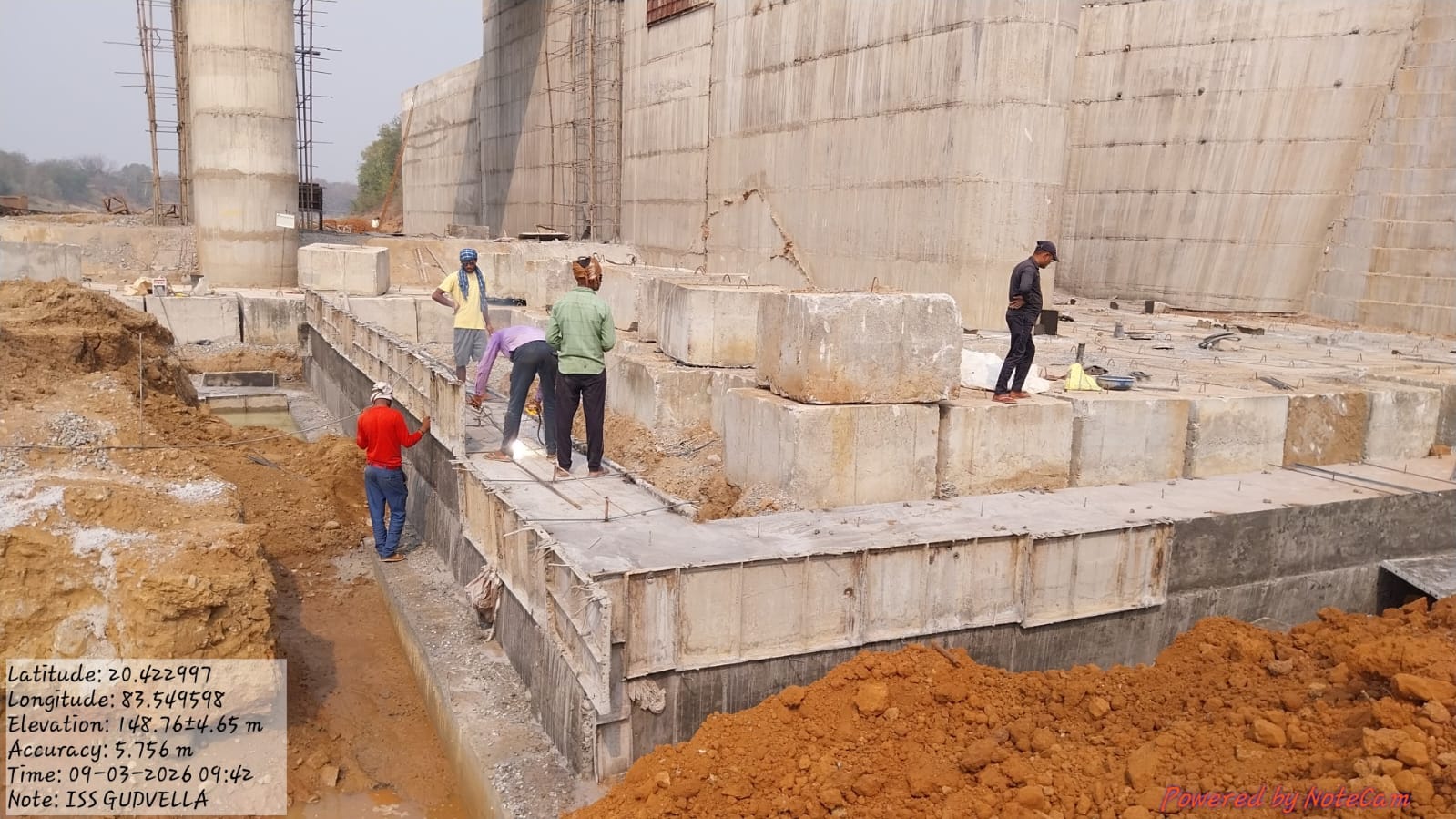

Instream Storage Structure, Gudvella

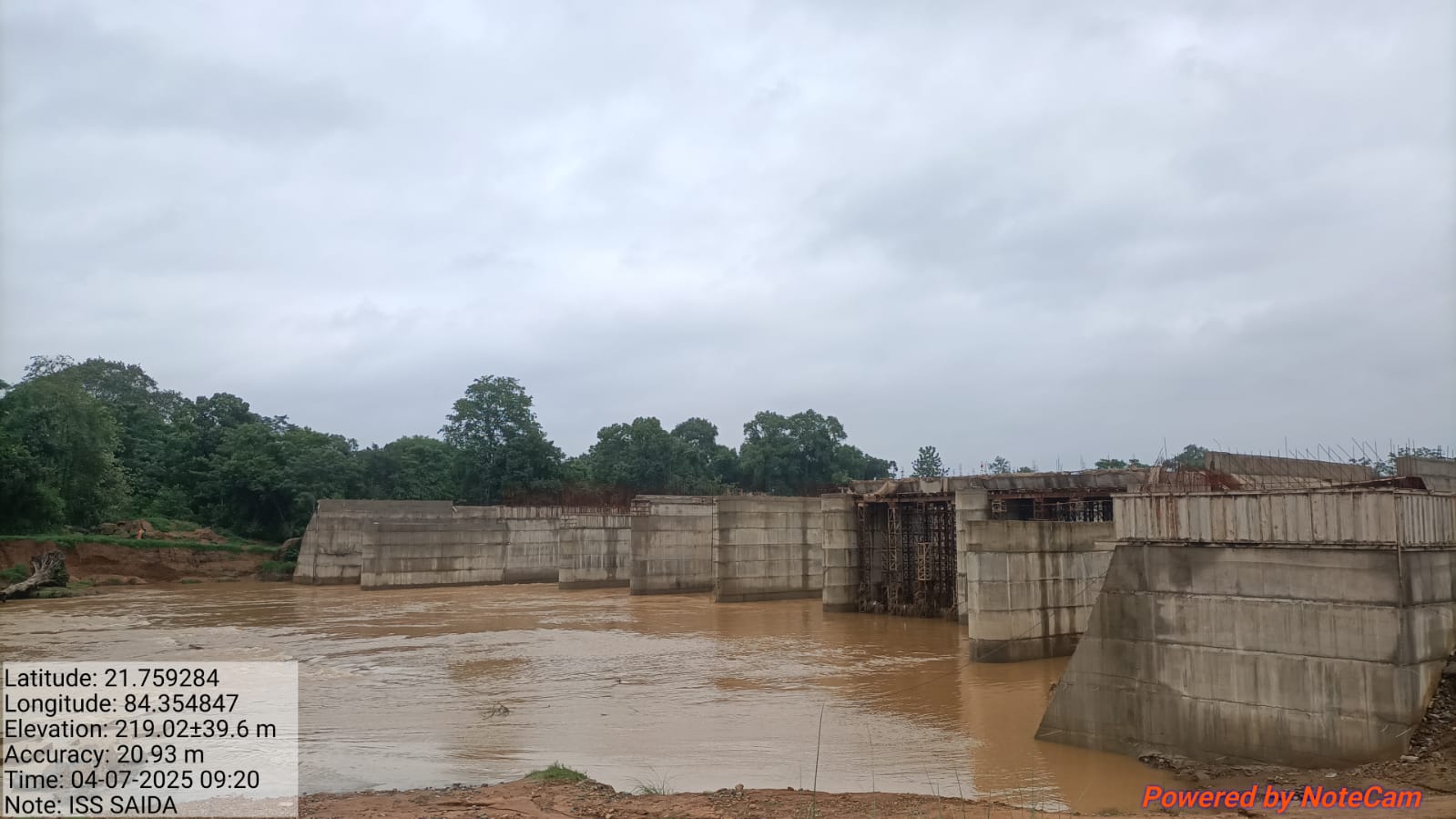

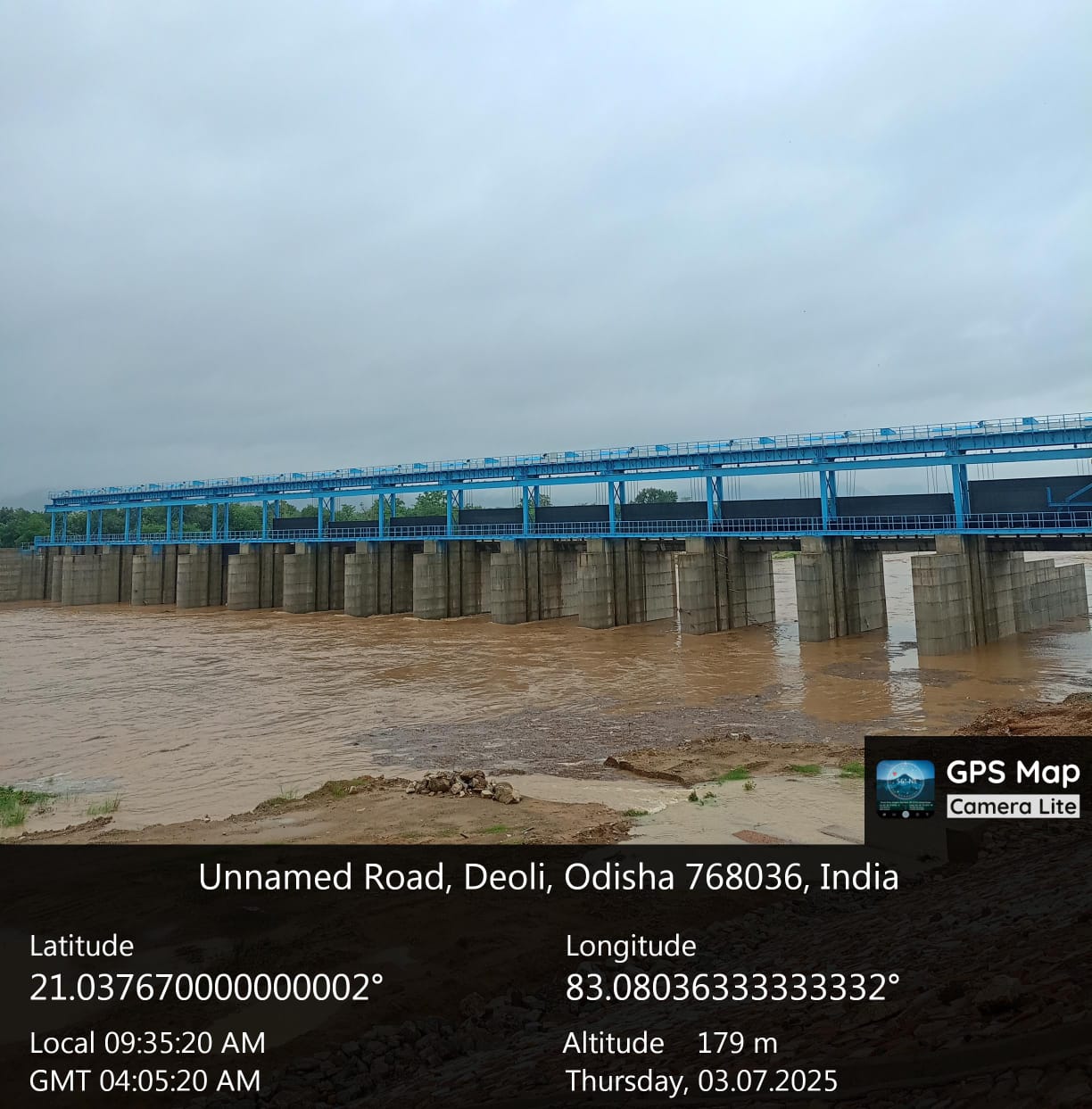

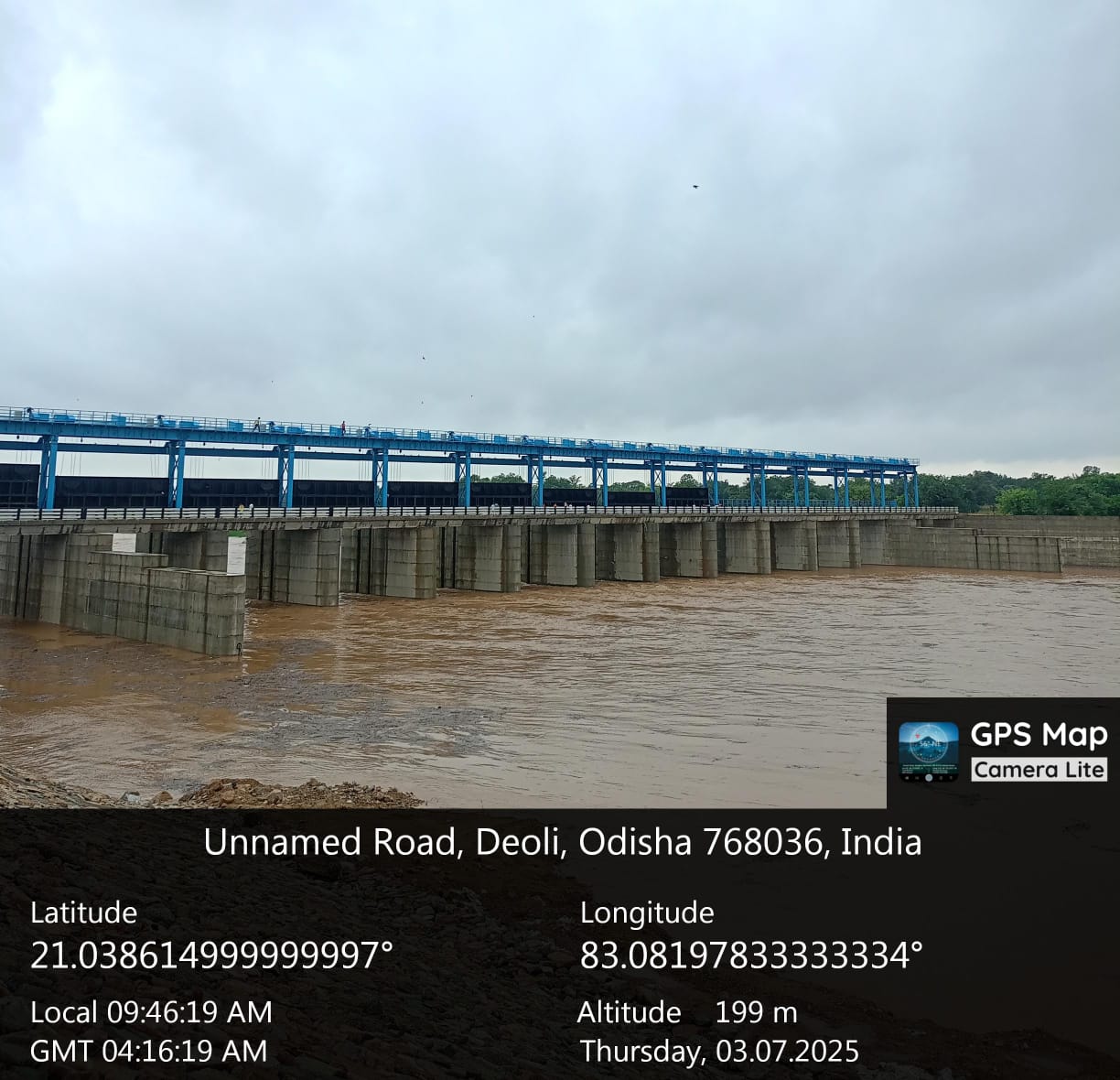

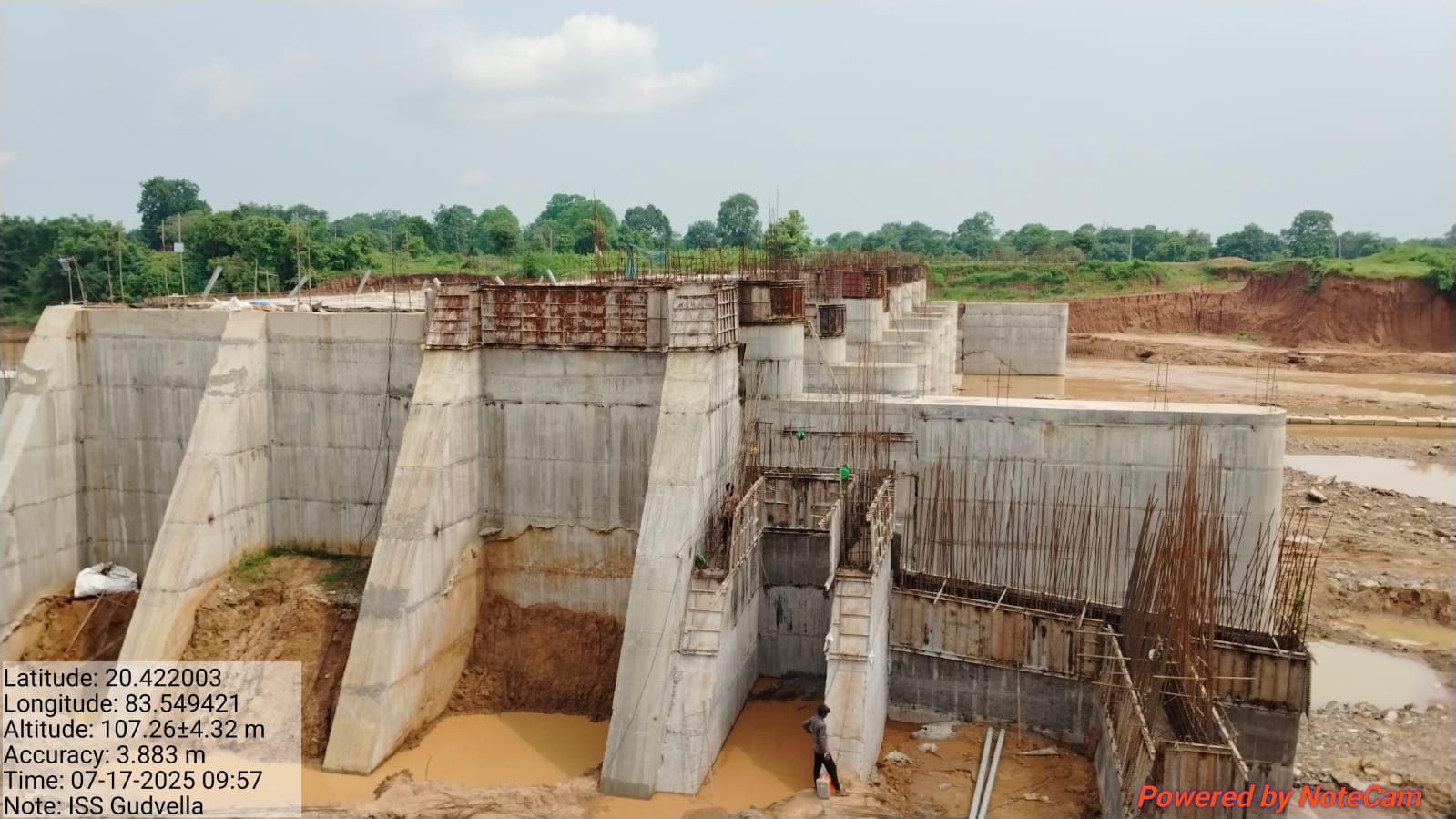

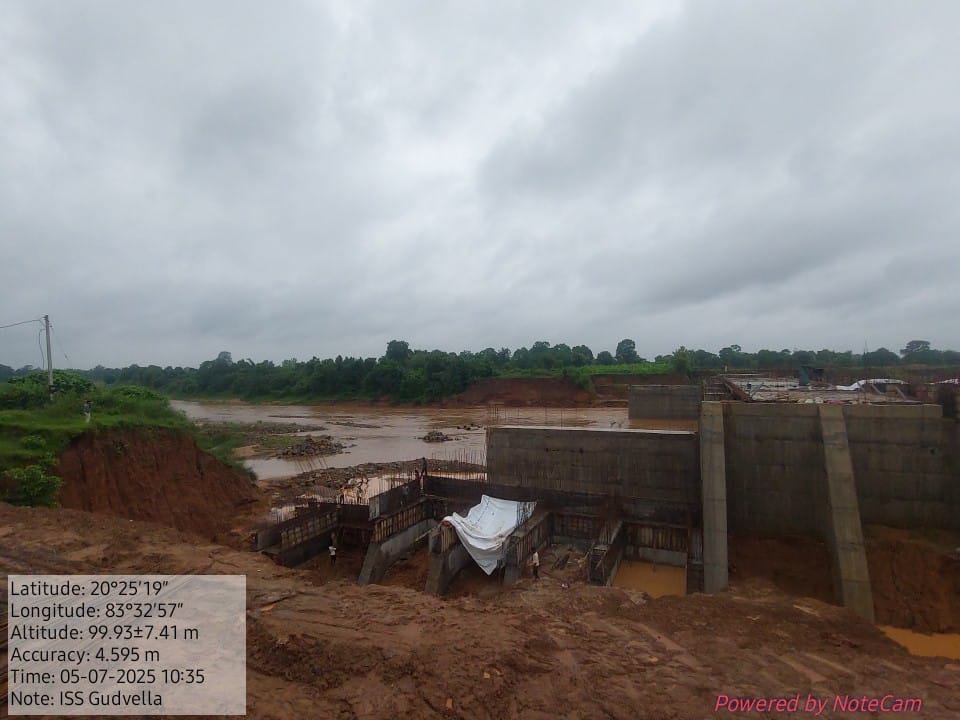

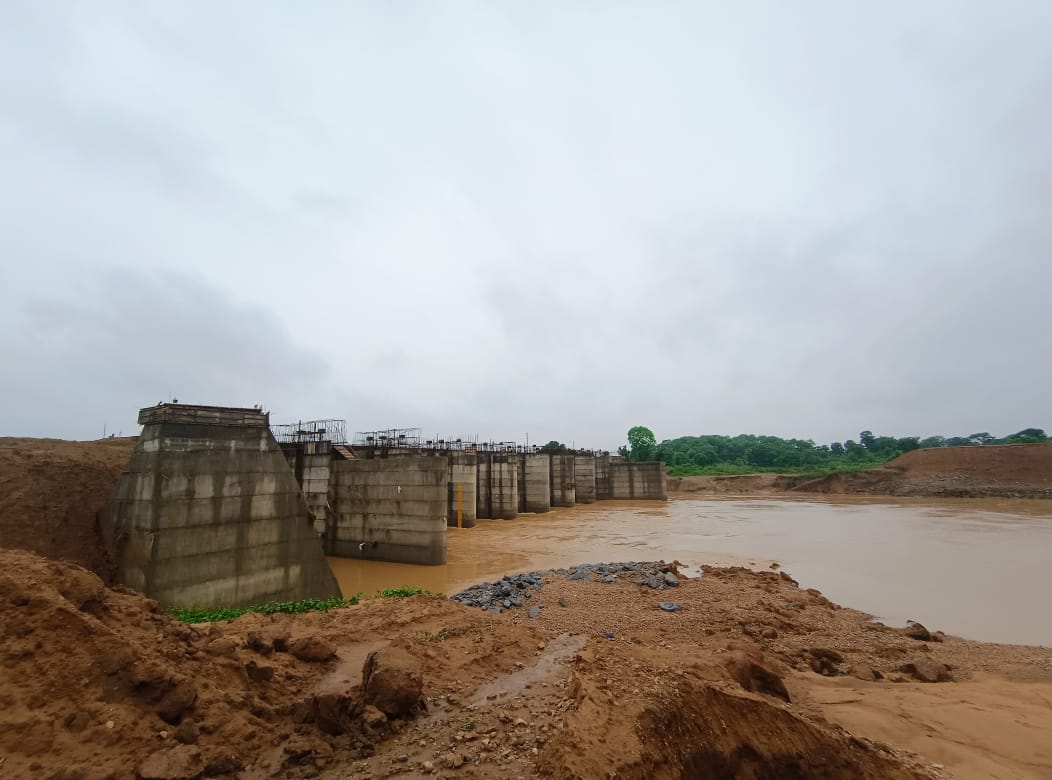

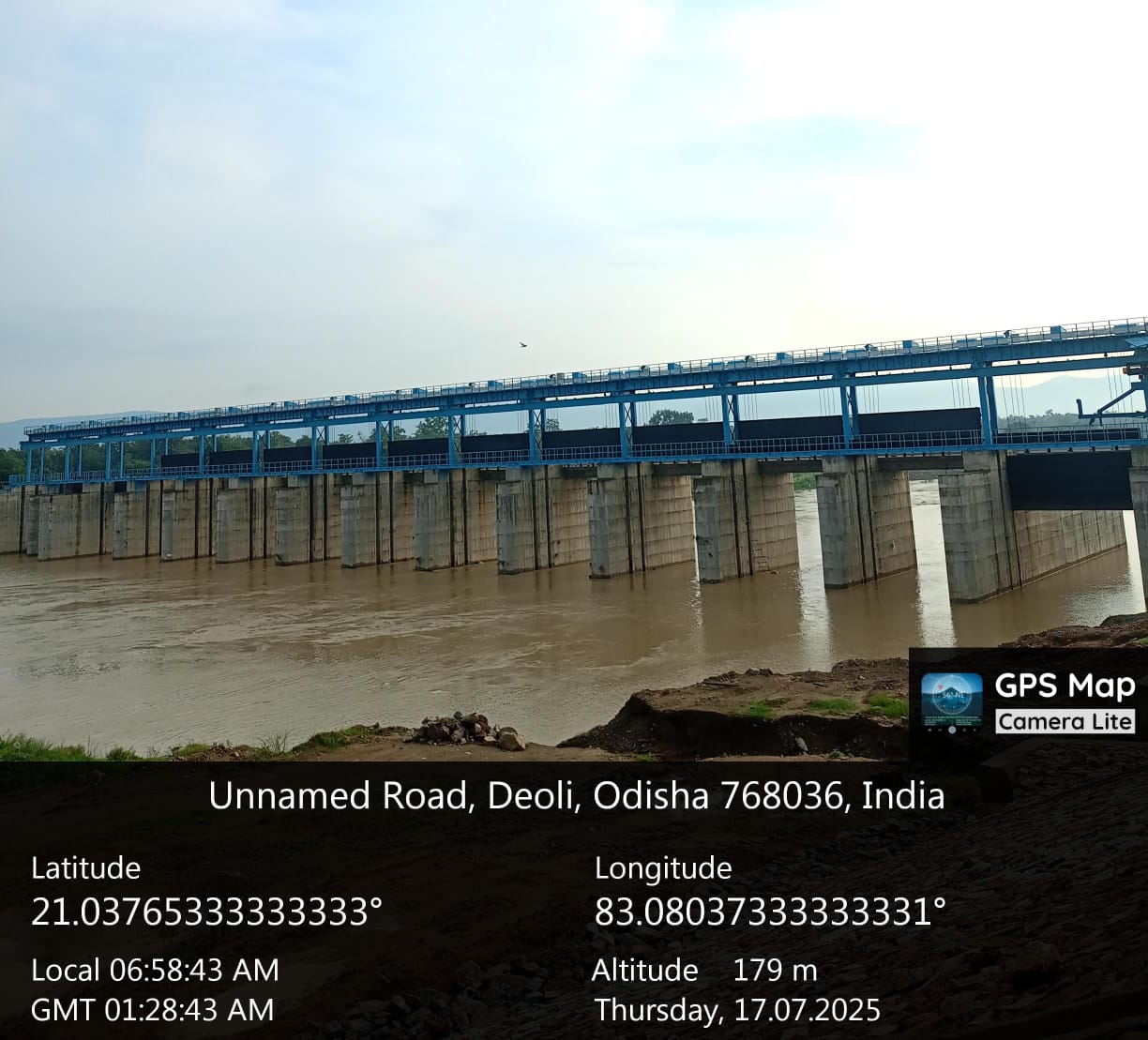

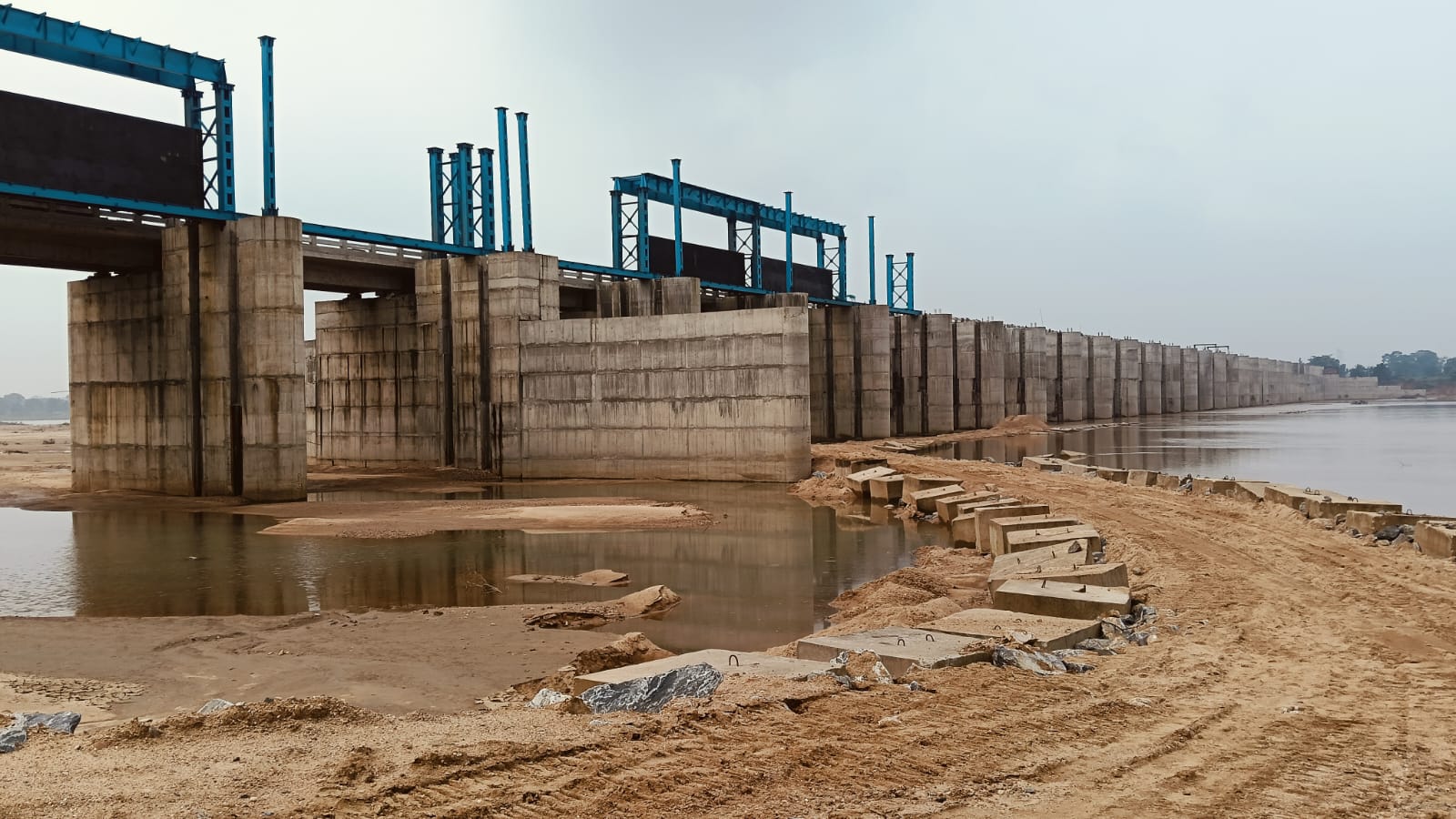

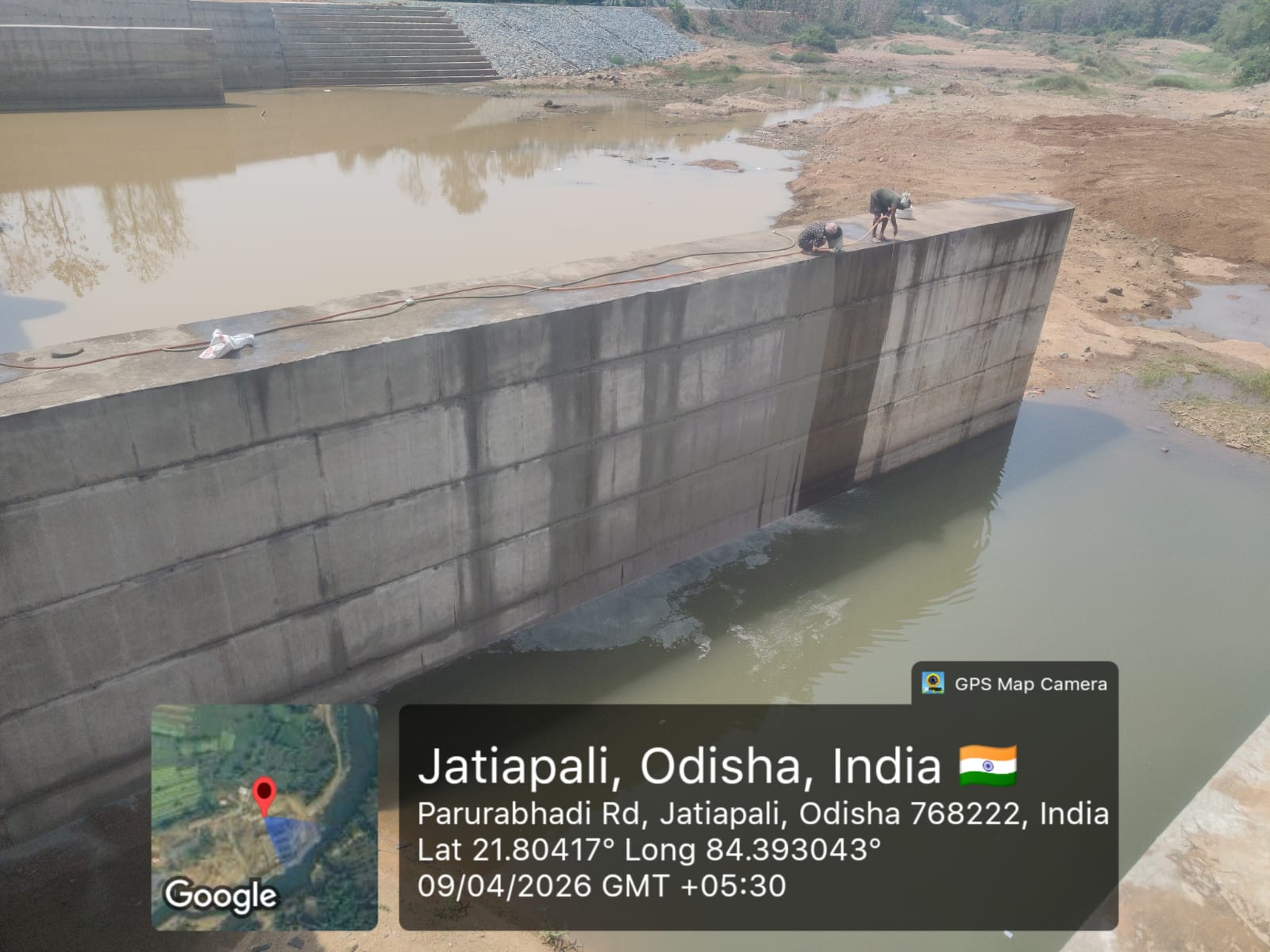

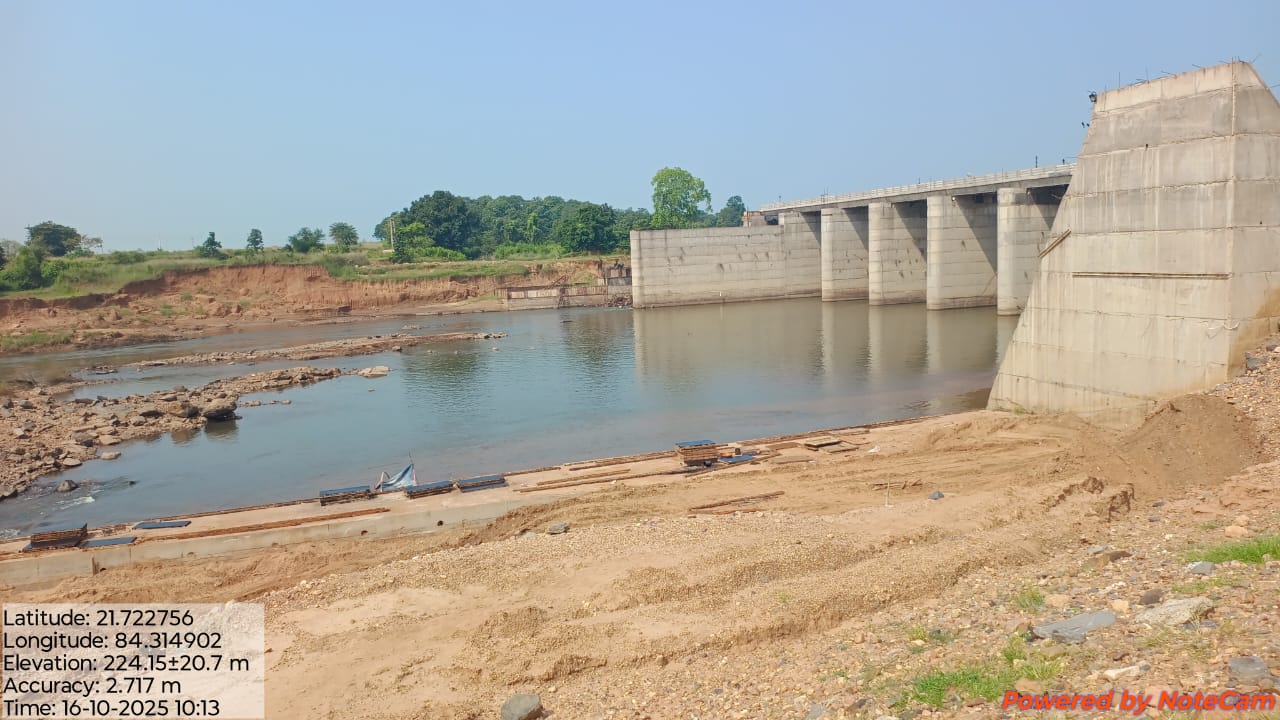

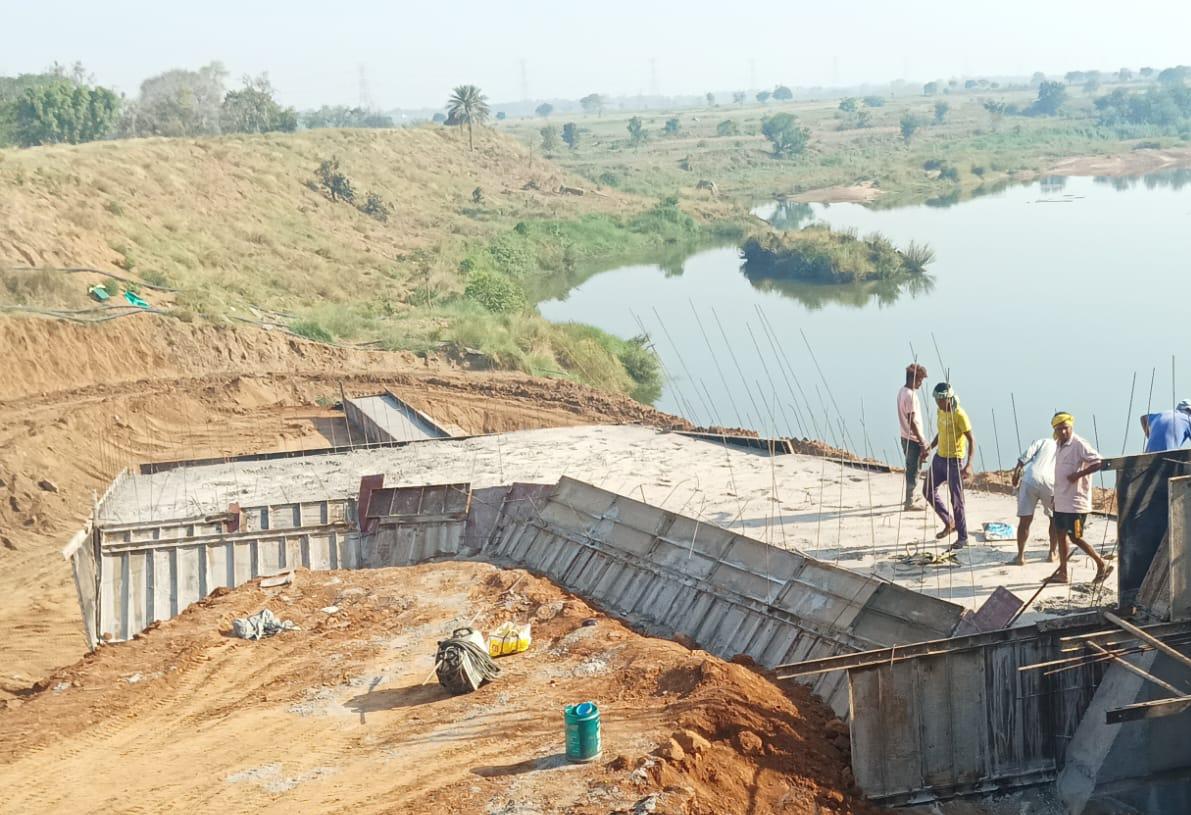

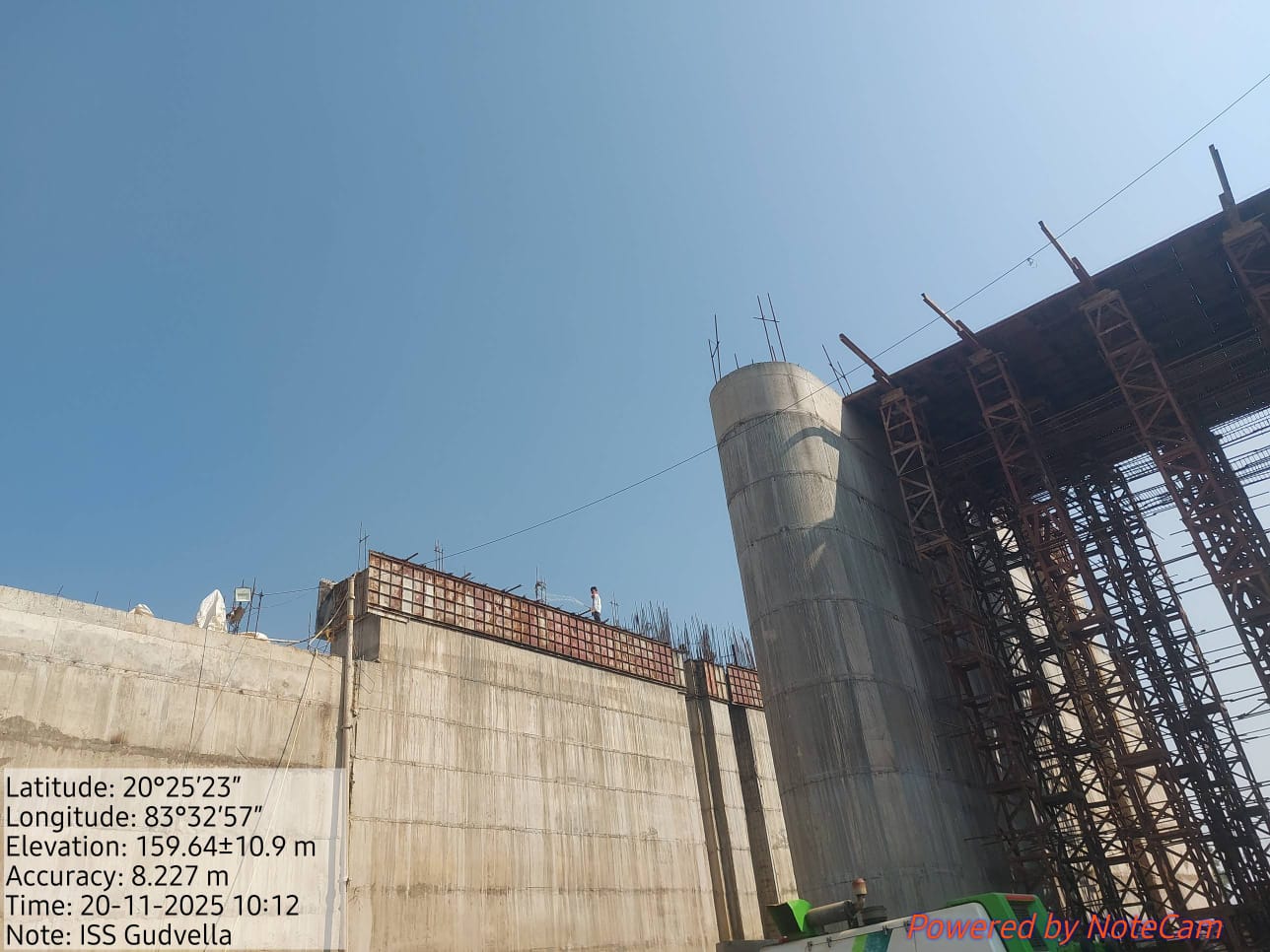

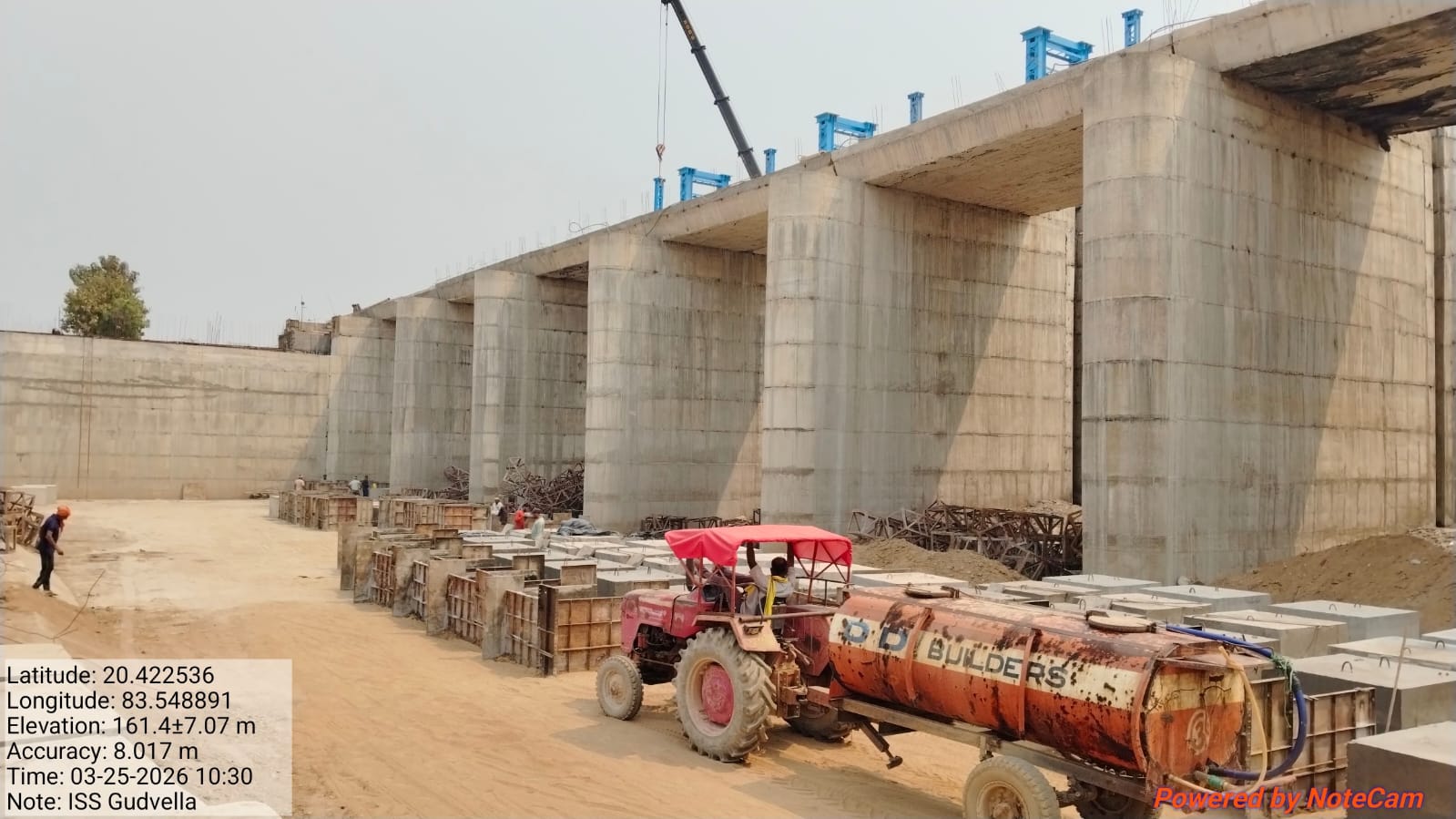

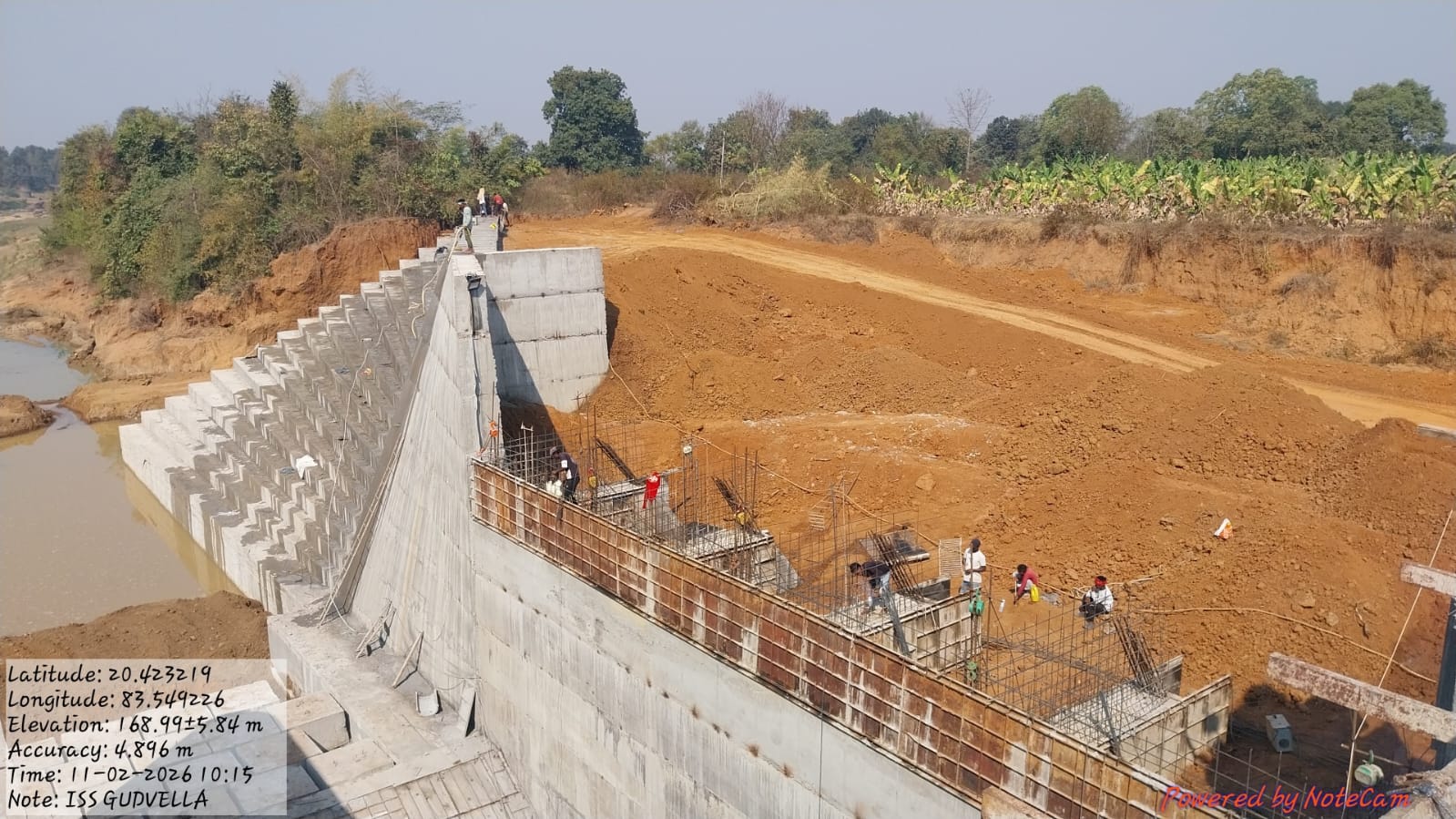

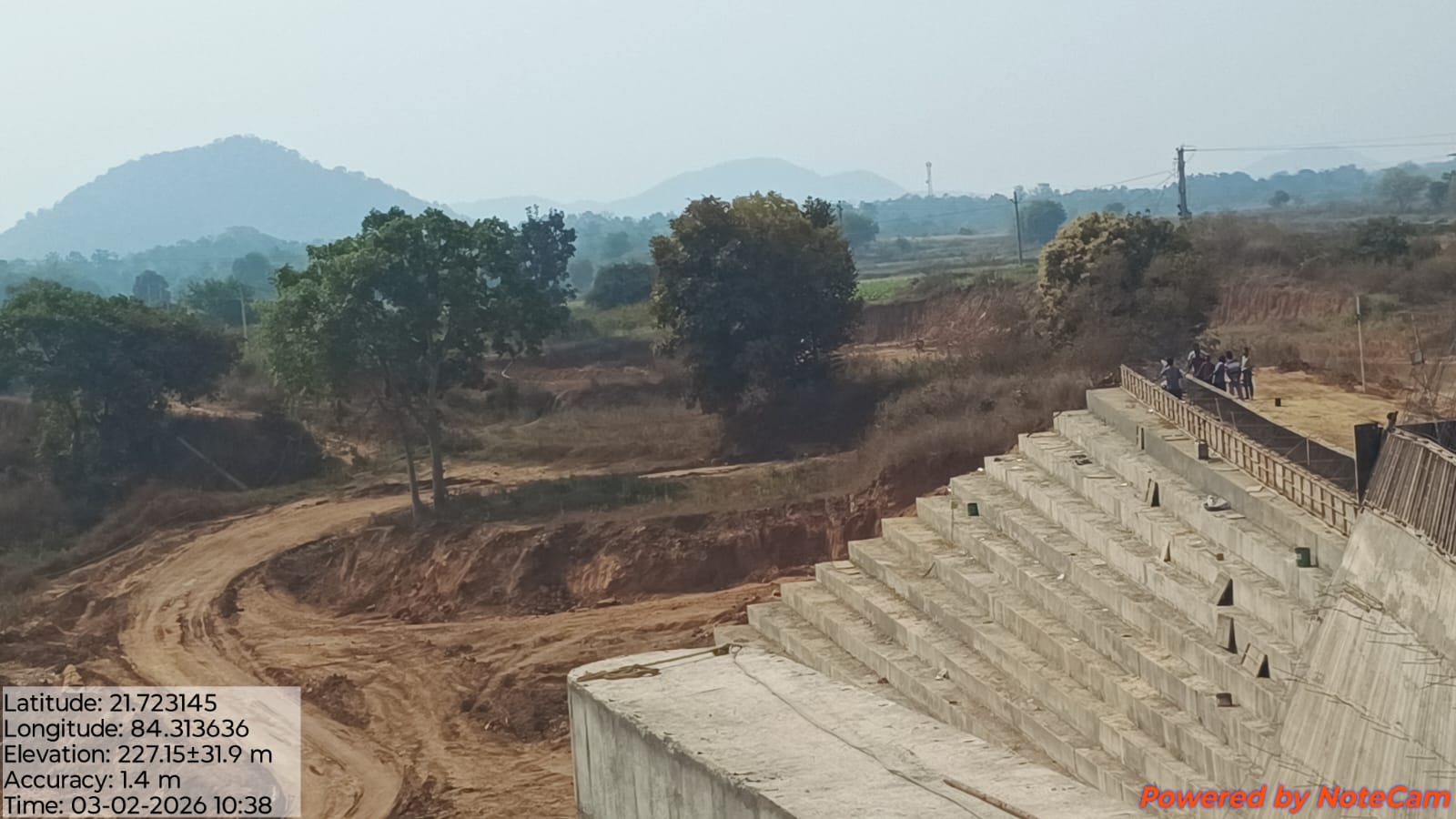

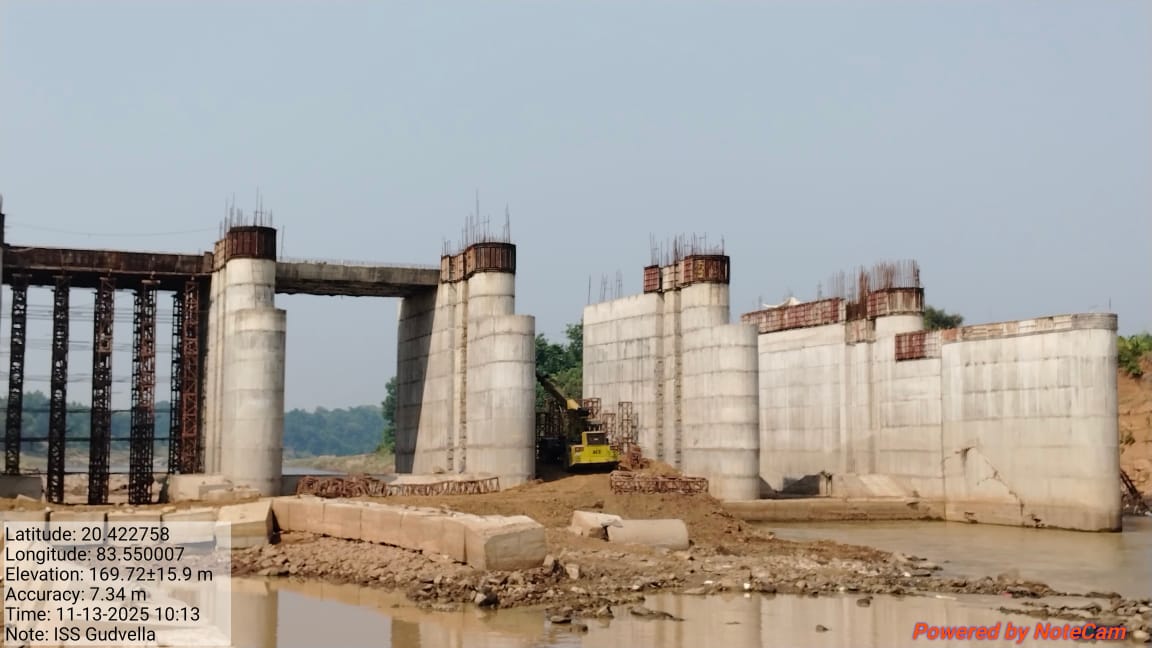

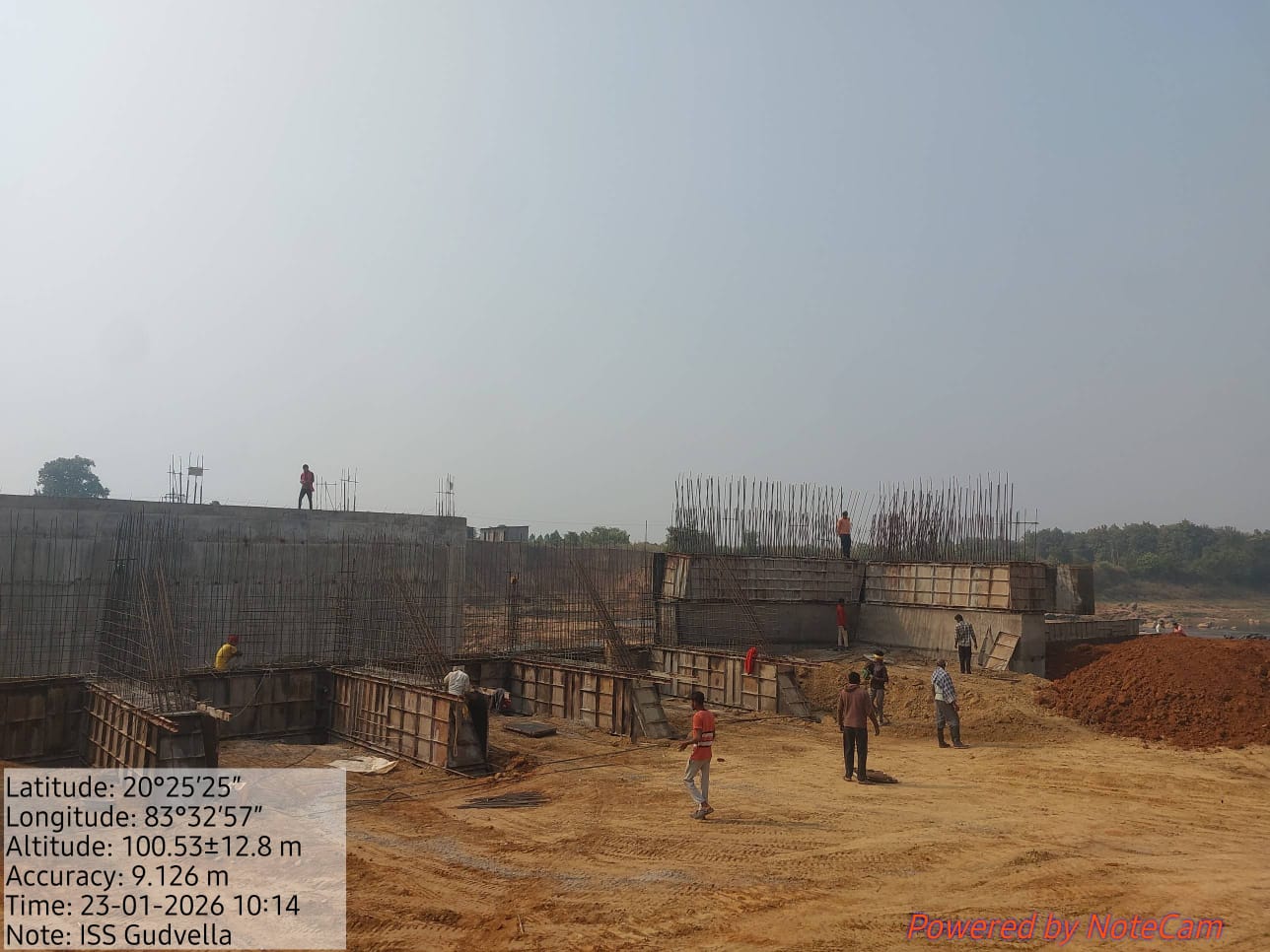

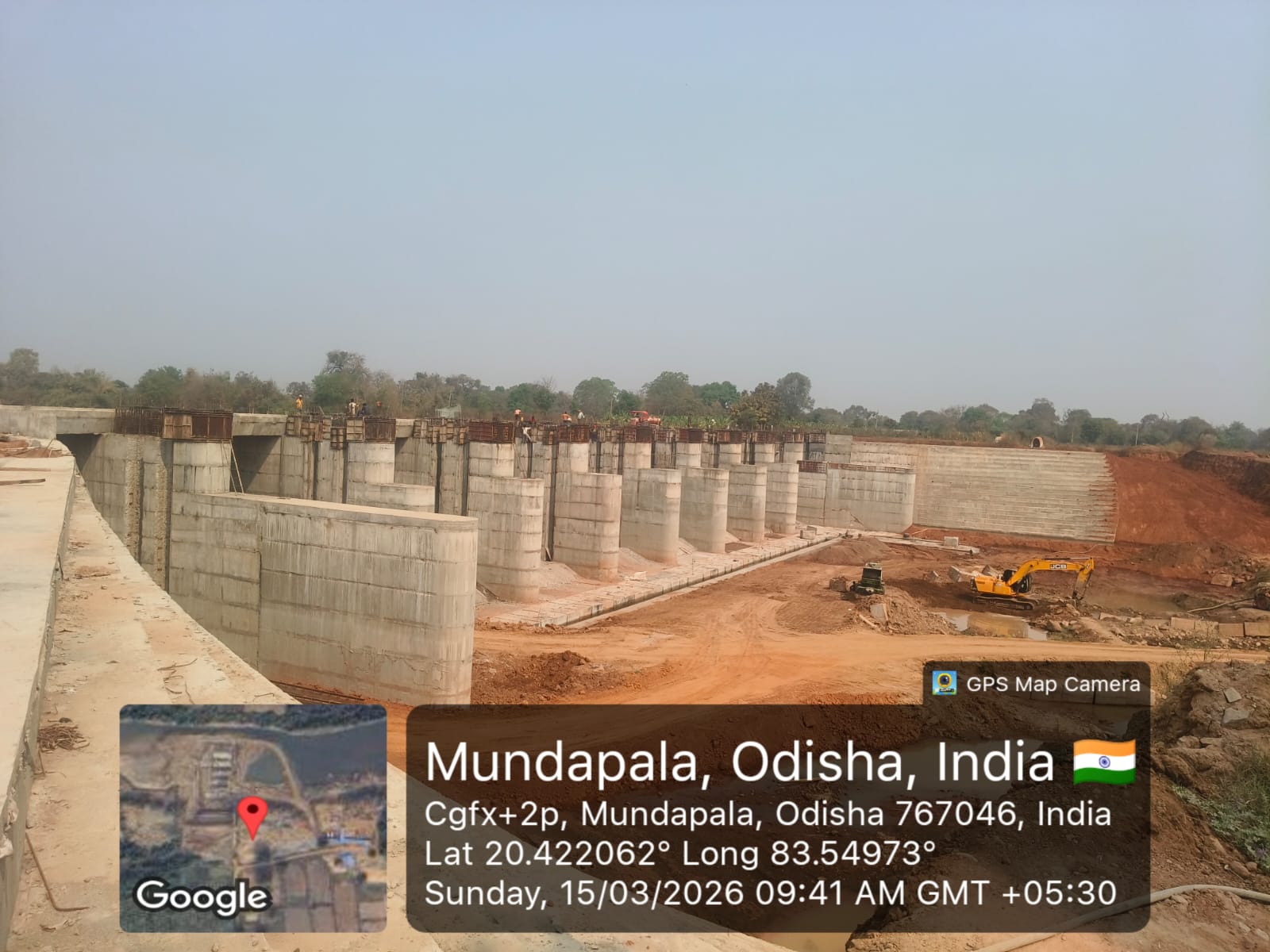

D/S view of ISS Gudvella on 23.09.2026

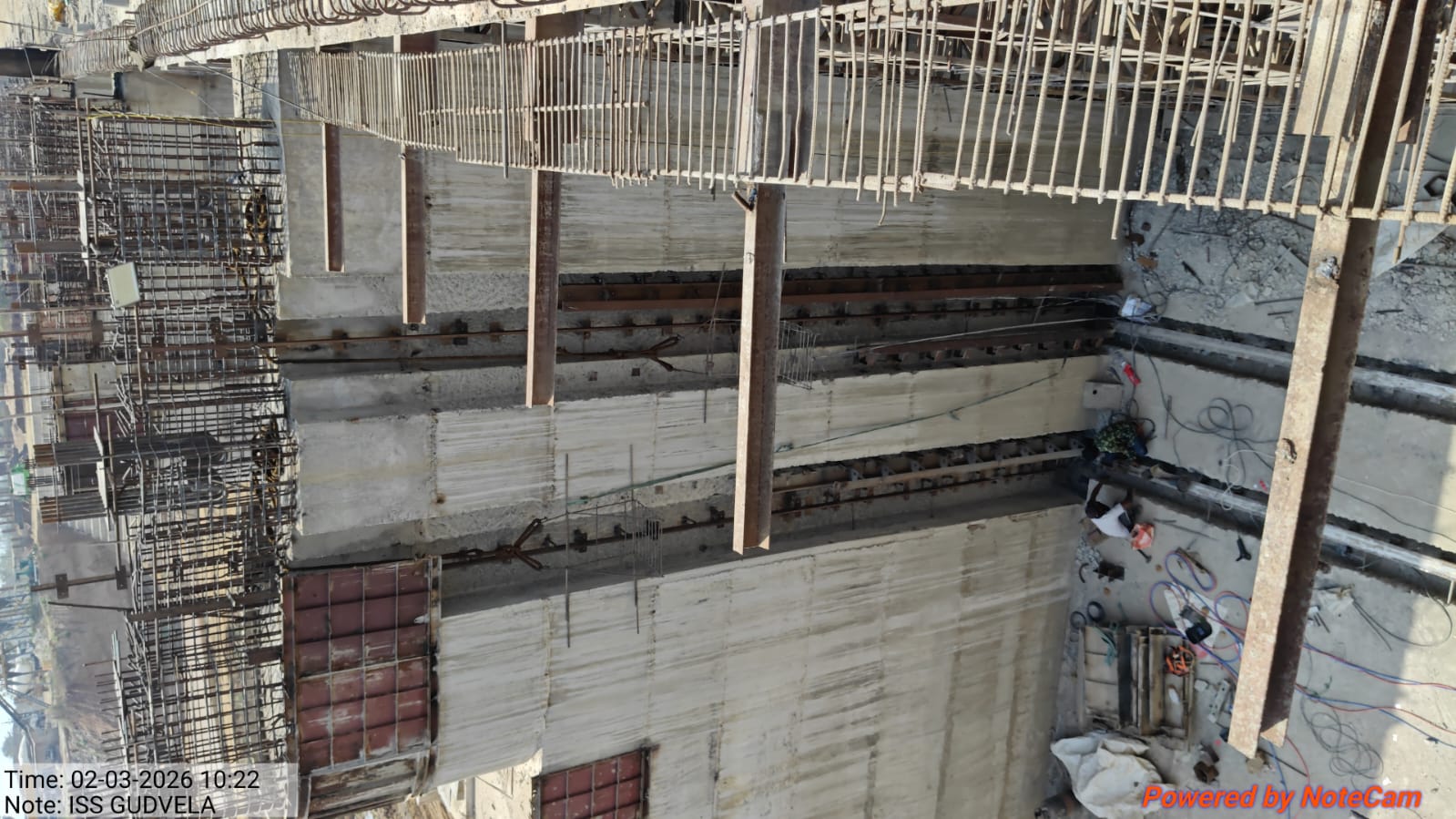

14/100

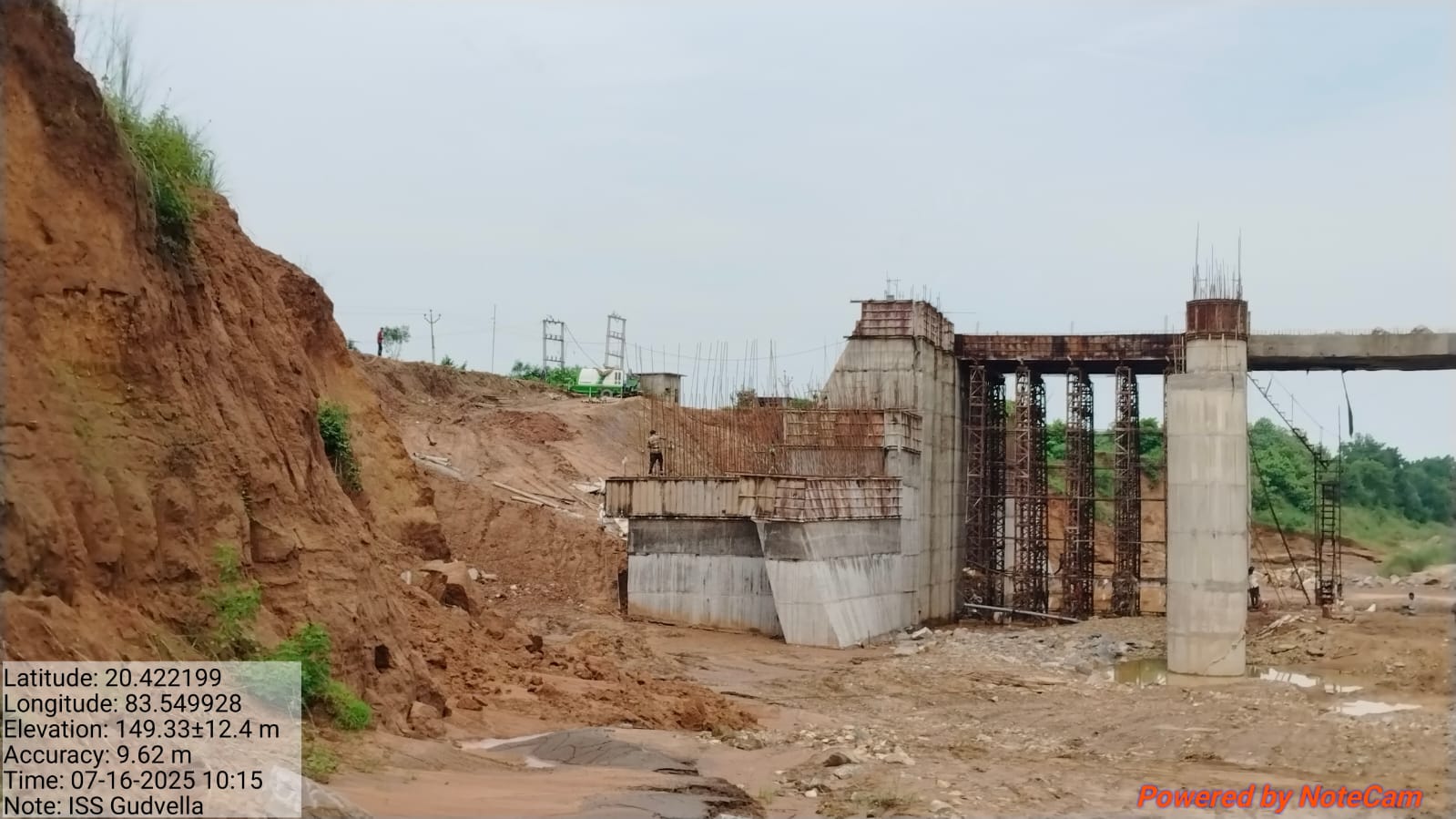

Instream Storage Structure, Gudvella

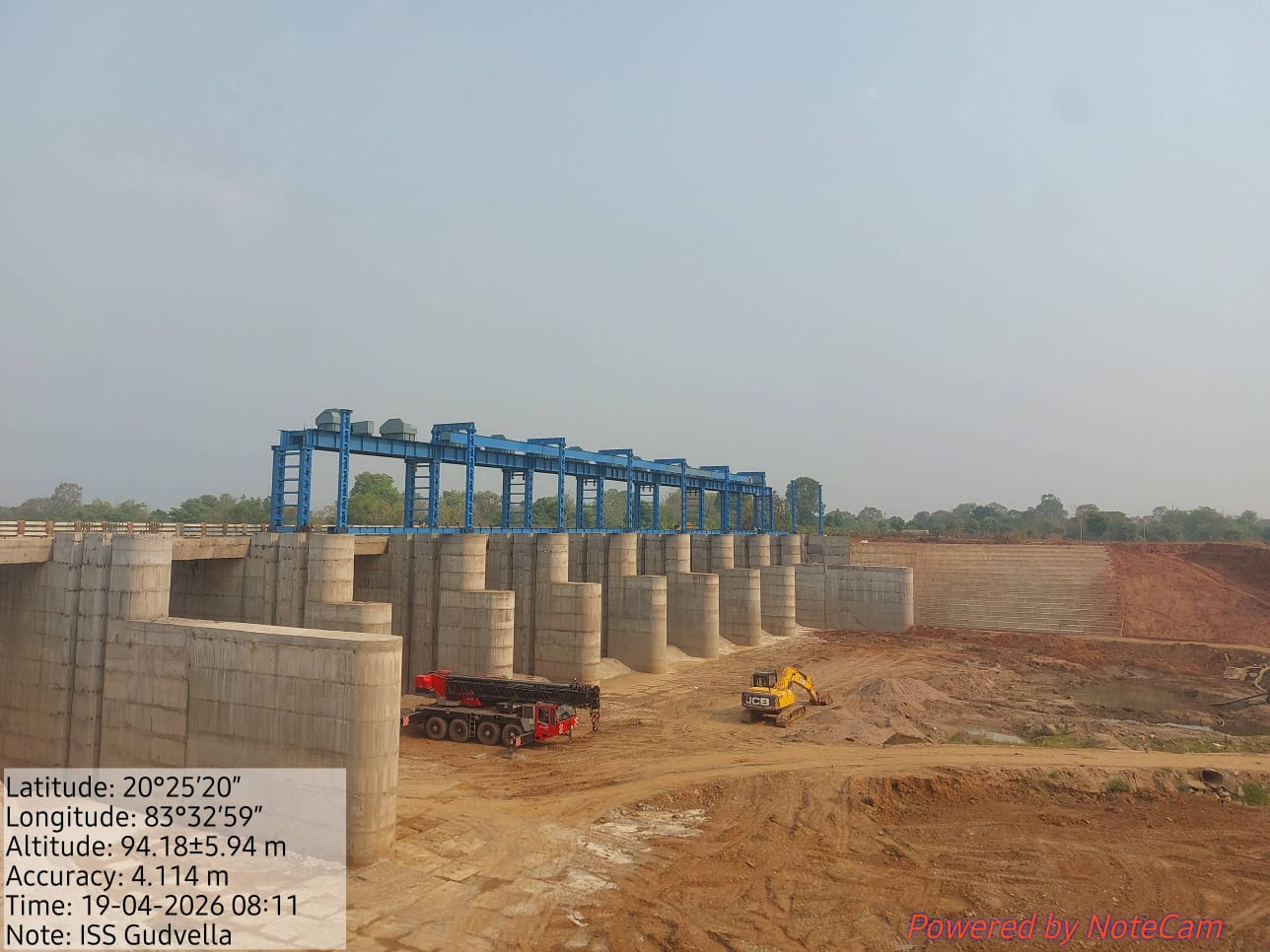

U/S view of ISS Gudvella on 23.09.2026
15/100

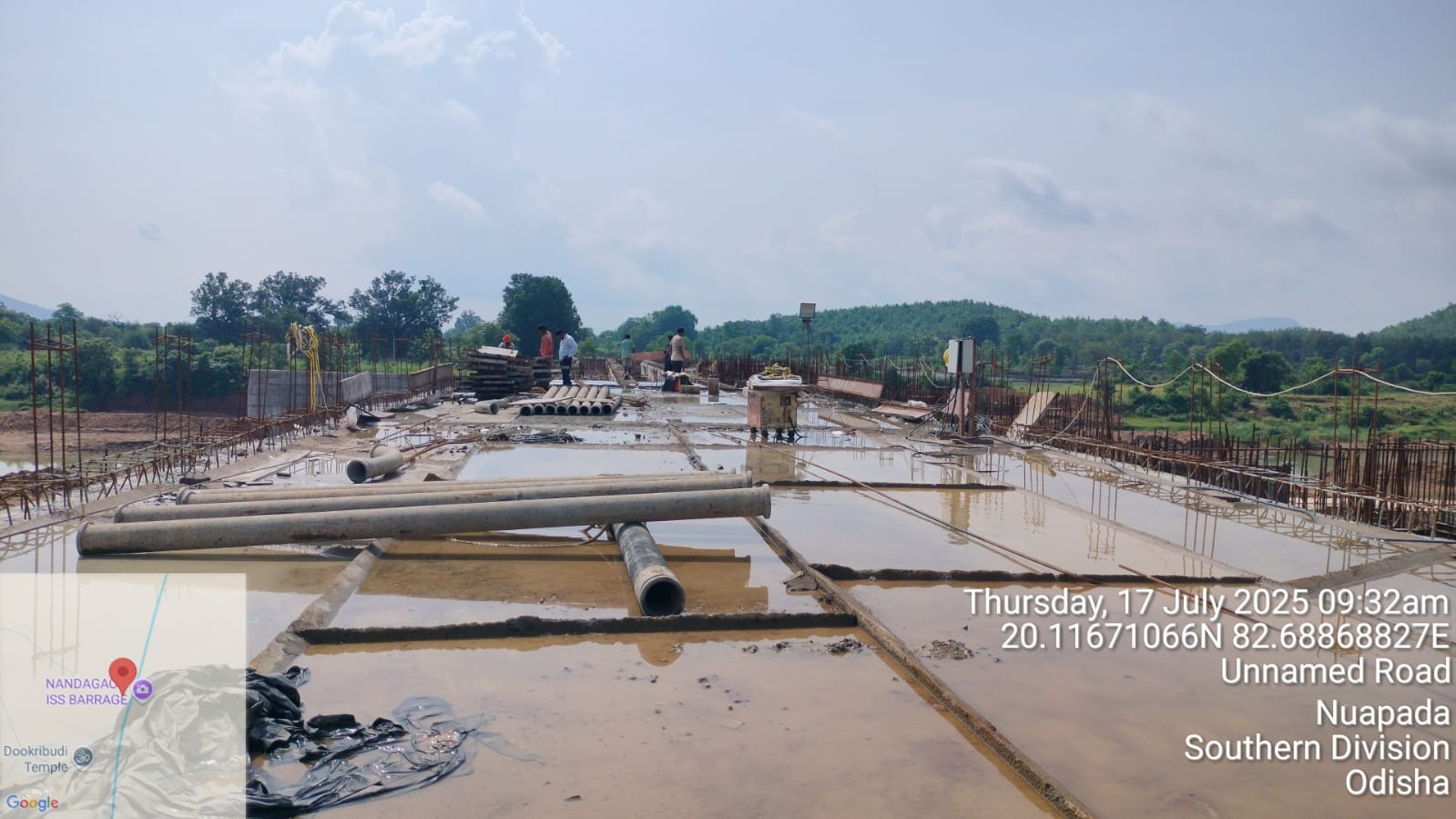

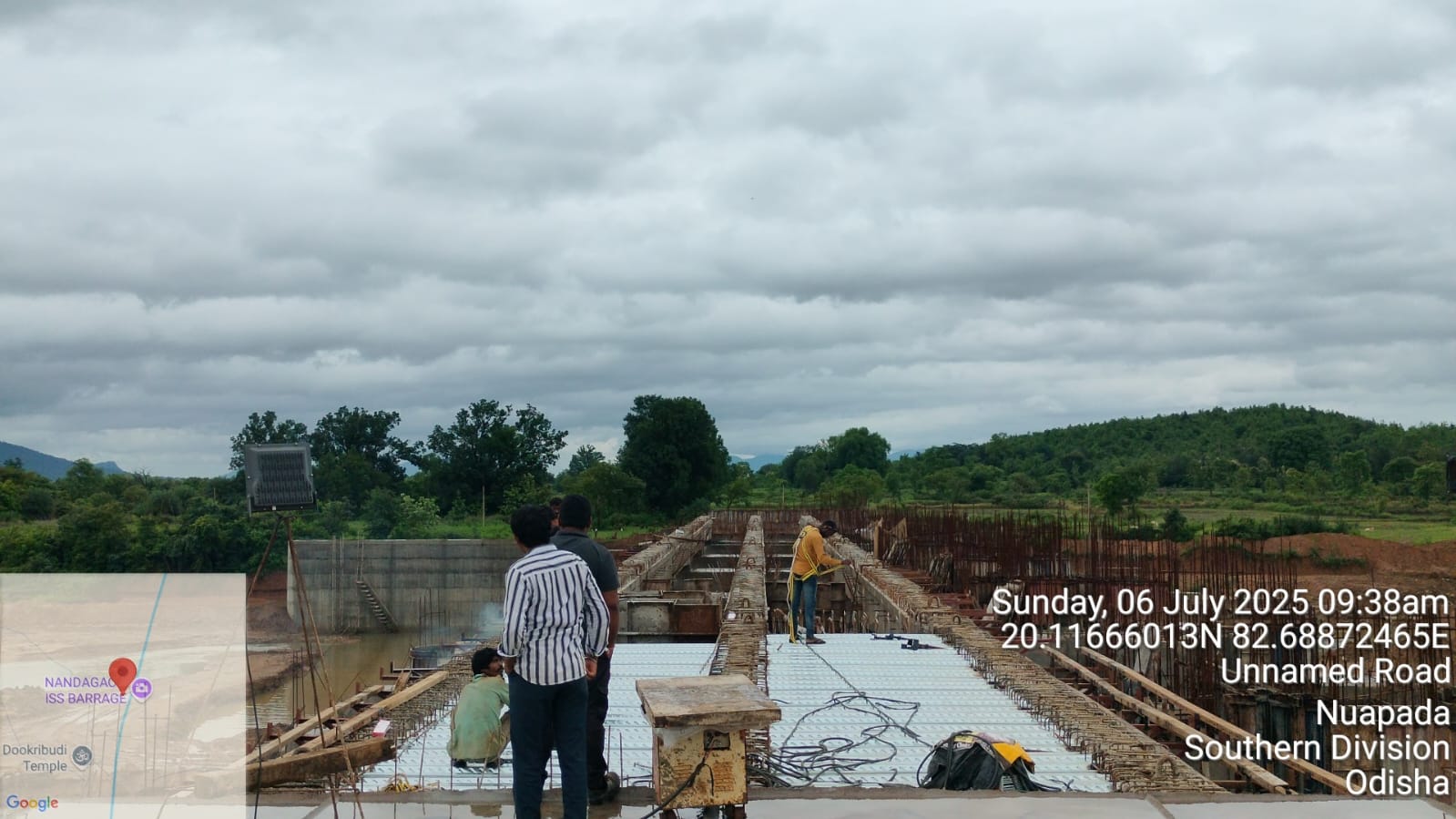

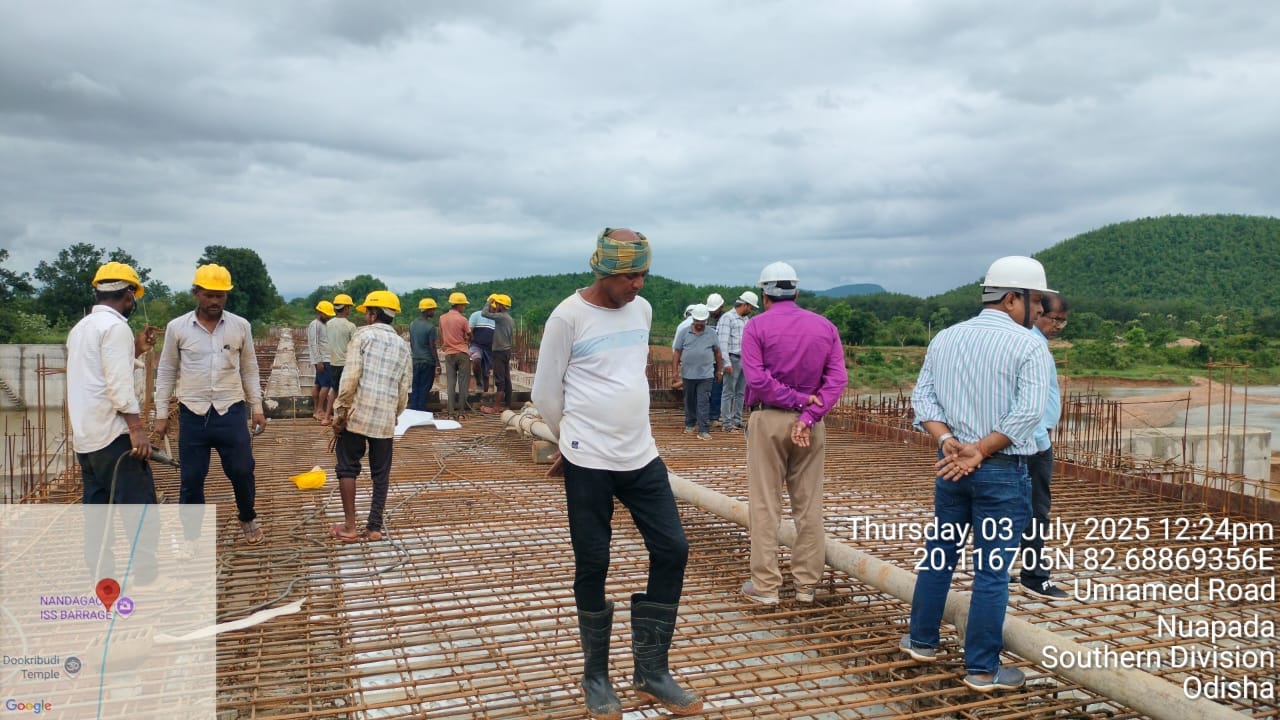

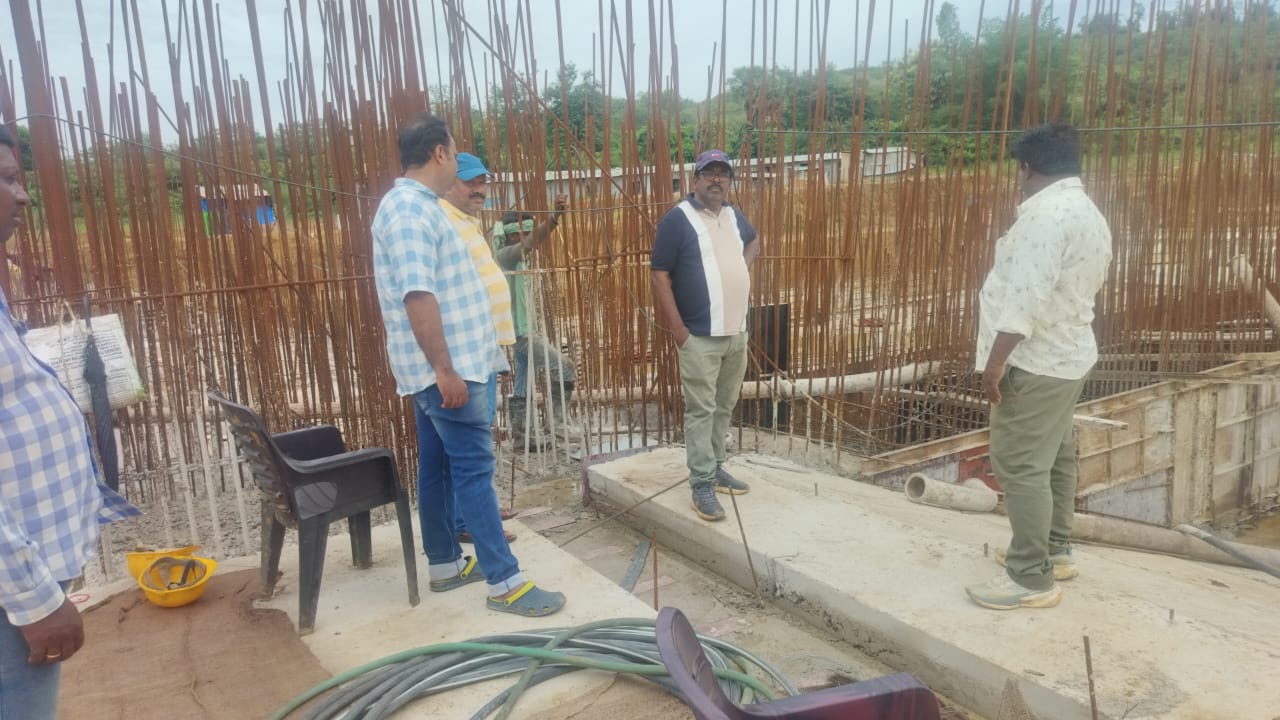

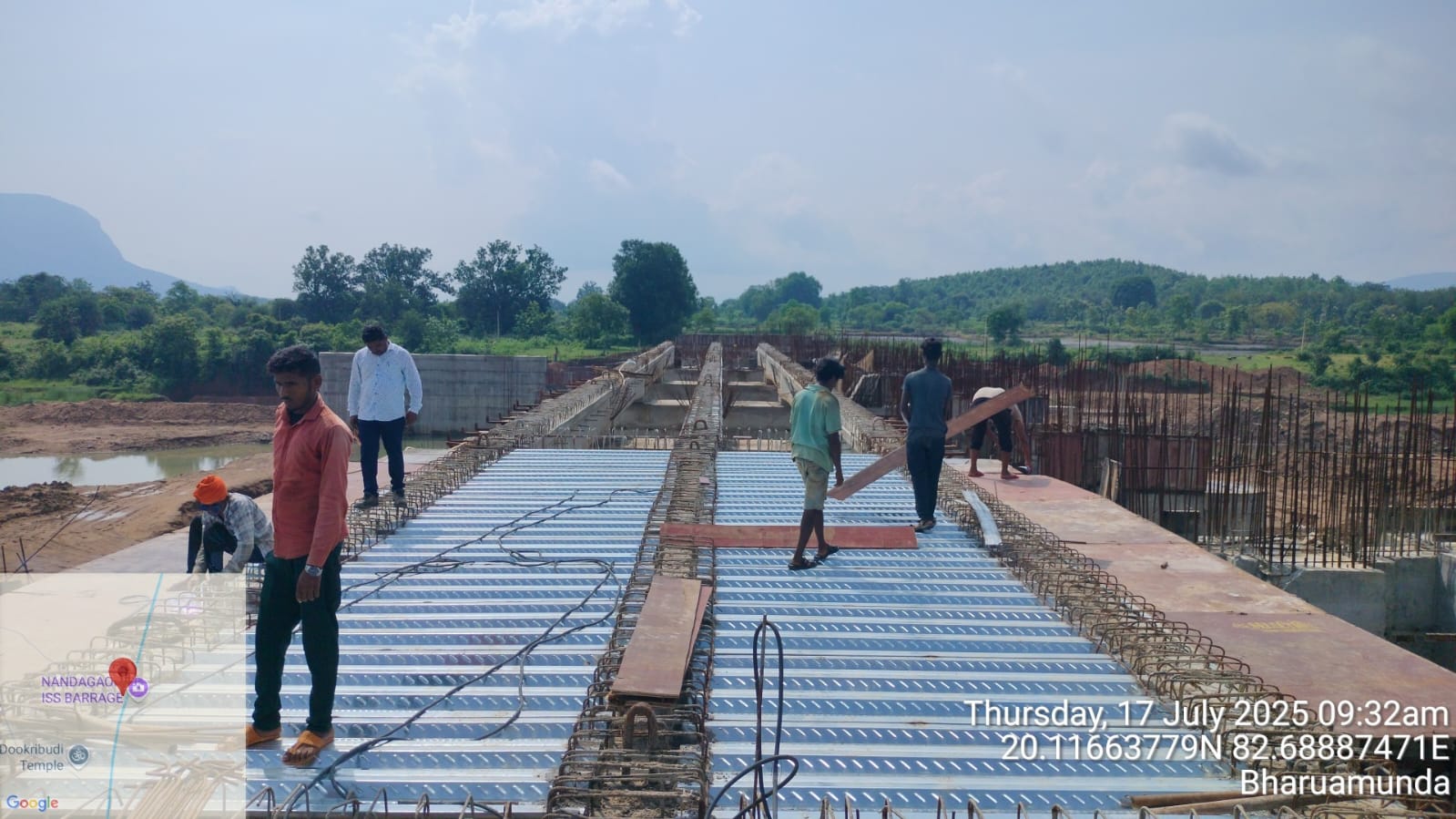

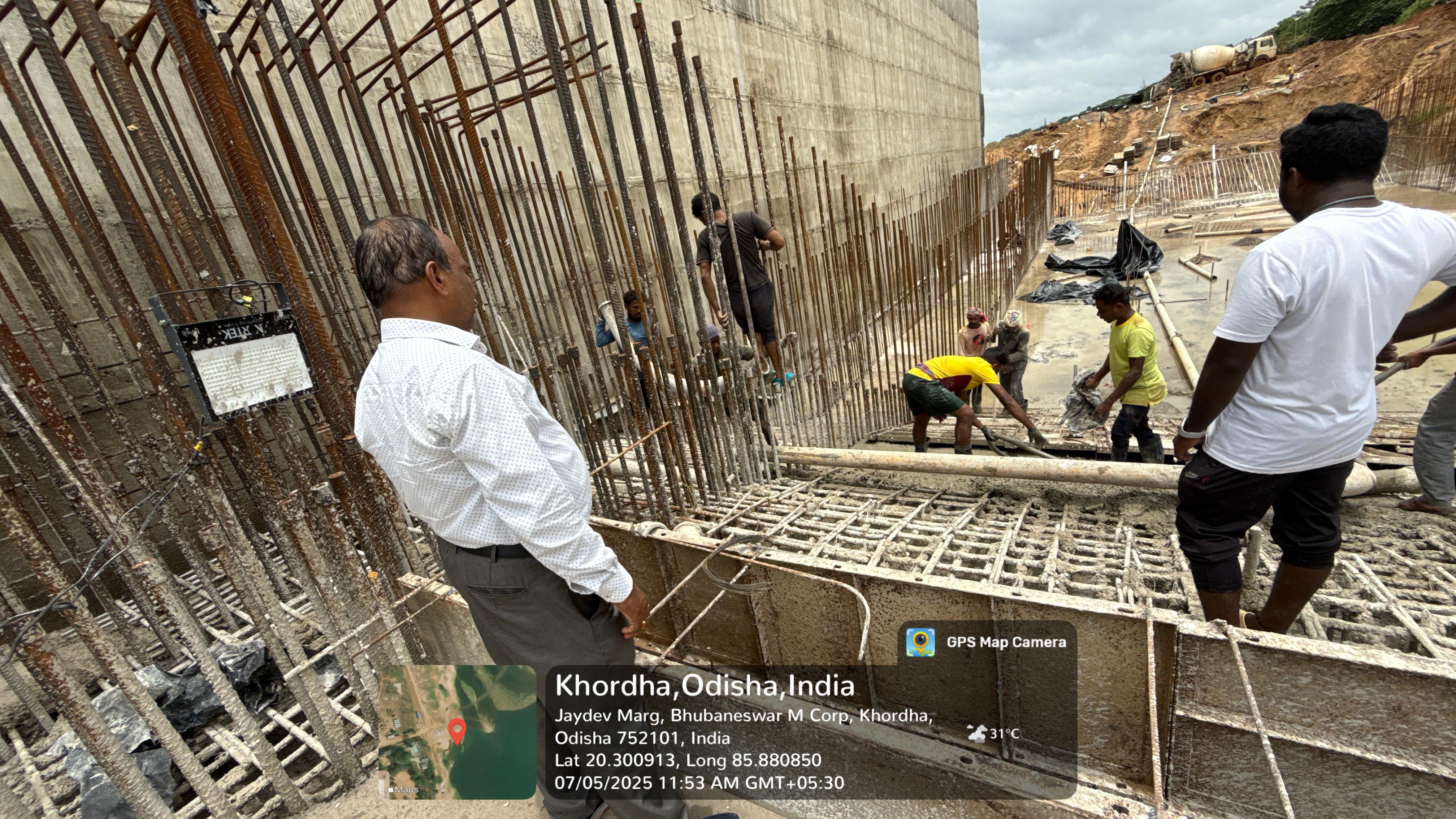

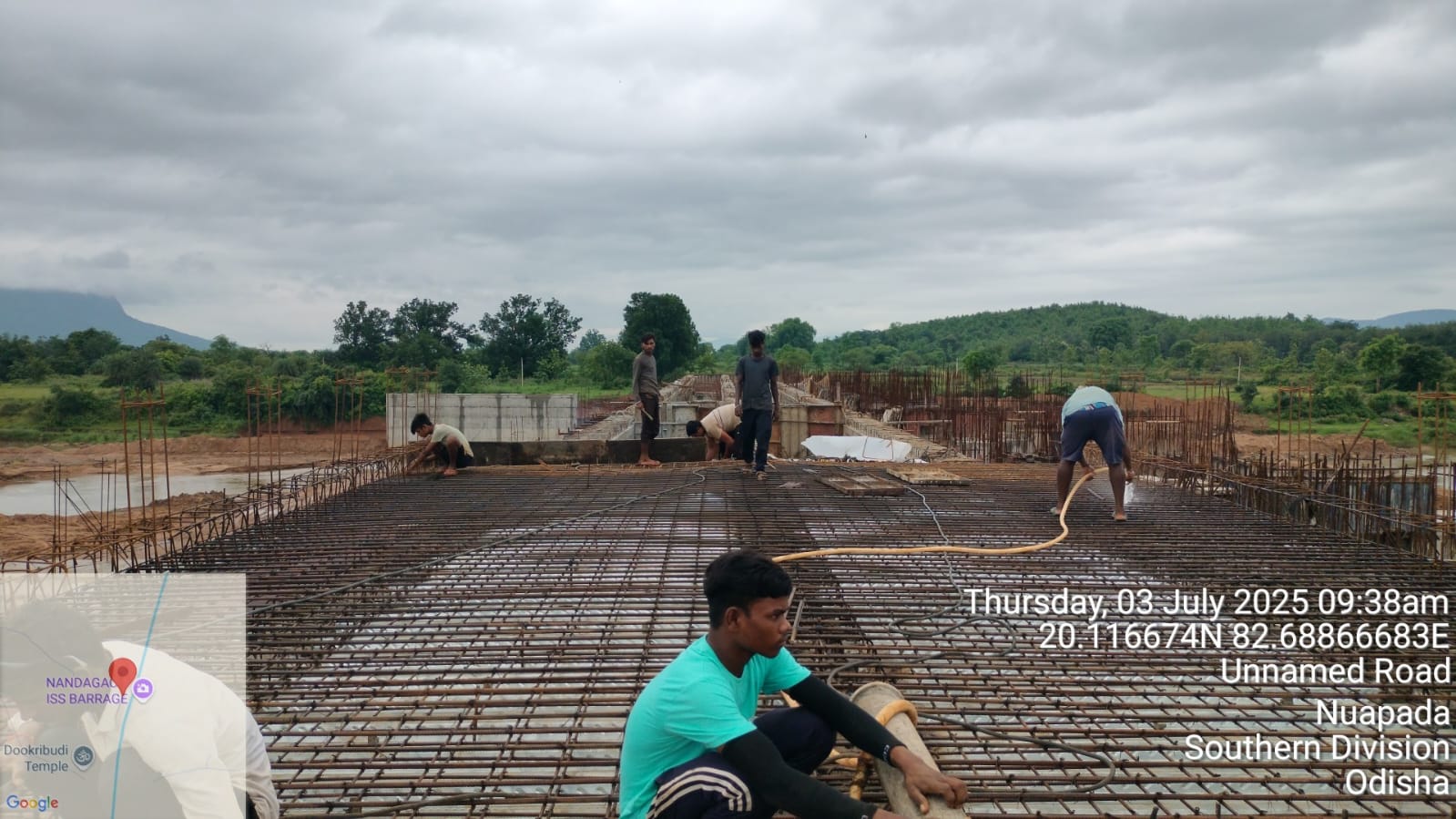

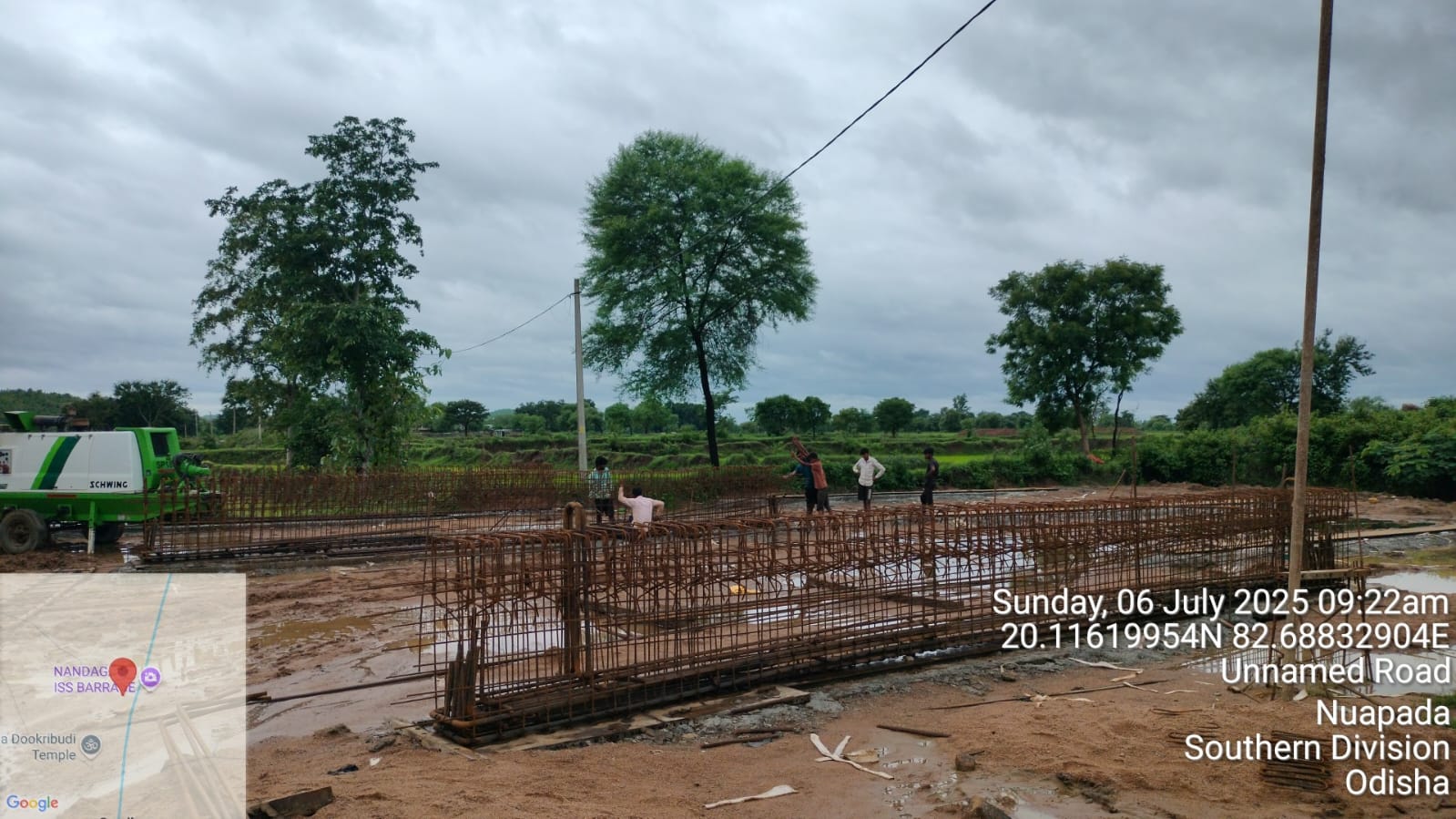

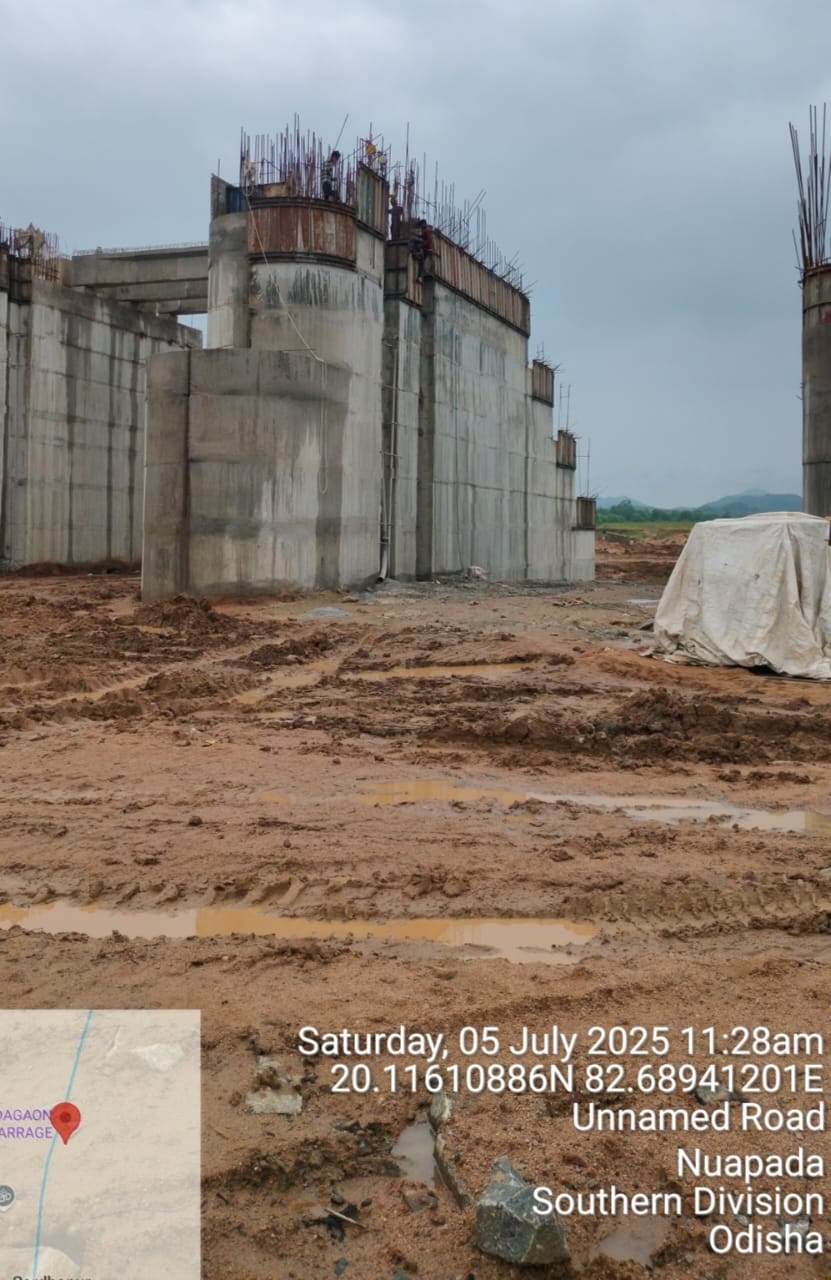

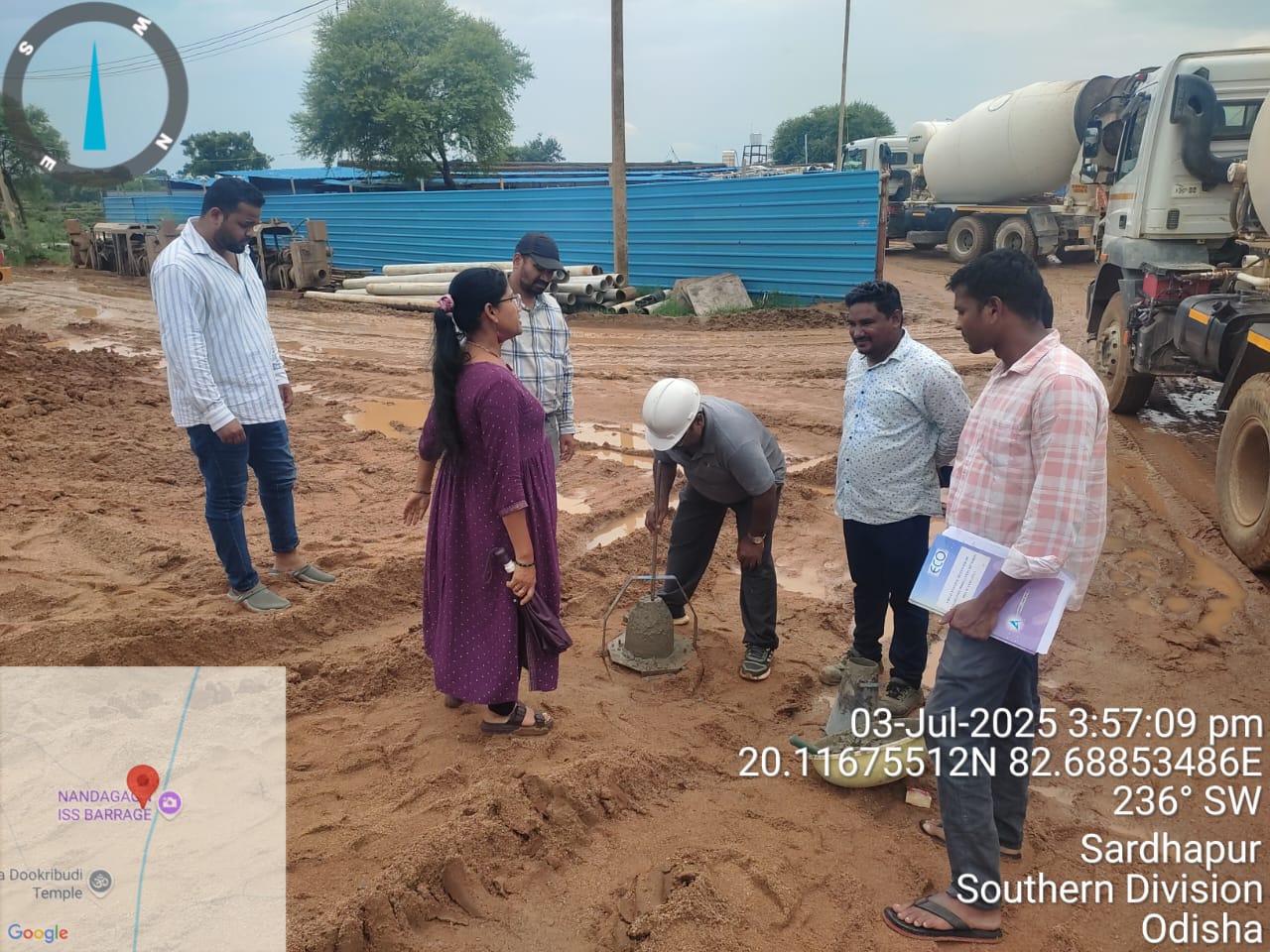

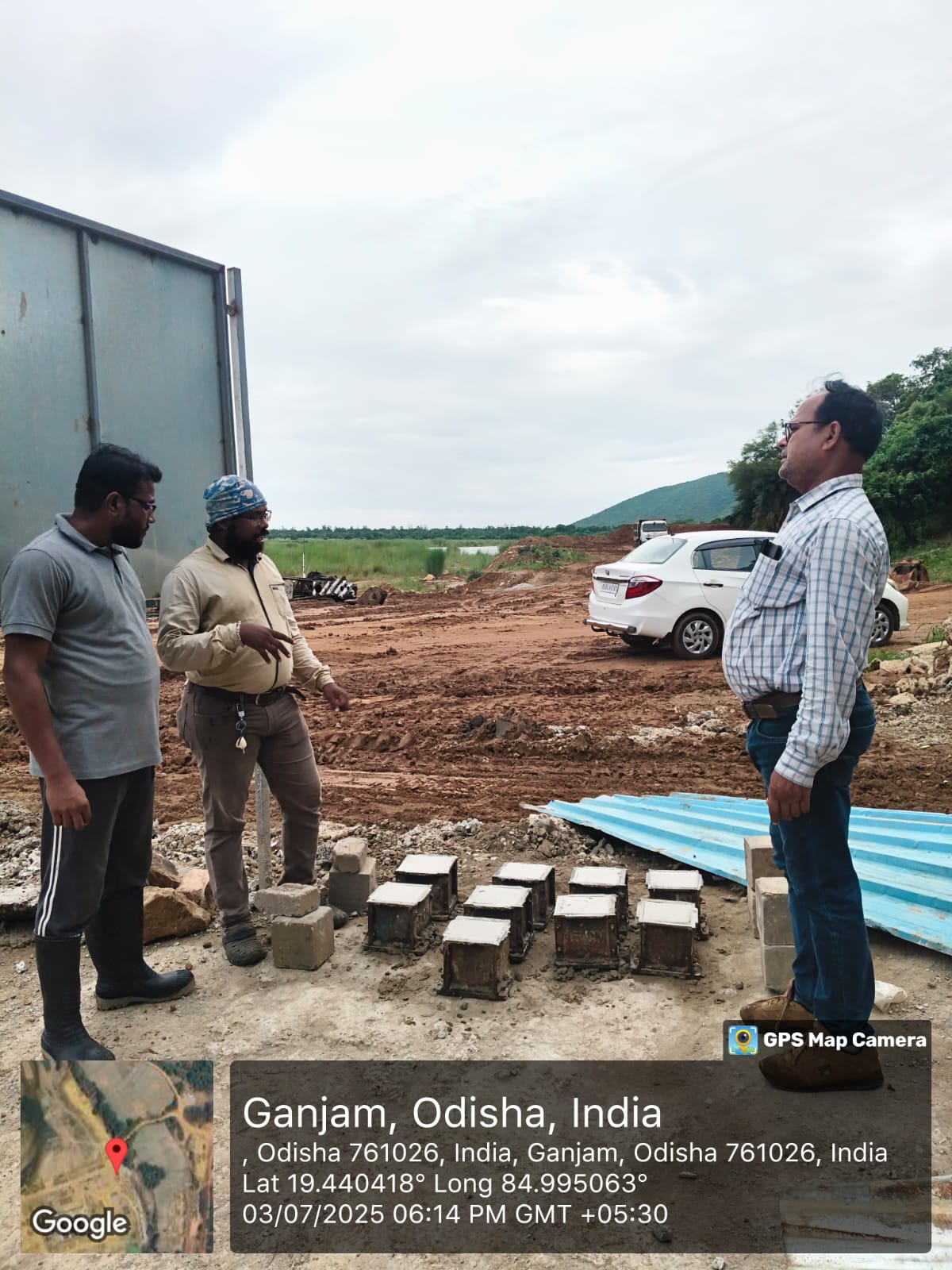

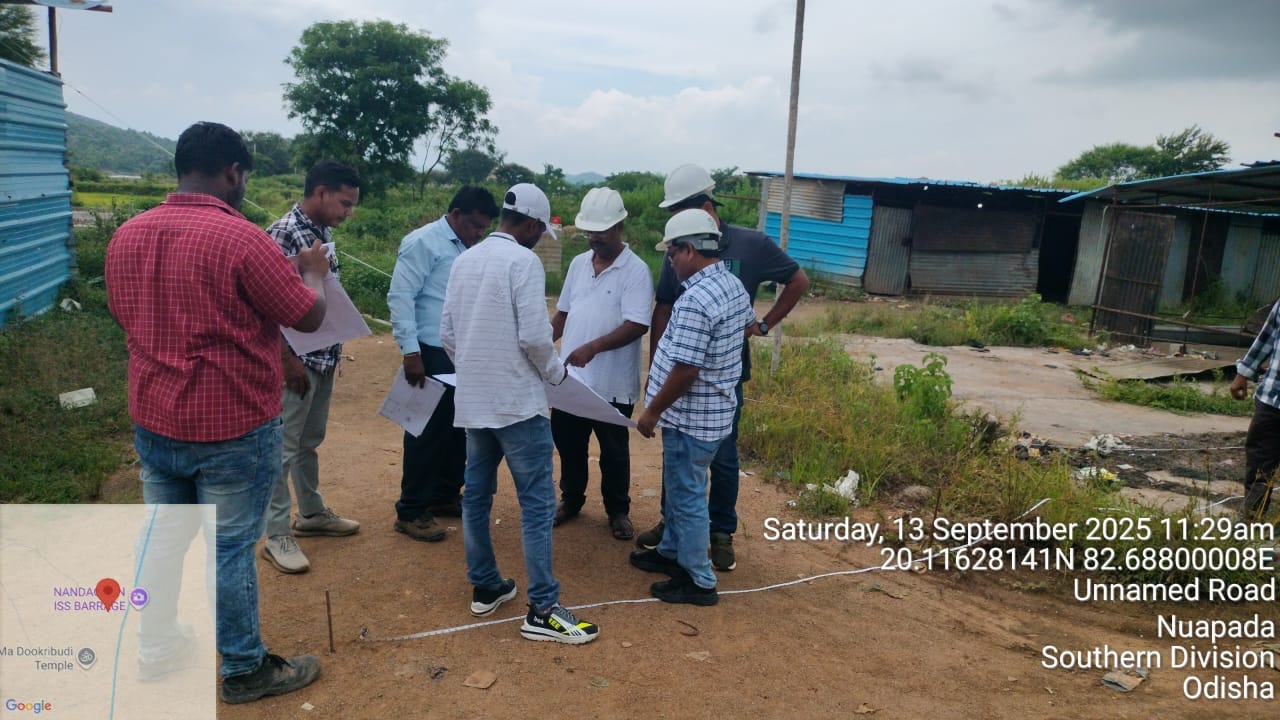

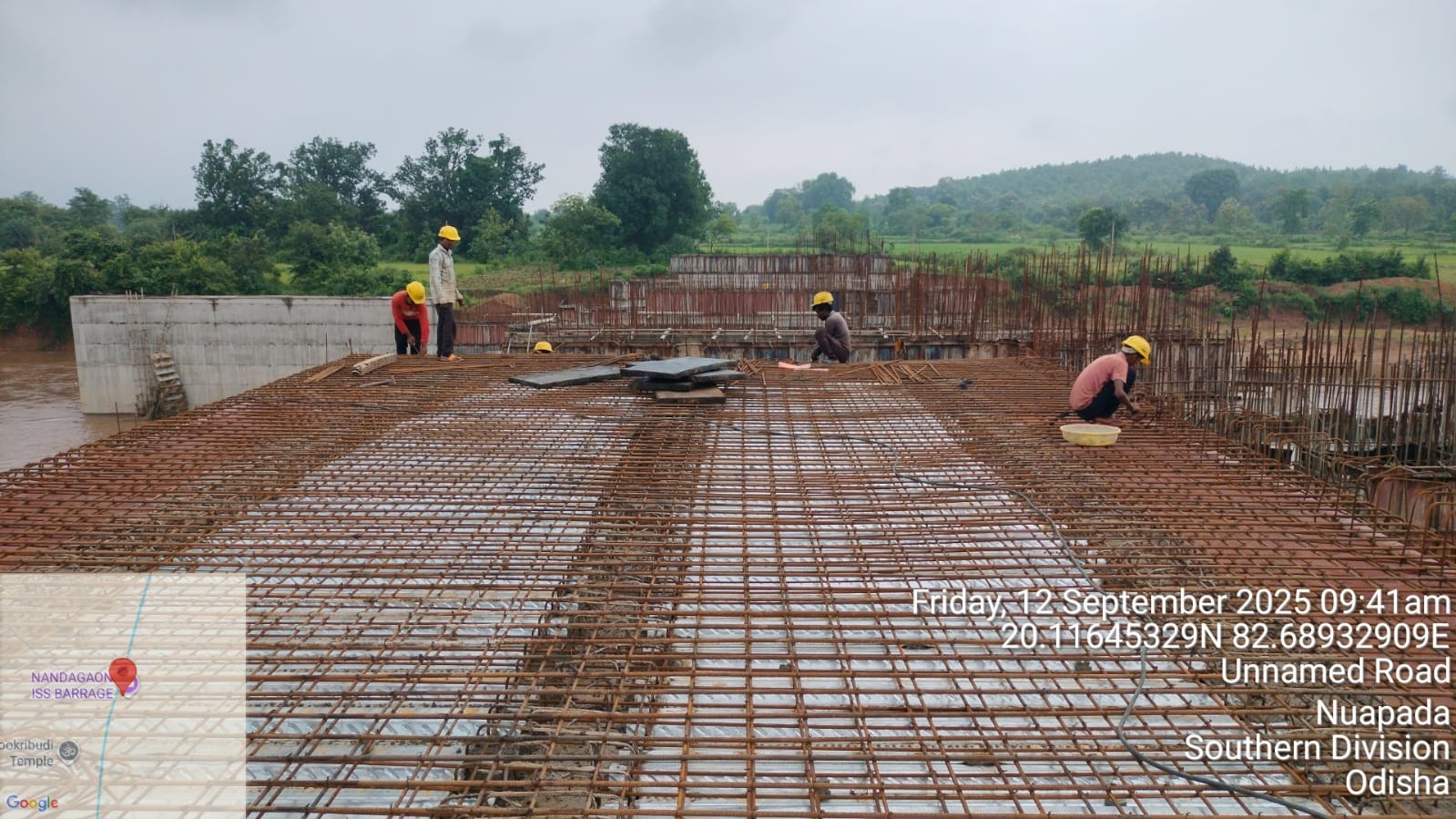

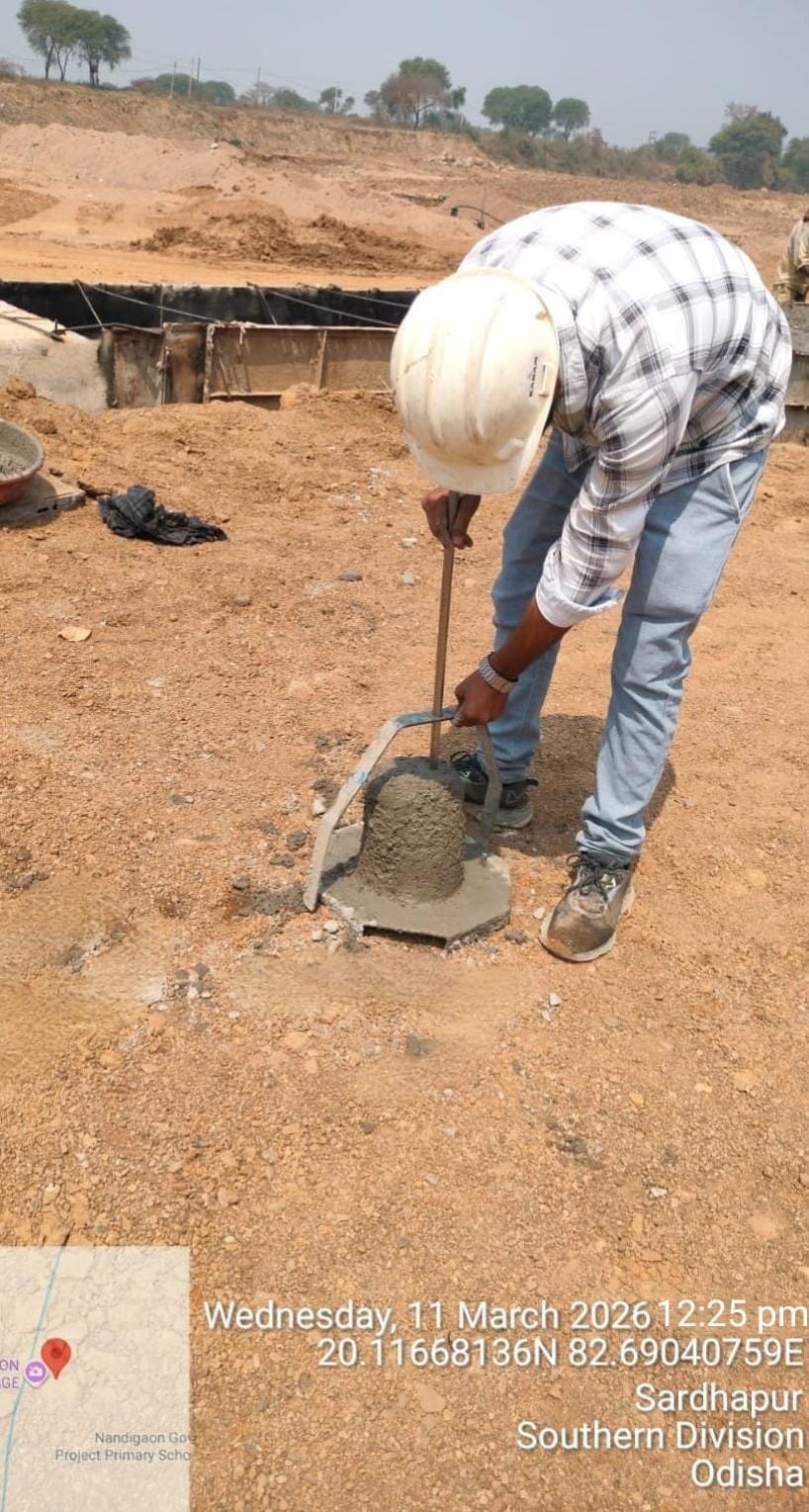

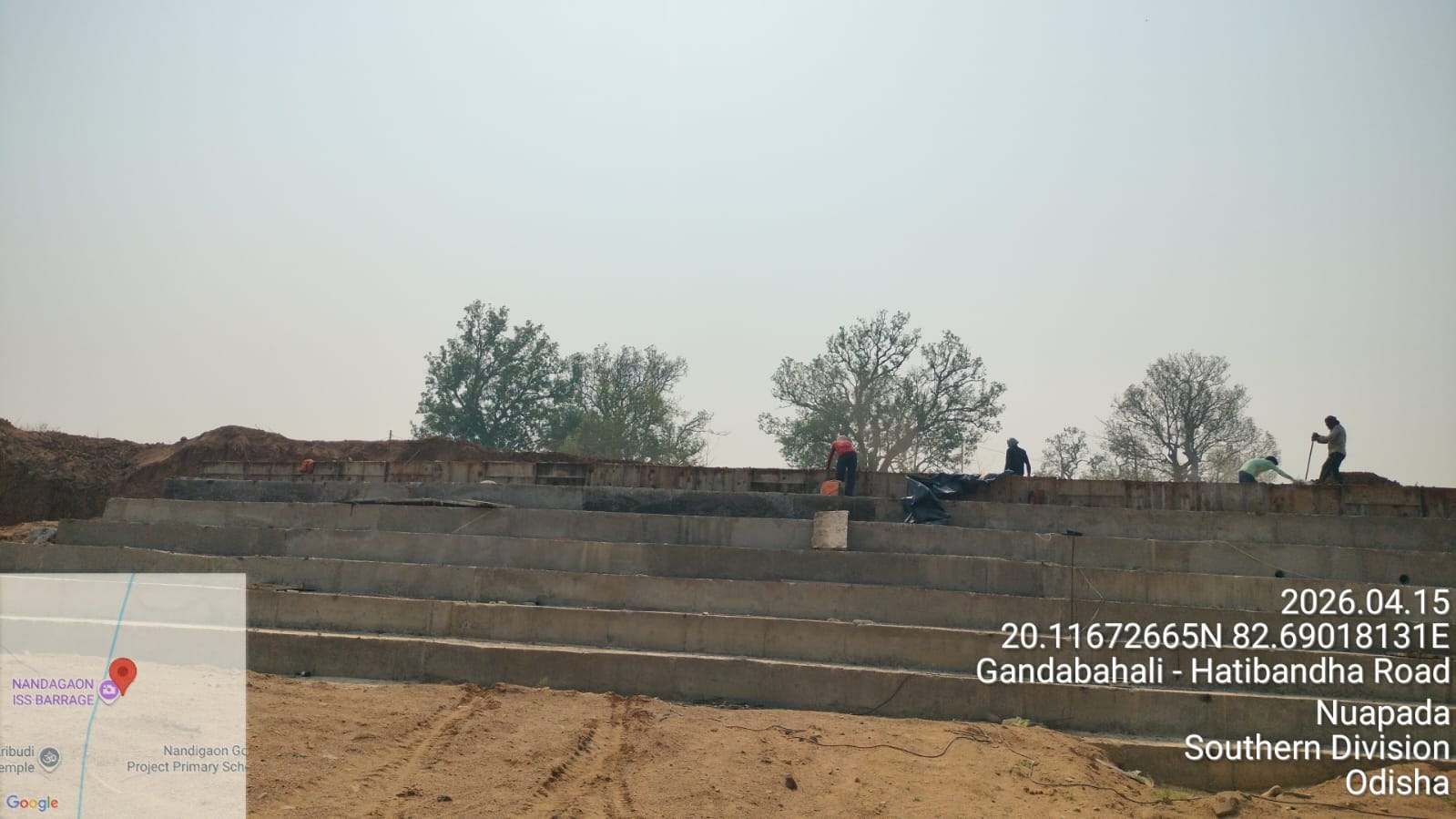

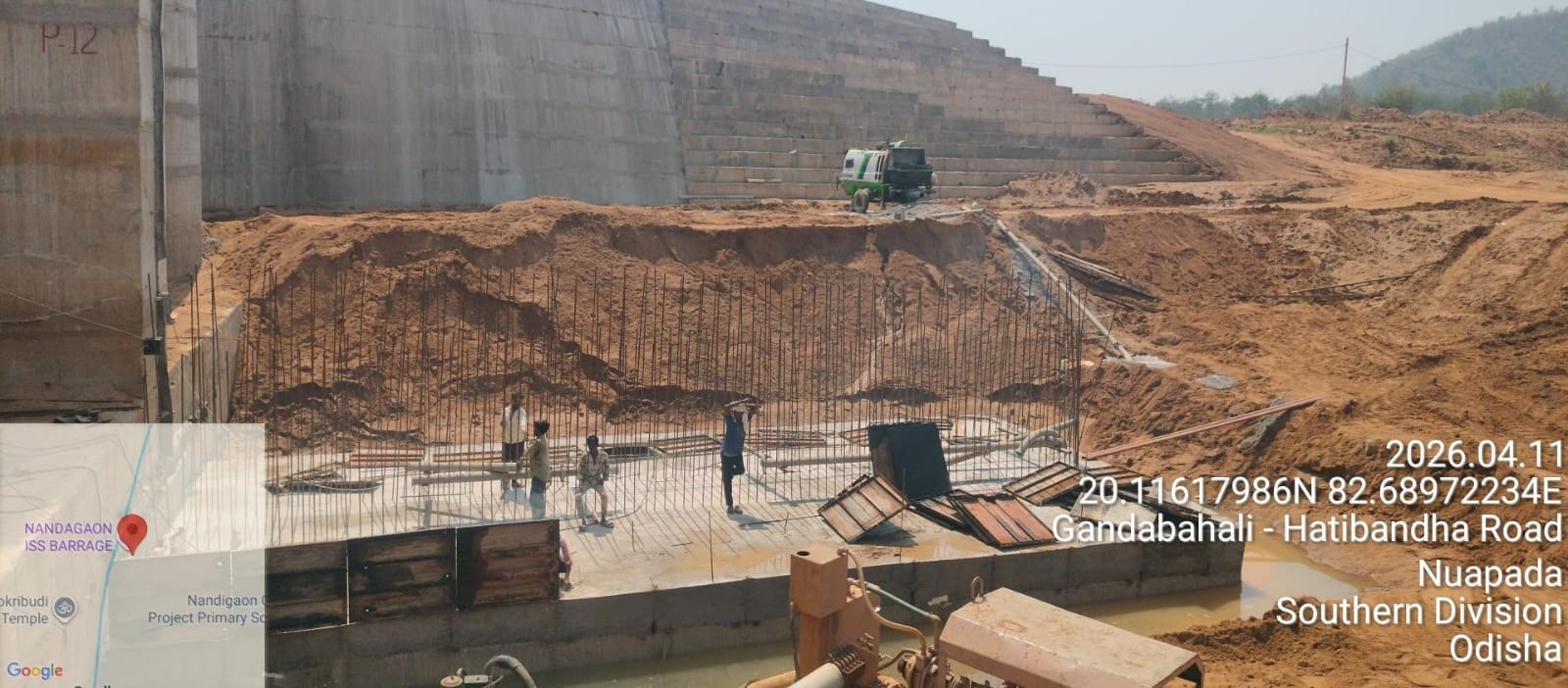

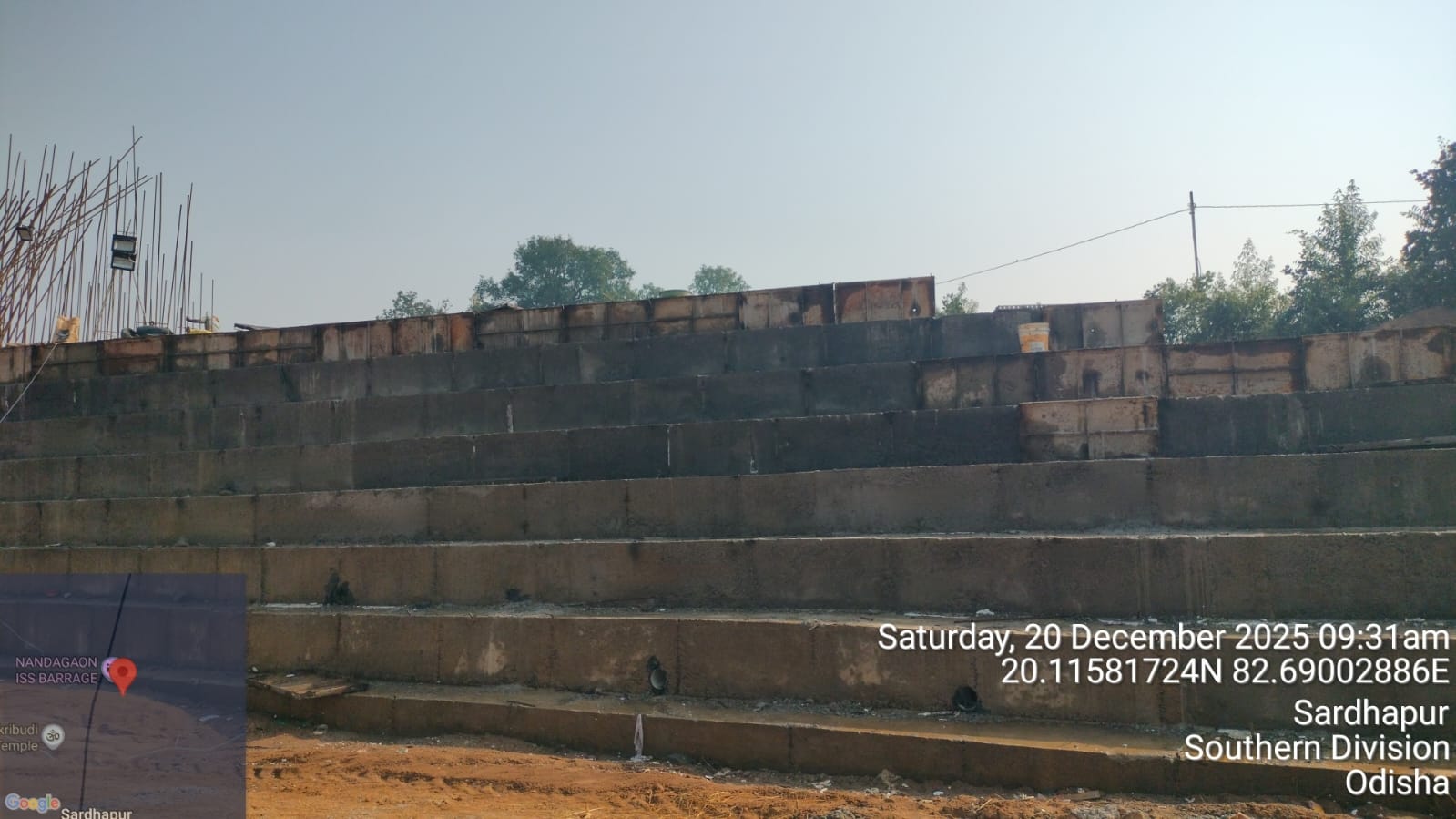

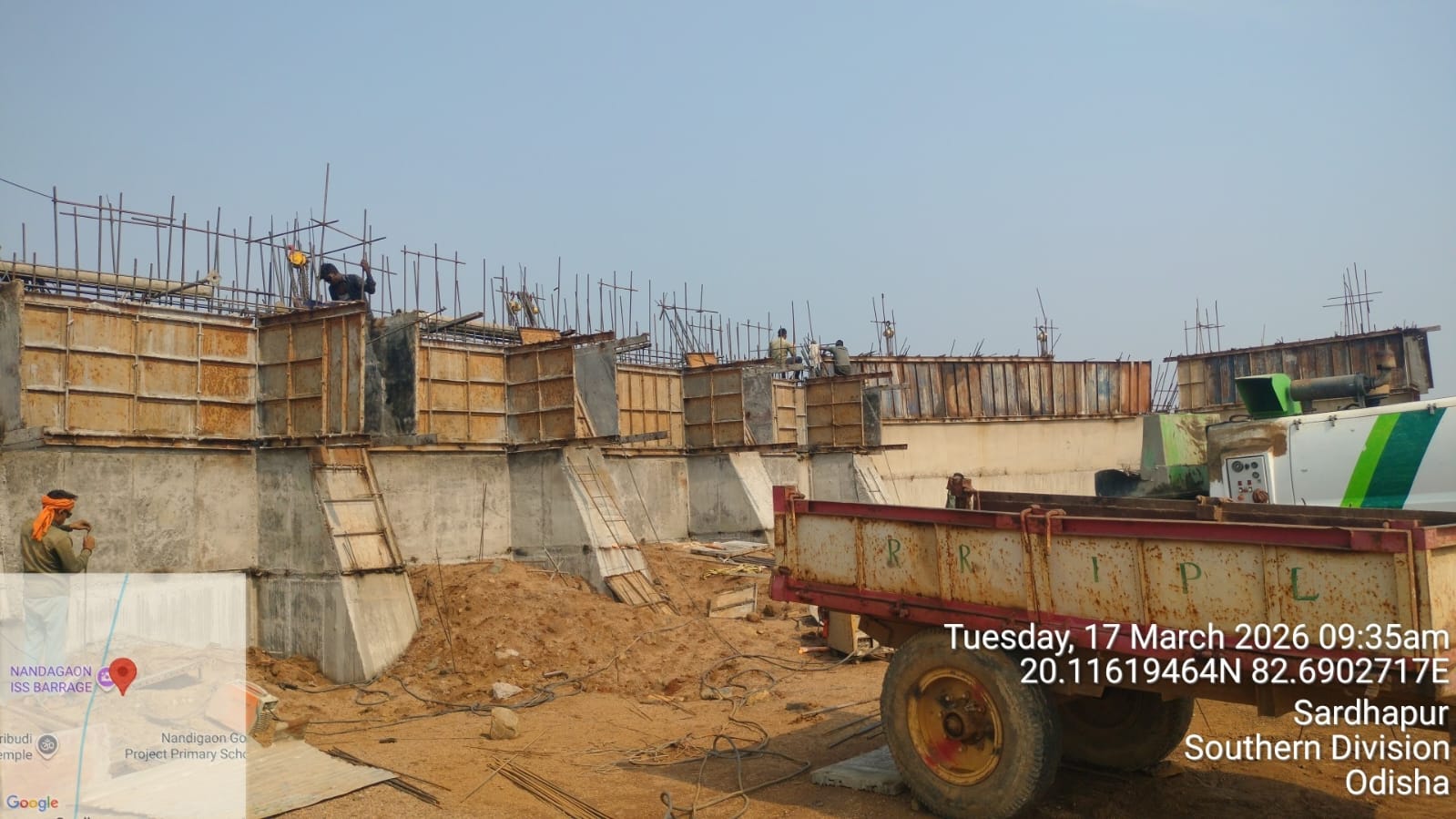

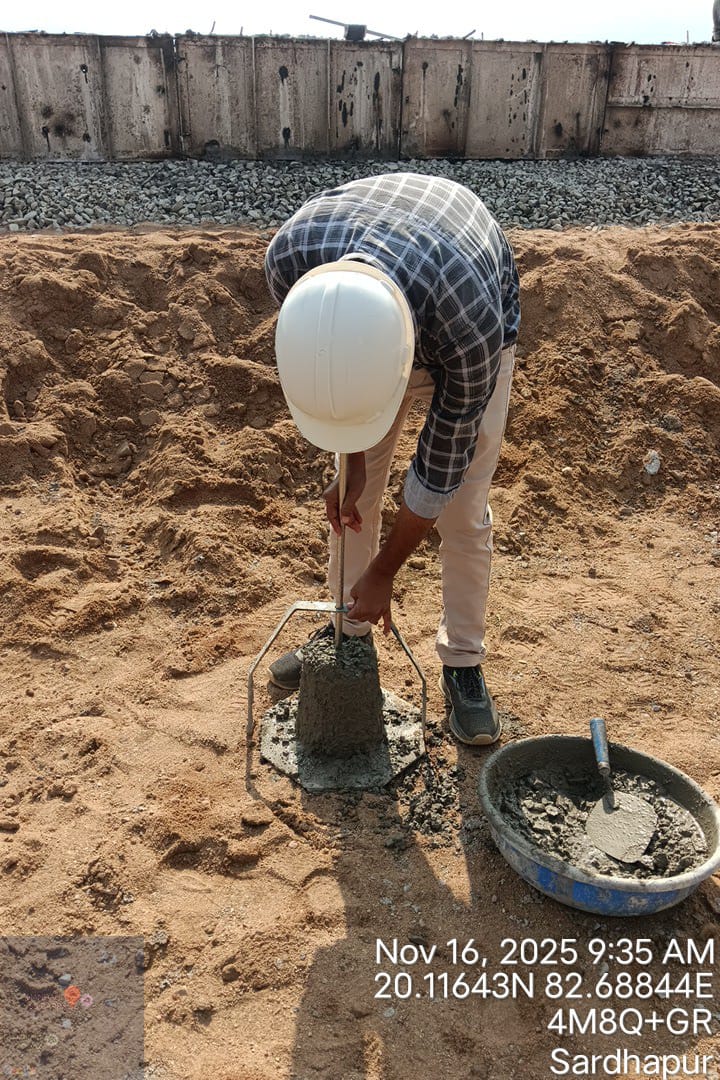

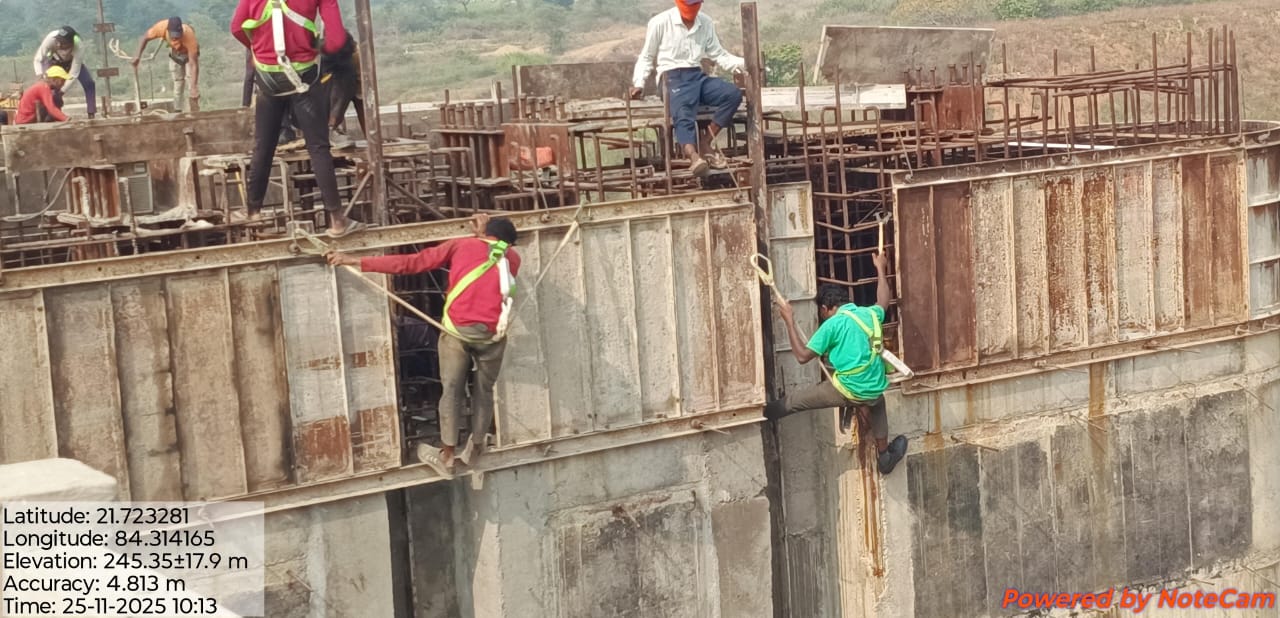

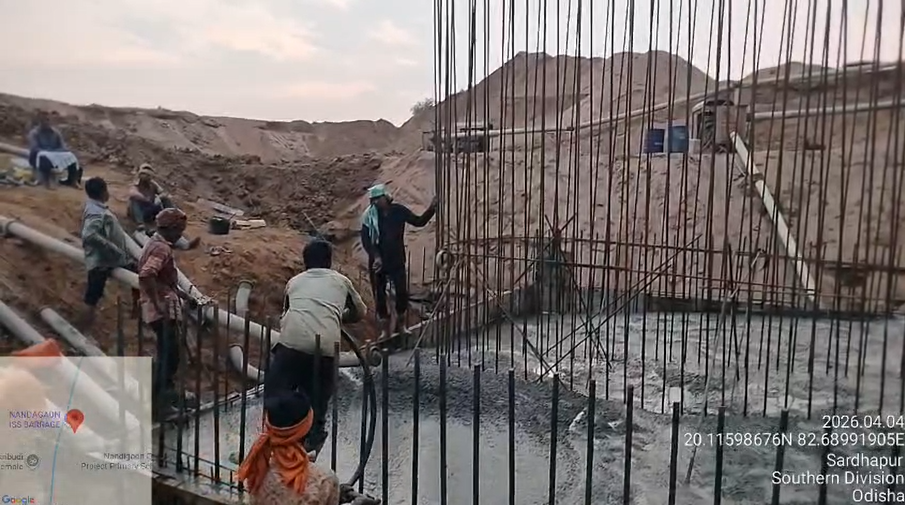

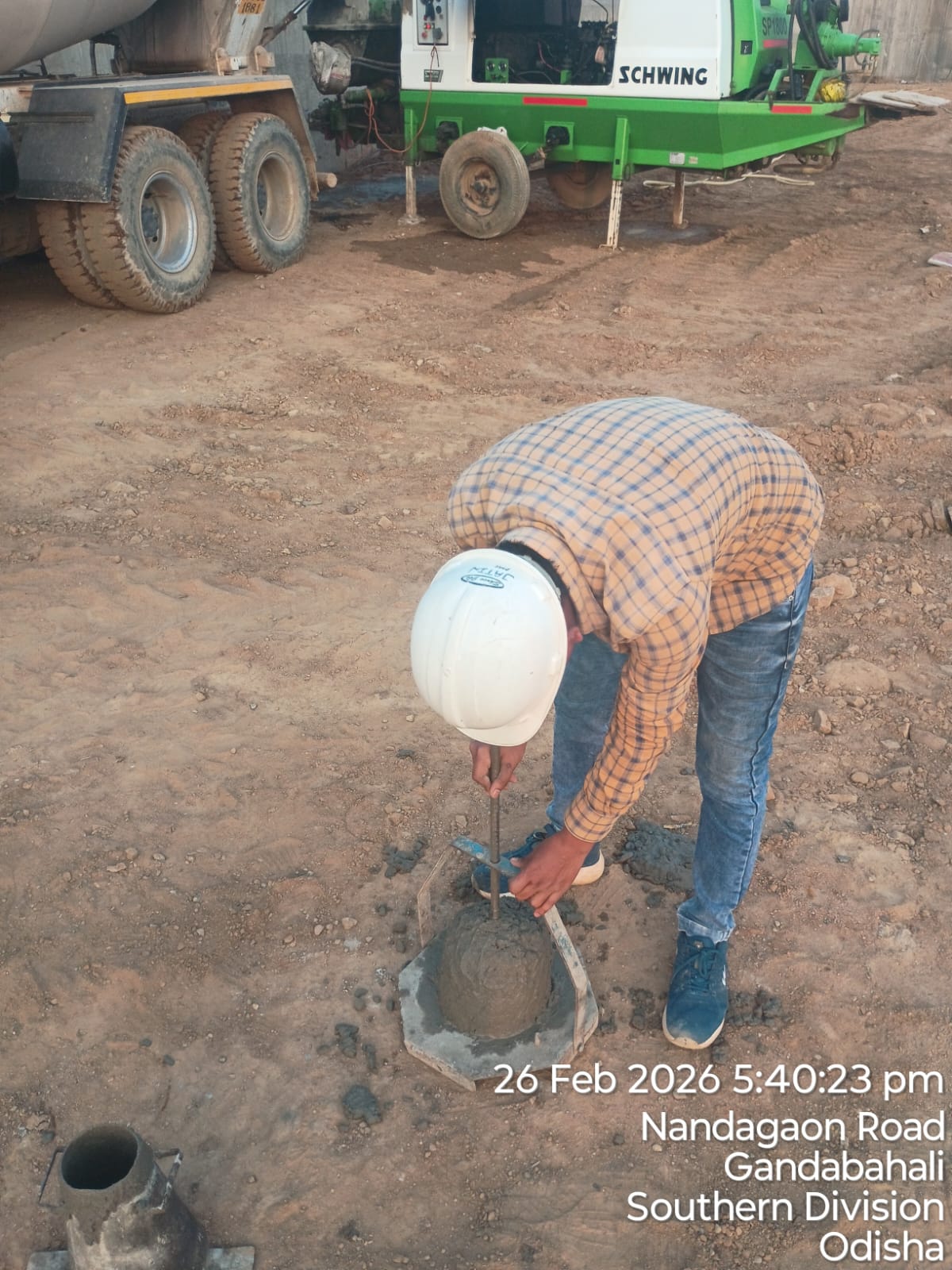

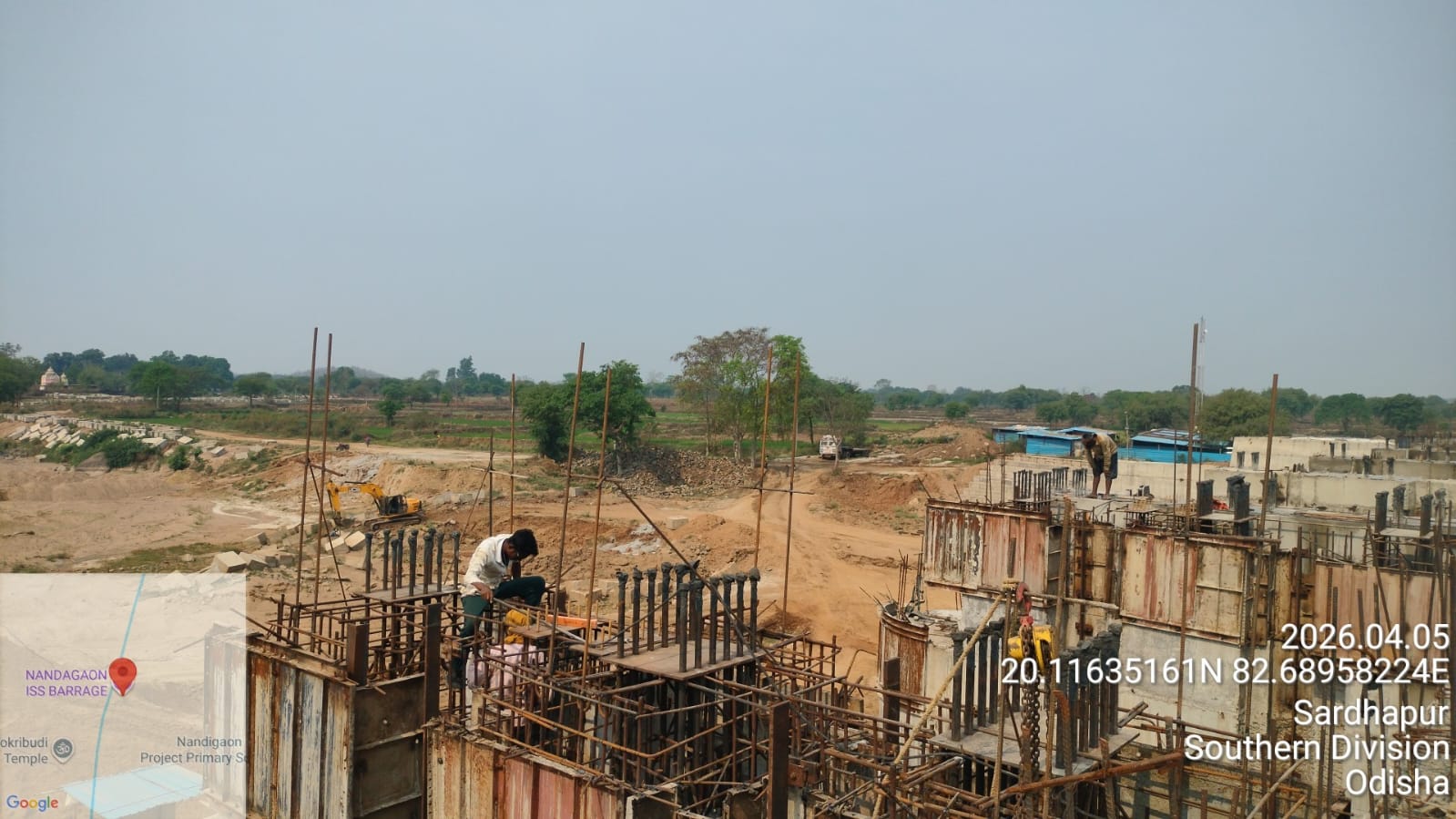

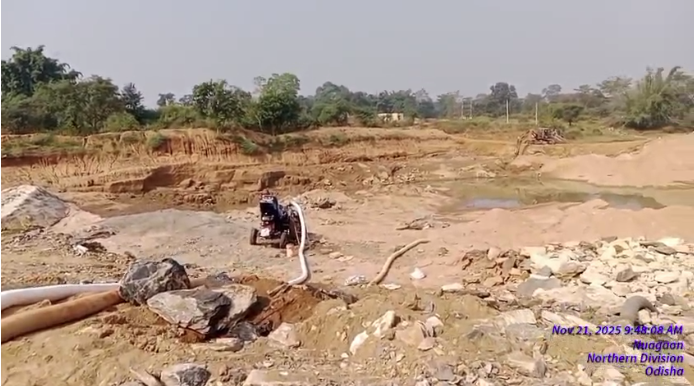

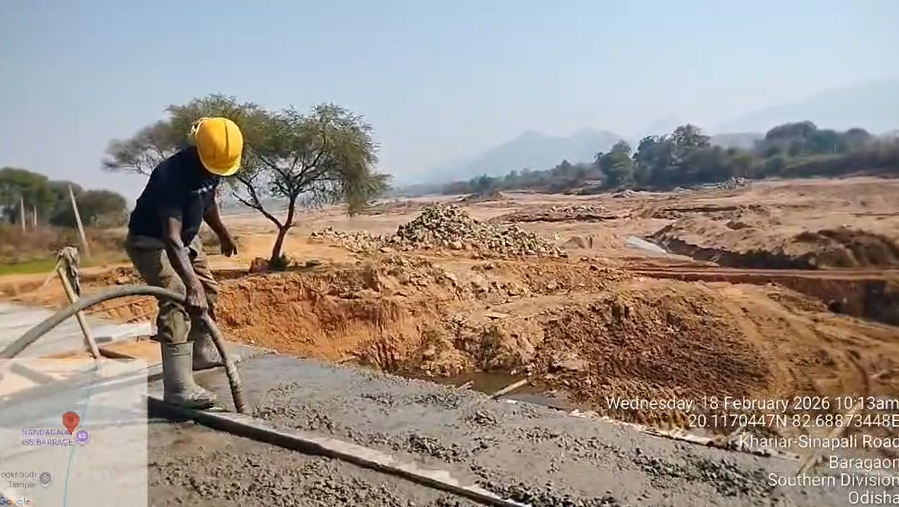

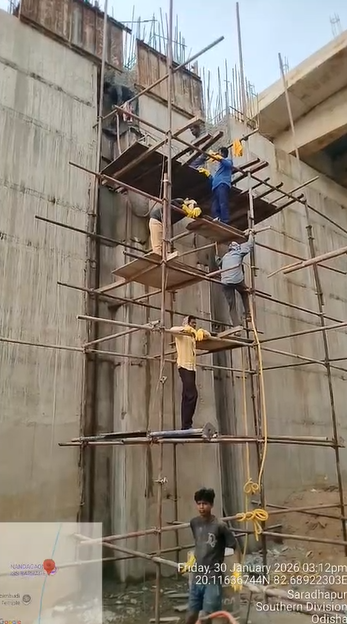

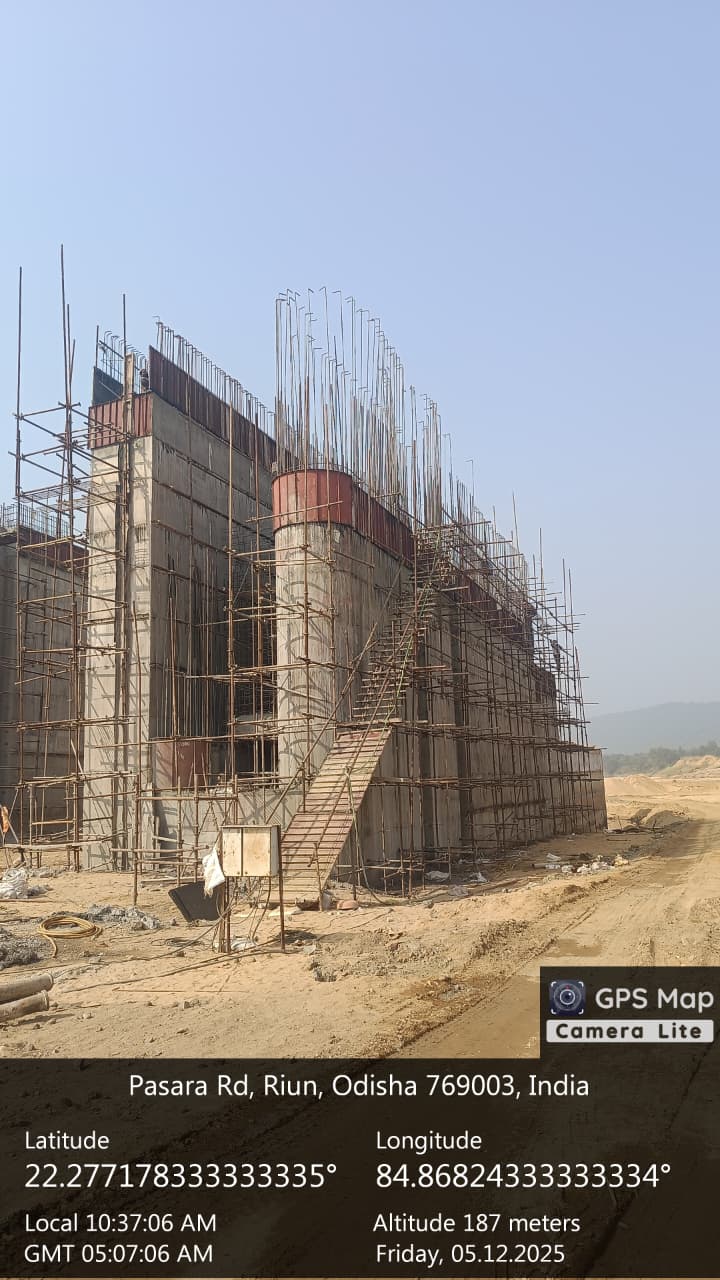

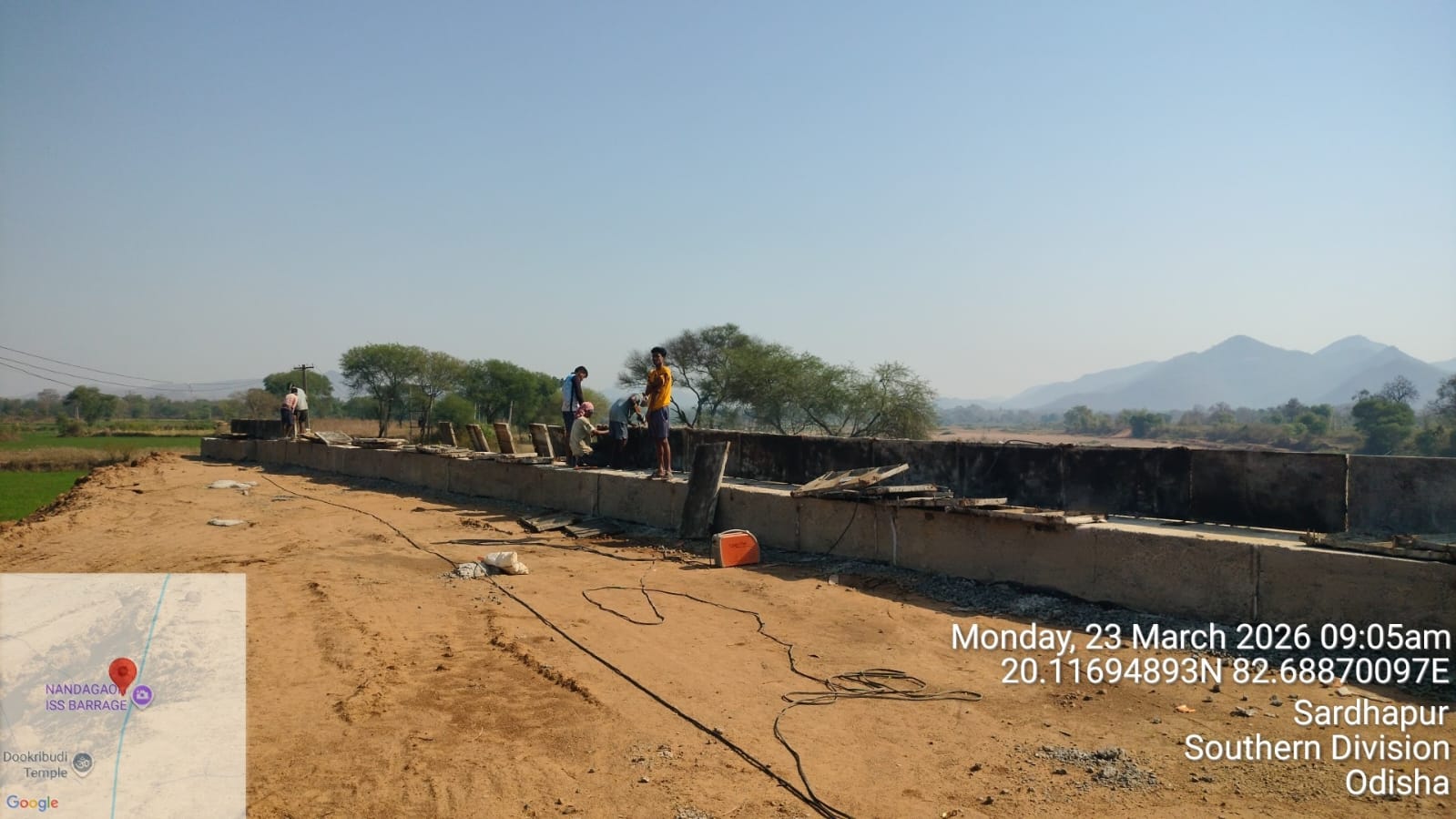

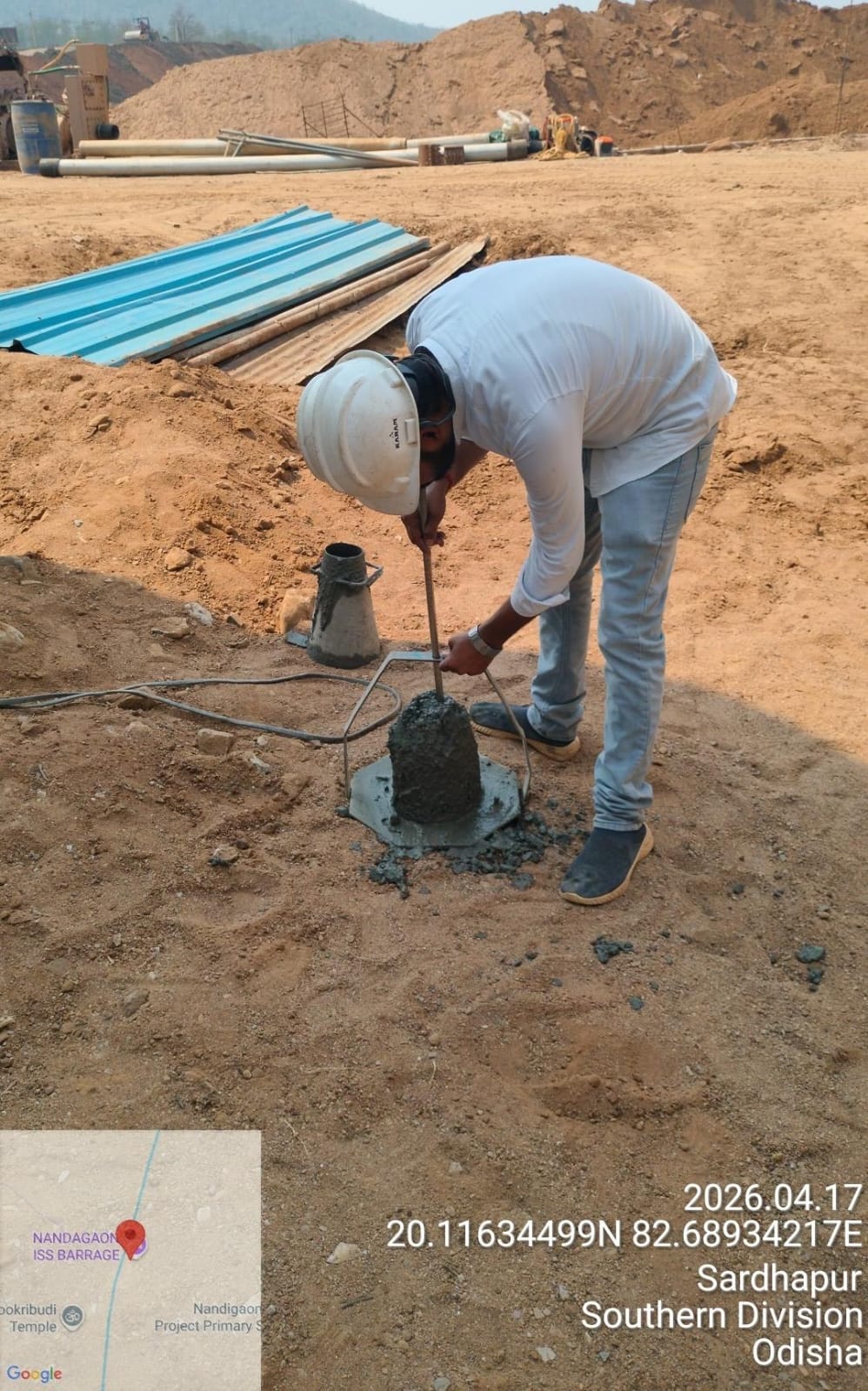

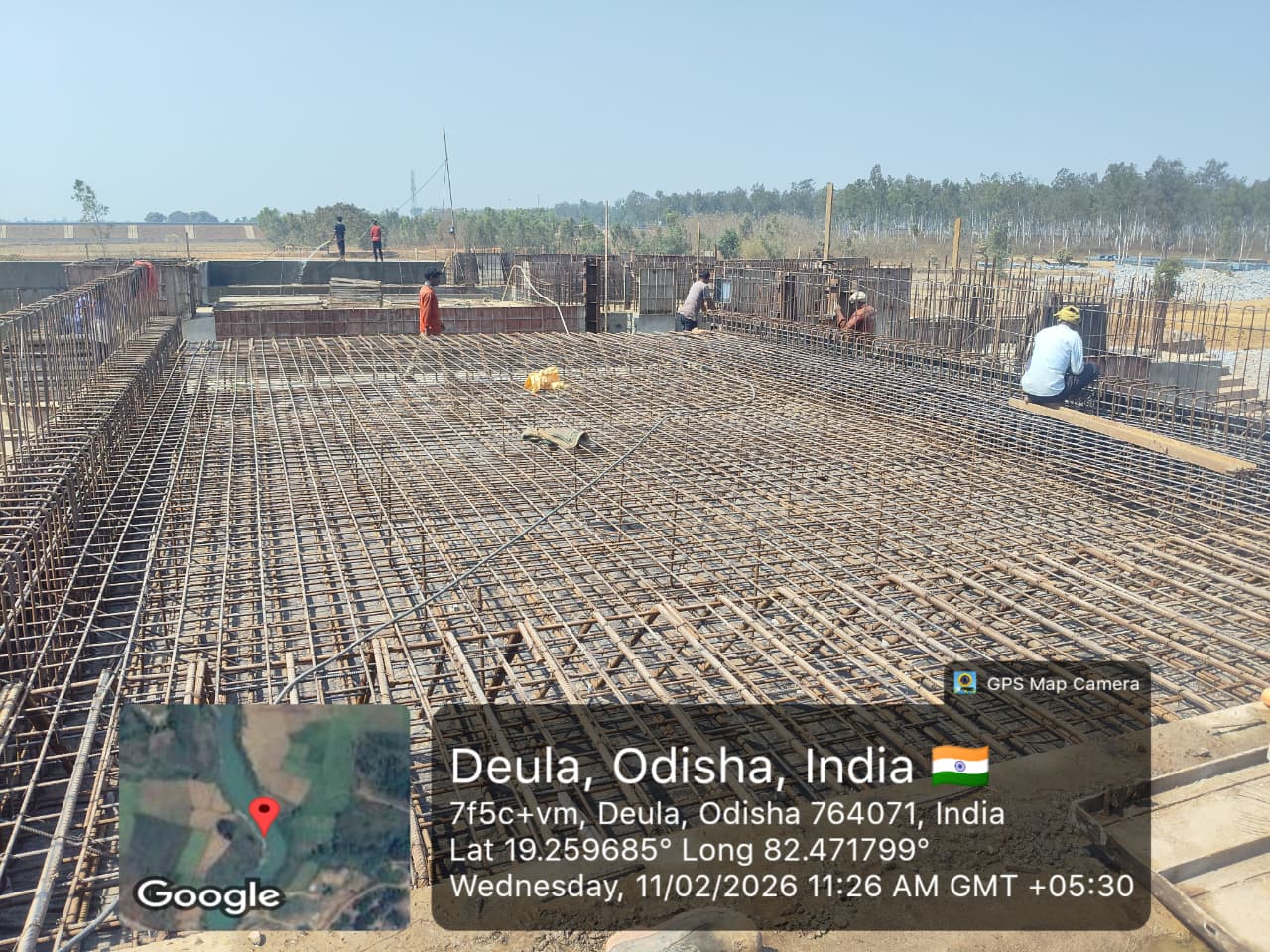

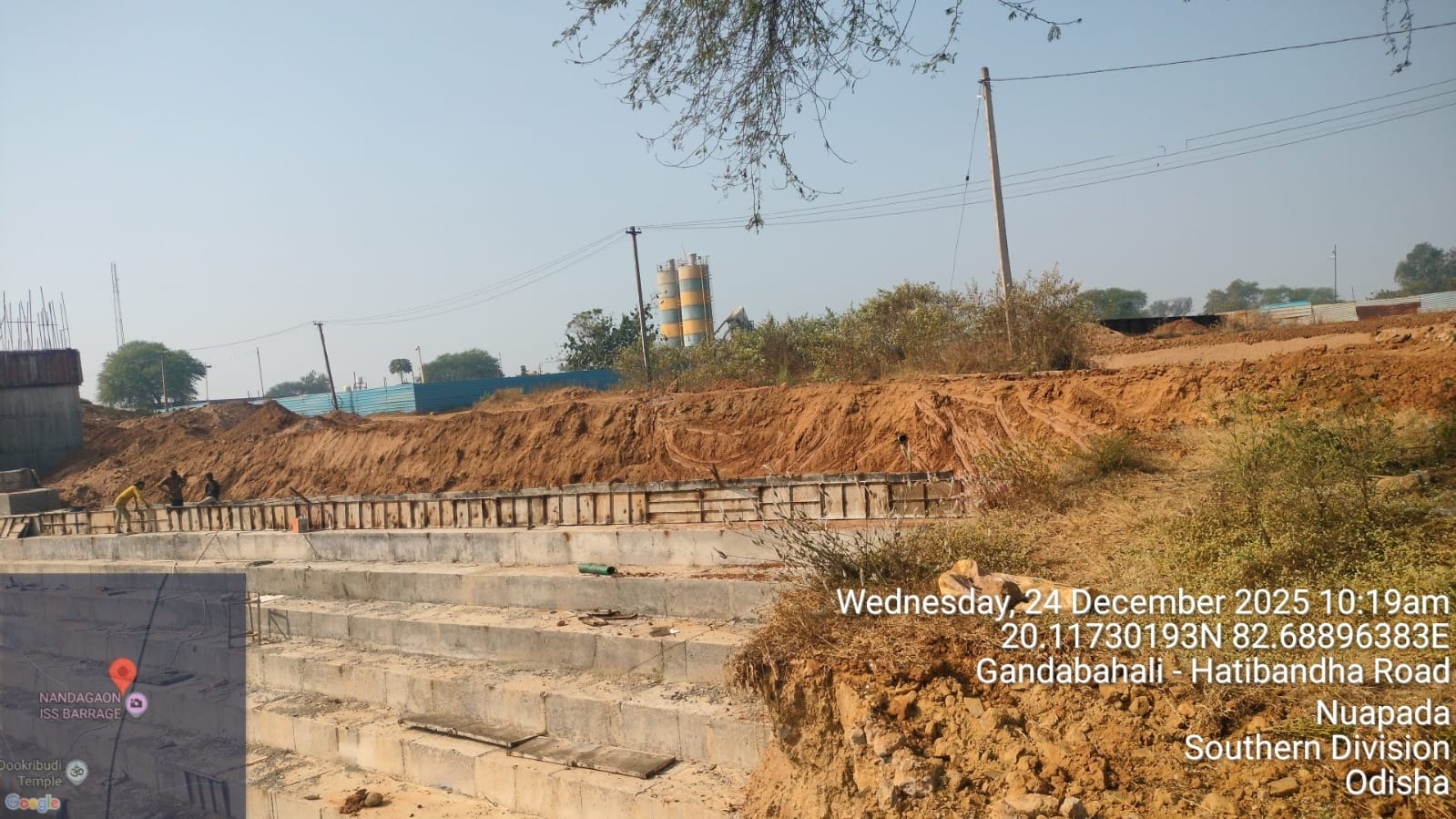

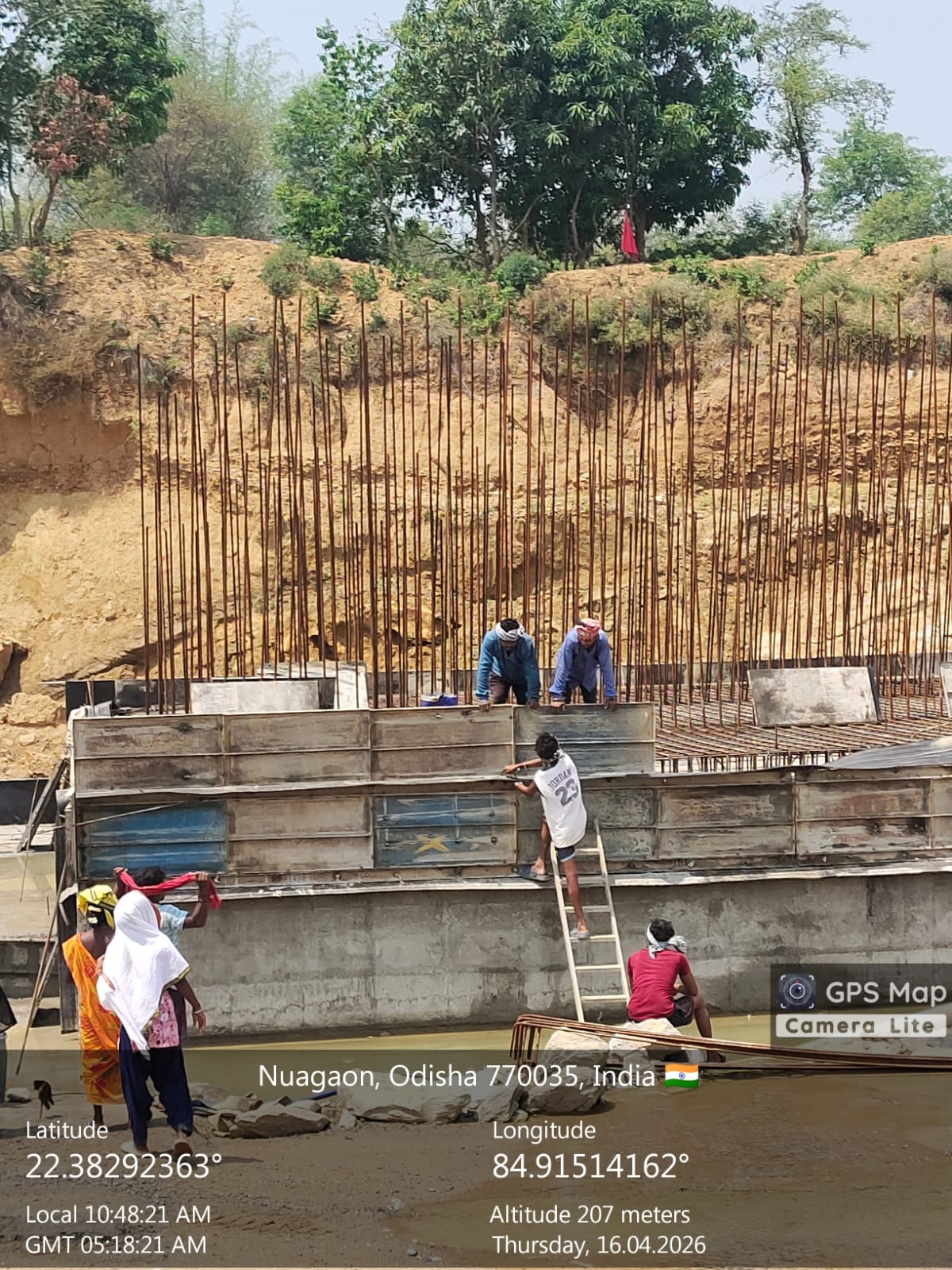

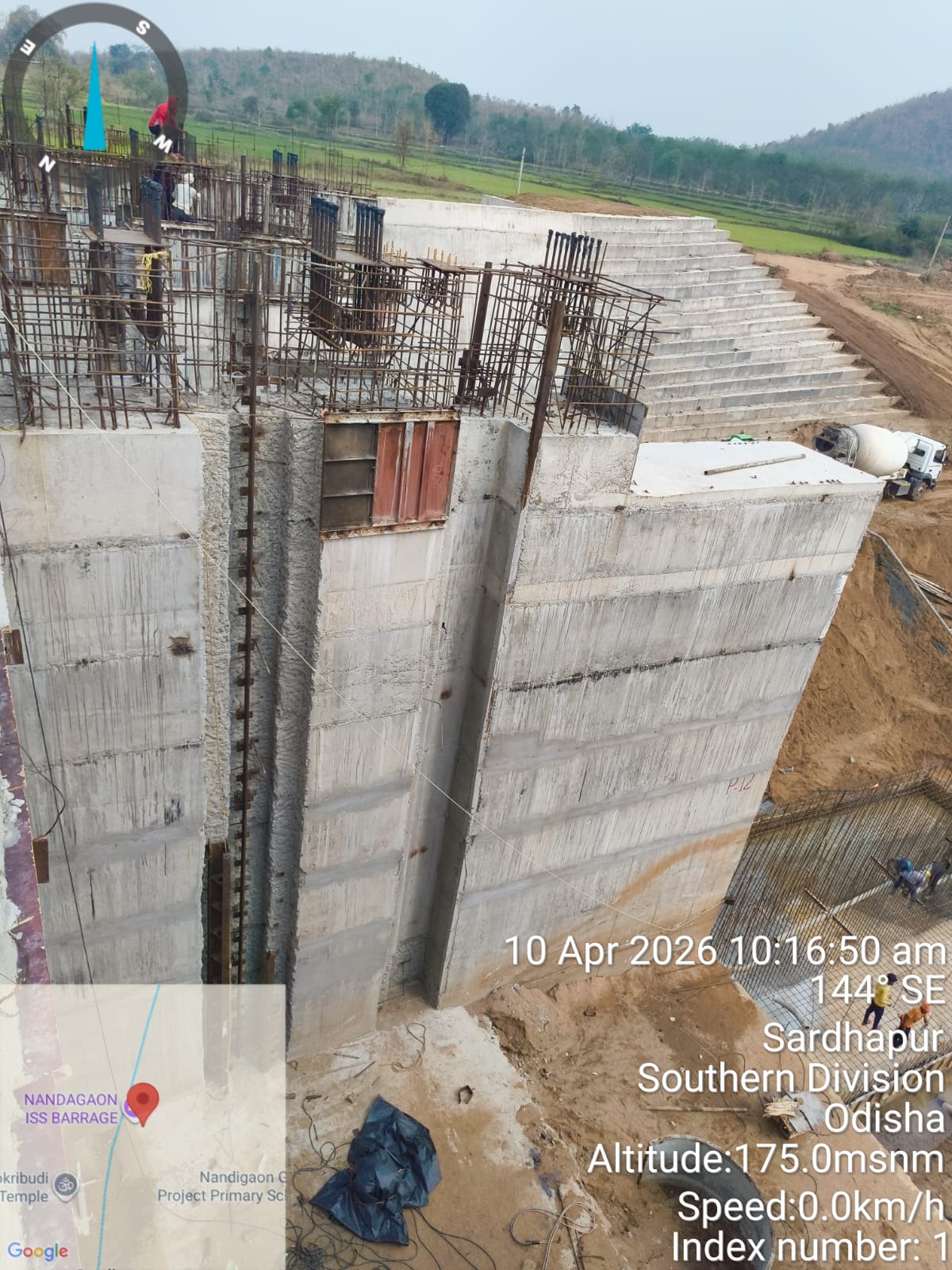

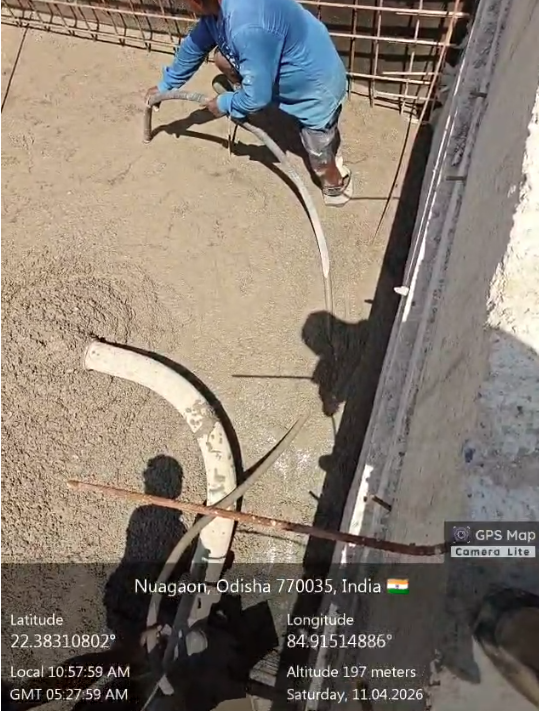

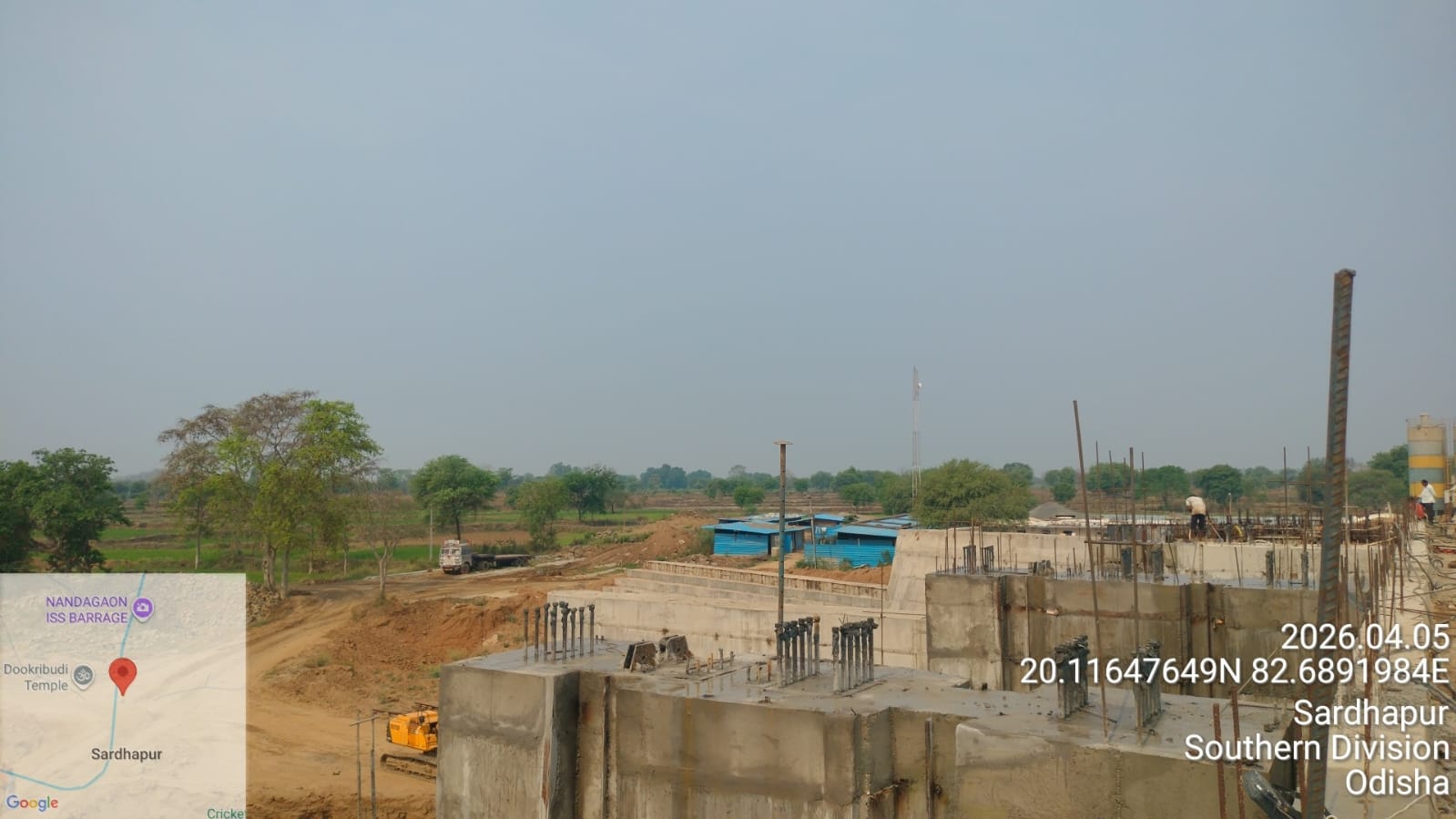

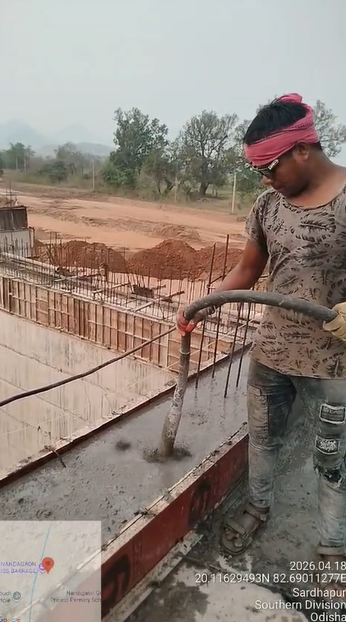

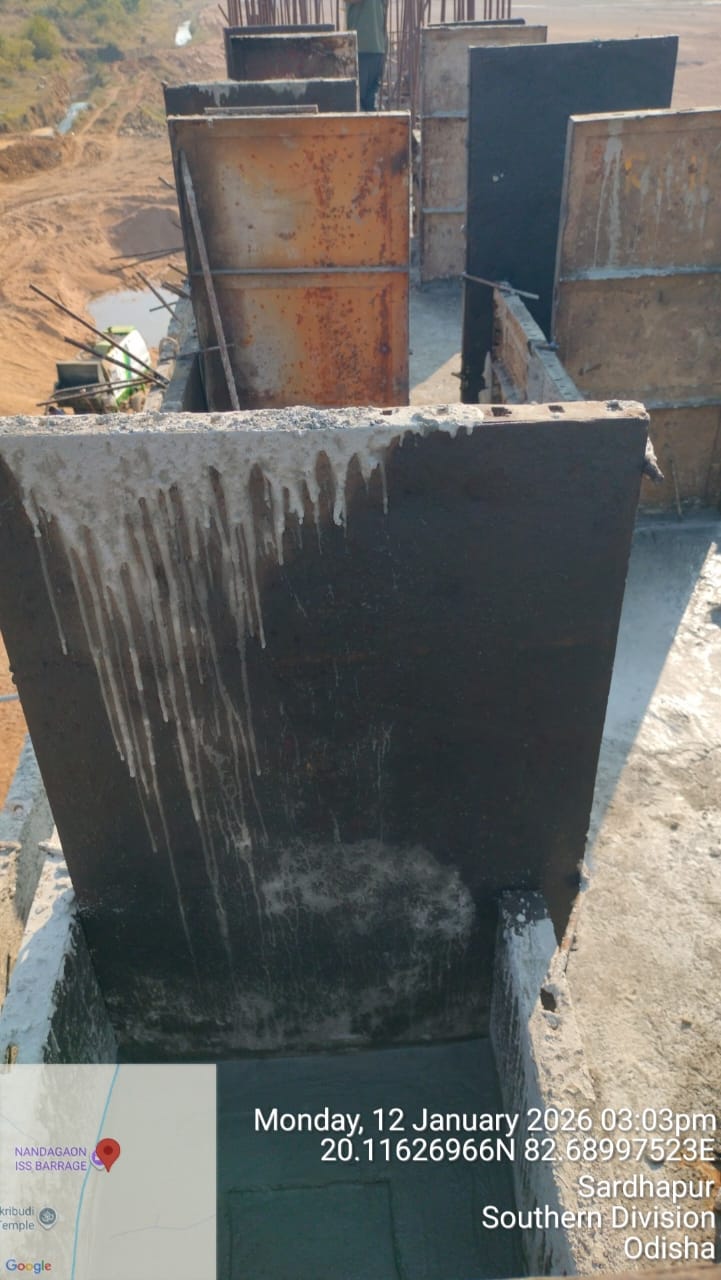

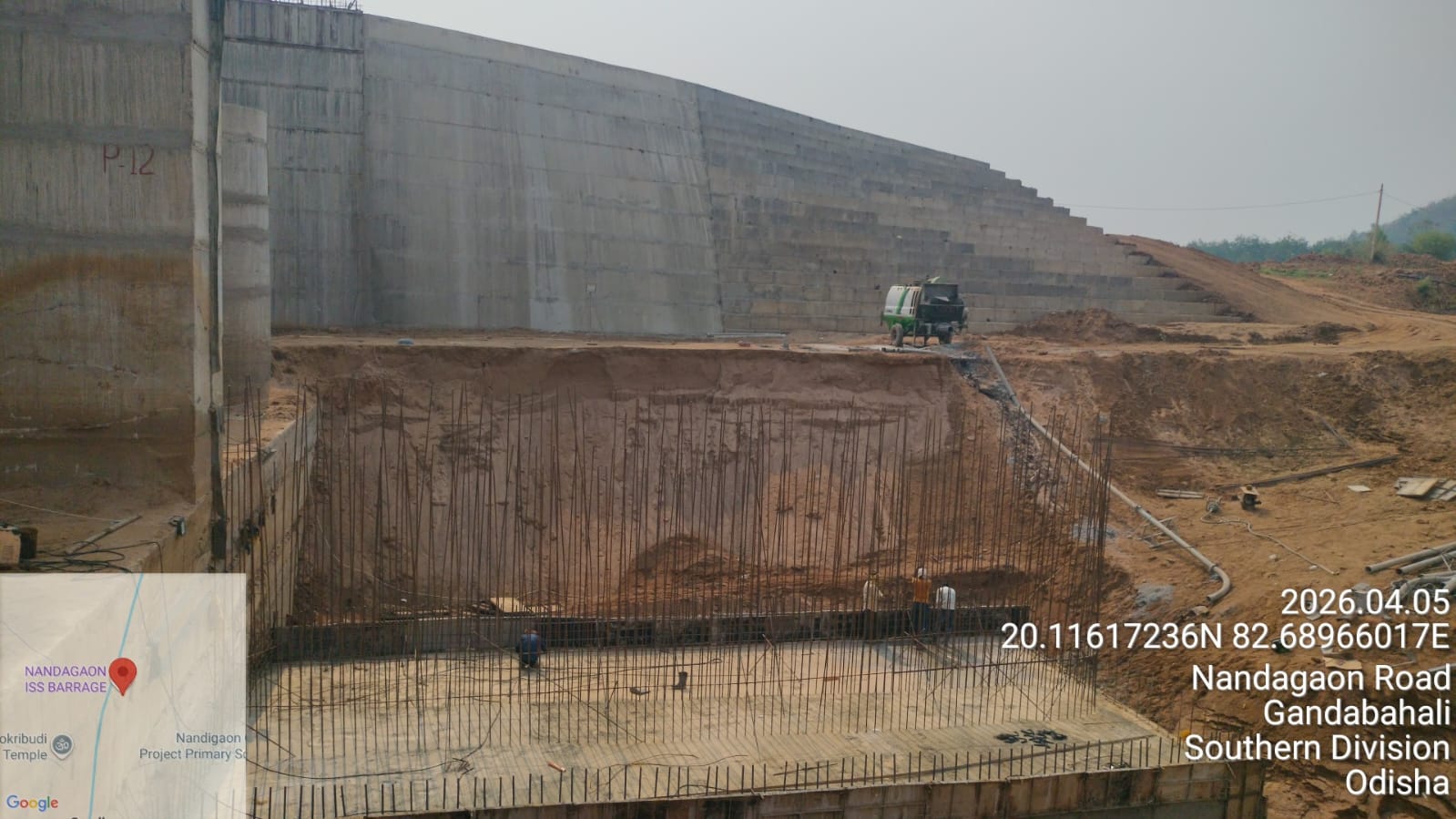

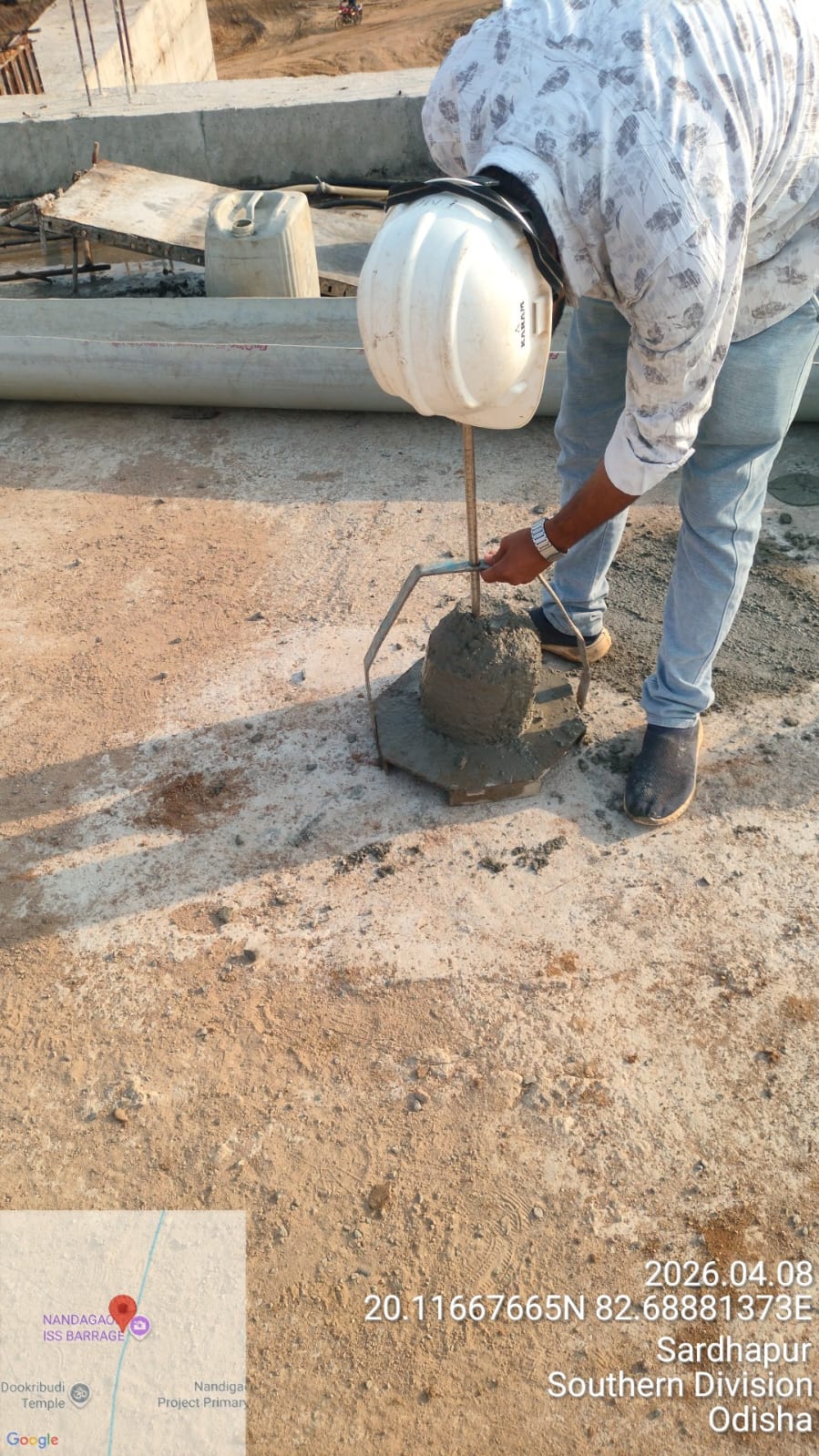

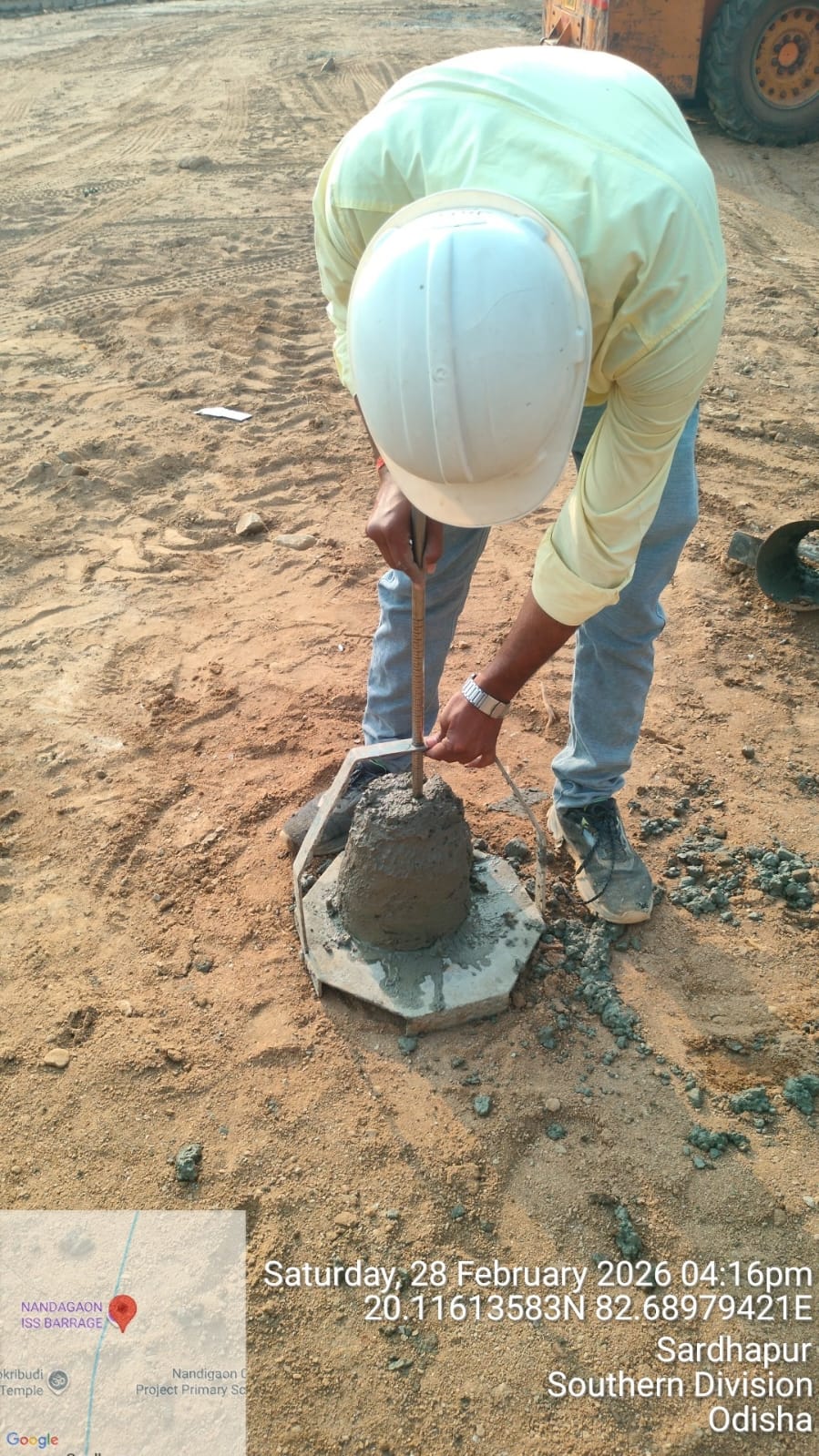

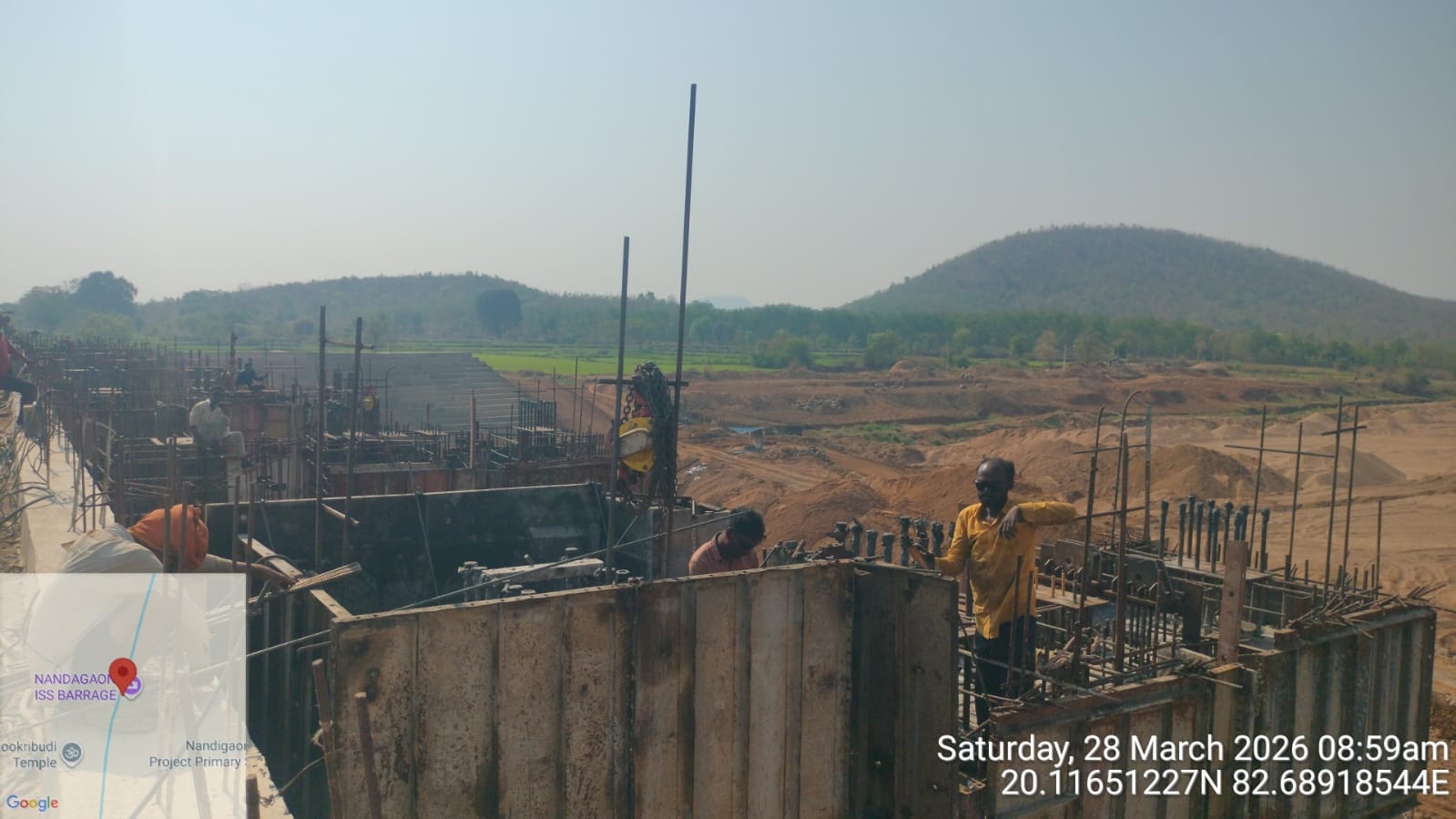

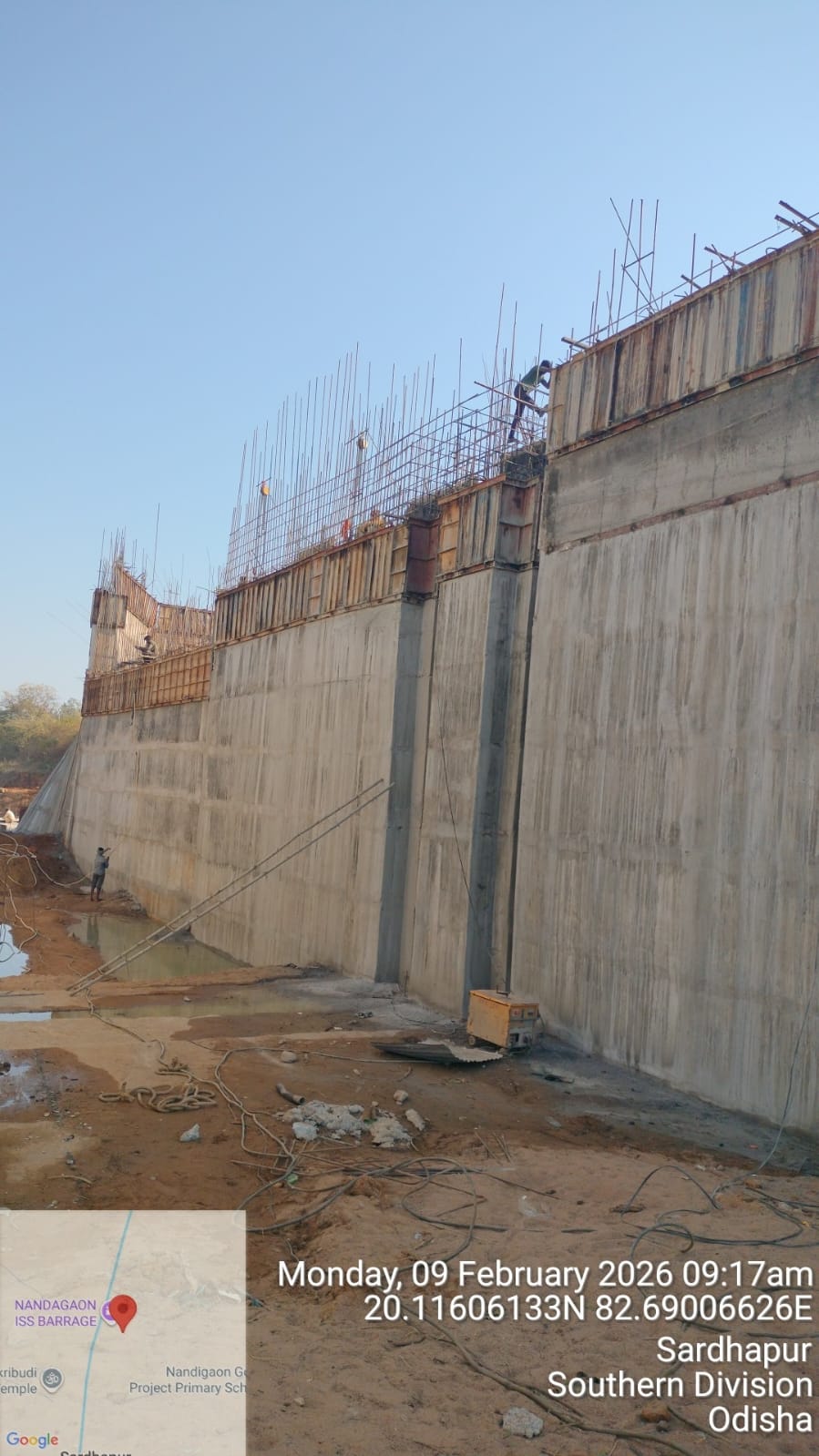

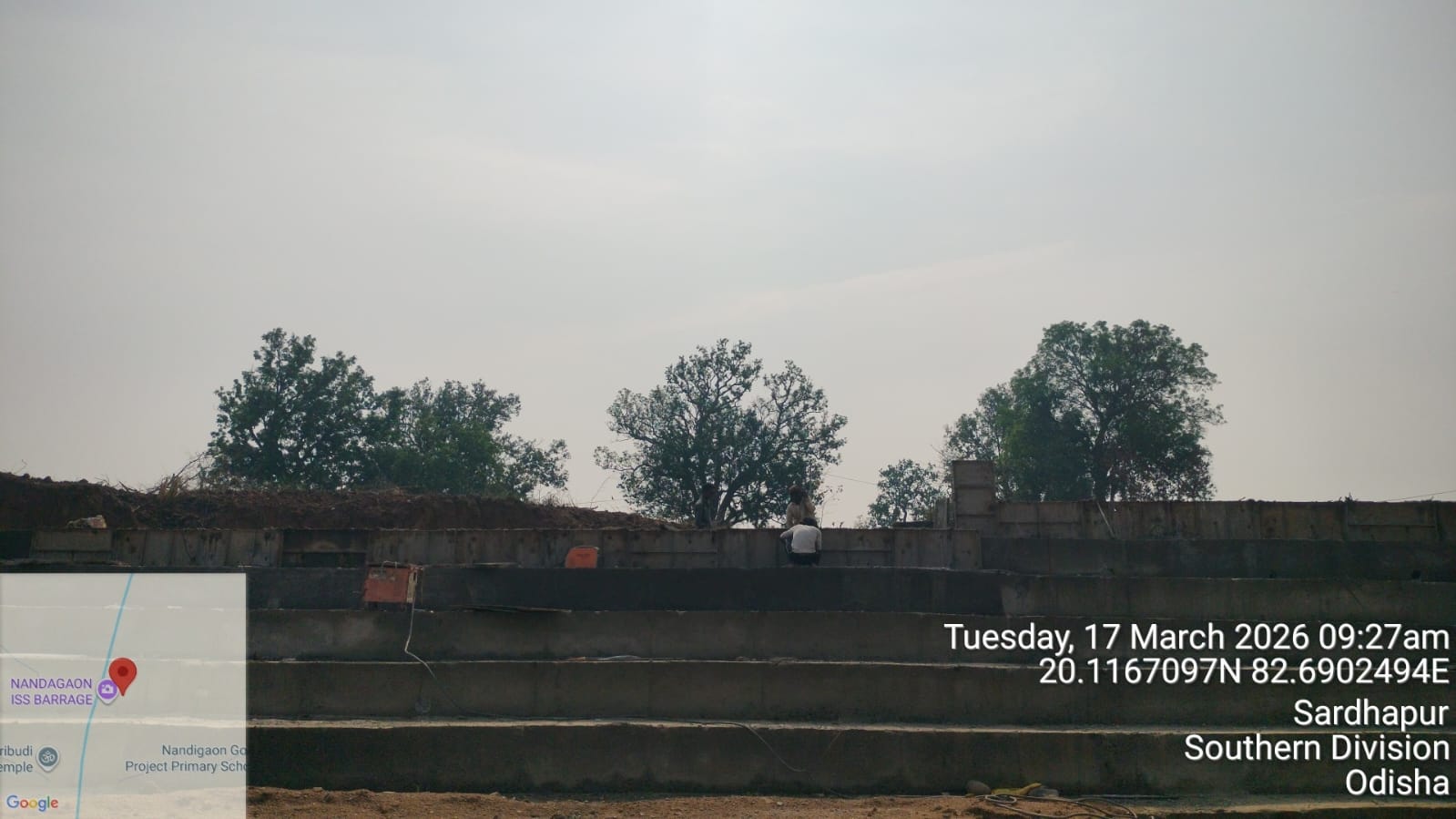

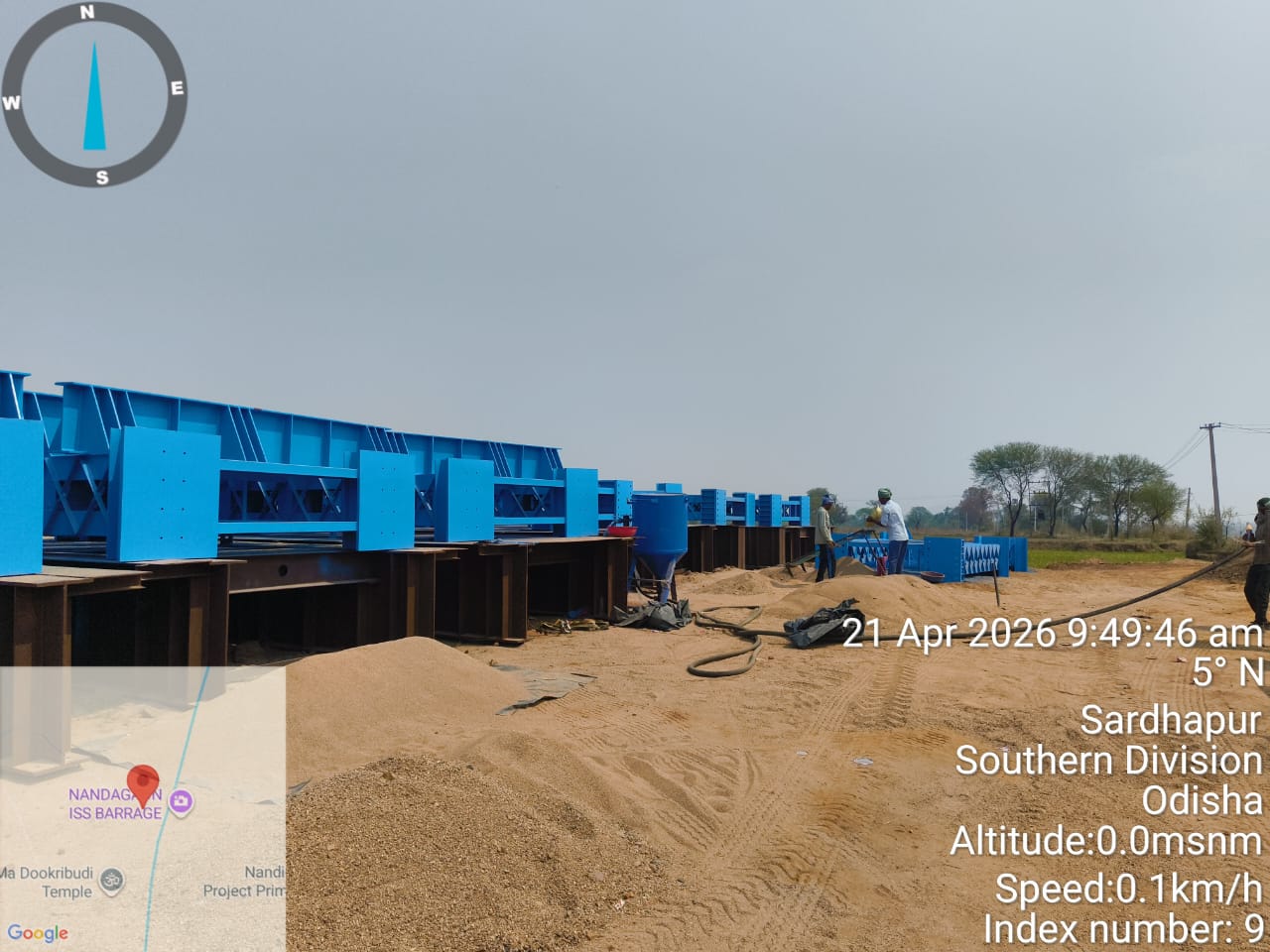

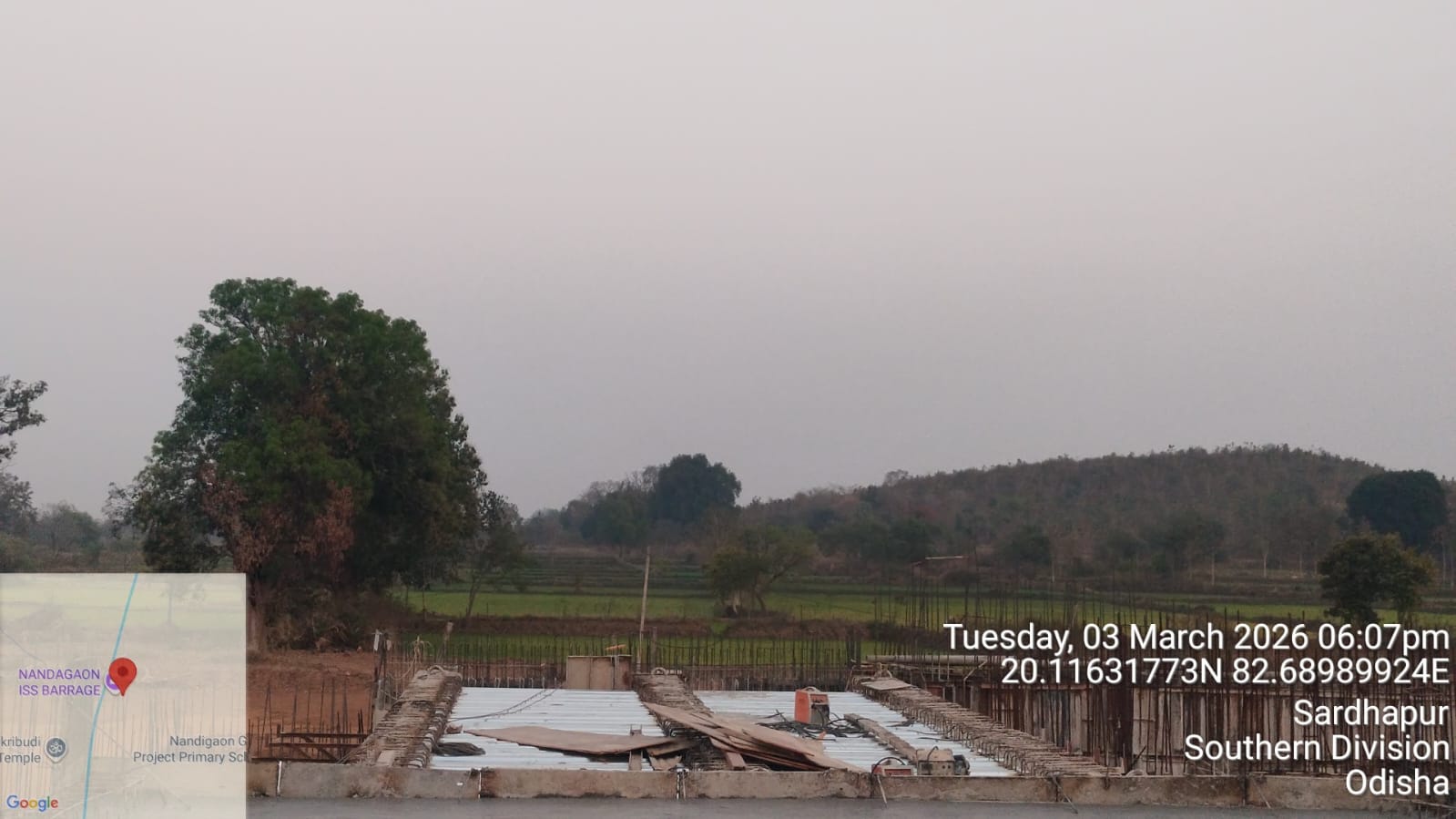

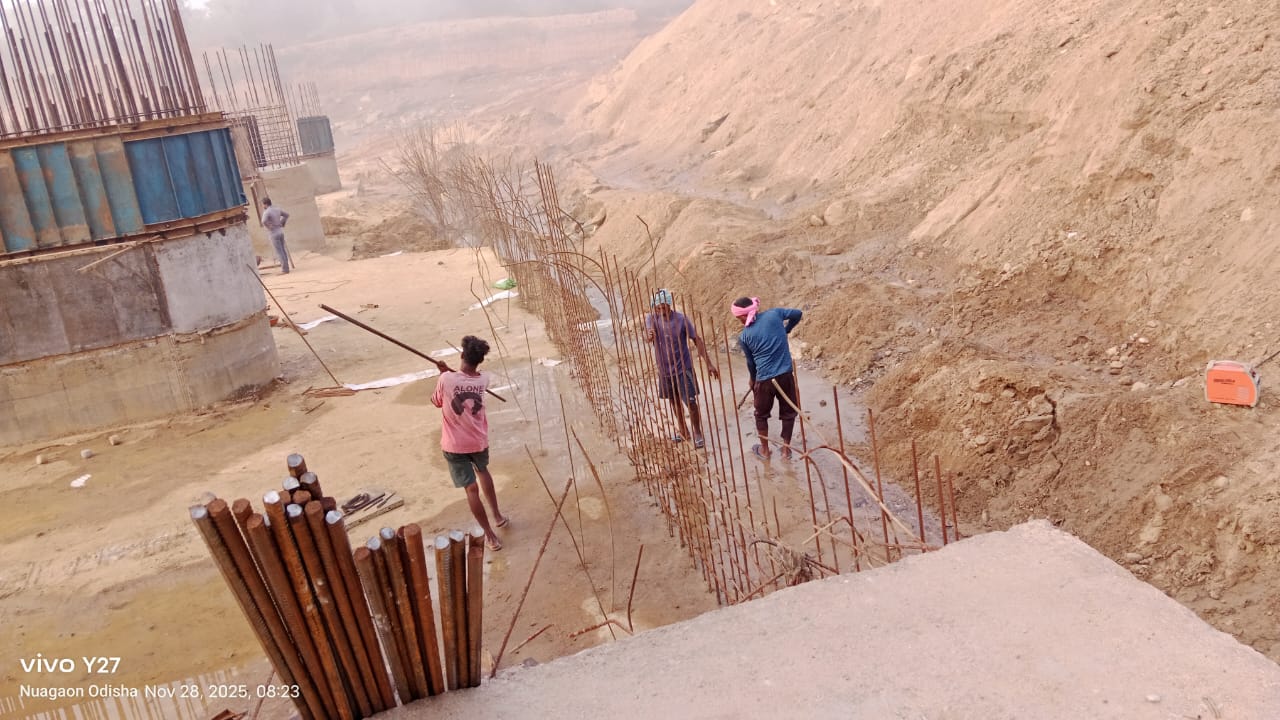

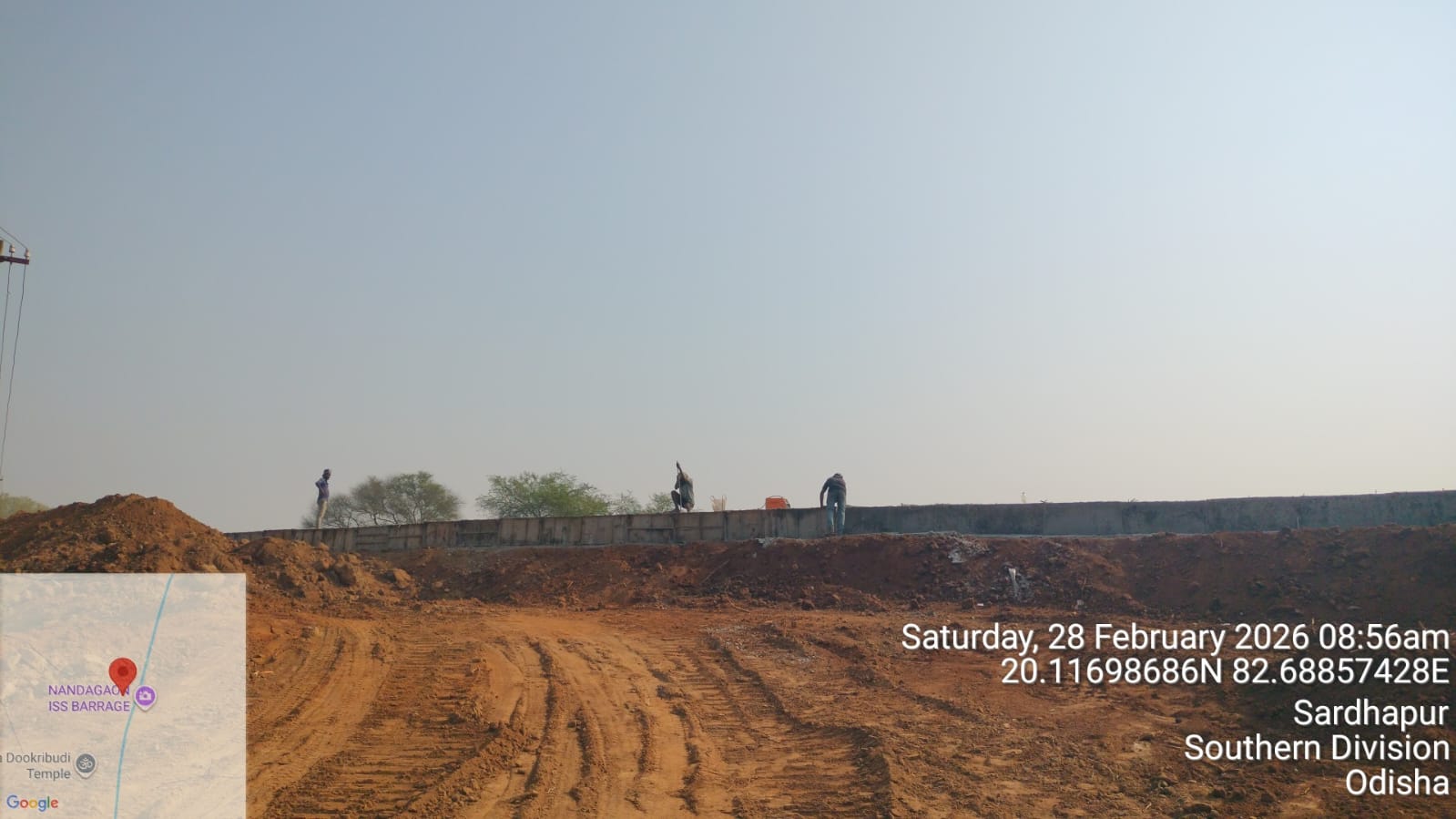

Instream Storage Structure, Nandagaon

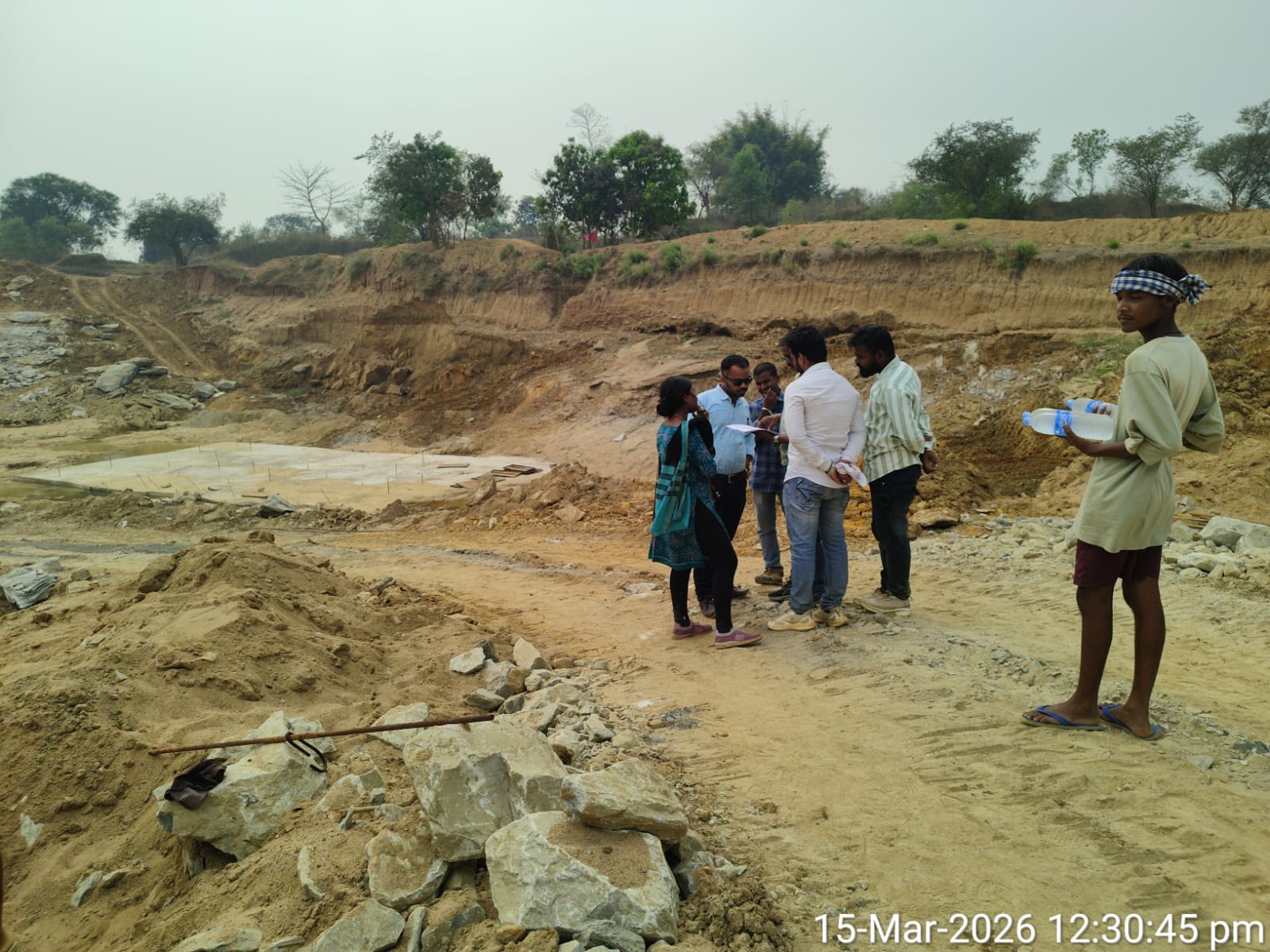

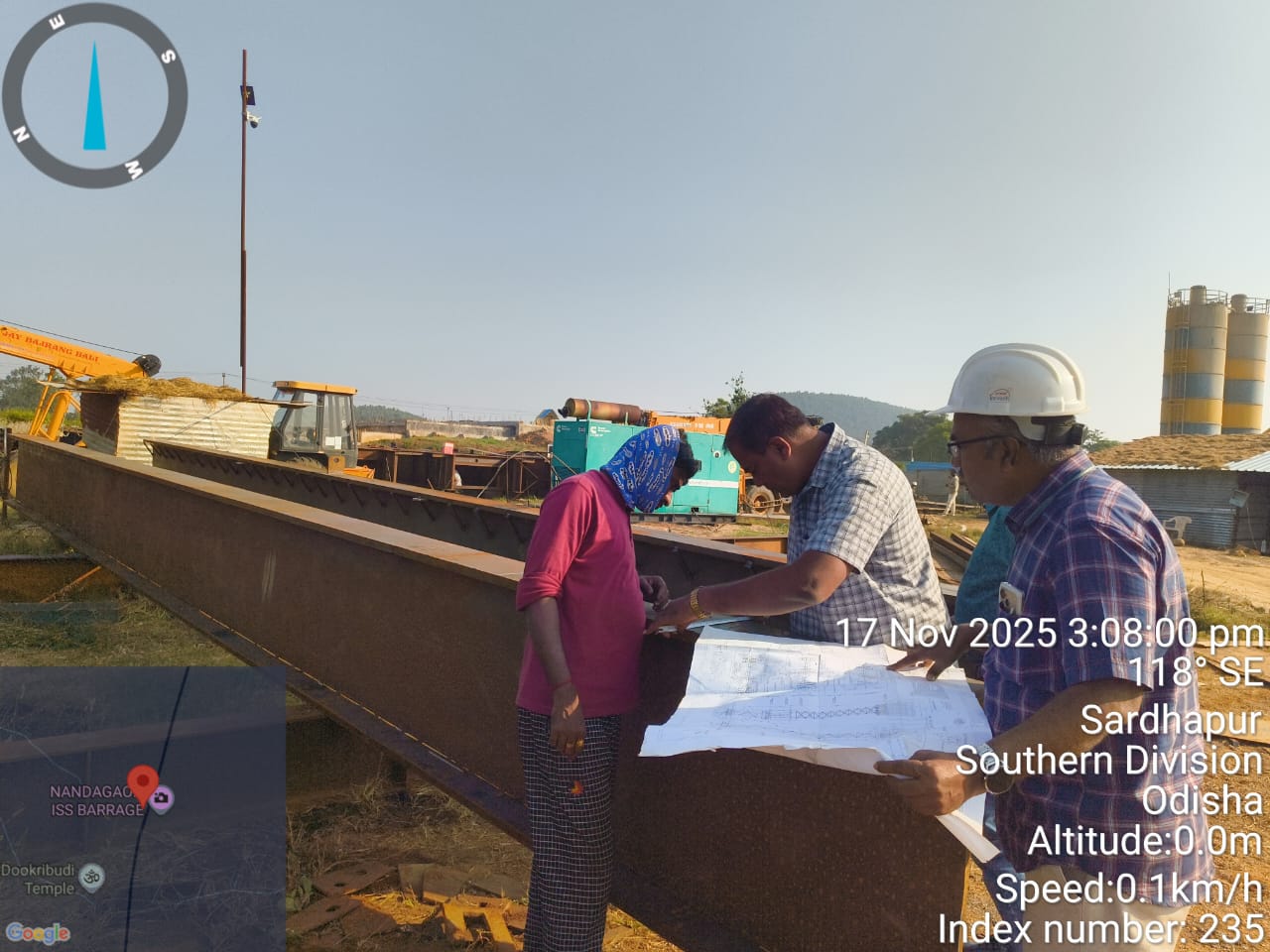

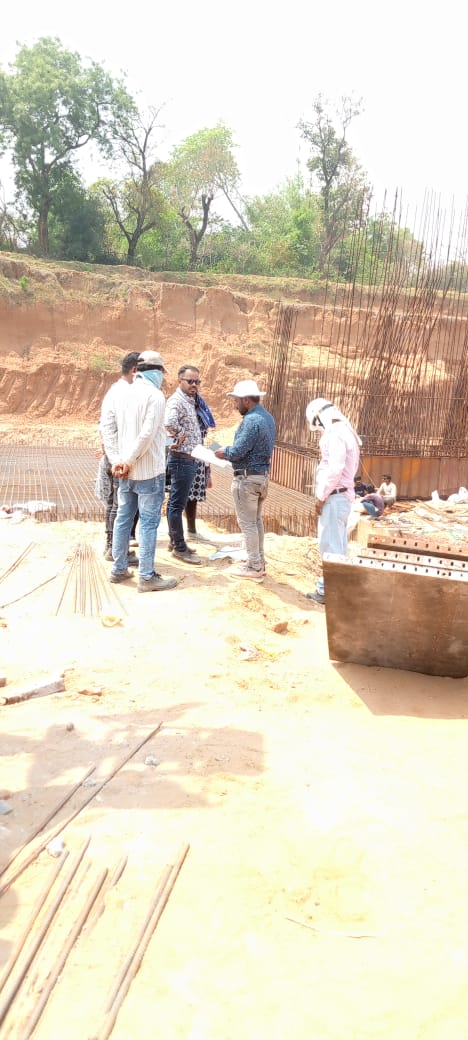

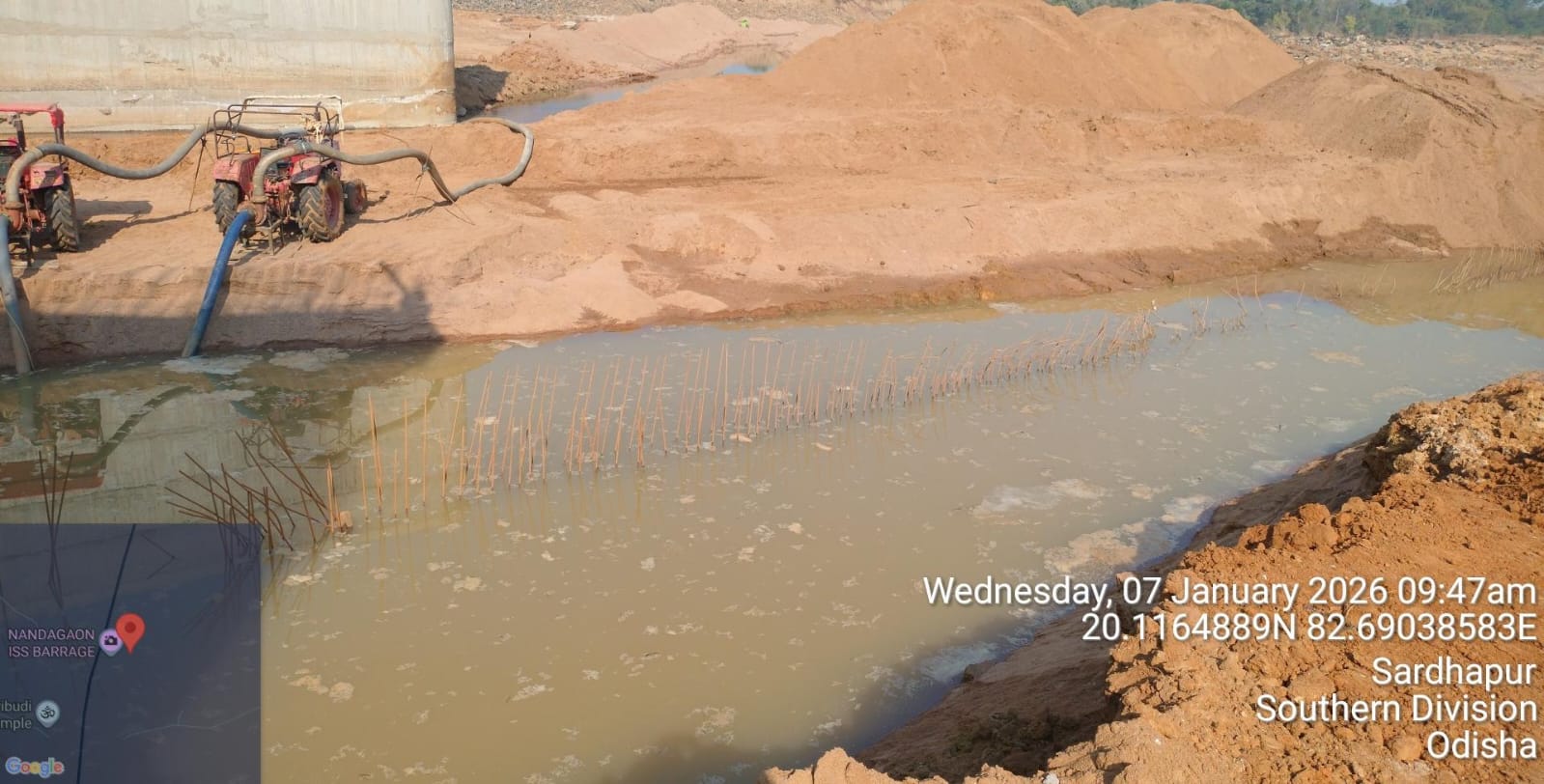

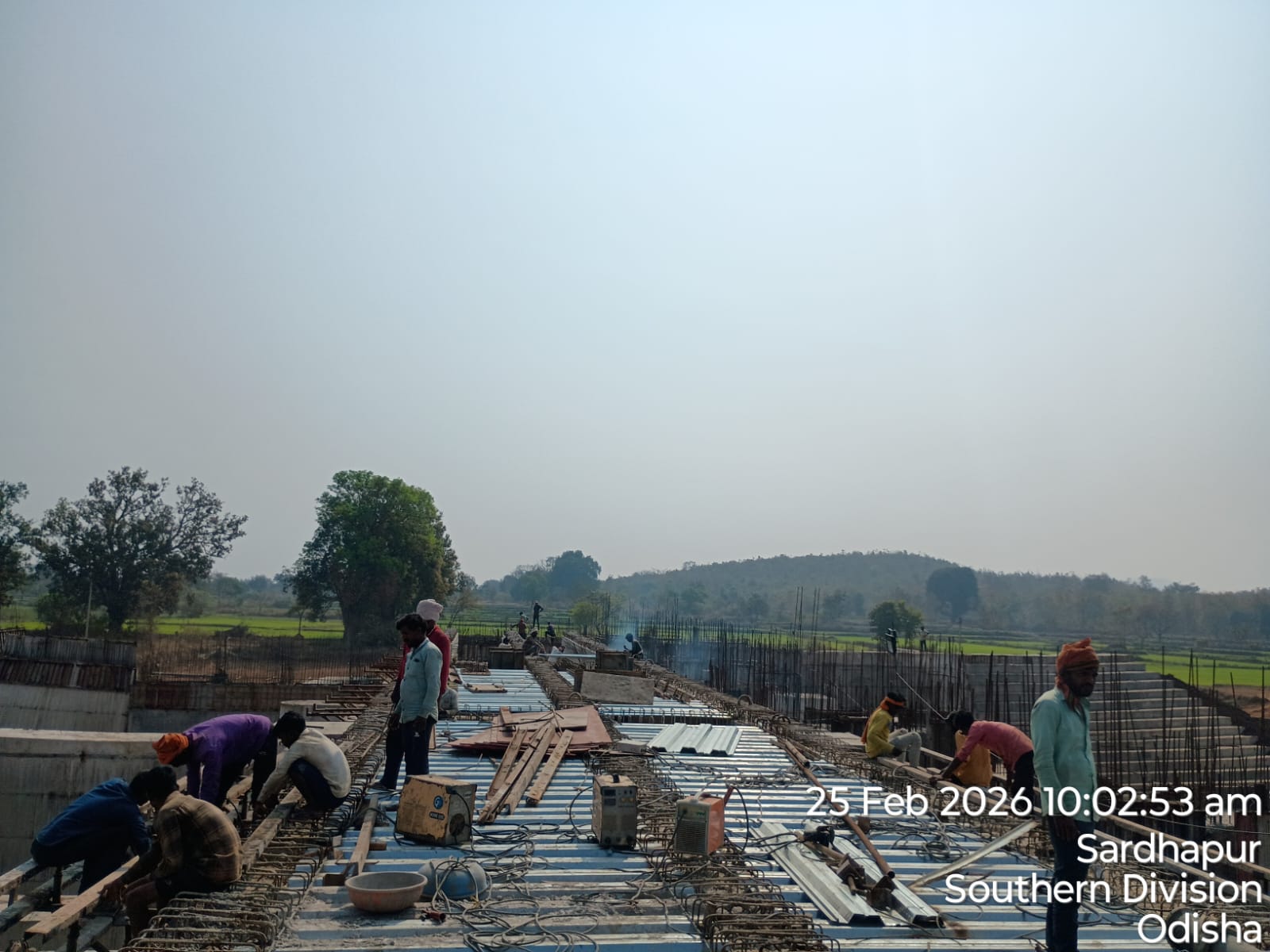

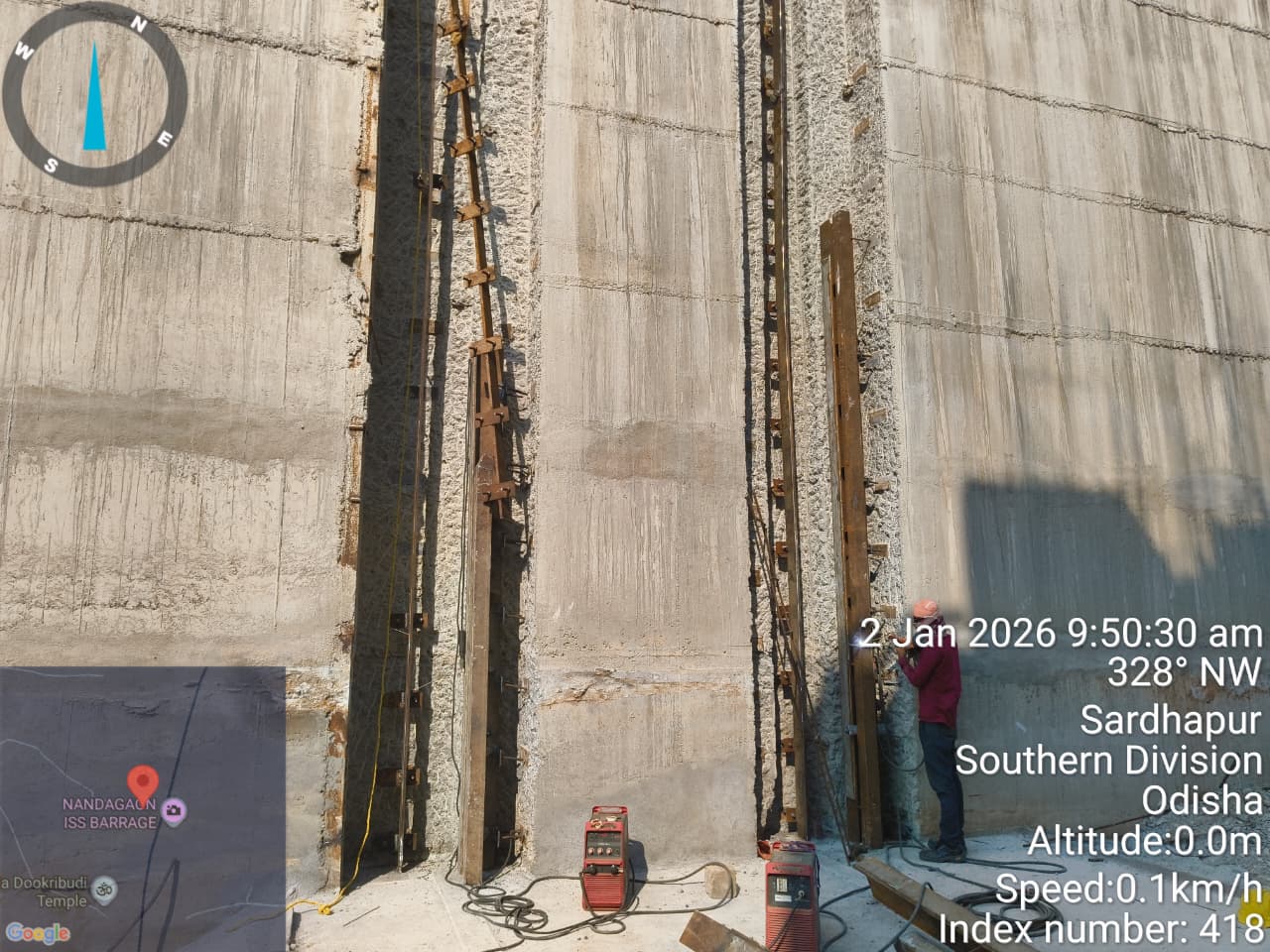

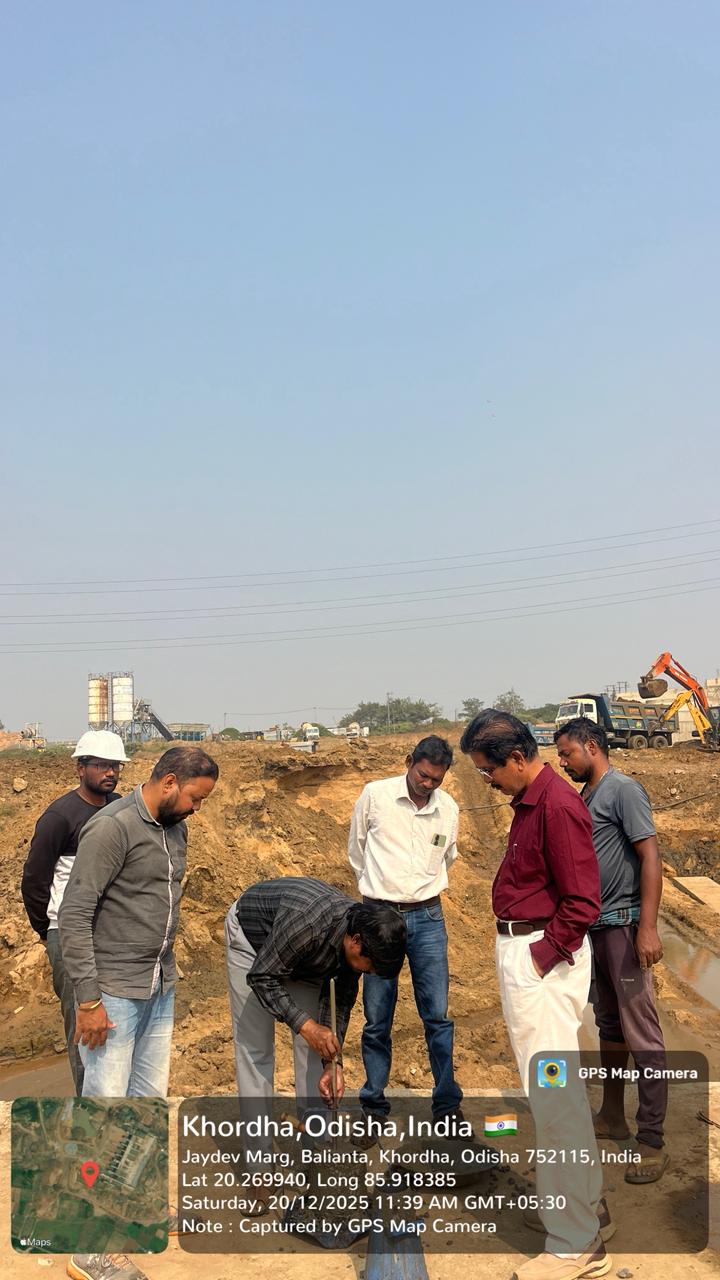

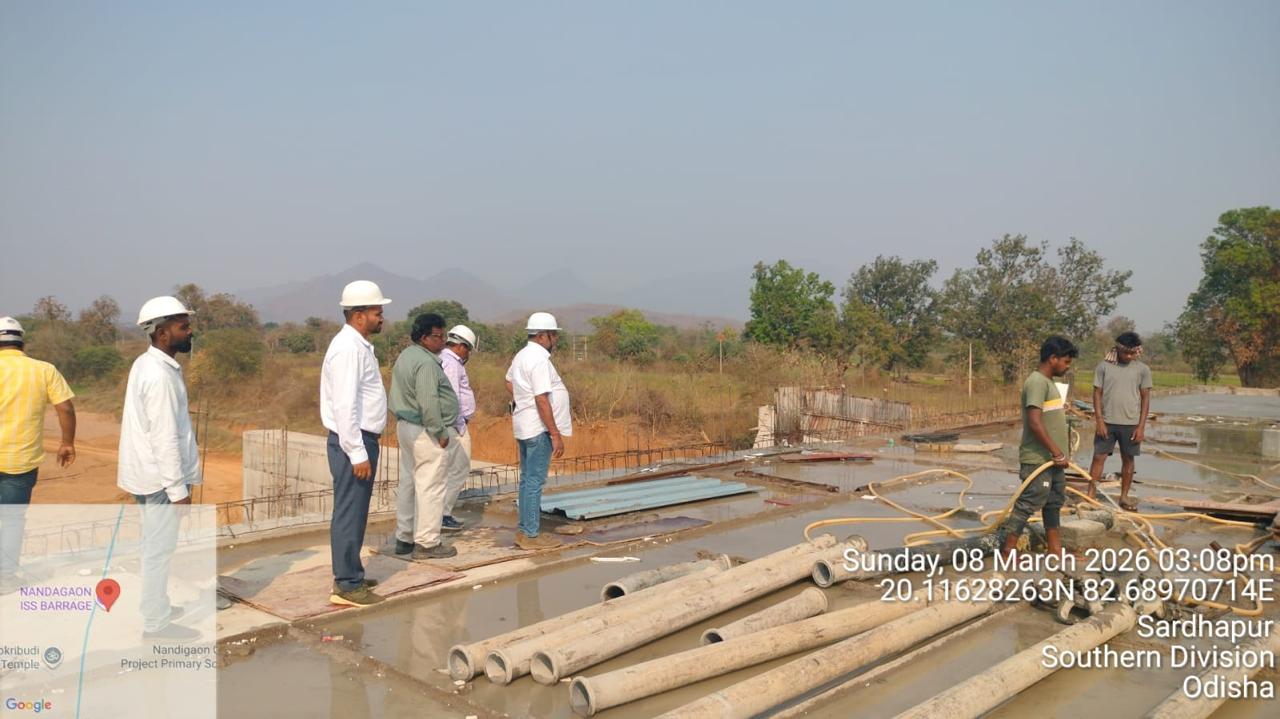

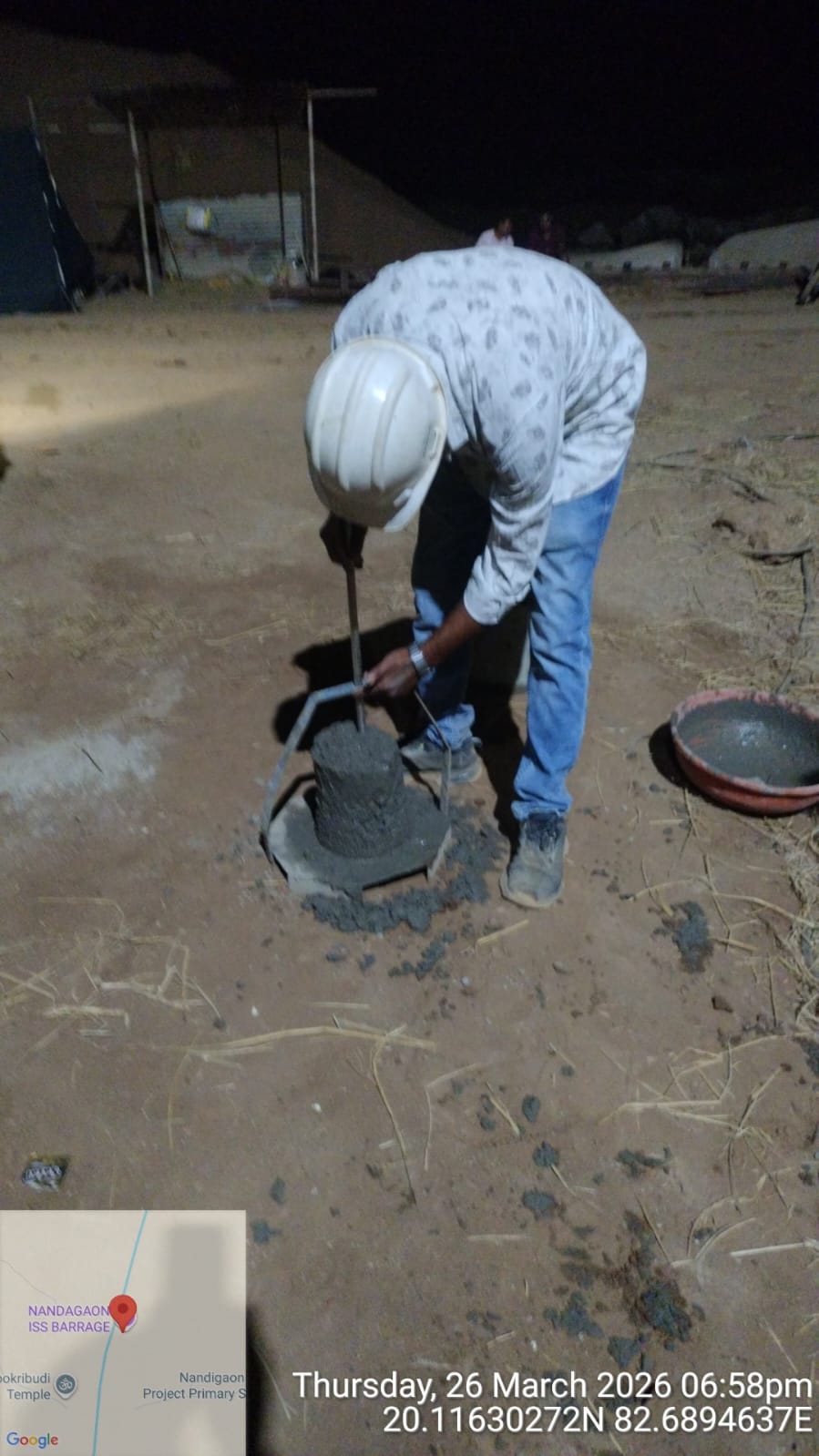

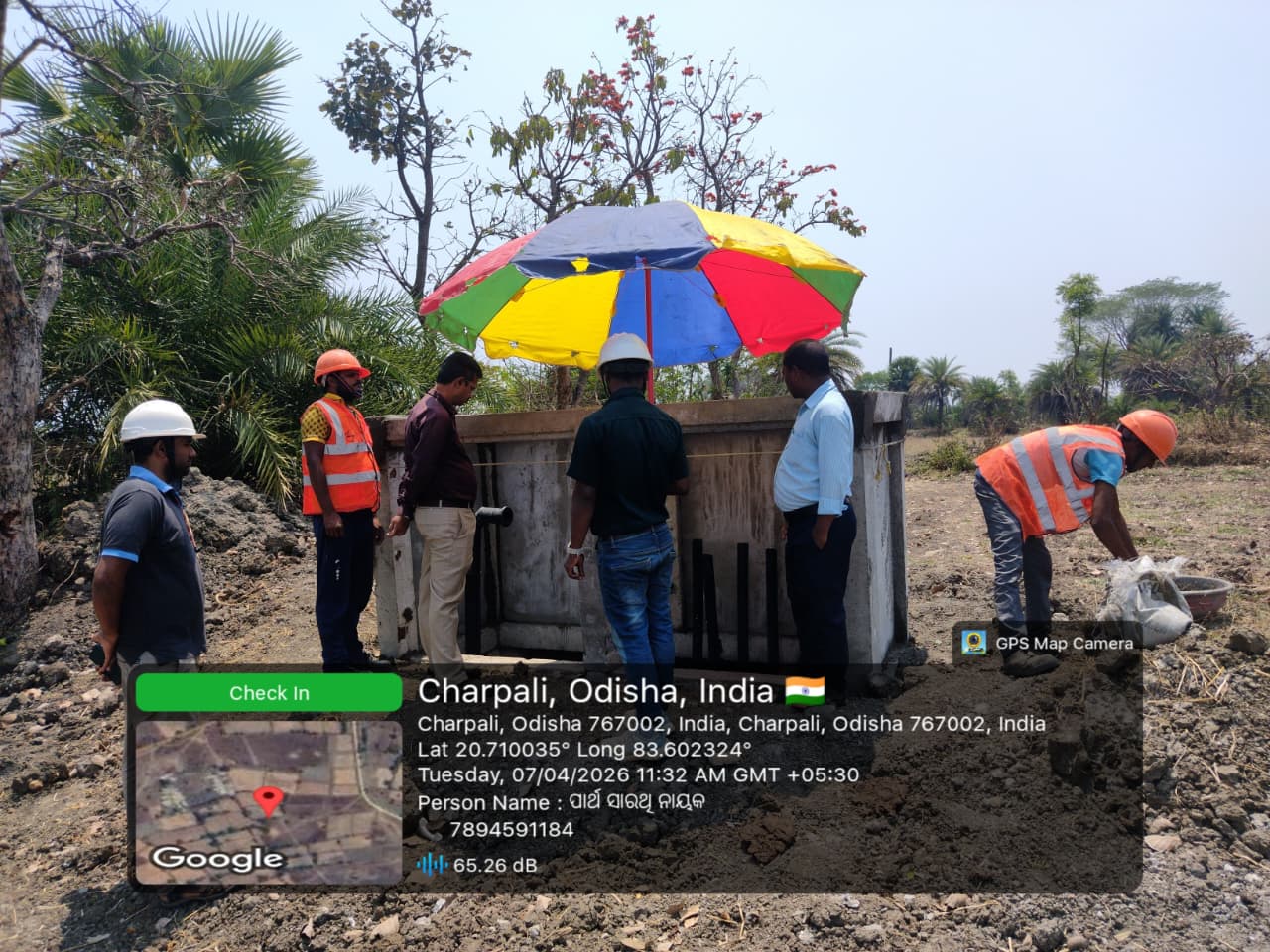

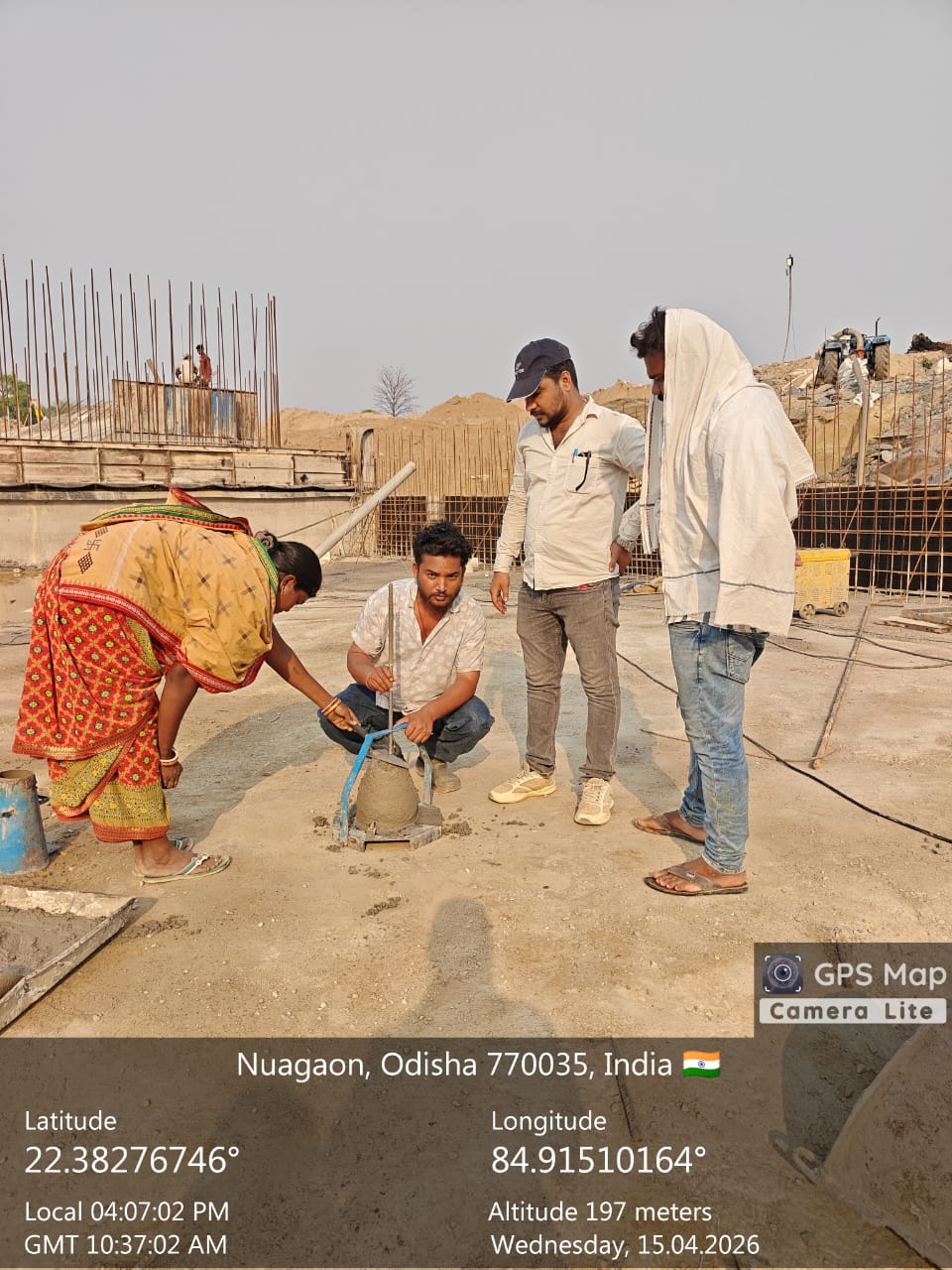

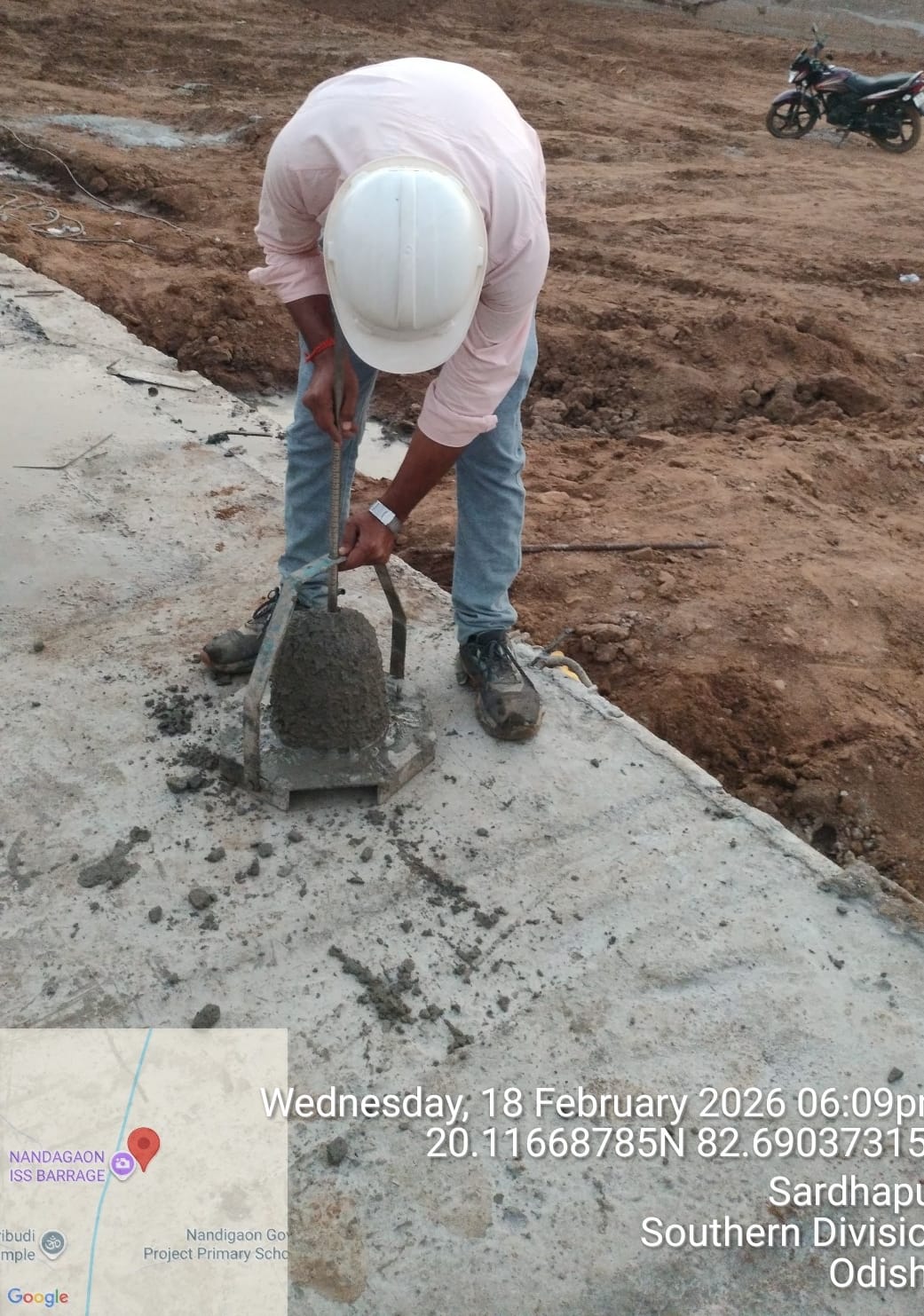

• Visited the ISS Nandagaon site with CME, QC exp in presence of site engineers. The work position of project site is as follows. 1.Basement slab & basement flooring PCC of control room building completed. No further work done since last one month. 2. No manpower for mechanical gate balance works. 3. Stone pitching work done for 300mtrs only on u/s right side & no further work is going on. 4. Wearing coat over the bridge slab haven’t taken off till now on 22.09.2026
16/100
Instream Storage Structure, Nandagaon
• Visited the ISS Nandagaon site with CME, QC exp in presence of site engineers. The work position of project site is as follows. 1.Basement slab & basement flooring PCC of control room building completed. No further work done since last one month. 2. No manpower for mechanical gate balance works. 3. Stone pitching work done for 300mtrs only on u/s right side & no further work is going on. 4. Wearing coat over the bridge slab haven’t taken off till now on 22.09.2026
17/100

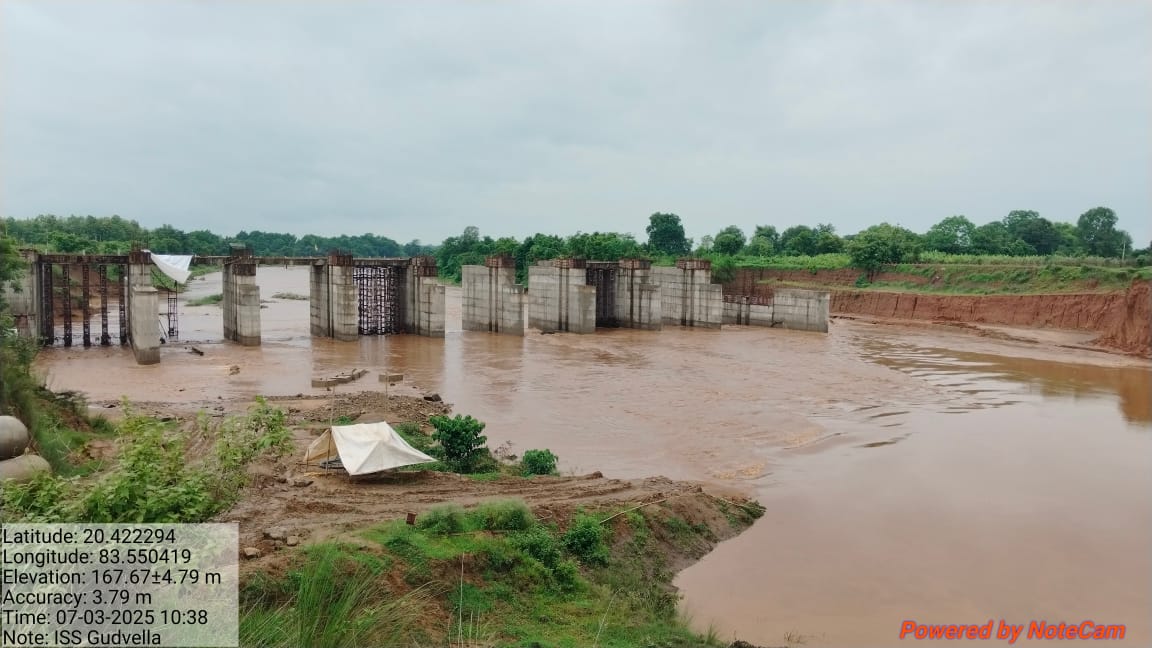

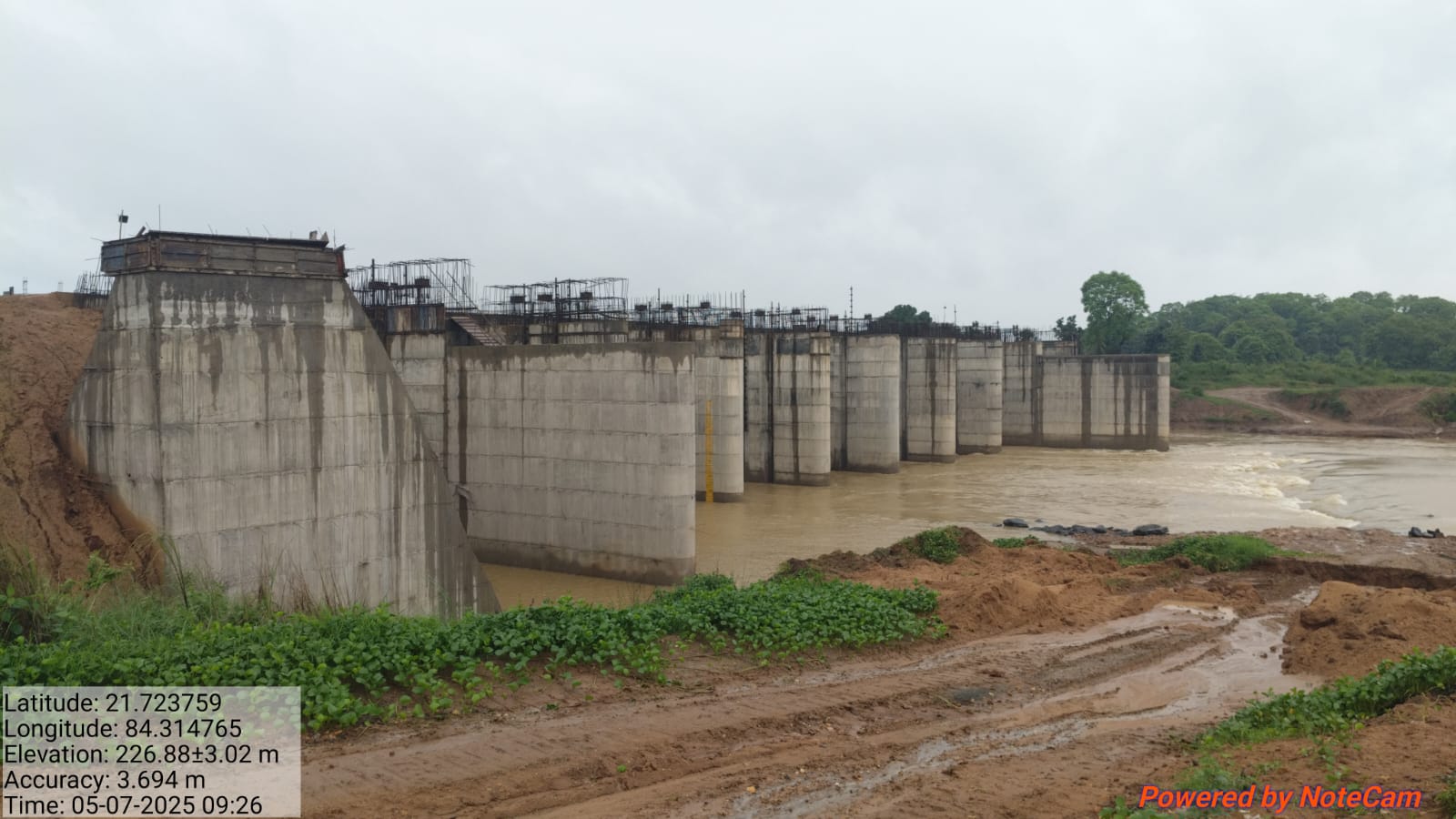

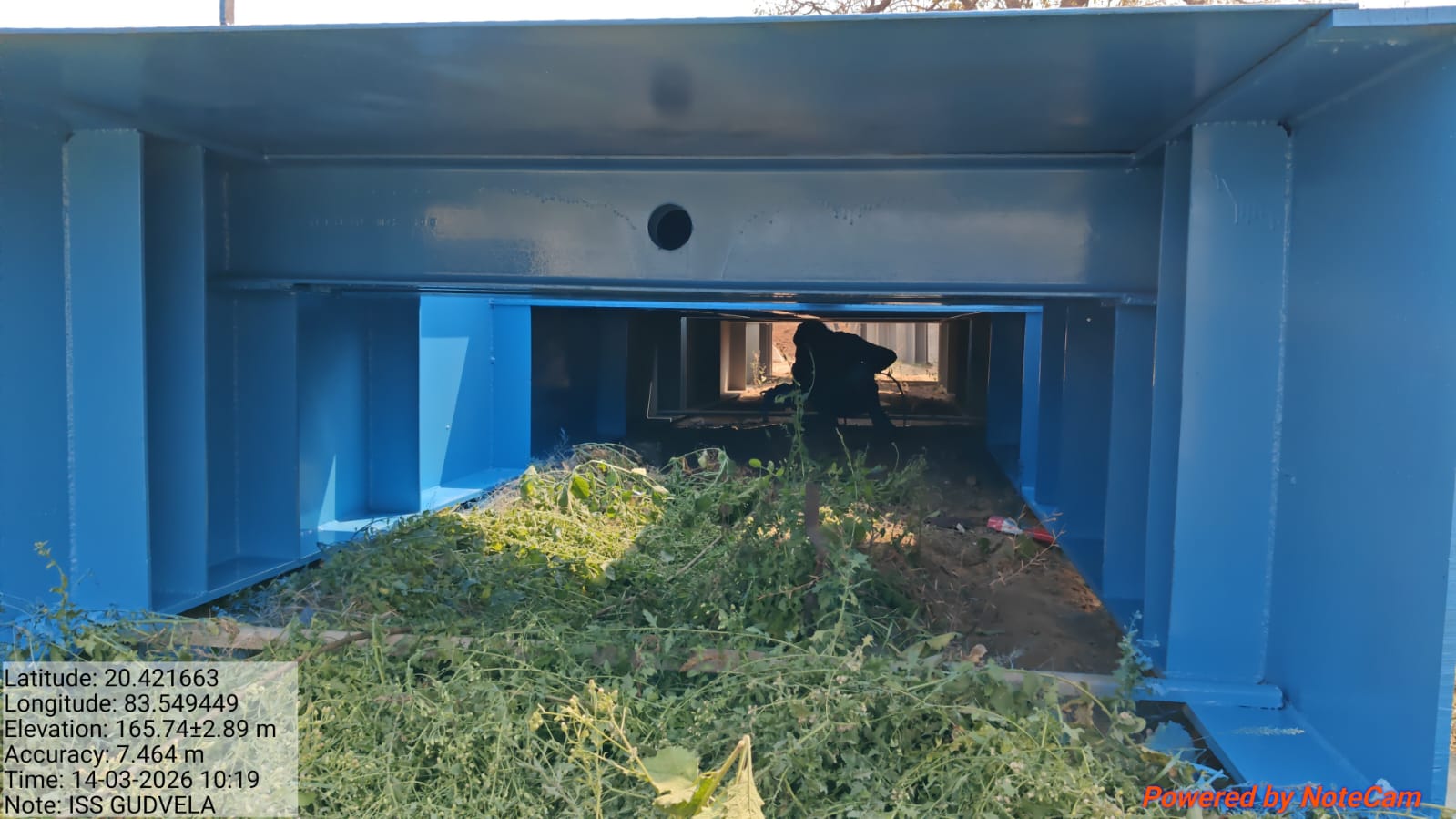

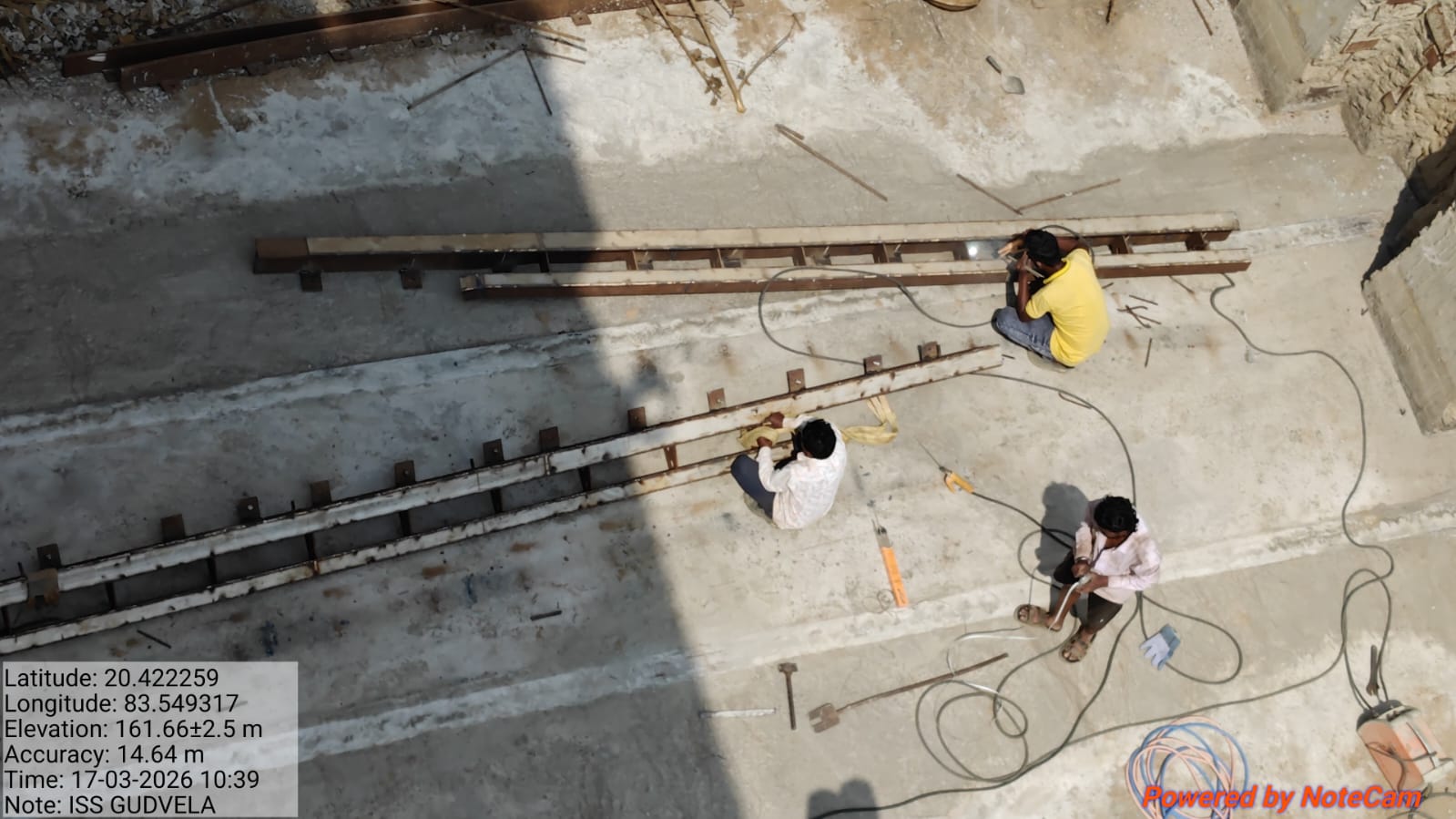

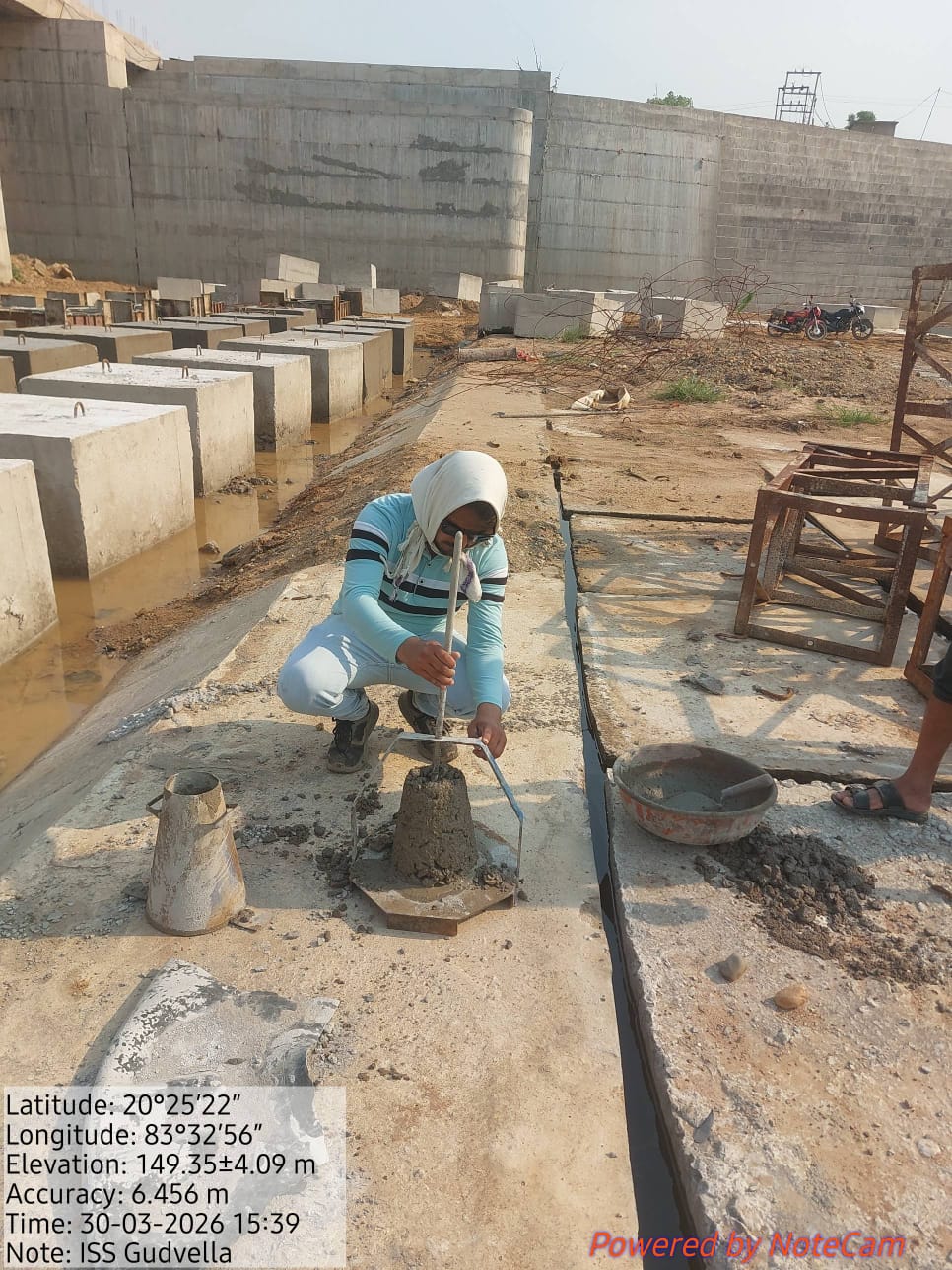

Instream Storage Structure, Gudvella

D/S view of ISS Gudvella on 22.09.2026
18/100
Instream Storage Structure, Gudvella
U/S view of ISS Gudvella on 22.09.2026
19/100

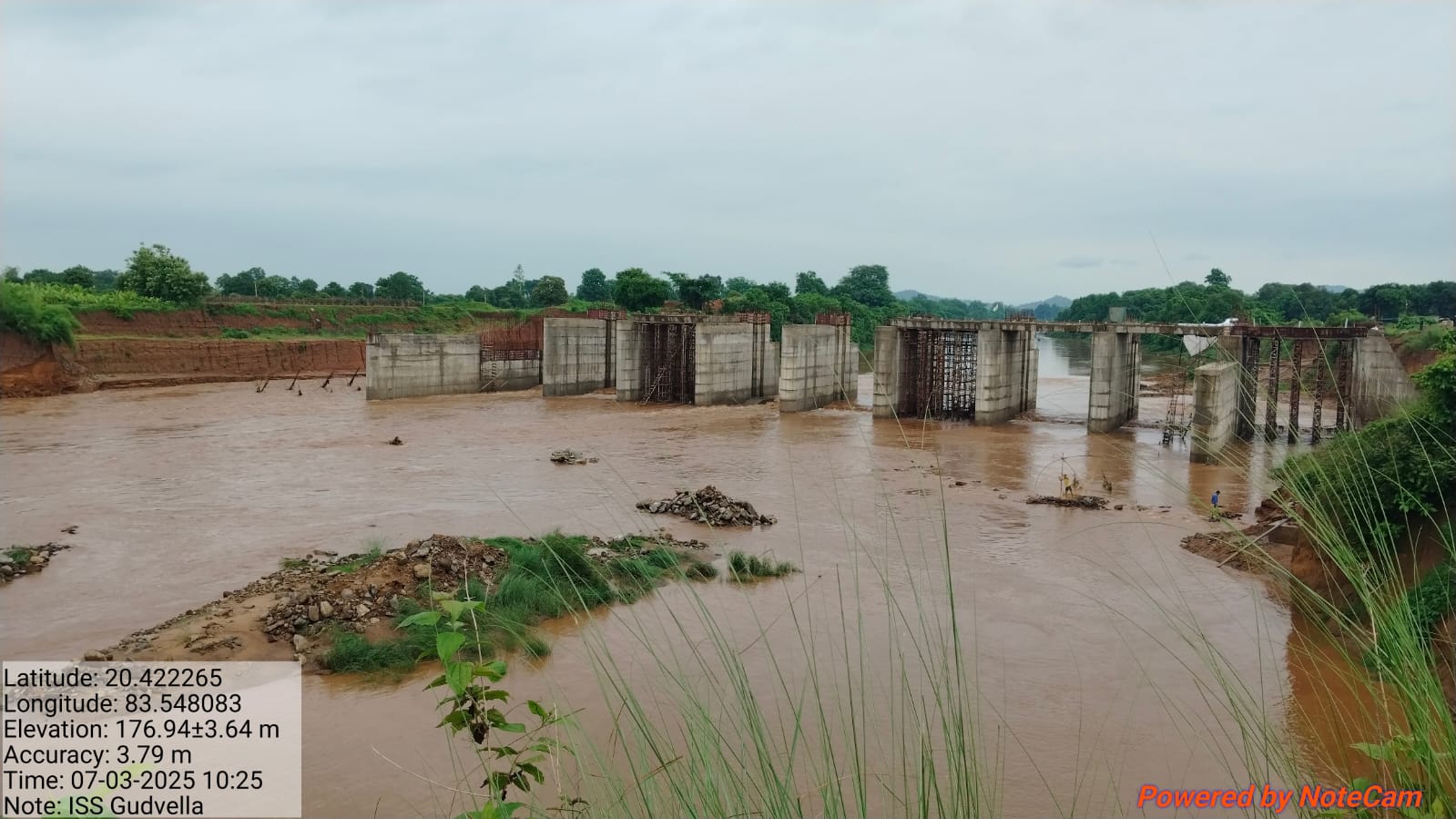

Instream Storage Structure, Gudvella

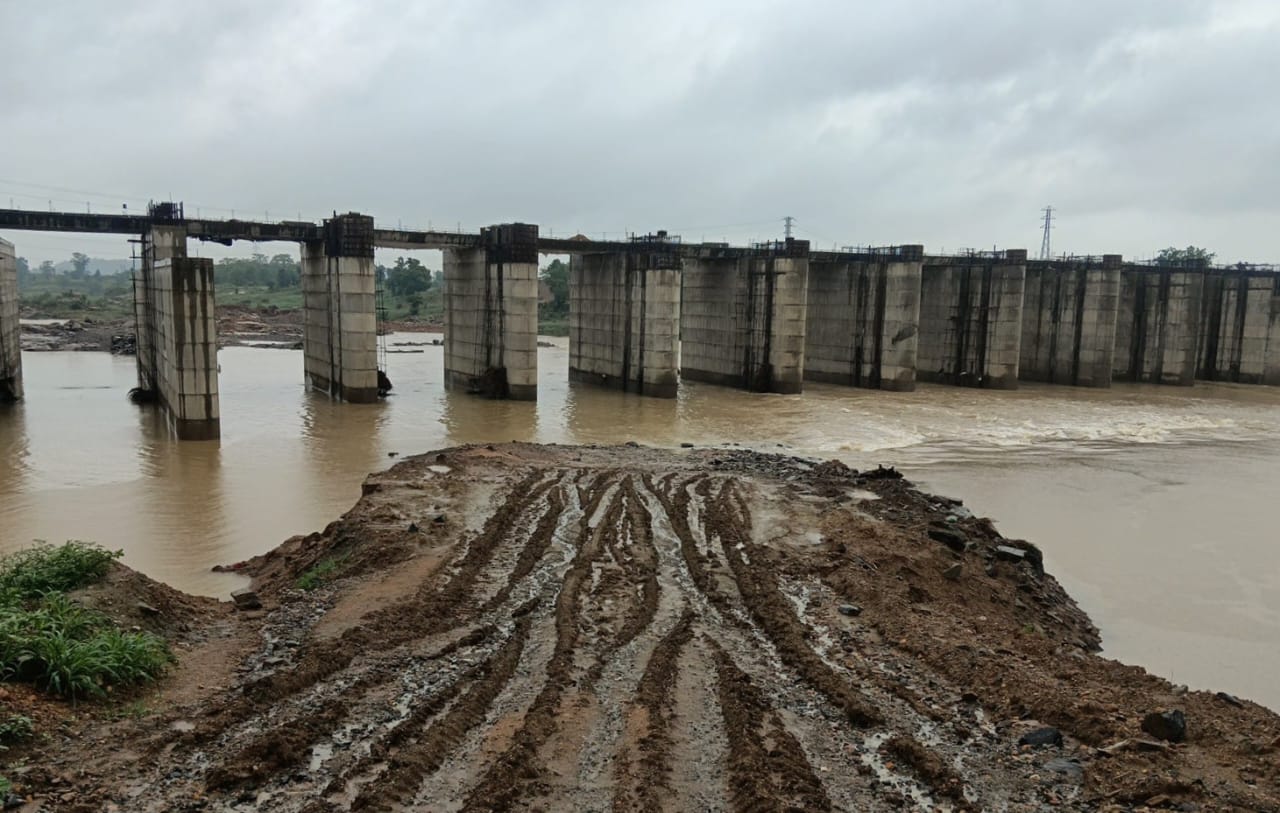

U/S view of ISS Gudvella on 21.09.2026
20/100

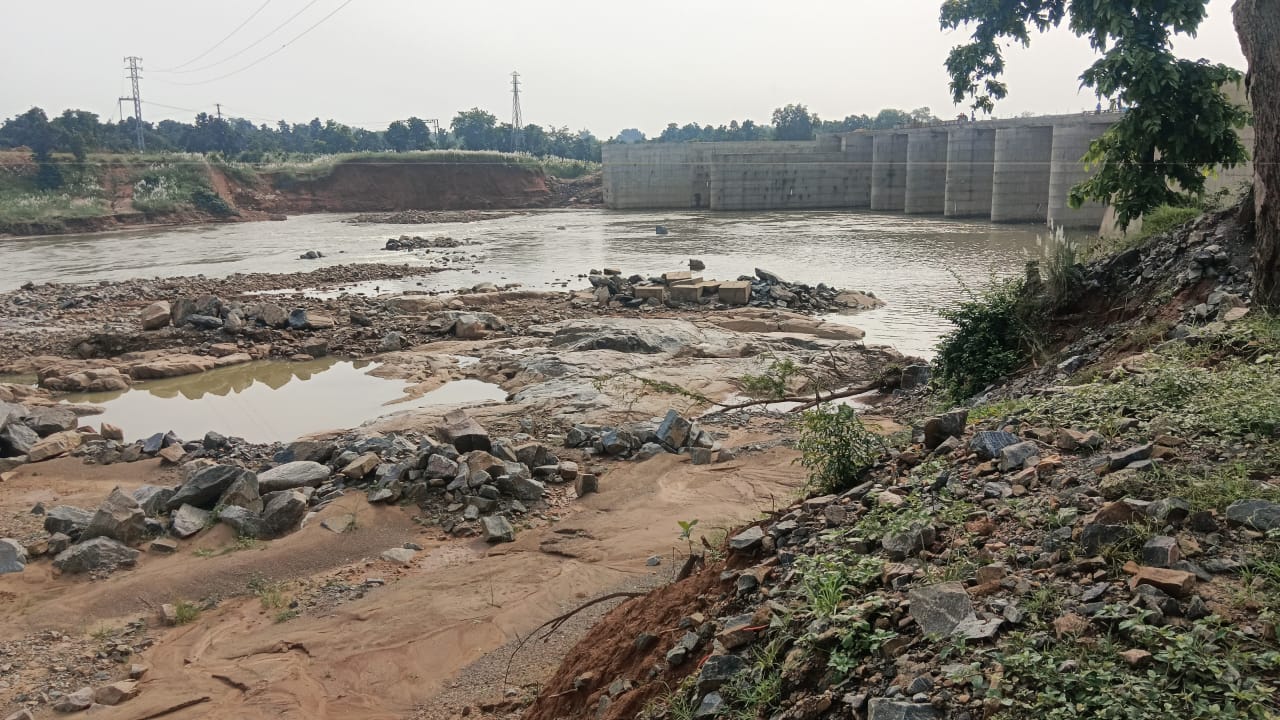

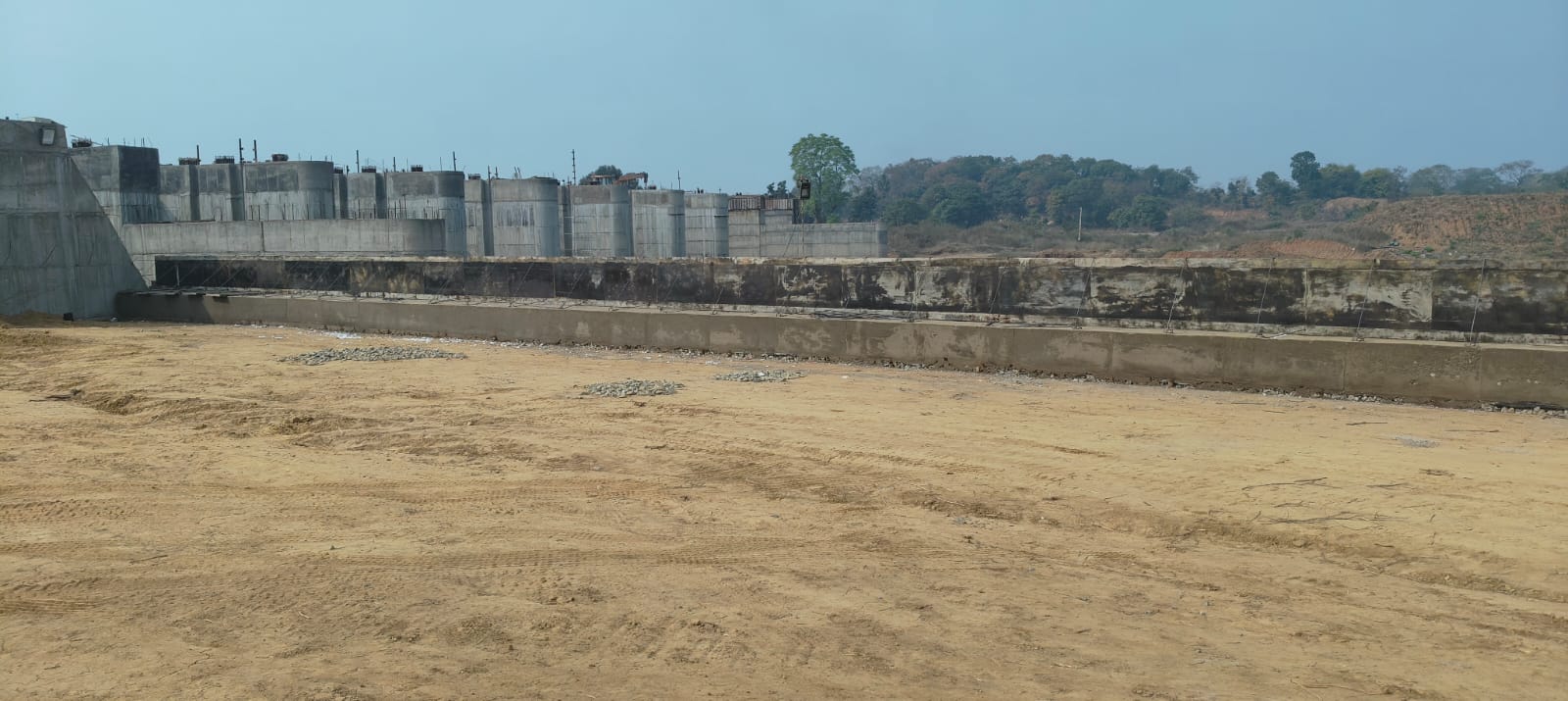

Instream Storage Structure, Gudvella
D/S view of ISS Gudvella on 19.09.2026

21/100

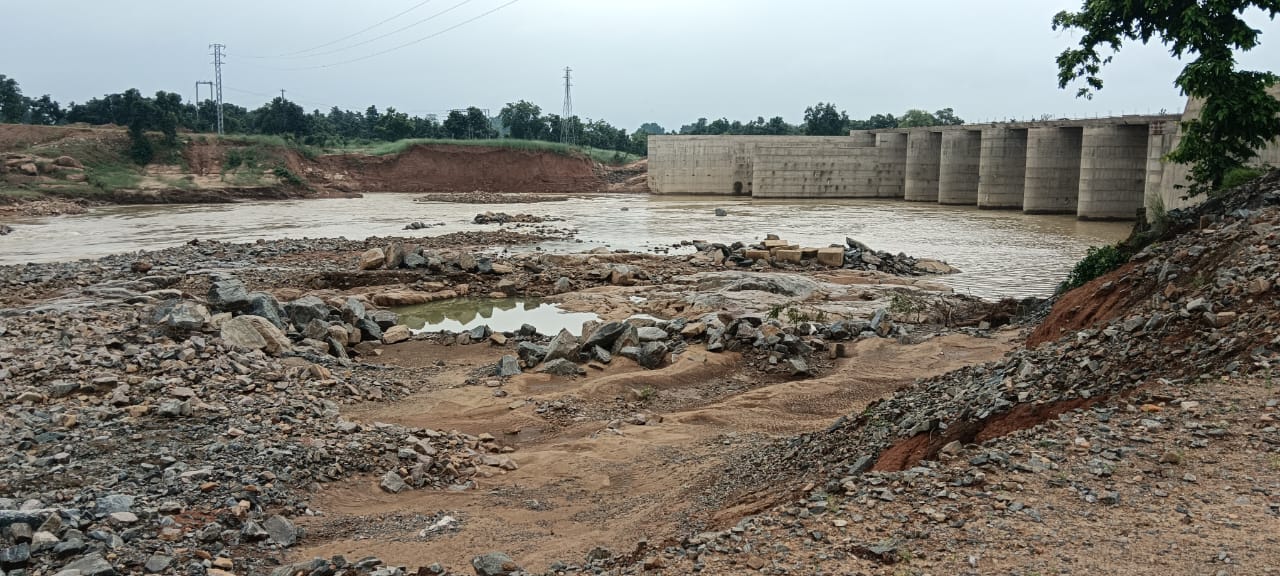

Instream Storage Structure, Gudvella
U/S view of ISS Gudvella on 19.09.2026
22/100

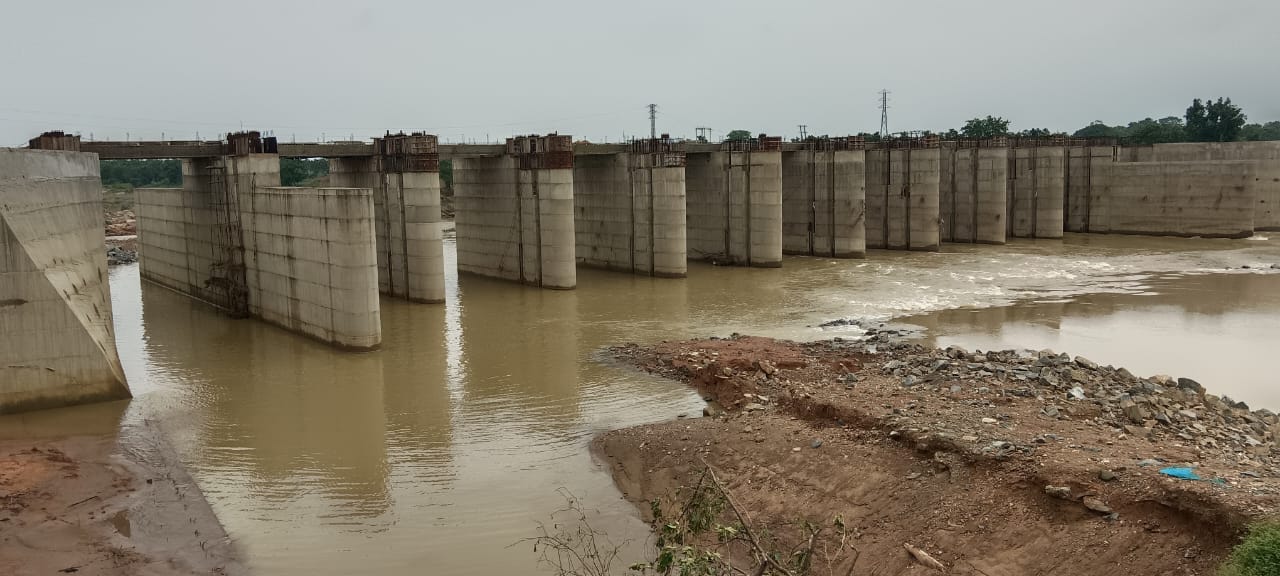

Instream Storage Structure, Gudvella

D/S view of ISS Gudvella on 18.09.2026
23/100
Instream Storage Structure, Gudvella
U/S view of ISS Gudvella on 18.09.2026
24/100
Instream Storage Structure, Gudvella
D/S view of ISS Gudvella on 17.09.2026
25/100
Instream Storage Structure, Gudvella
U/S view of ISS Gudvella on 17.09.2026
26/100
Instream Storage Structure, Gudvella
D/S view of ISS Gudvella on 16.09.2026

27/100
Instream Storage Structure, Gudvella
U/S view of ISS Gudvella on 16.09.2026
28/100
Instream Storage Structure, Gudvella
D/S view of ISS Gudvella on 15.09.2026
29/100
Instream Storage Structure, Gudvella
U/S view of ISS Gudvella on 15.09.2026
30/100
Instream Storage Structure, Gudvella
D/S view of ISS Gudvella on 14.09.2026
31/100
Instream Storage Structure, Gudvella
U/S view of ISS Gudvella on 14.09.2026
32/100
Instream Storage Structure, Gudvella

D/S view of ISS Gudvella on 13.09.2026
33/100
Instream Storage Structure, Gudvella
U/S view of ISS Gudvella on 13.09.2026
34/100
Instream Storage Structure, Gudvella
D/S view of ISS Gudvella on 11.09.2026

35/100
Instream Storage Structure, Gudvella

U/S view of ISS Gudvella on 11.09.2026
36/100

Instream Storage Structure, Hamirpur

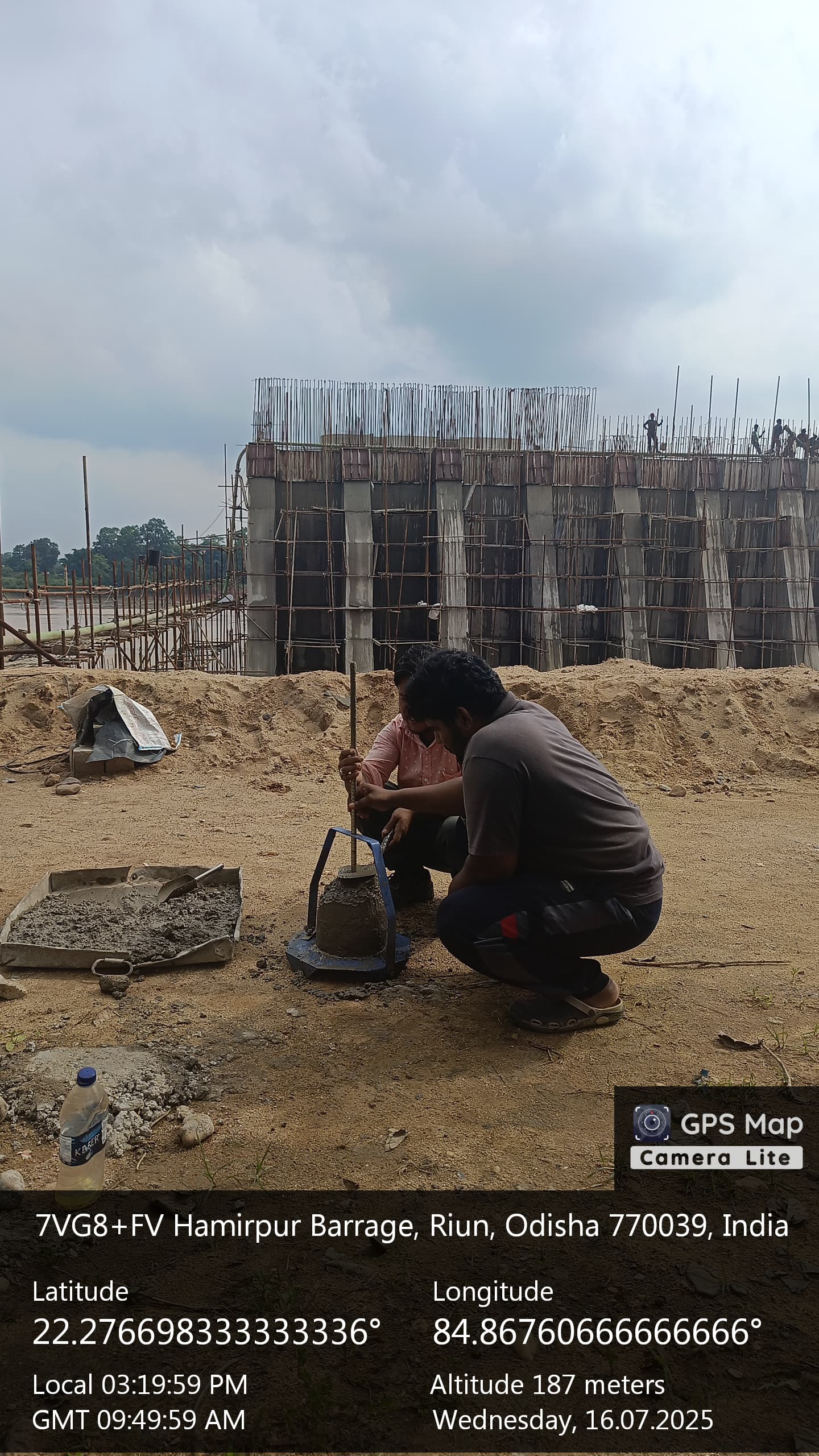

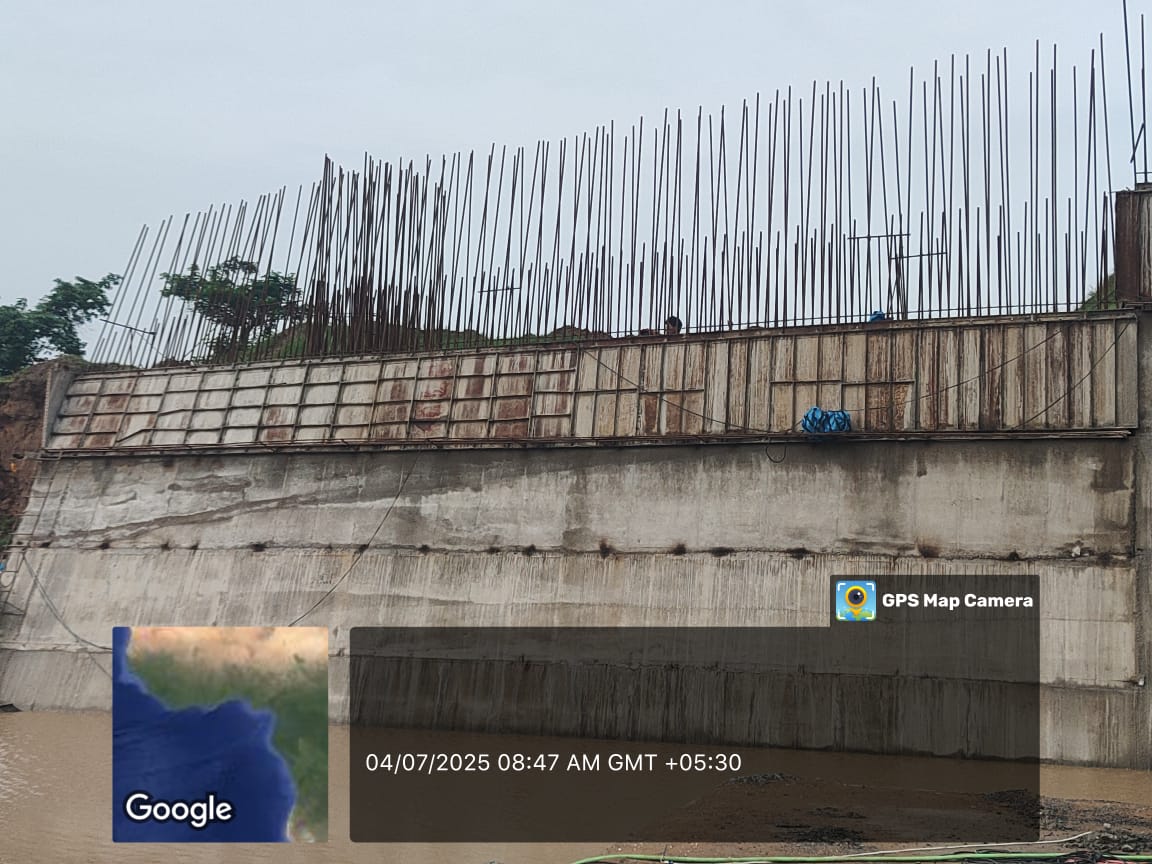

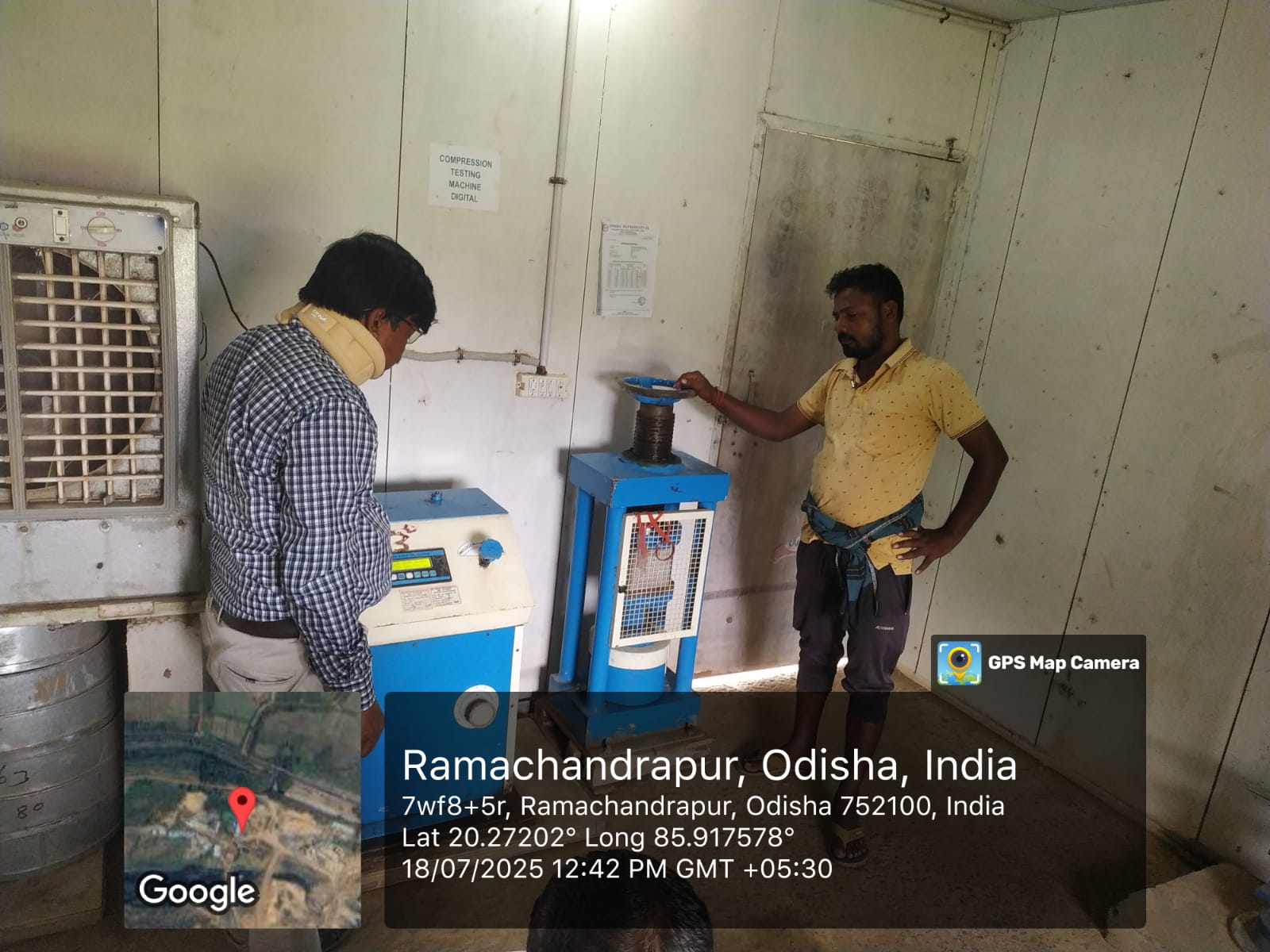

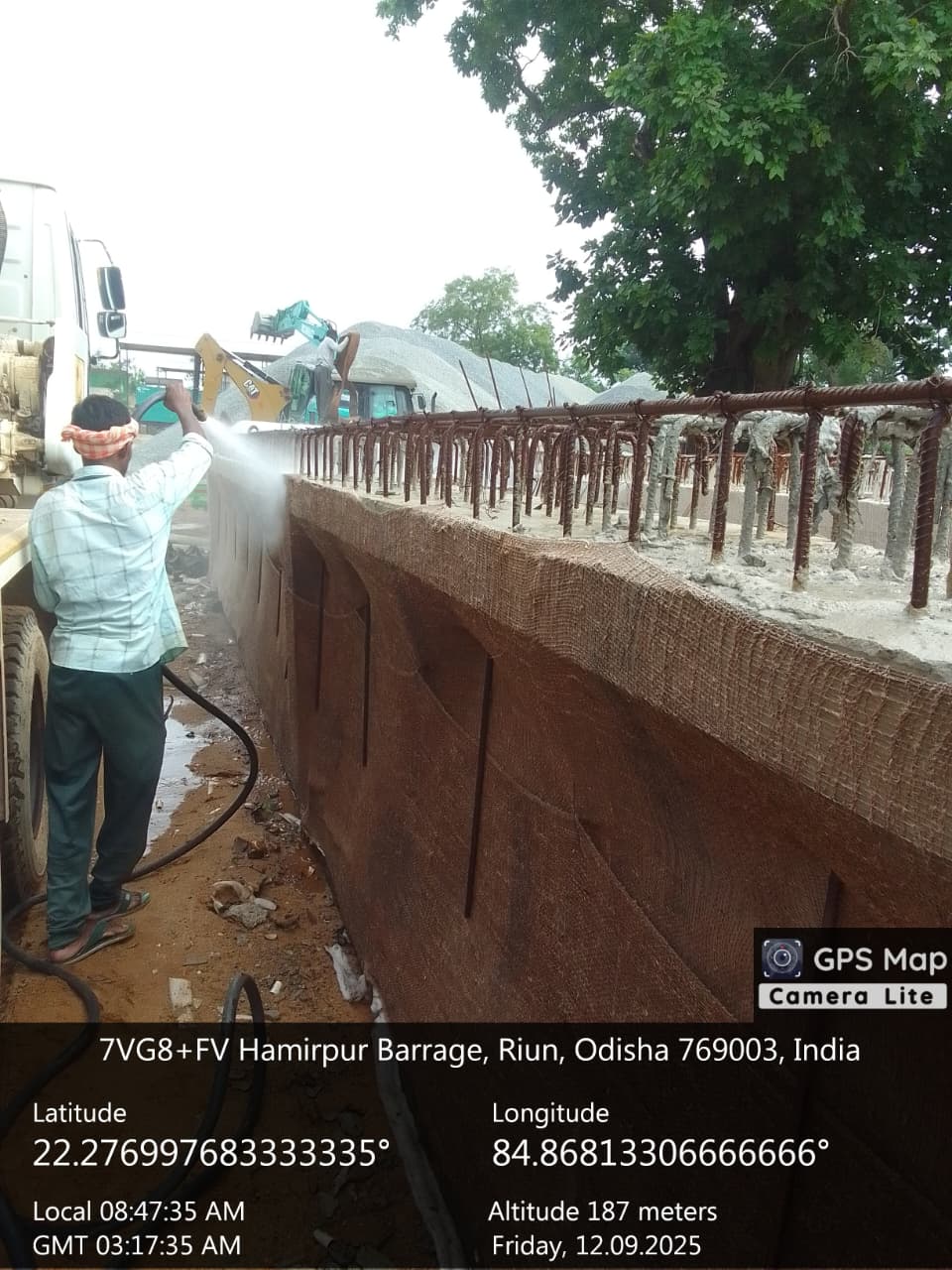

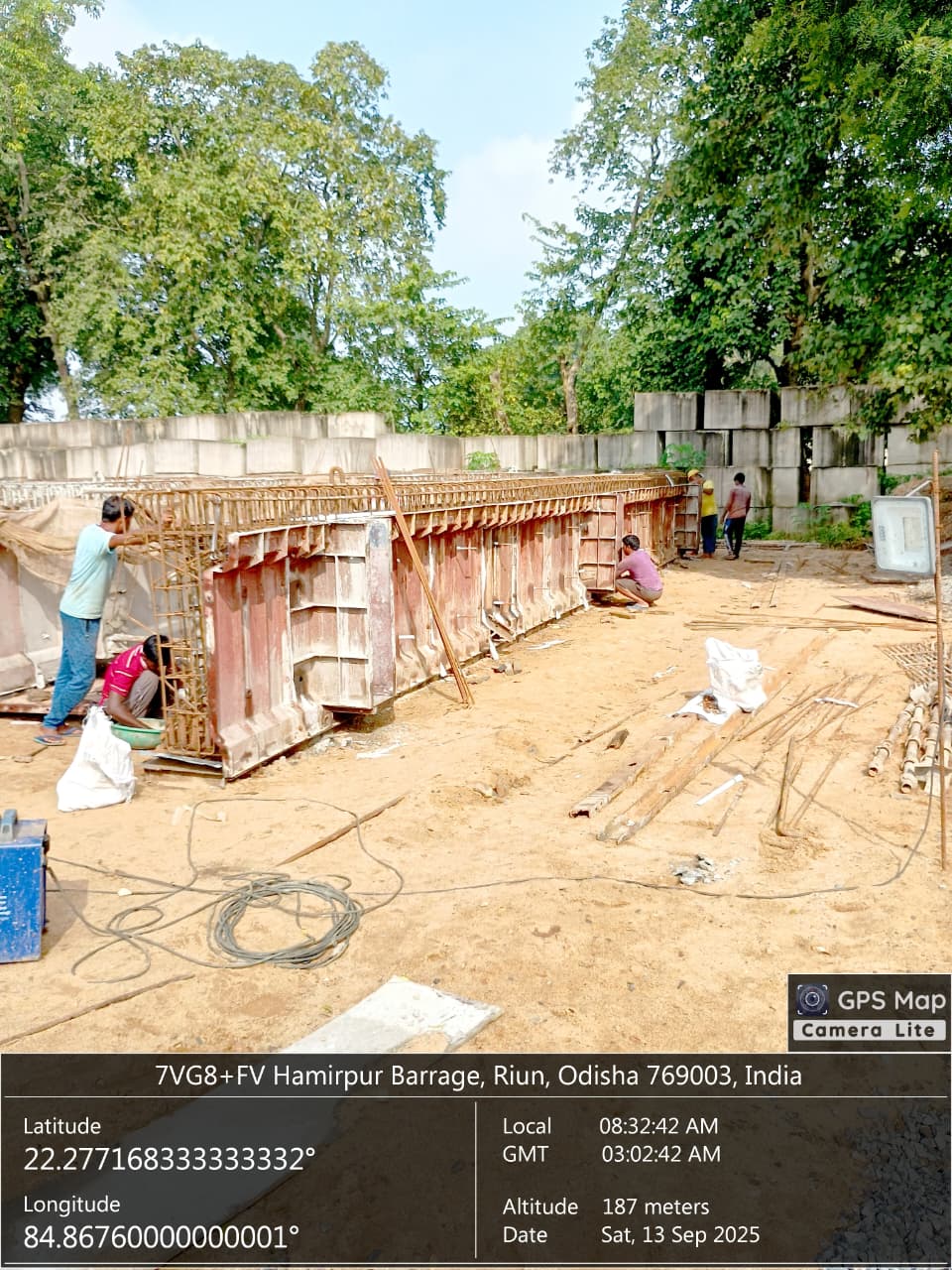

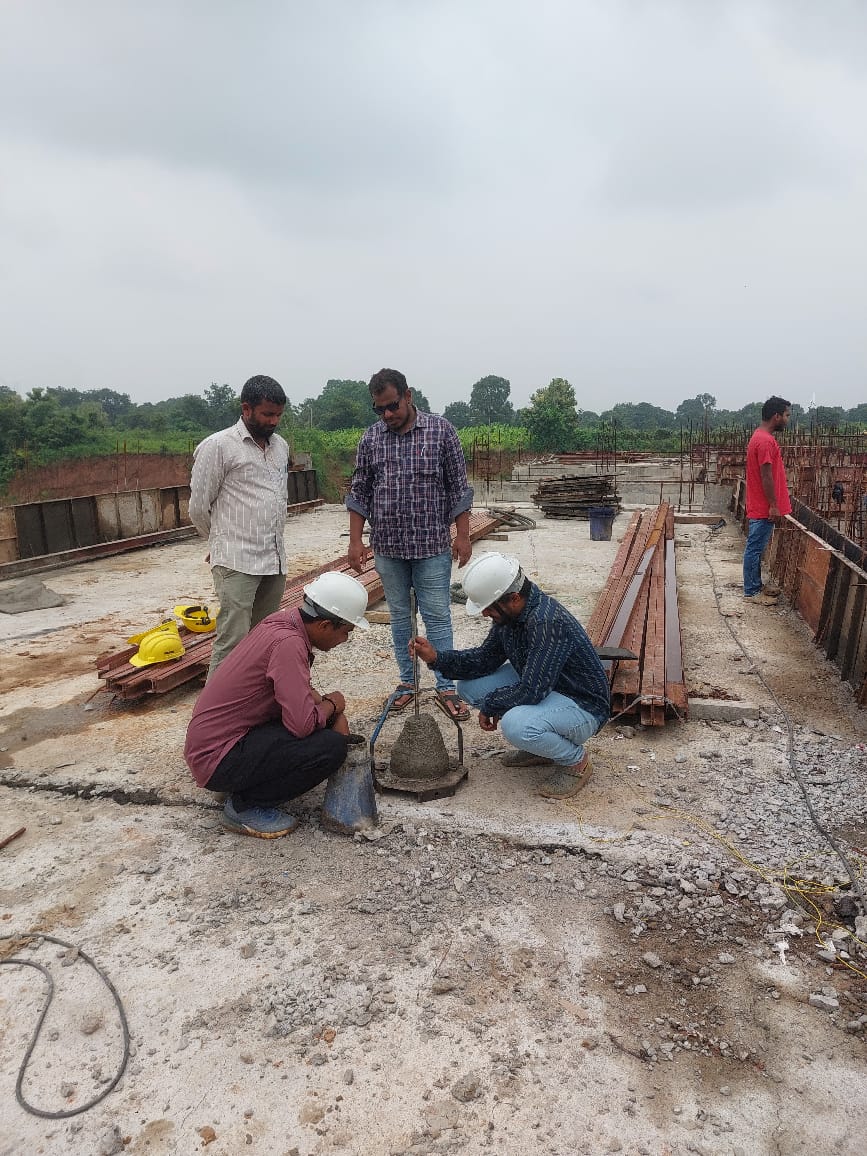

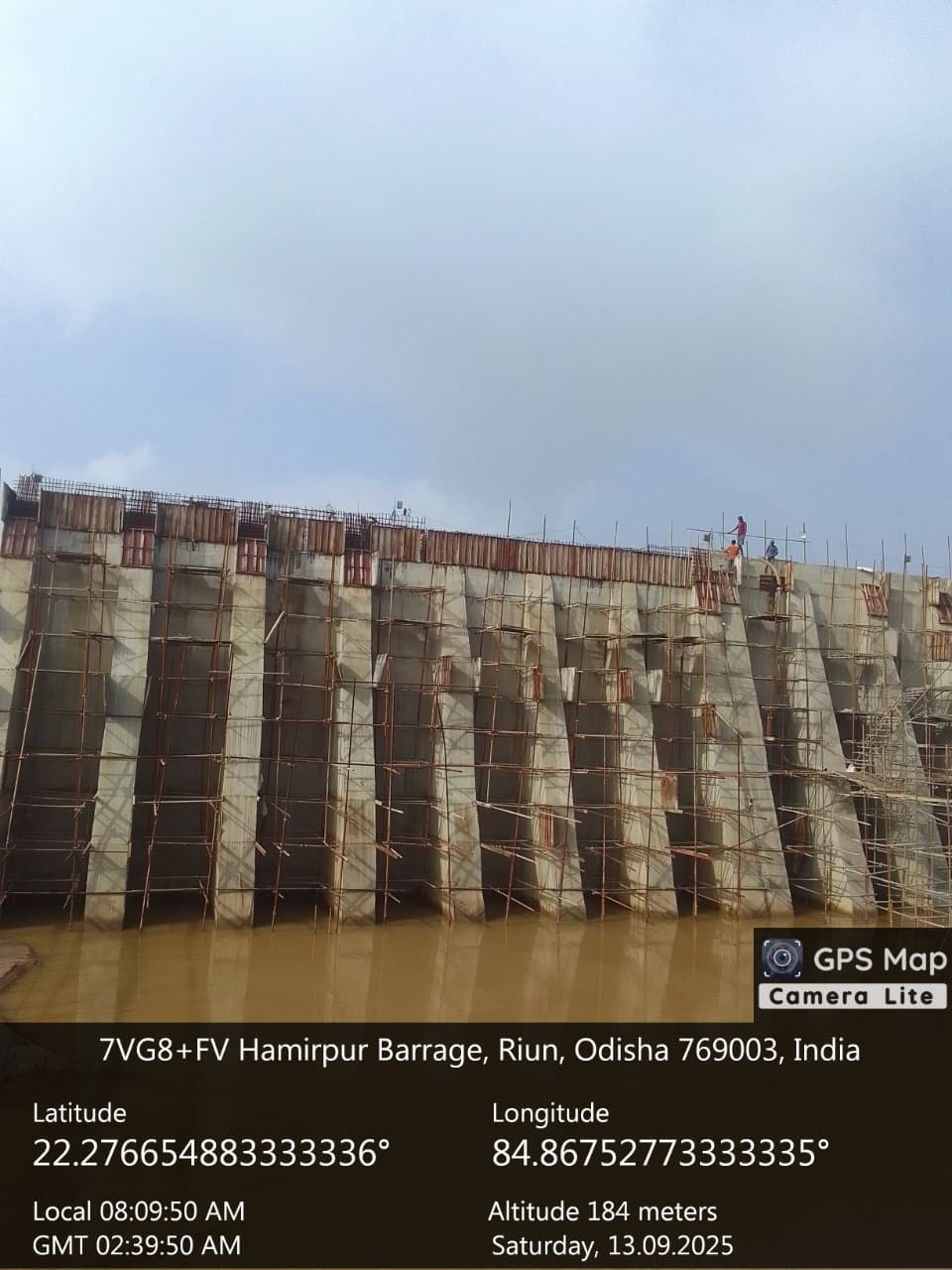

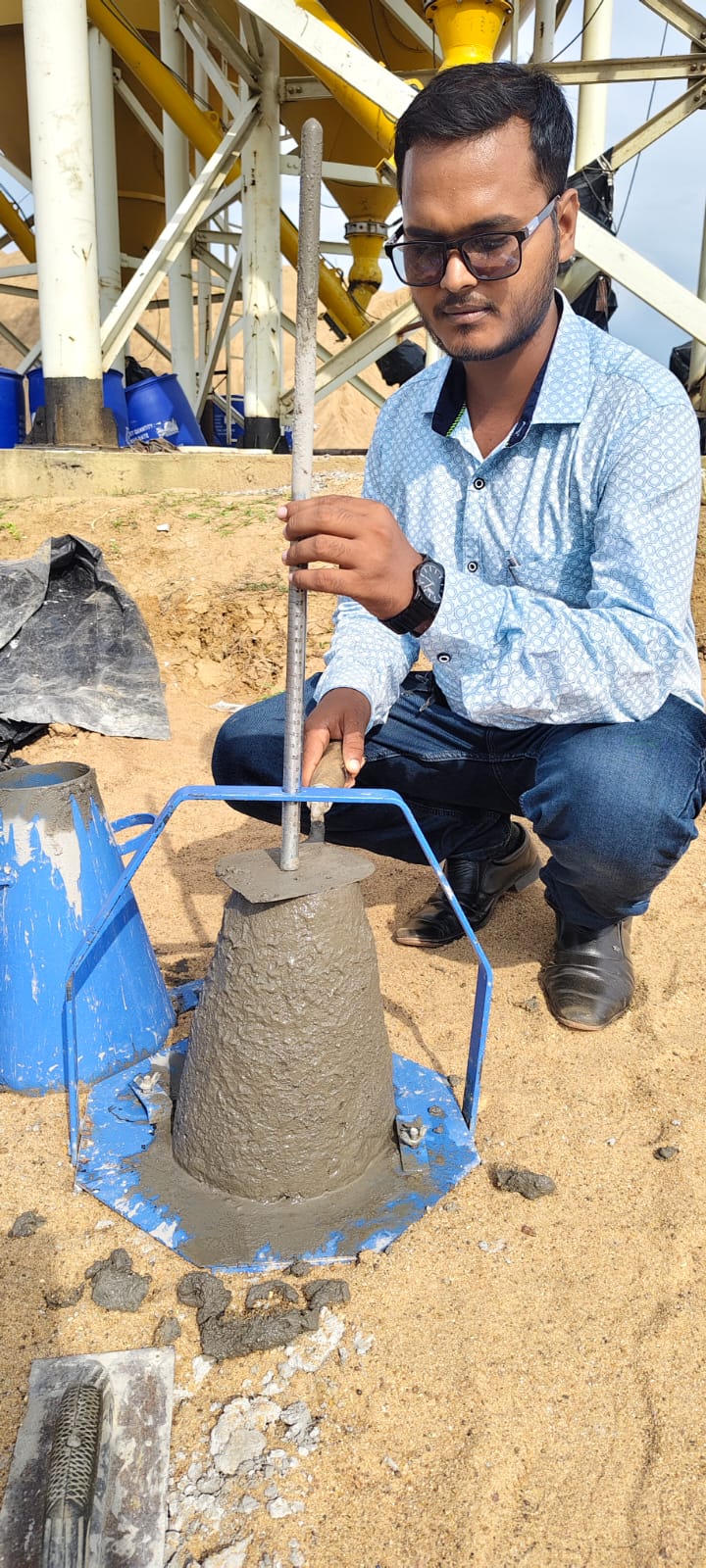

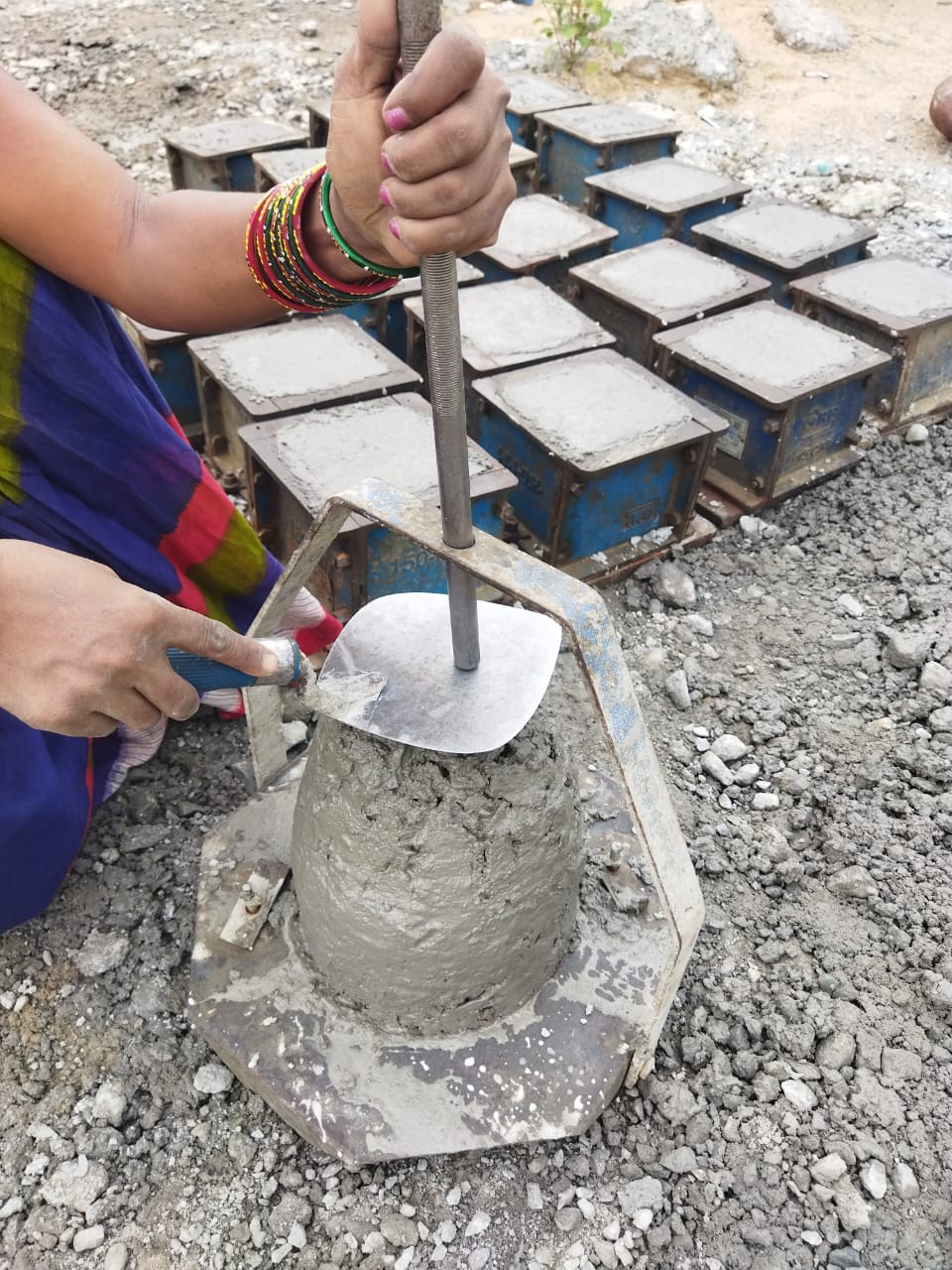

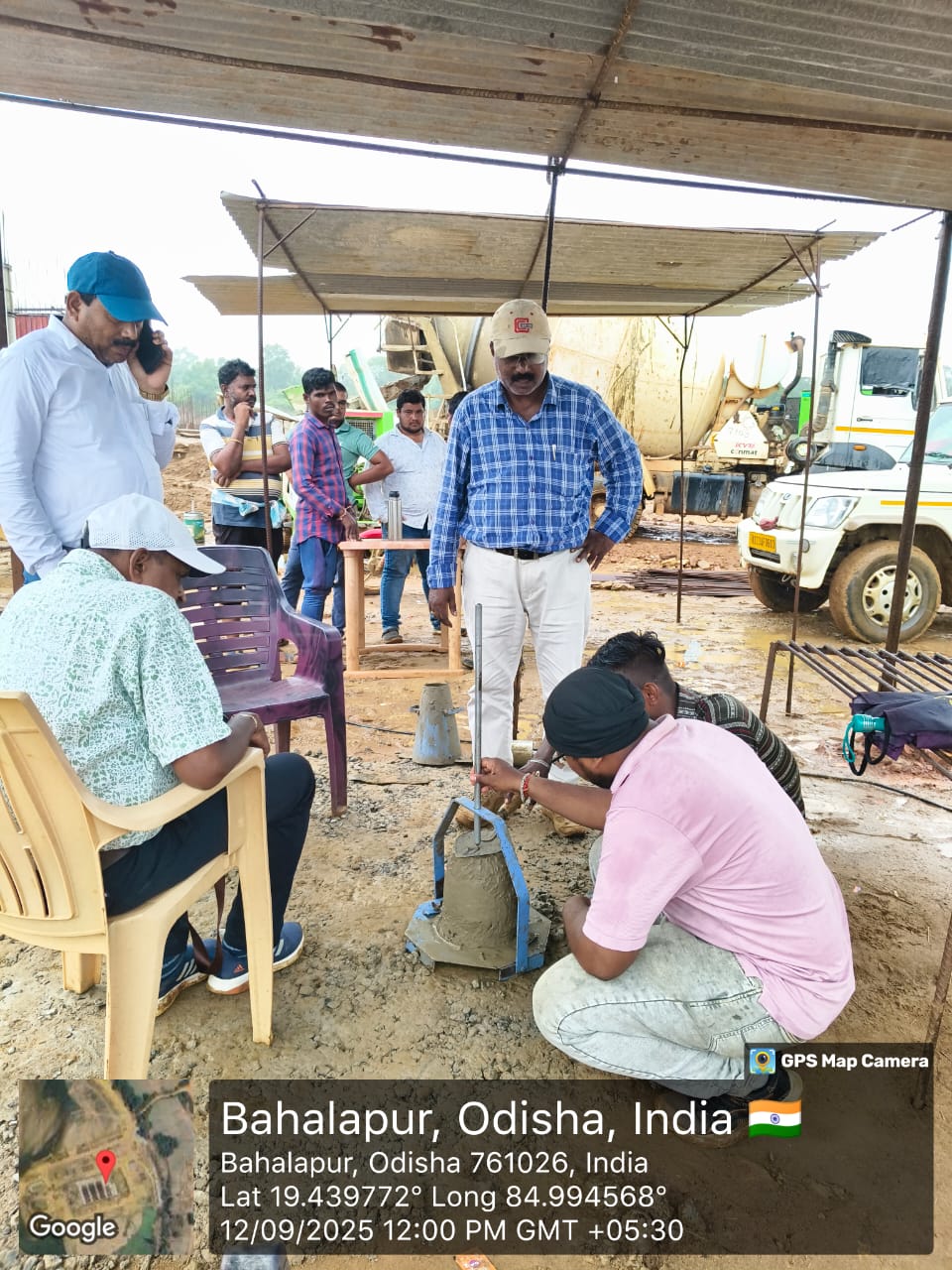

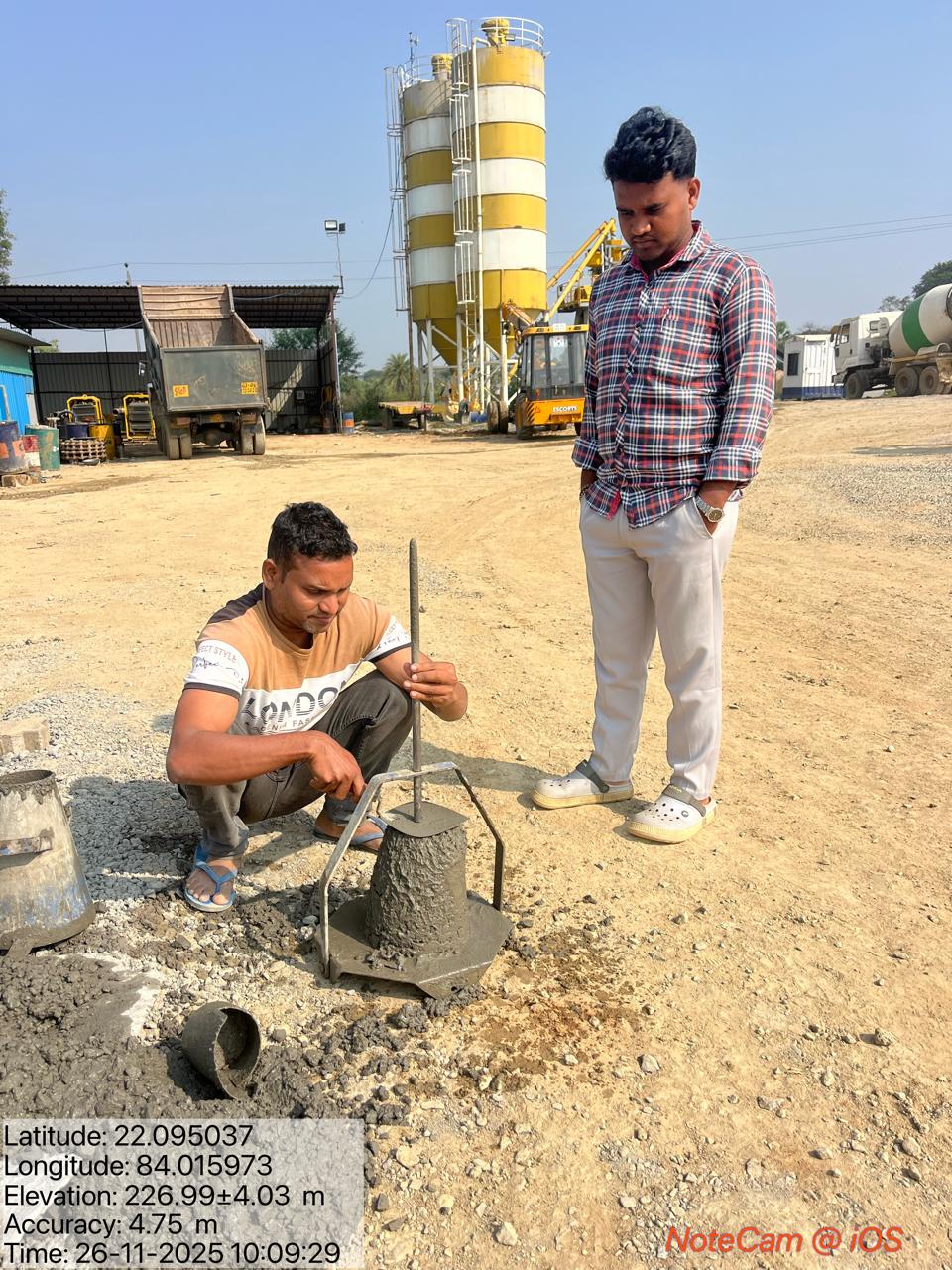

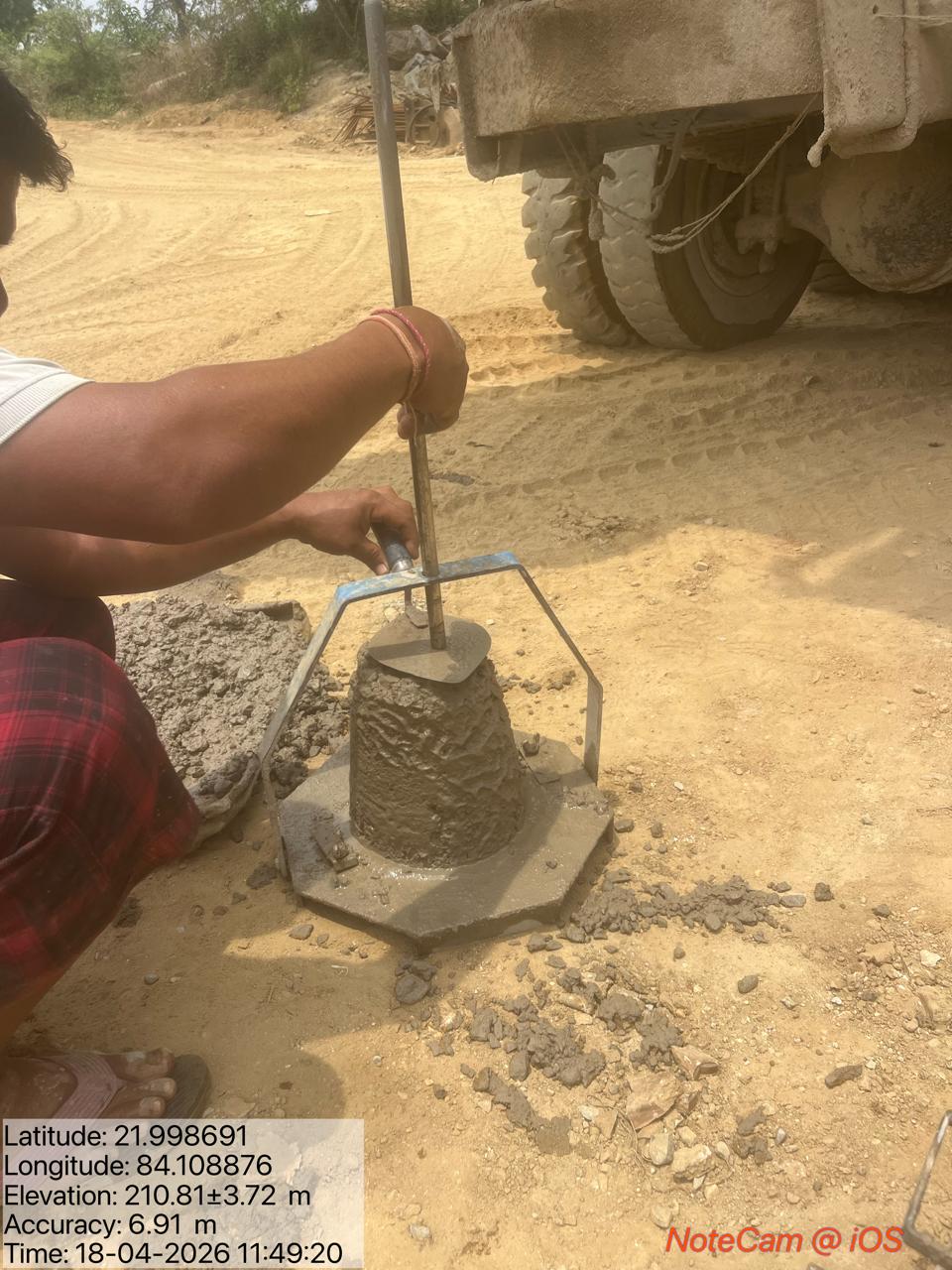

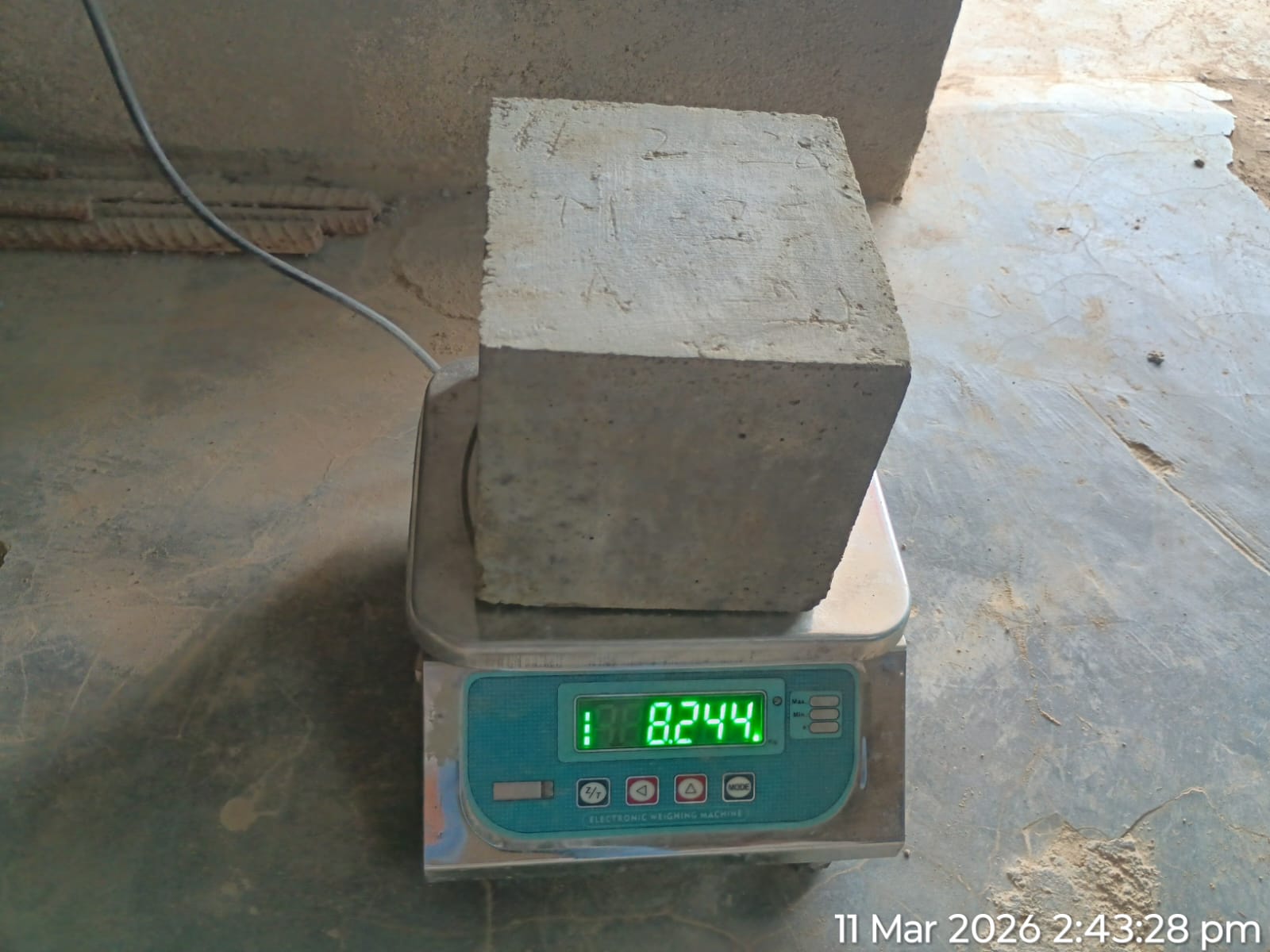

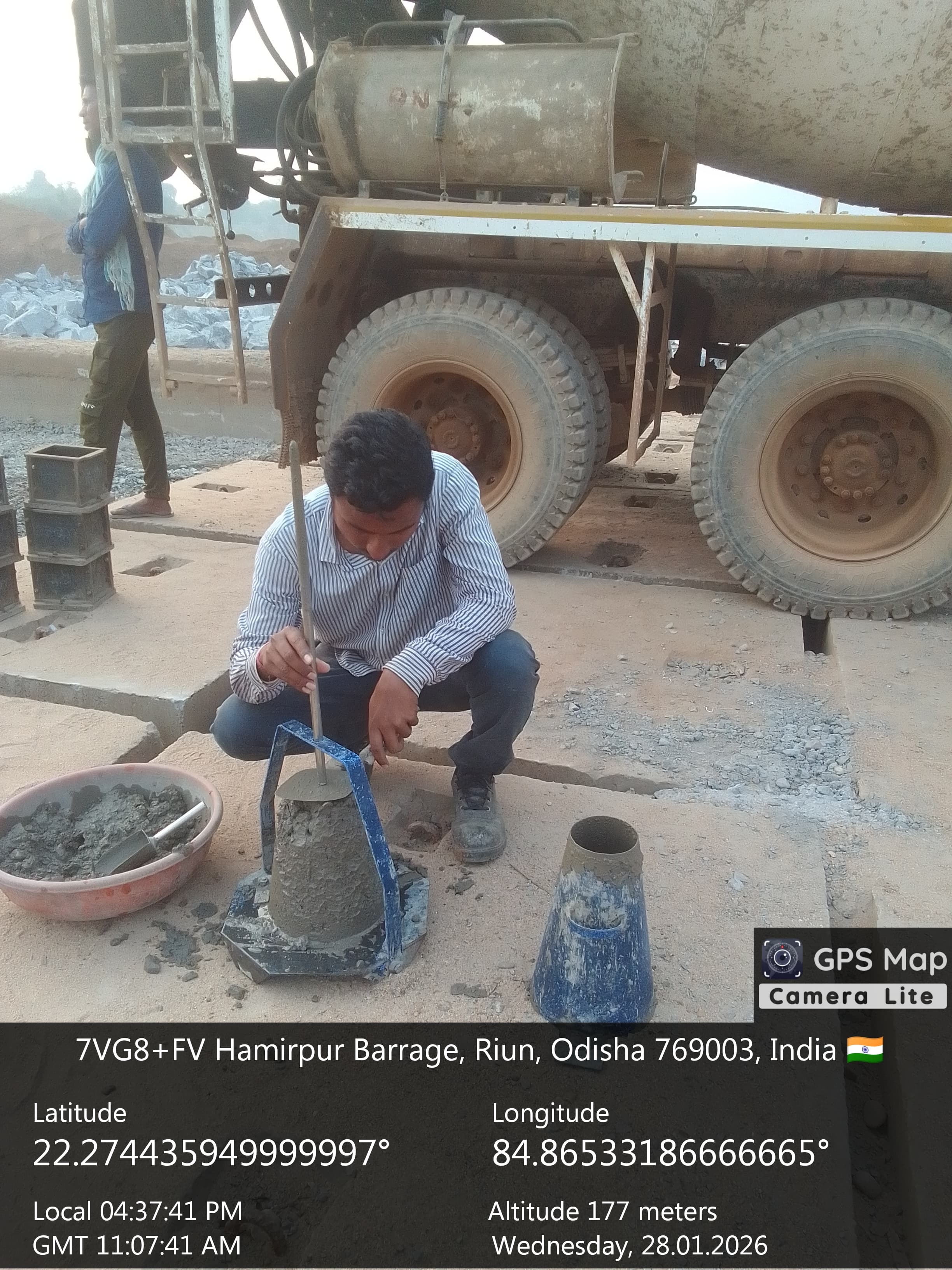

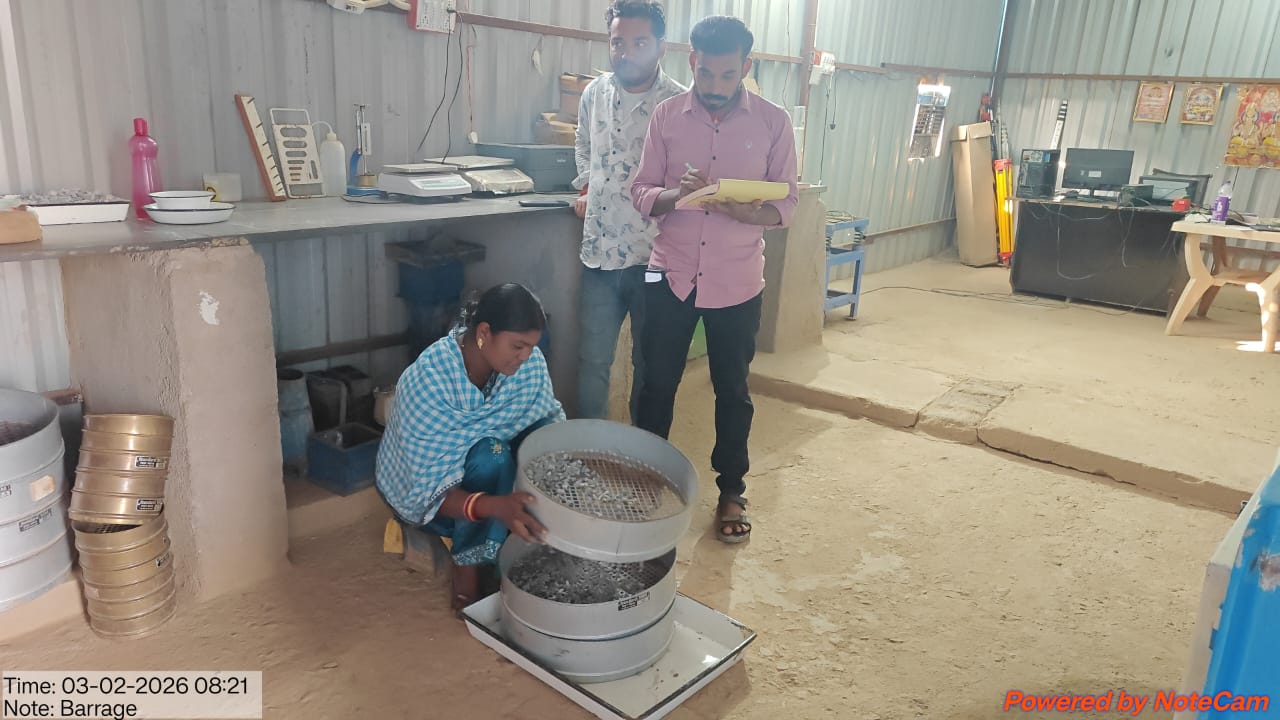

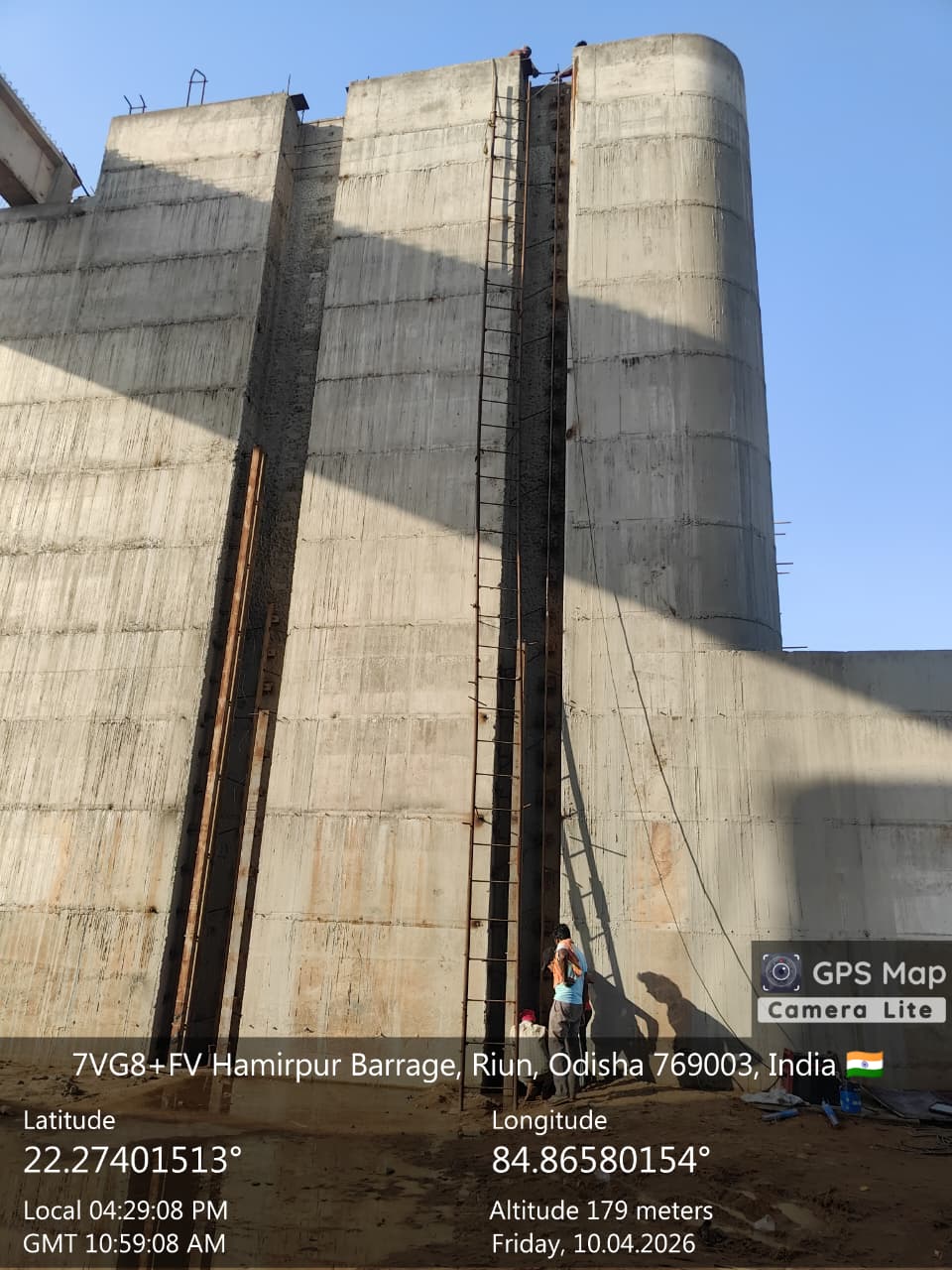

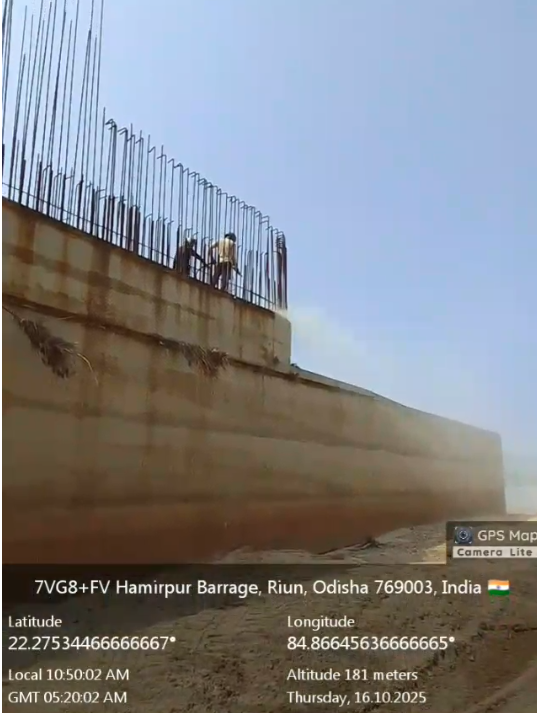

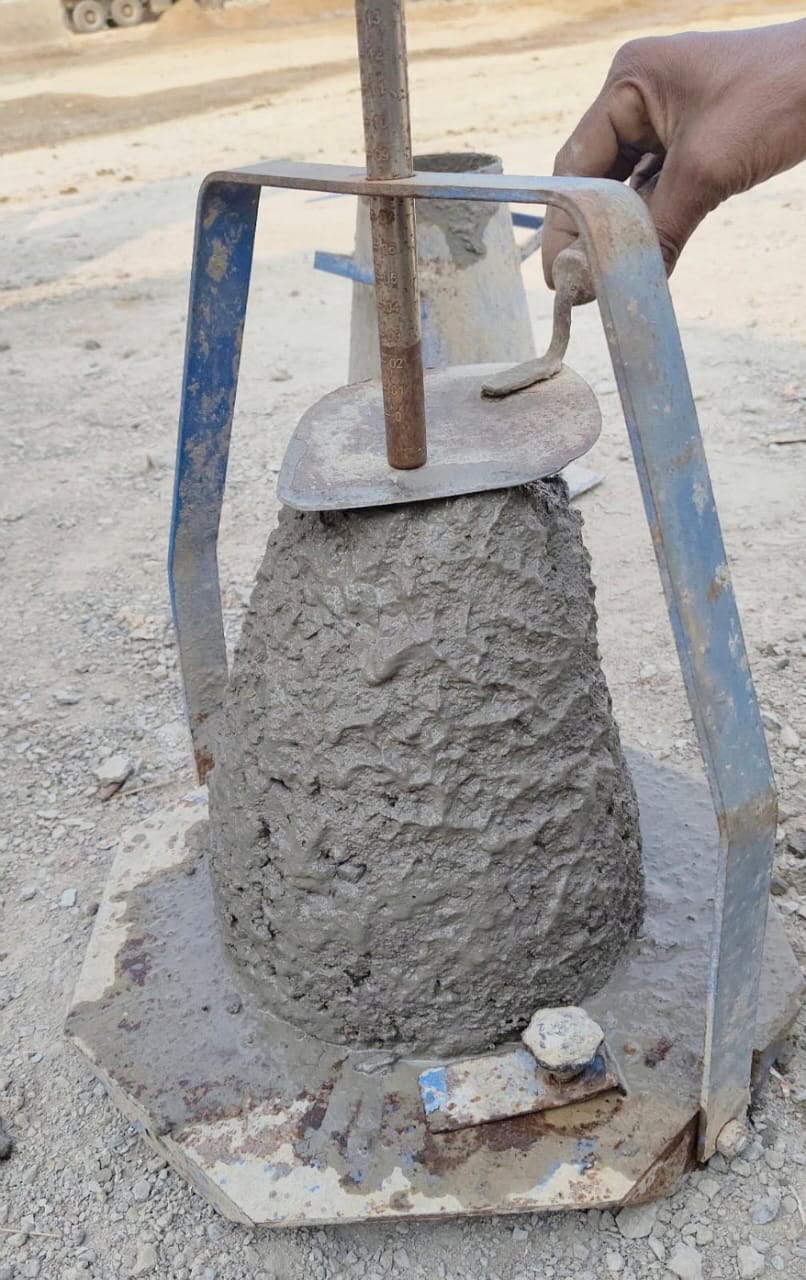

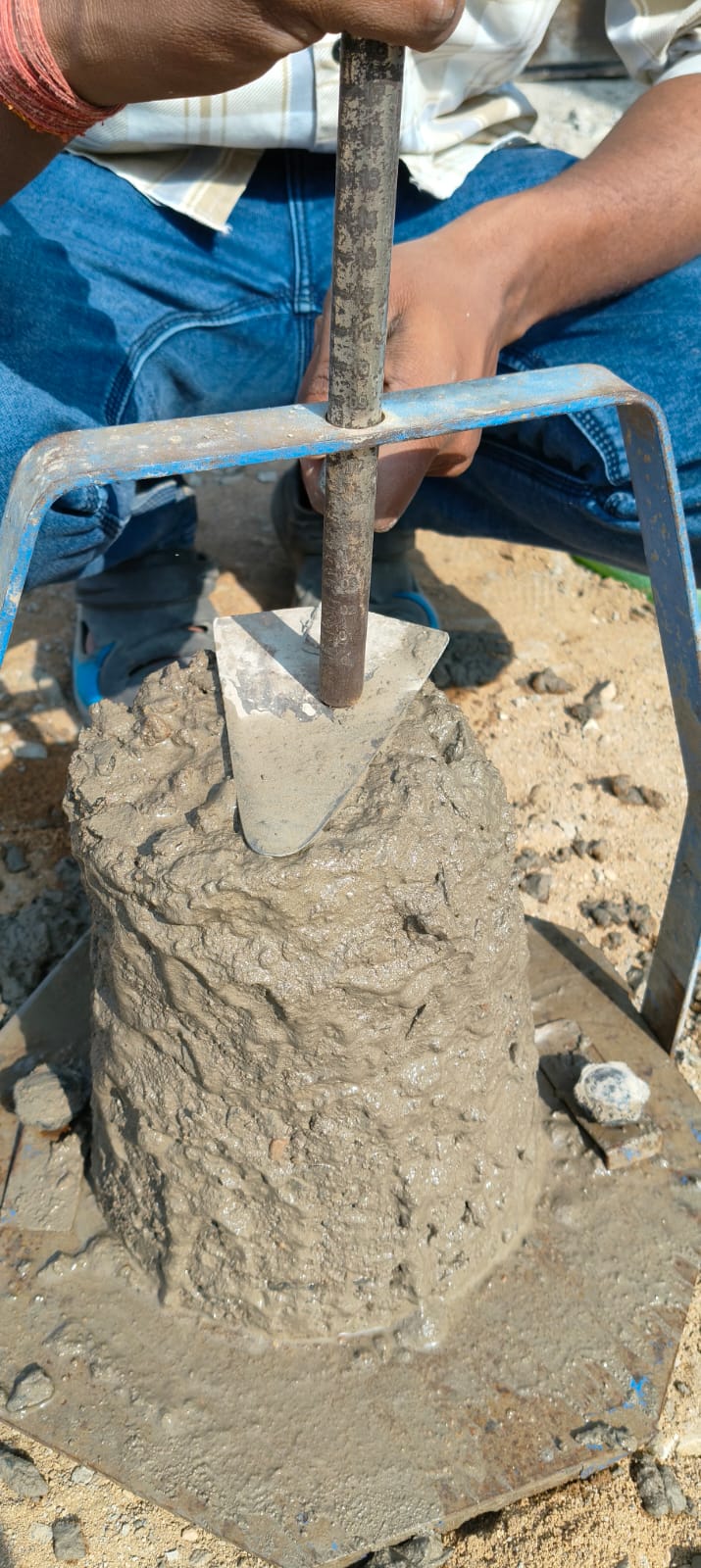

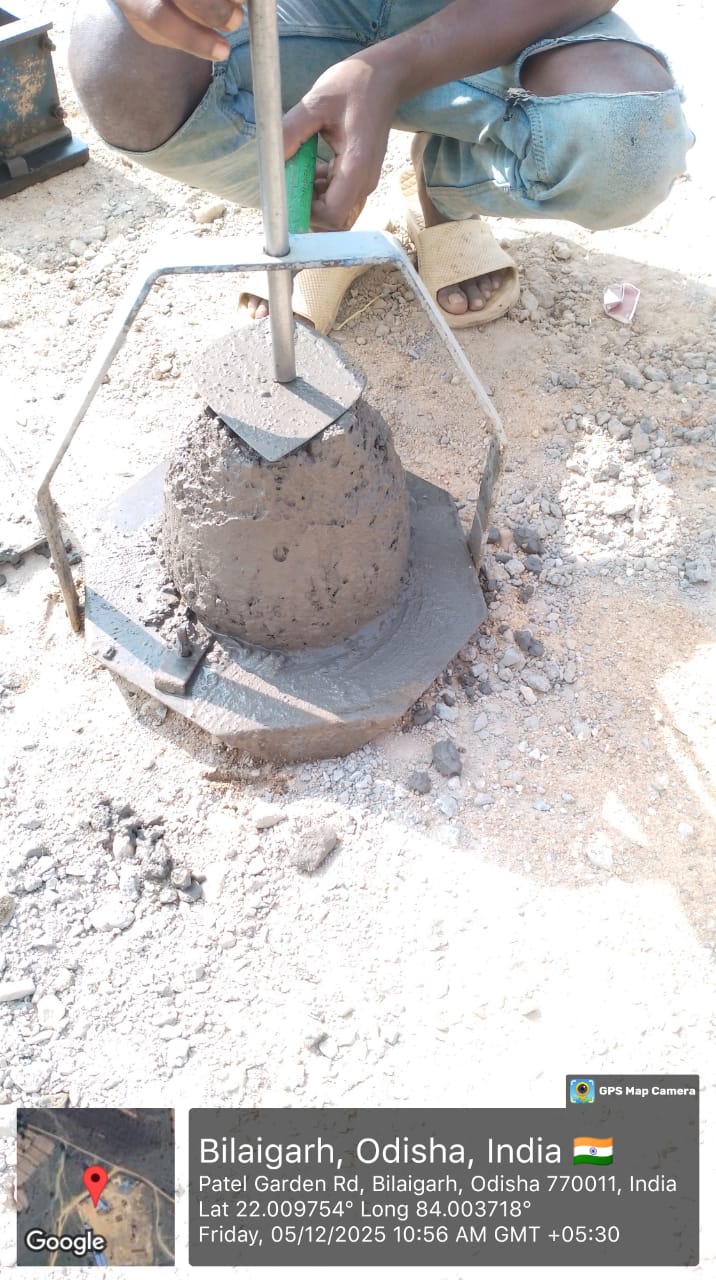

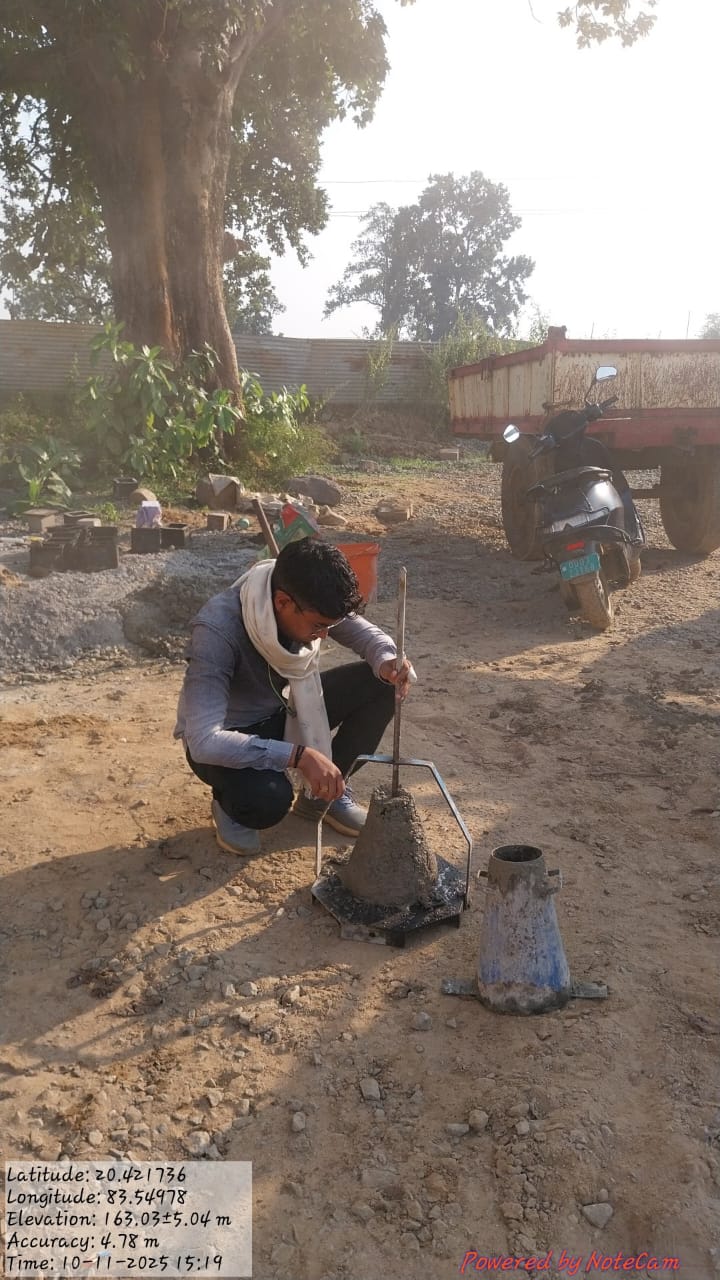

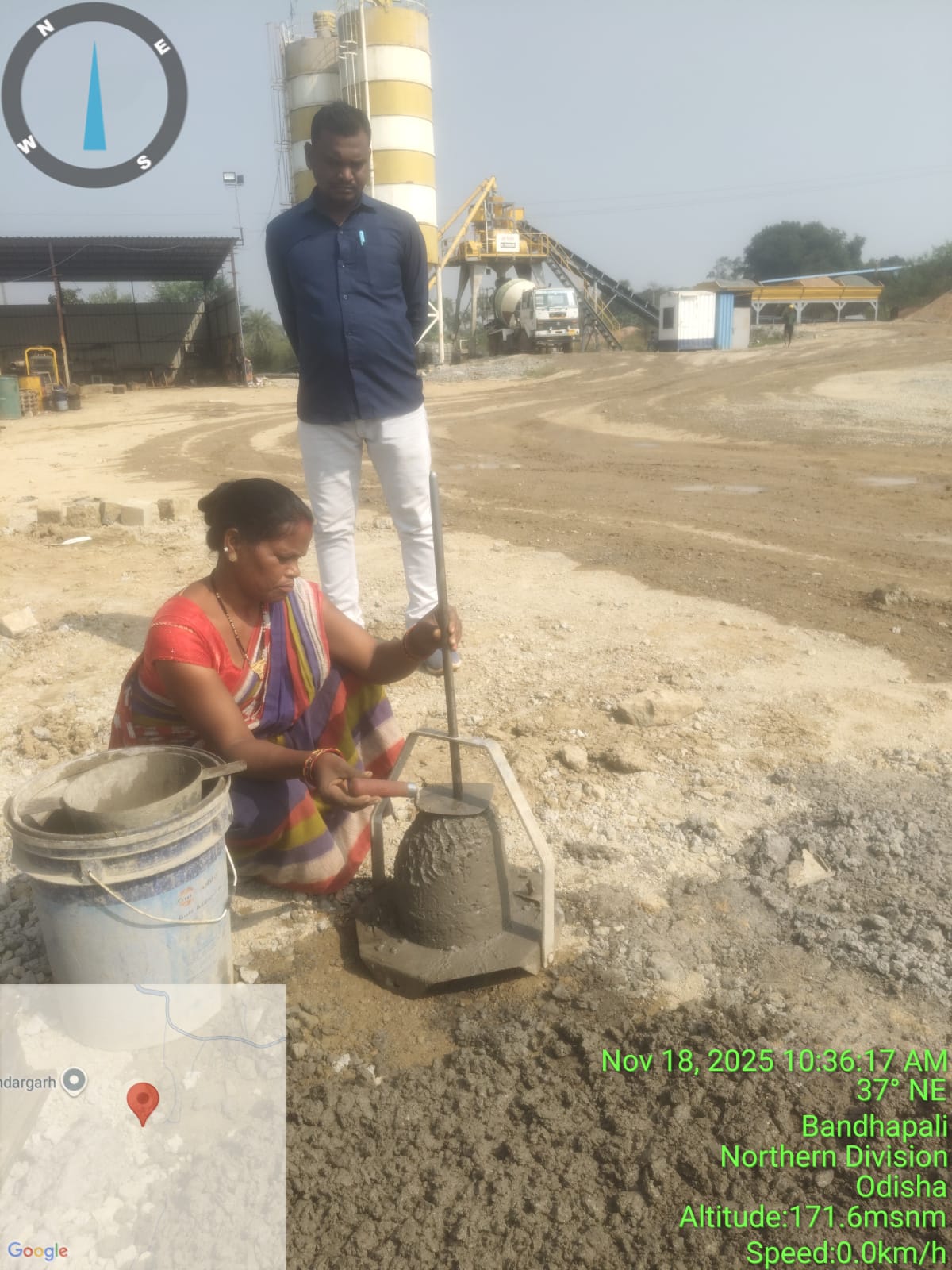

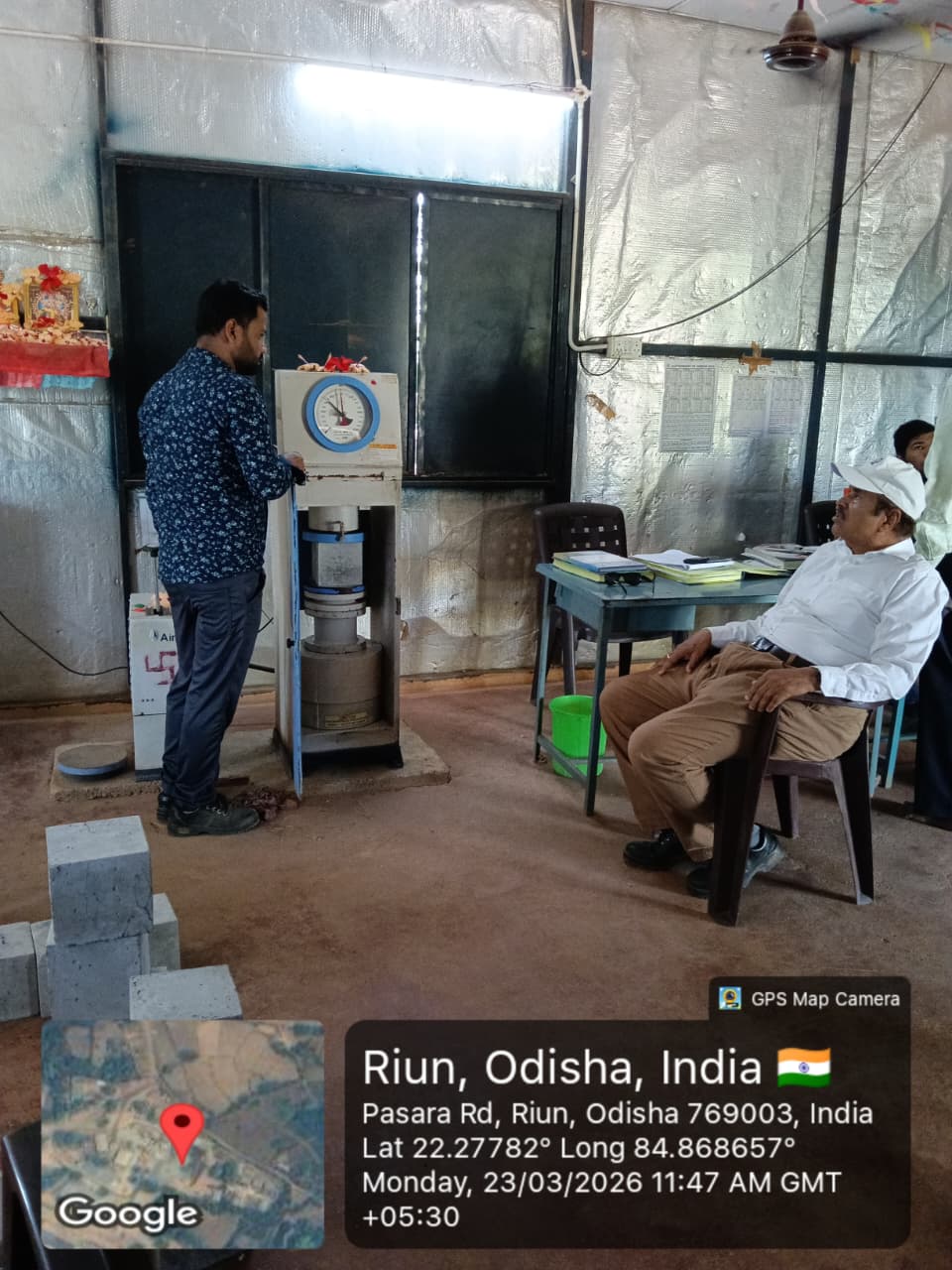

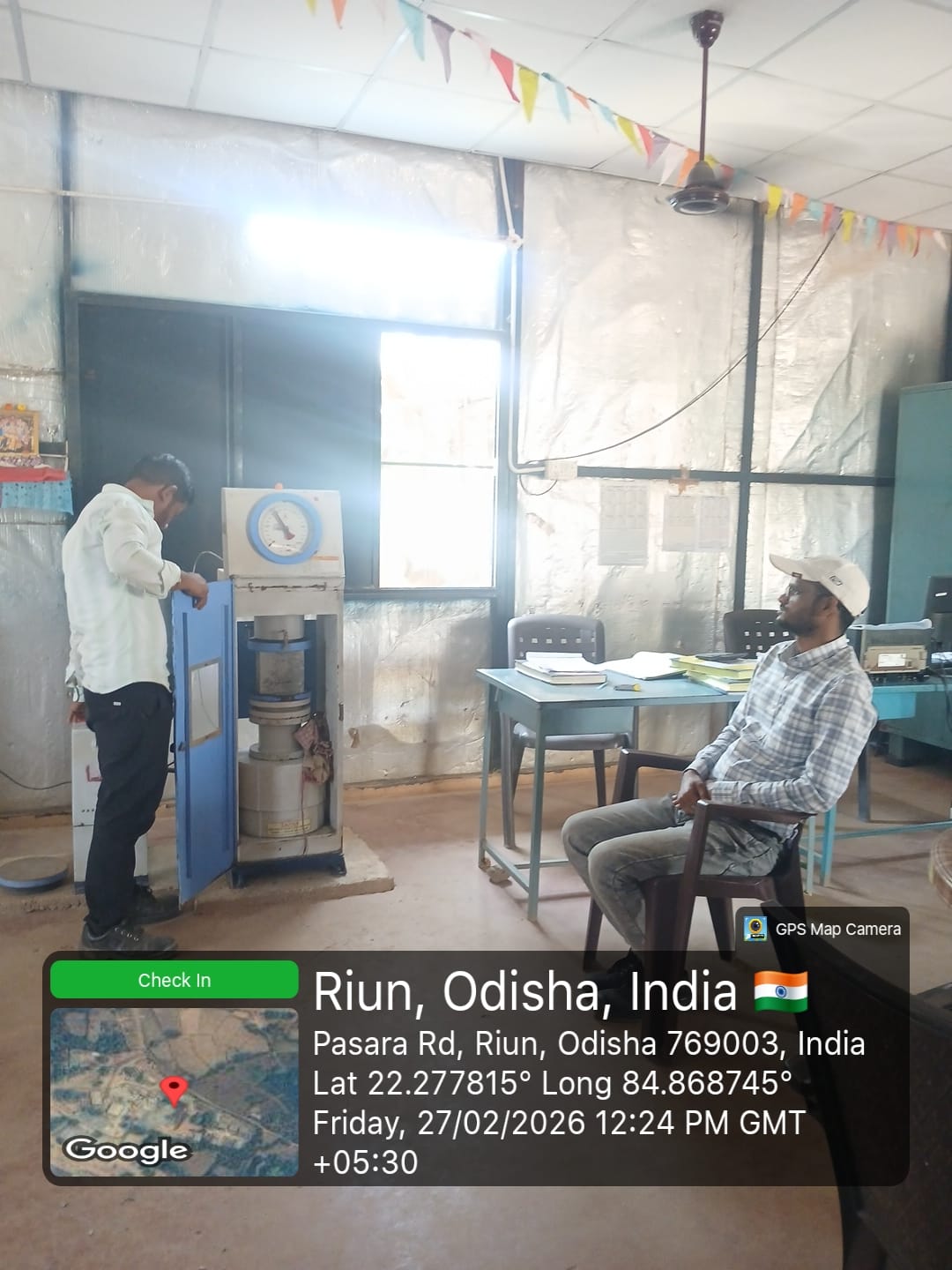

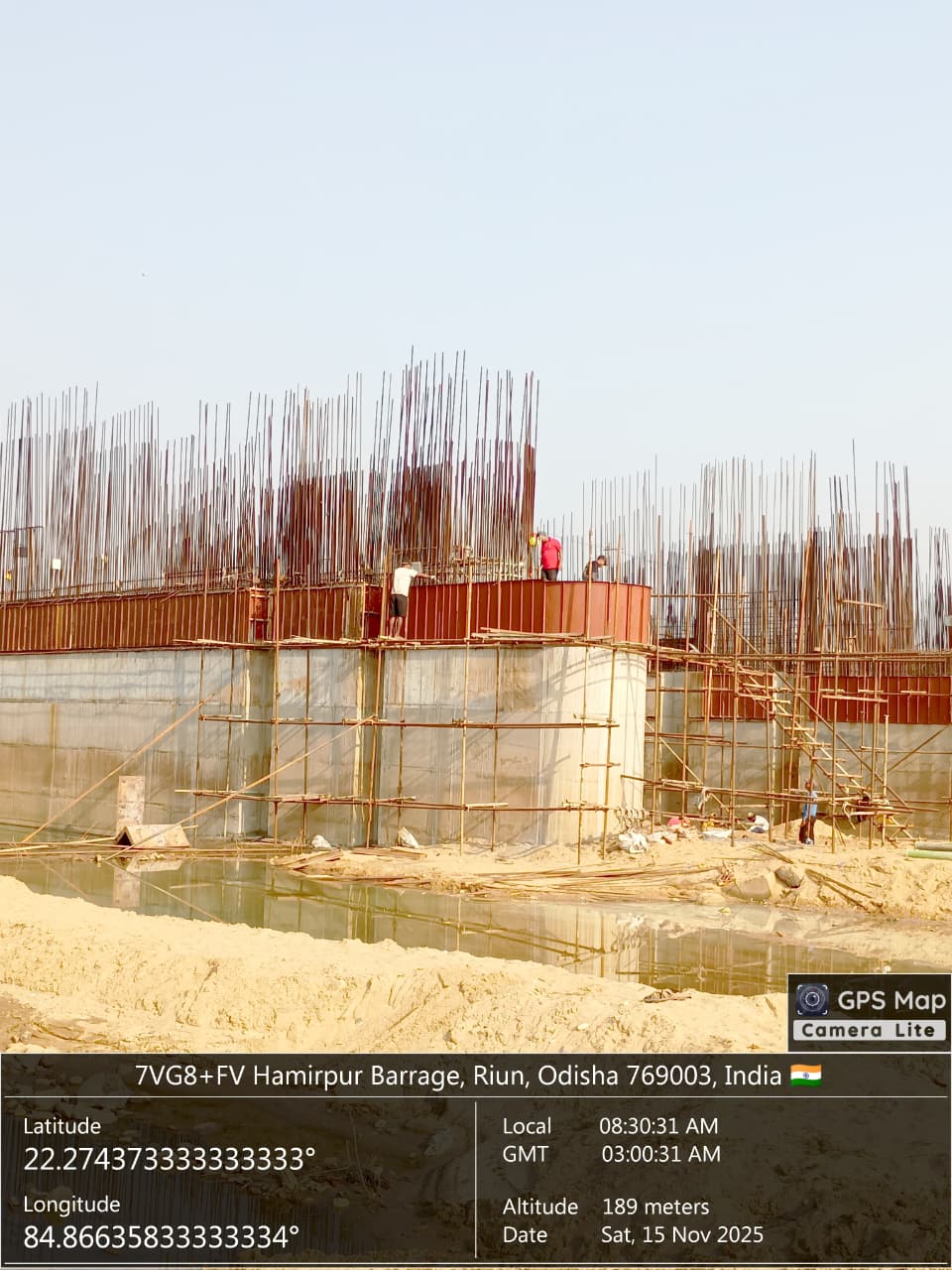

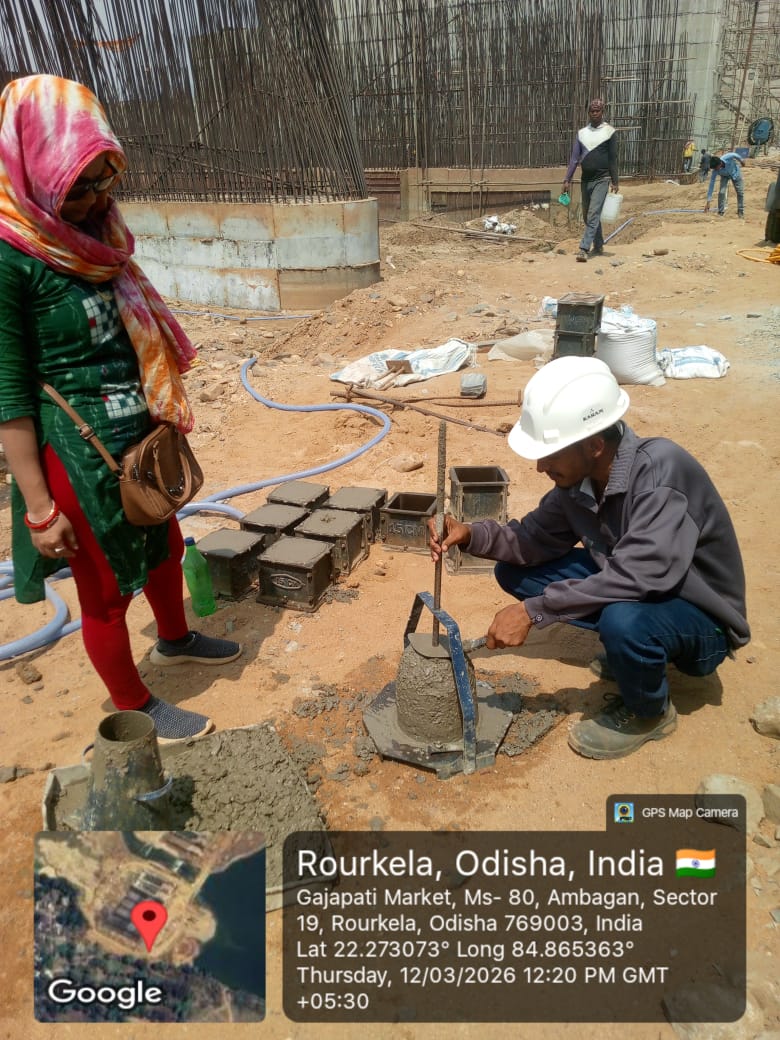

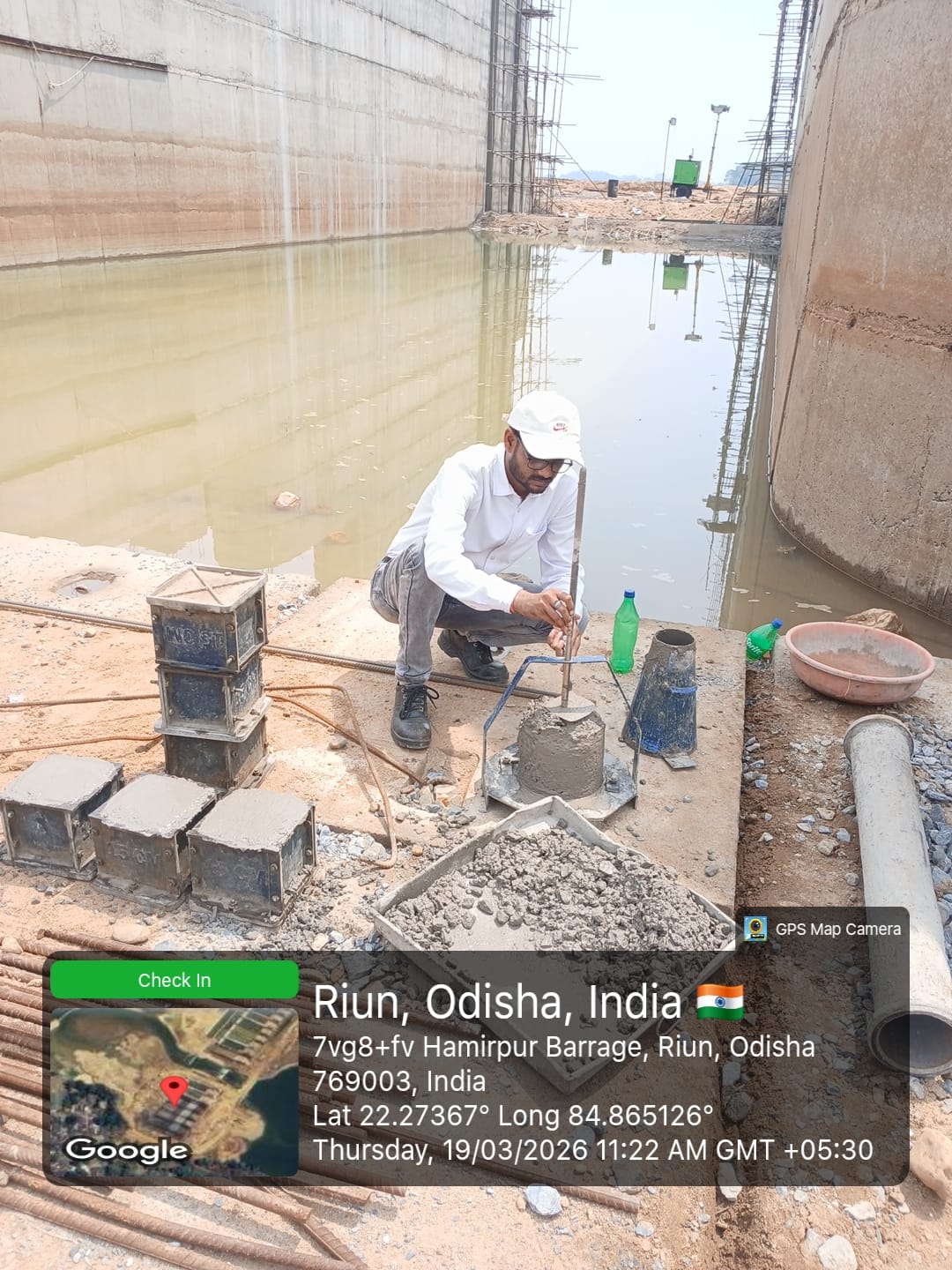

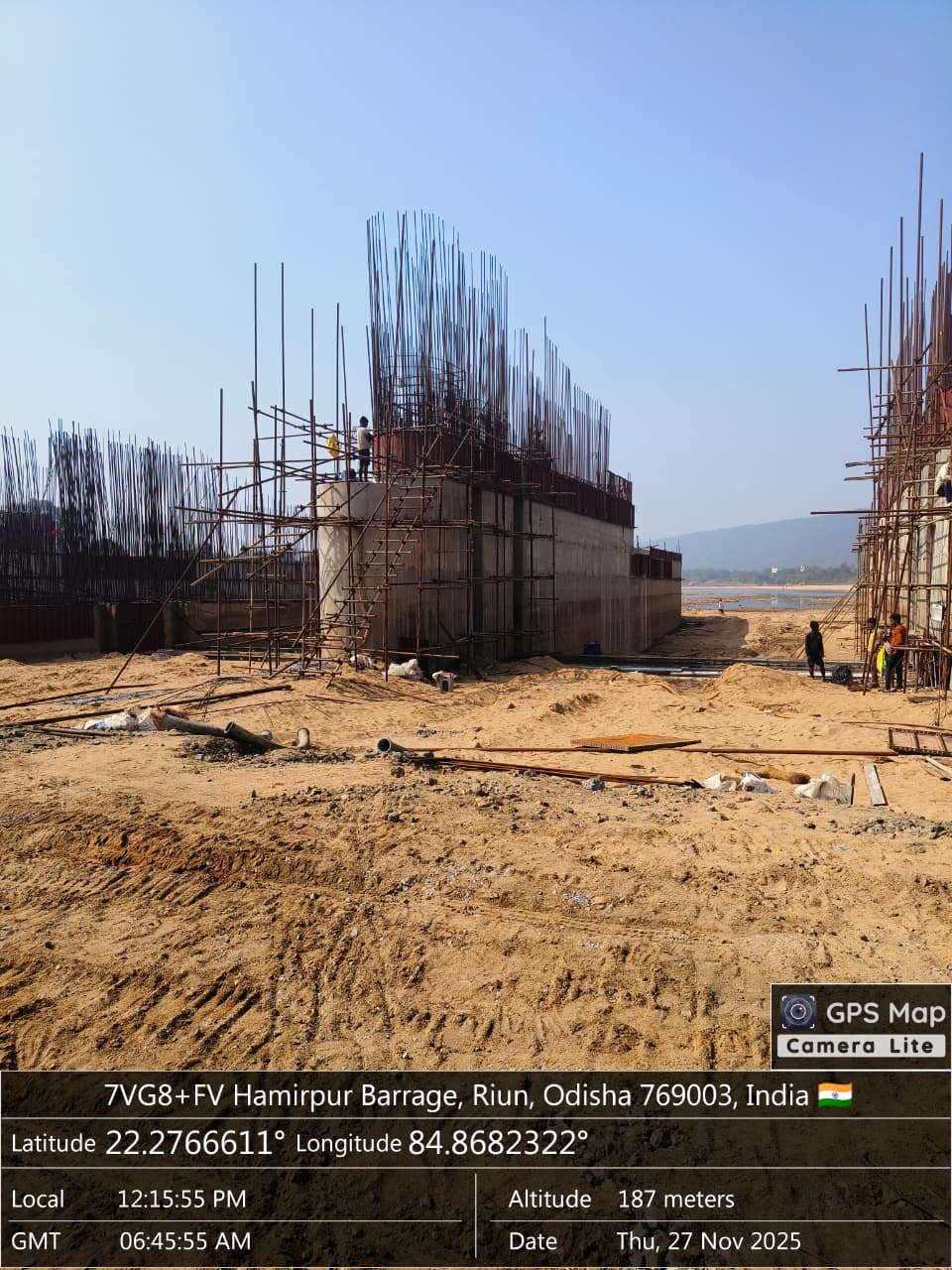

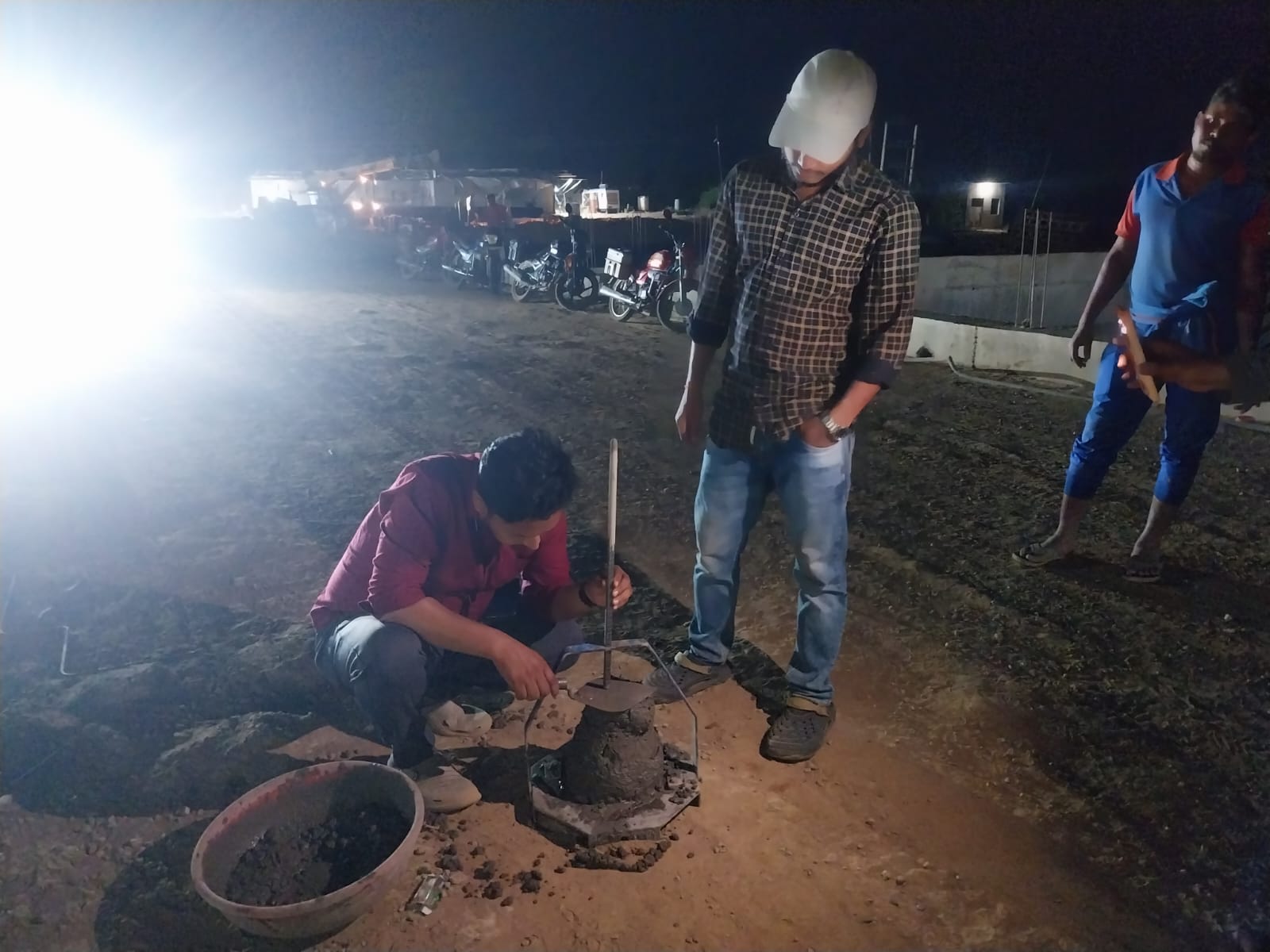

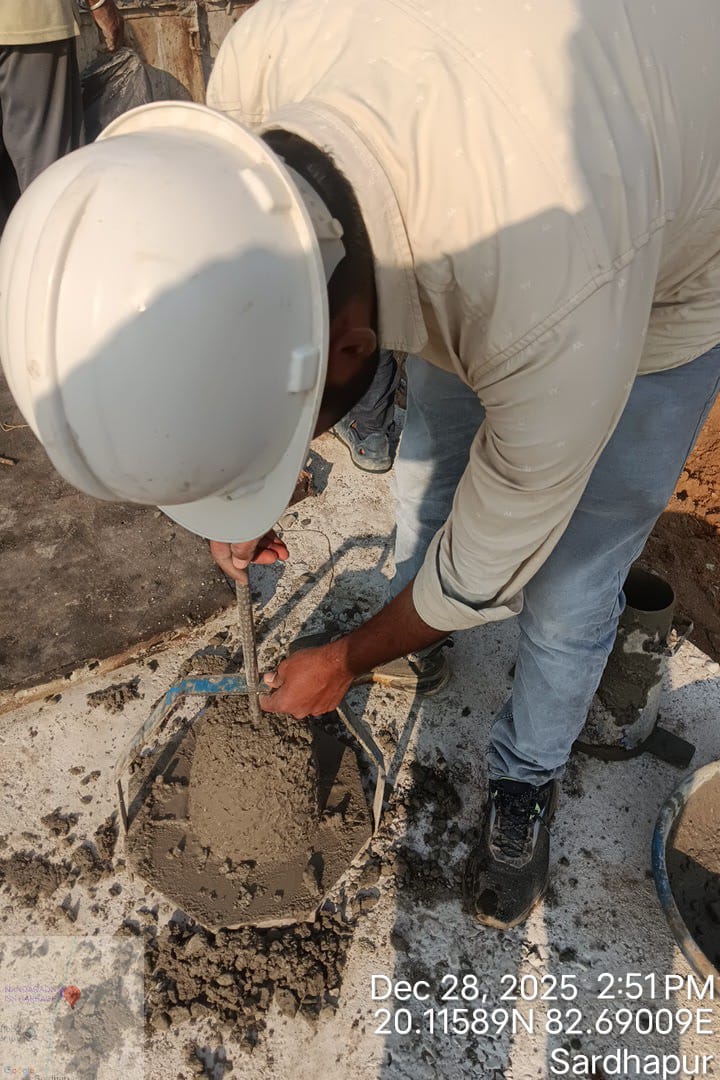

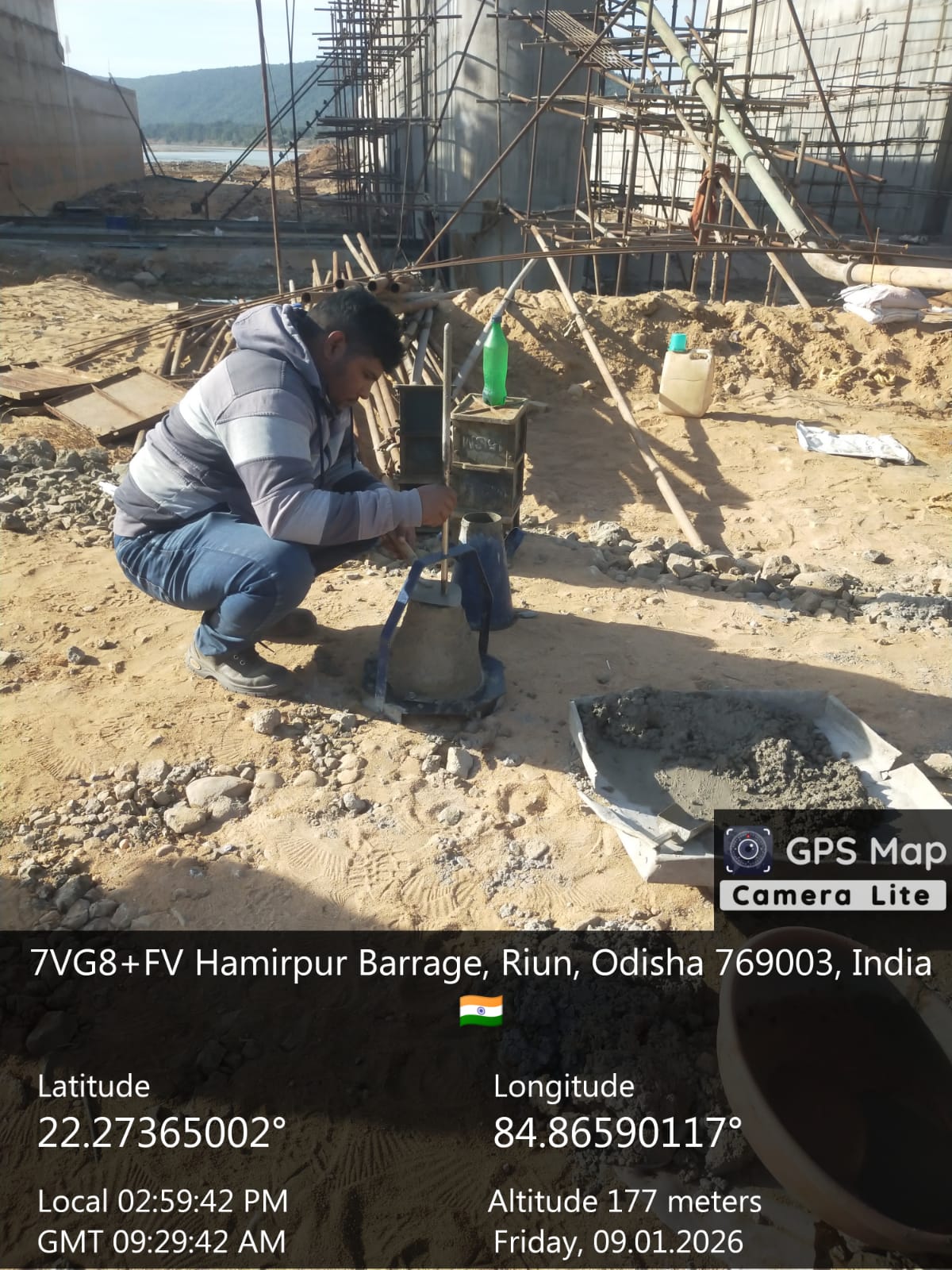

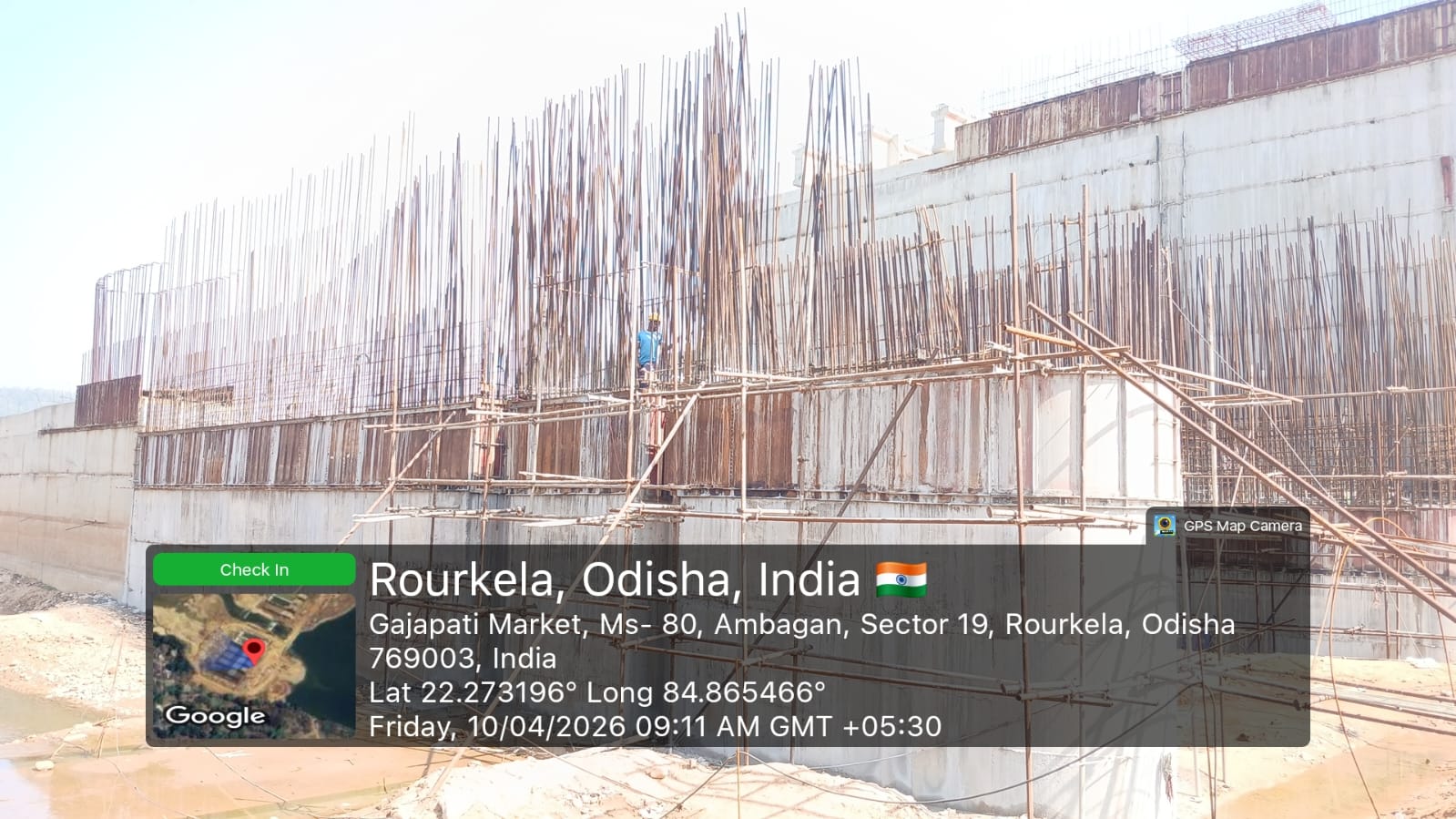

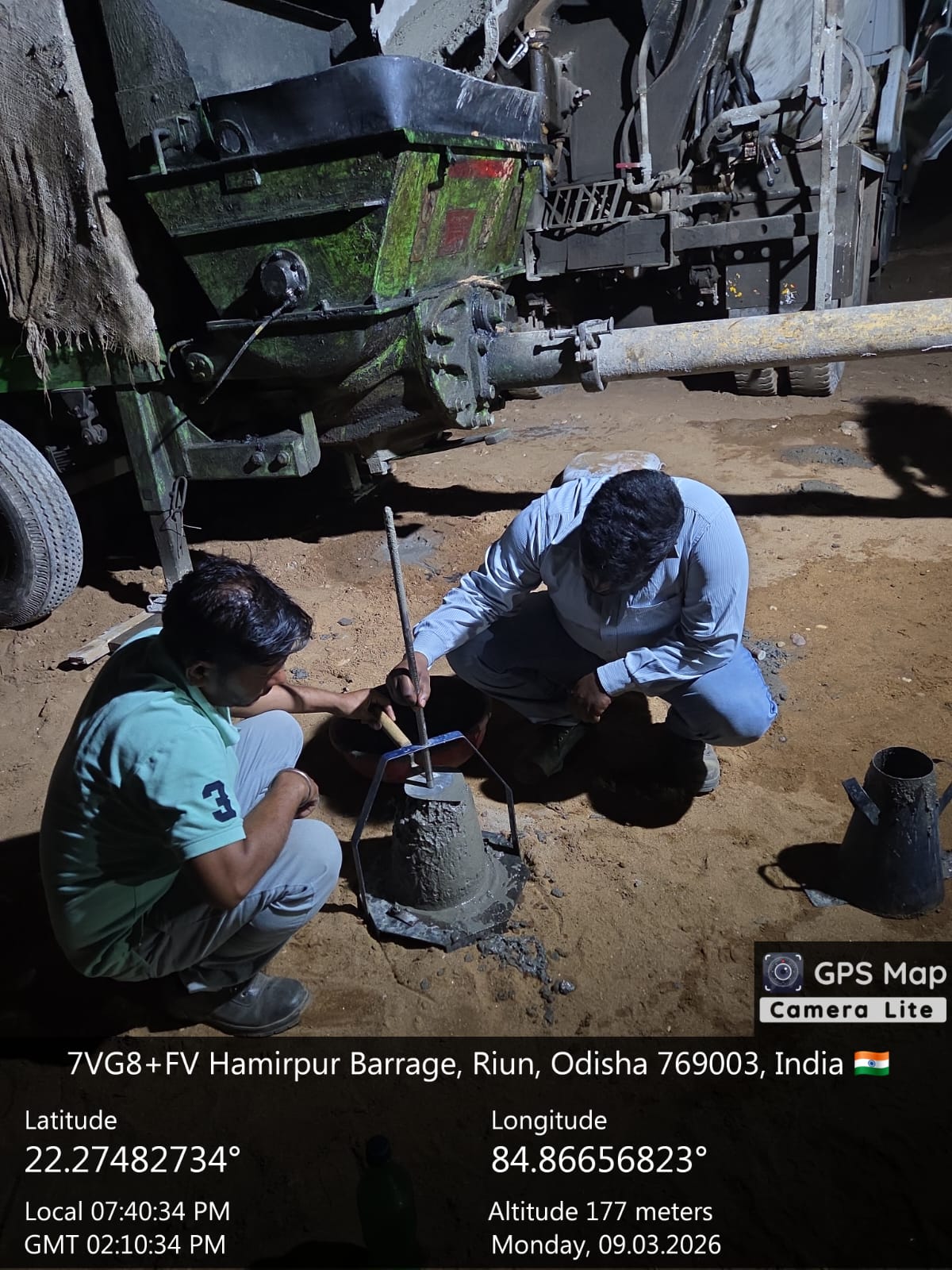

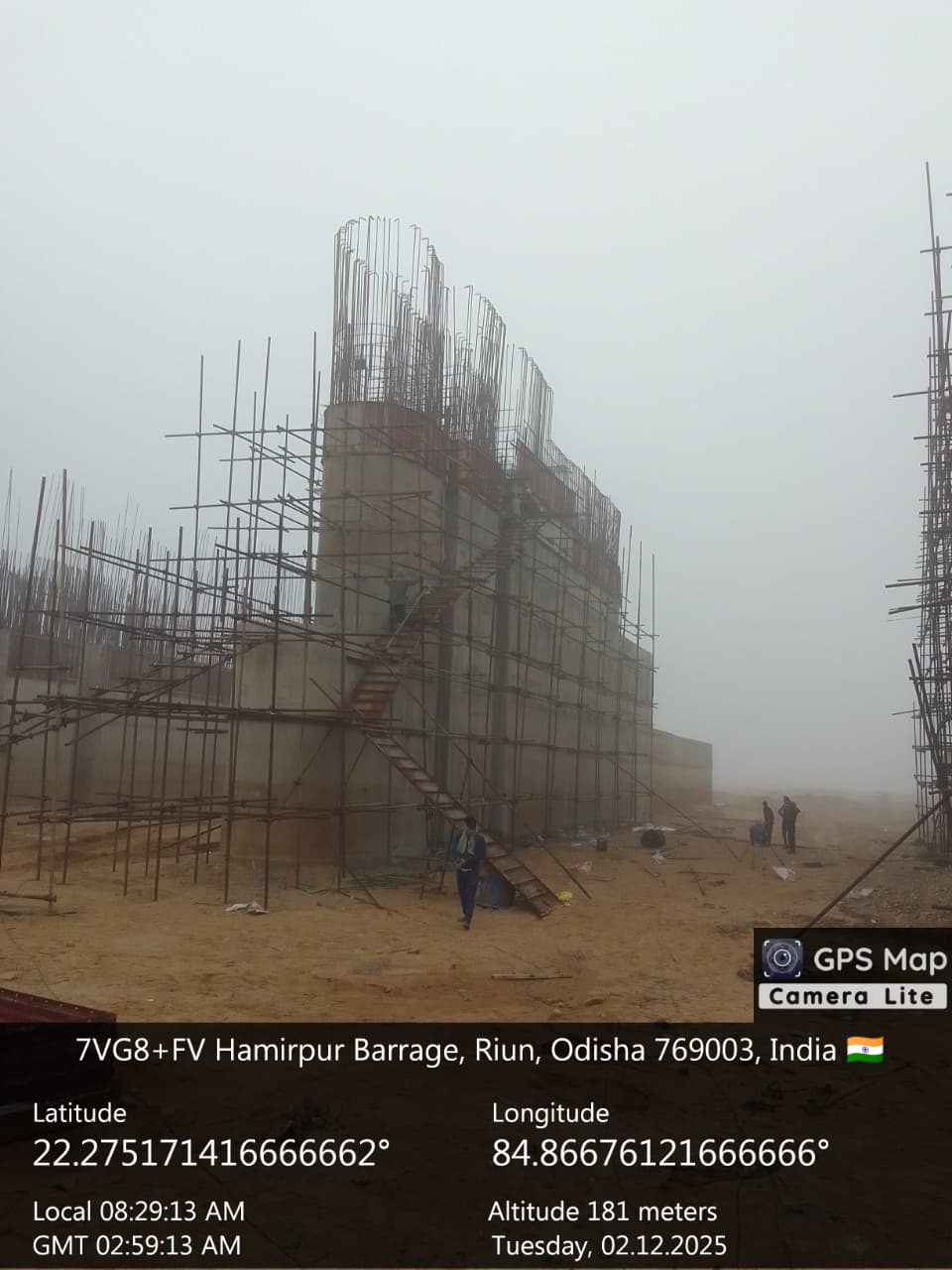

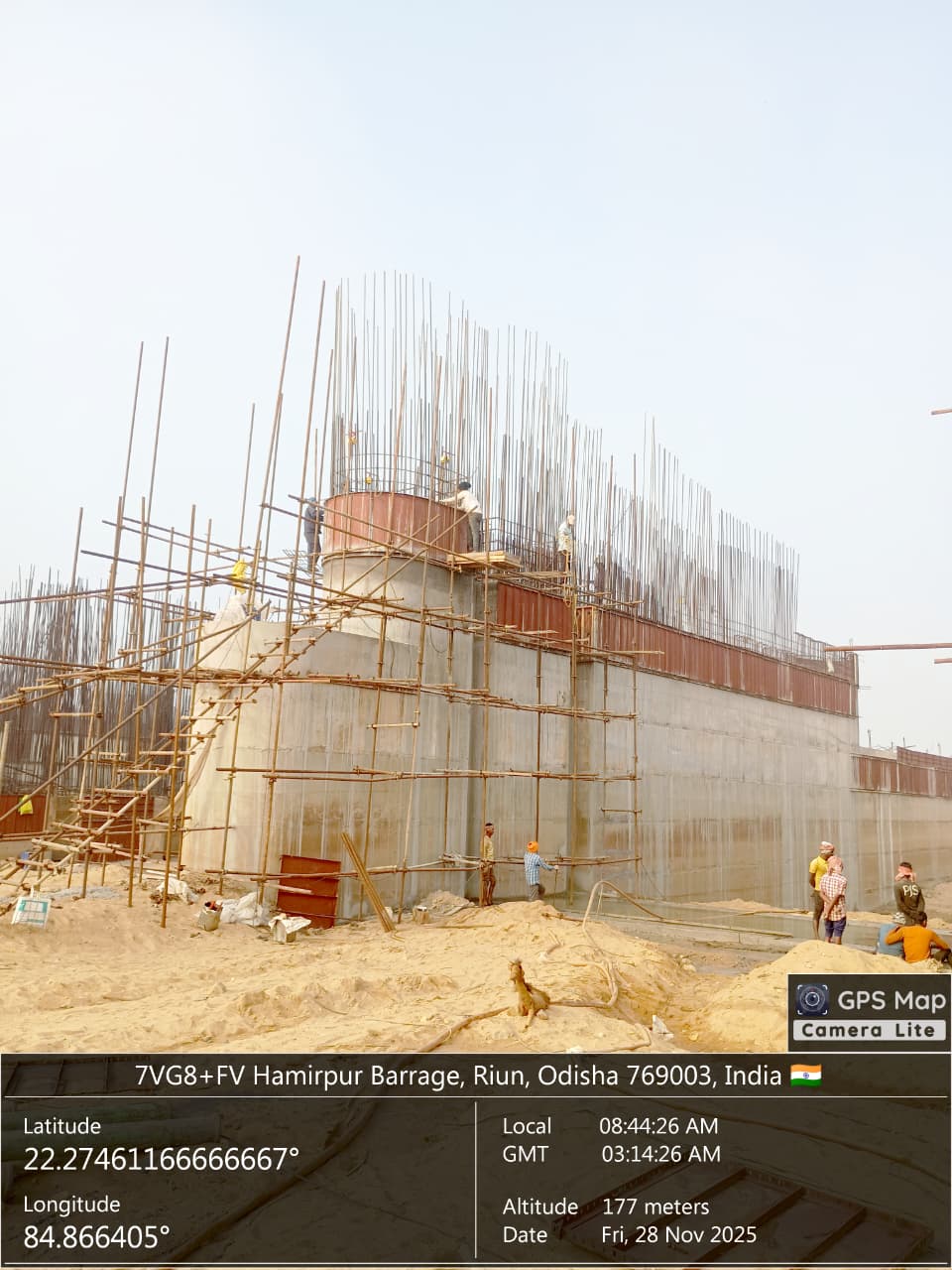

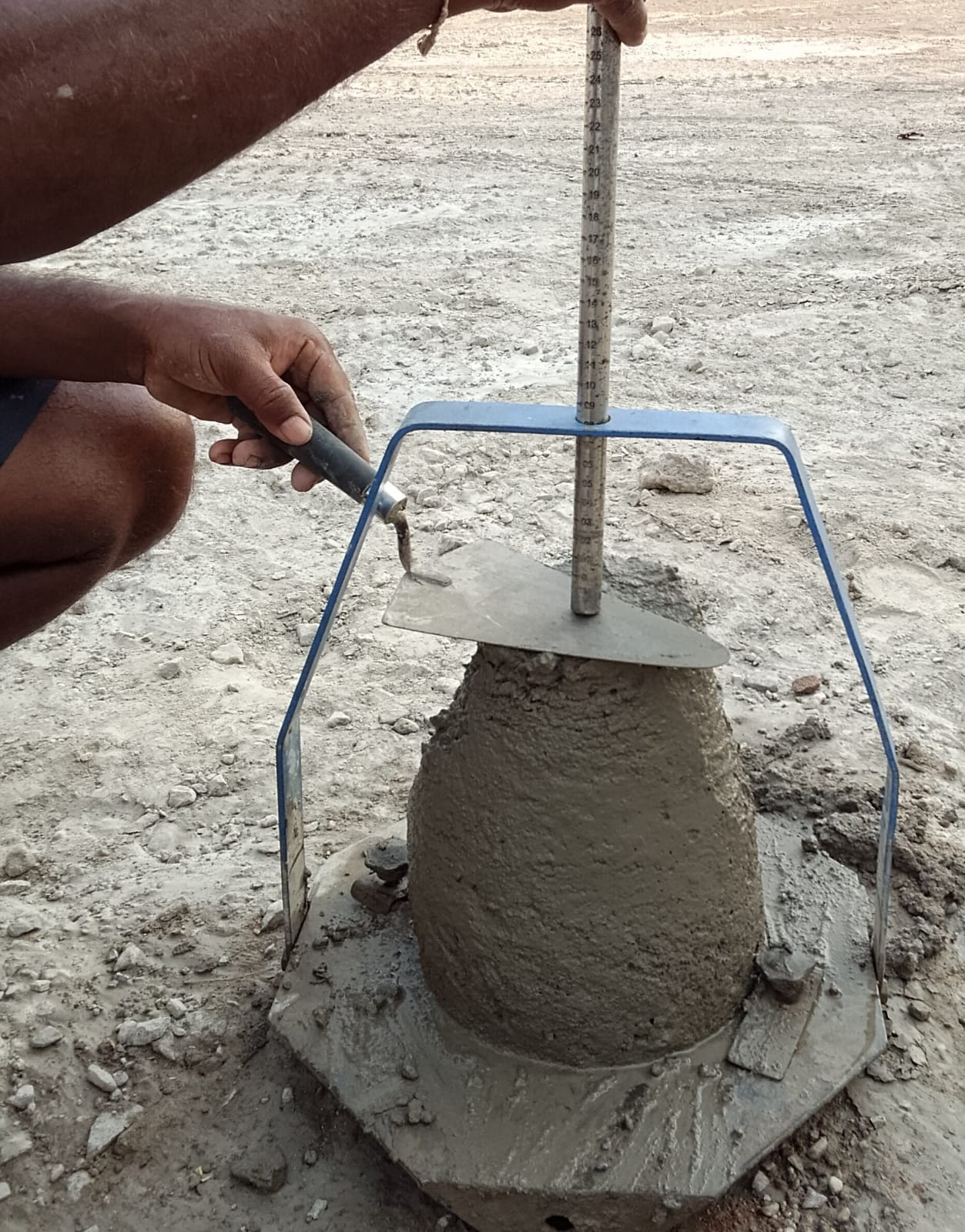

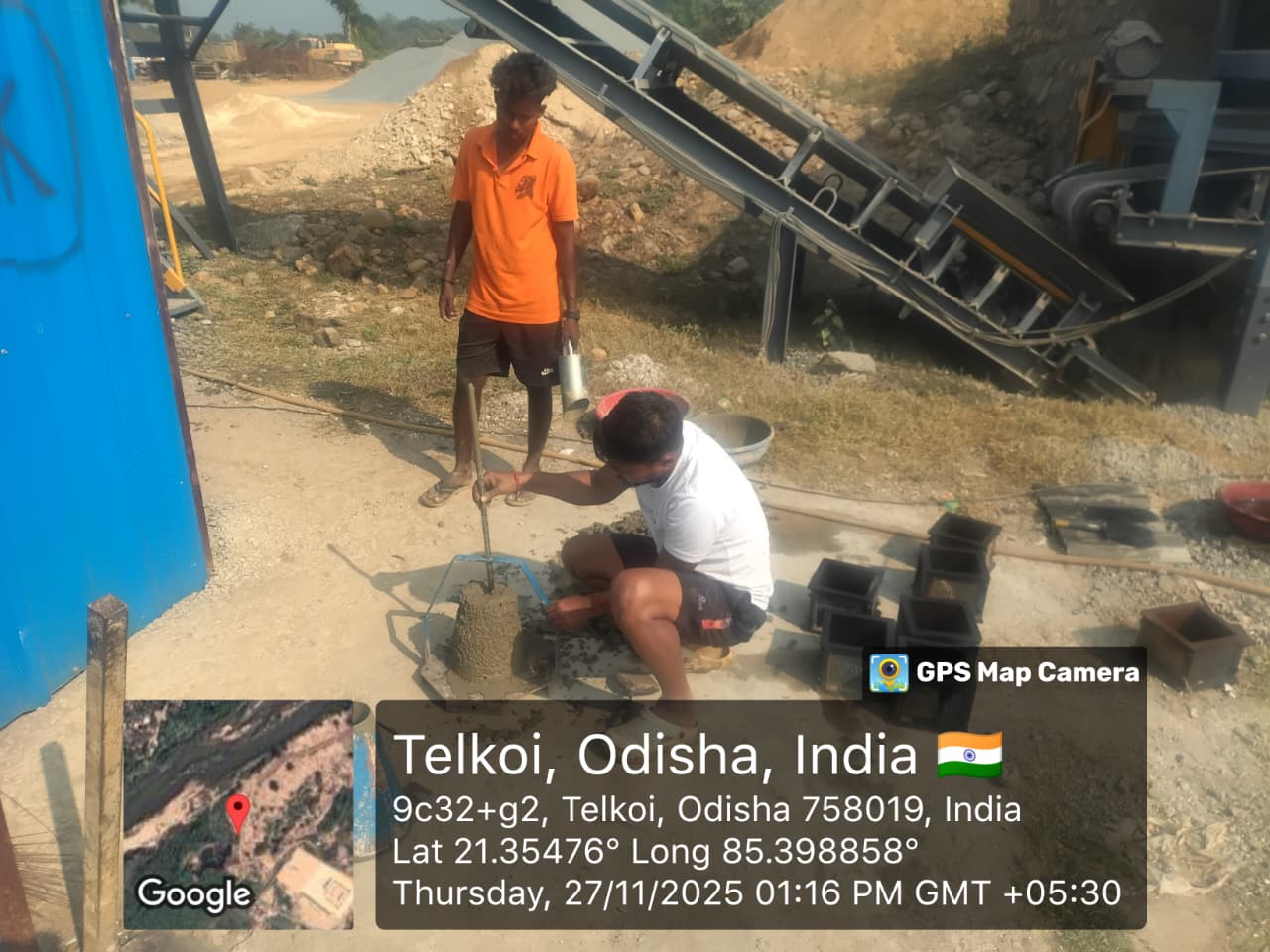

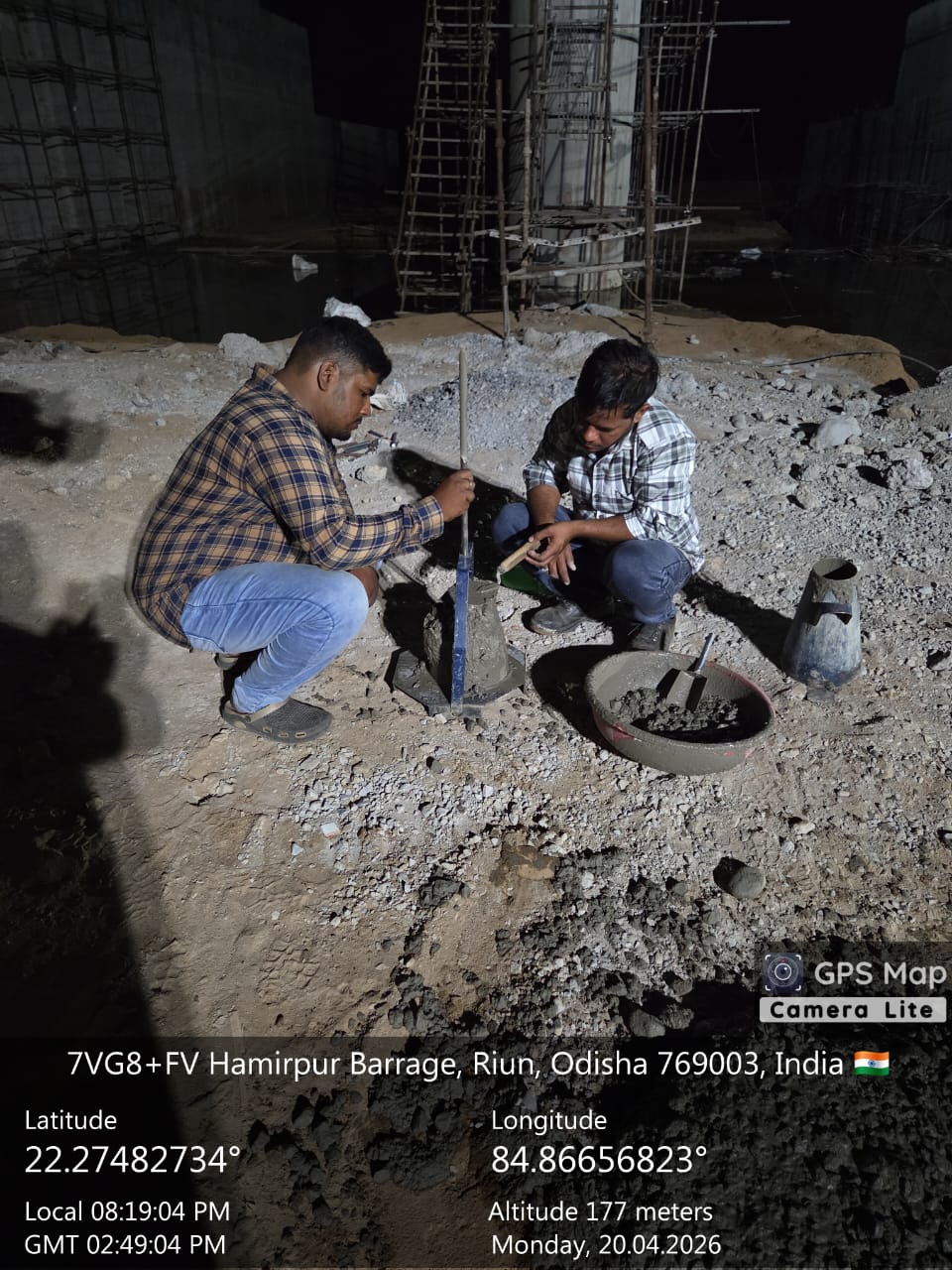

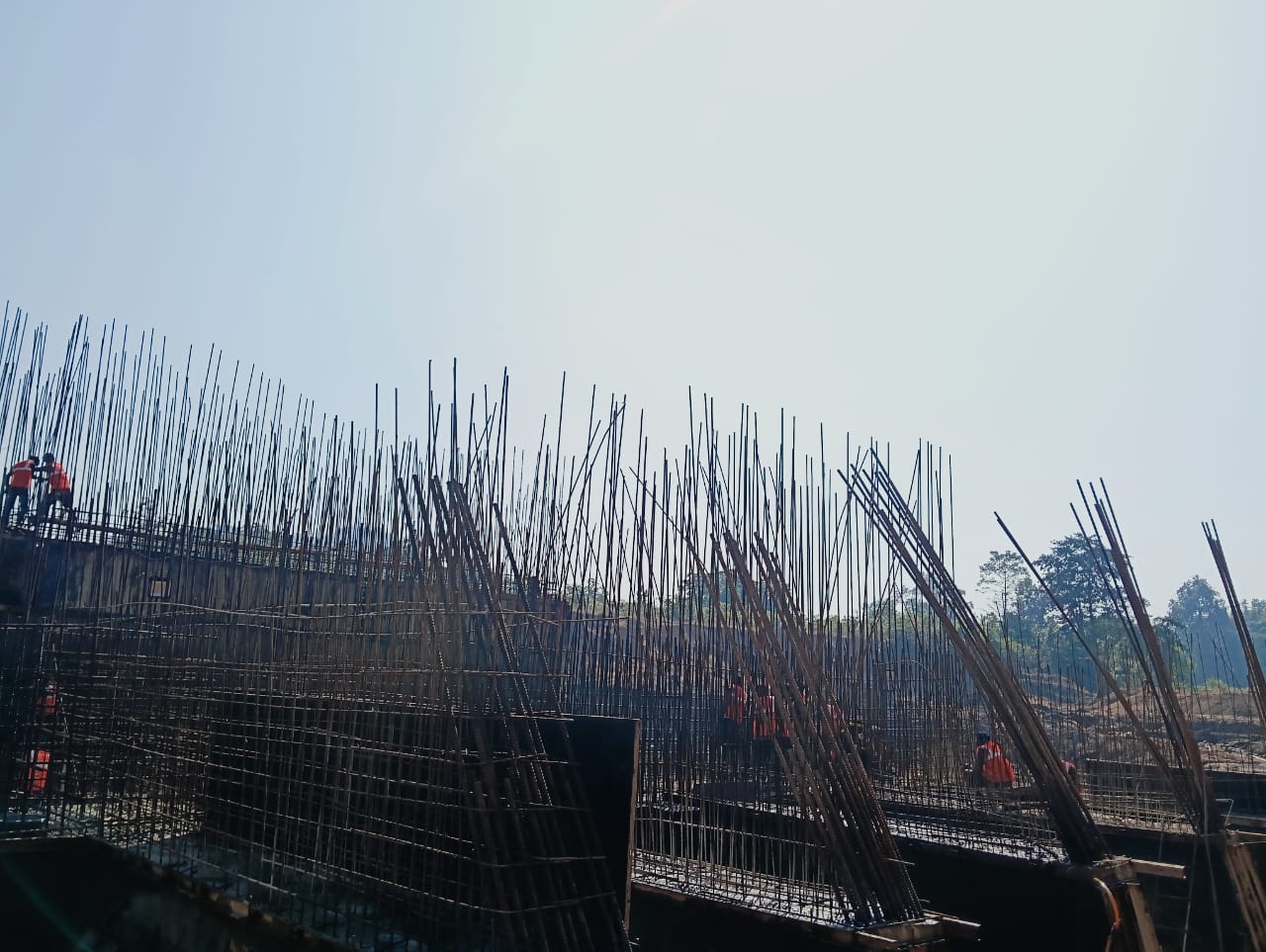

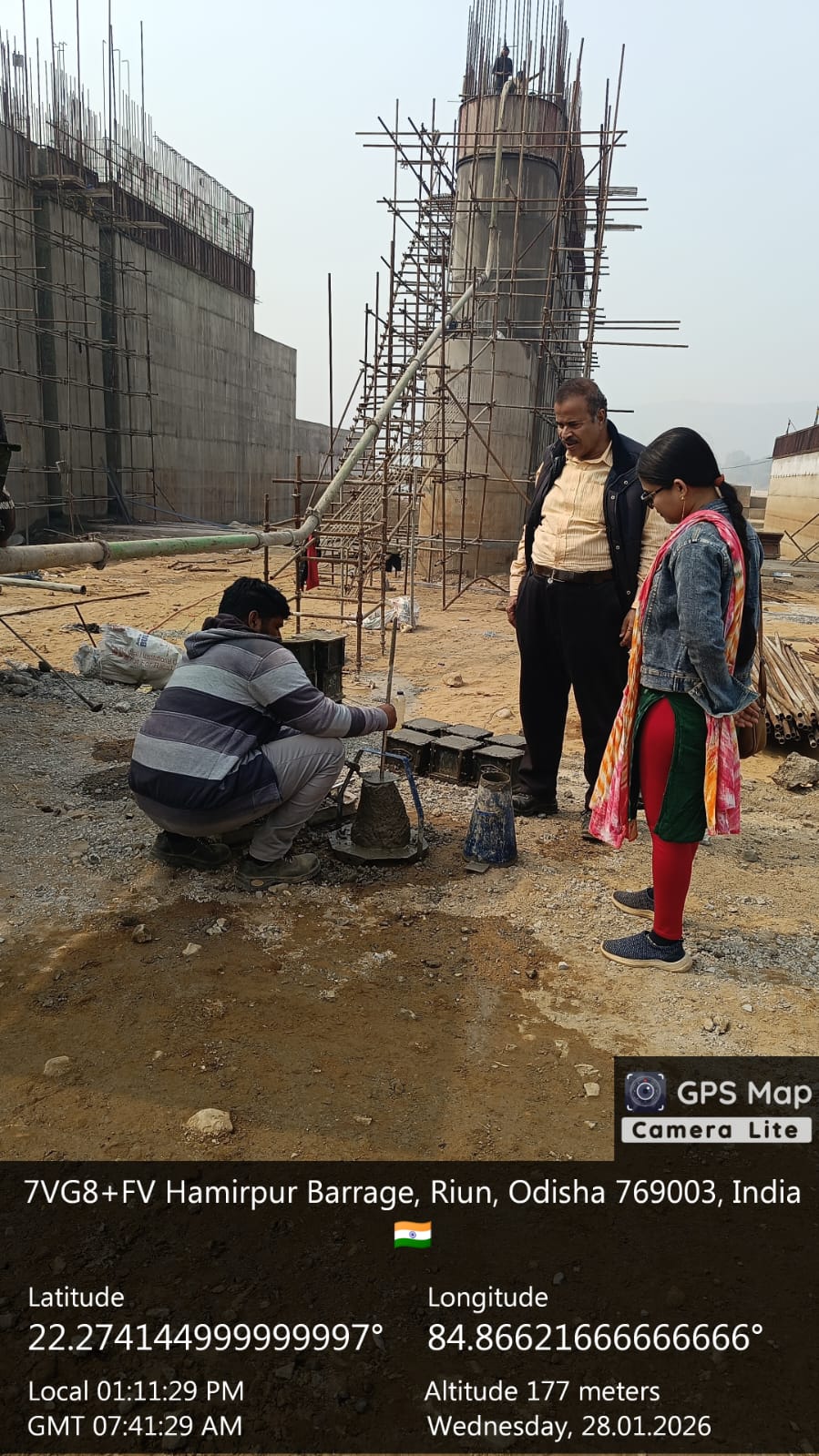

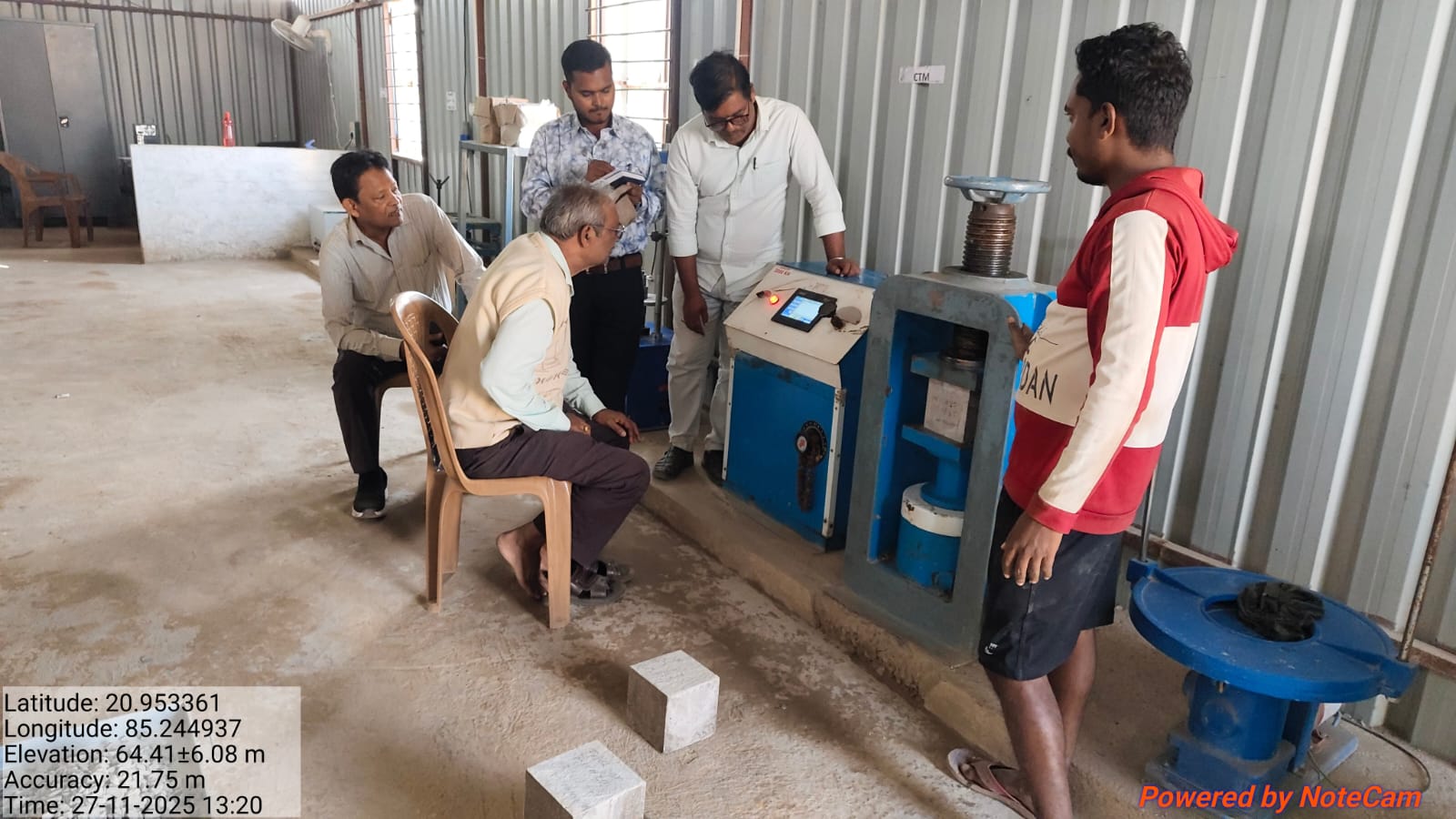

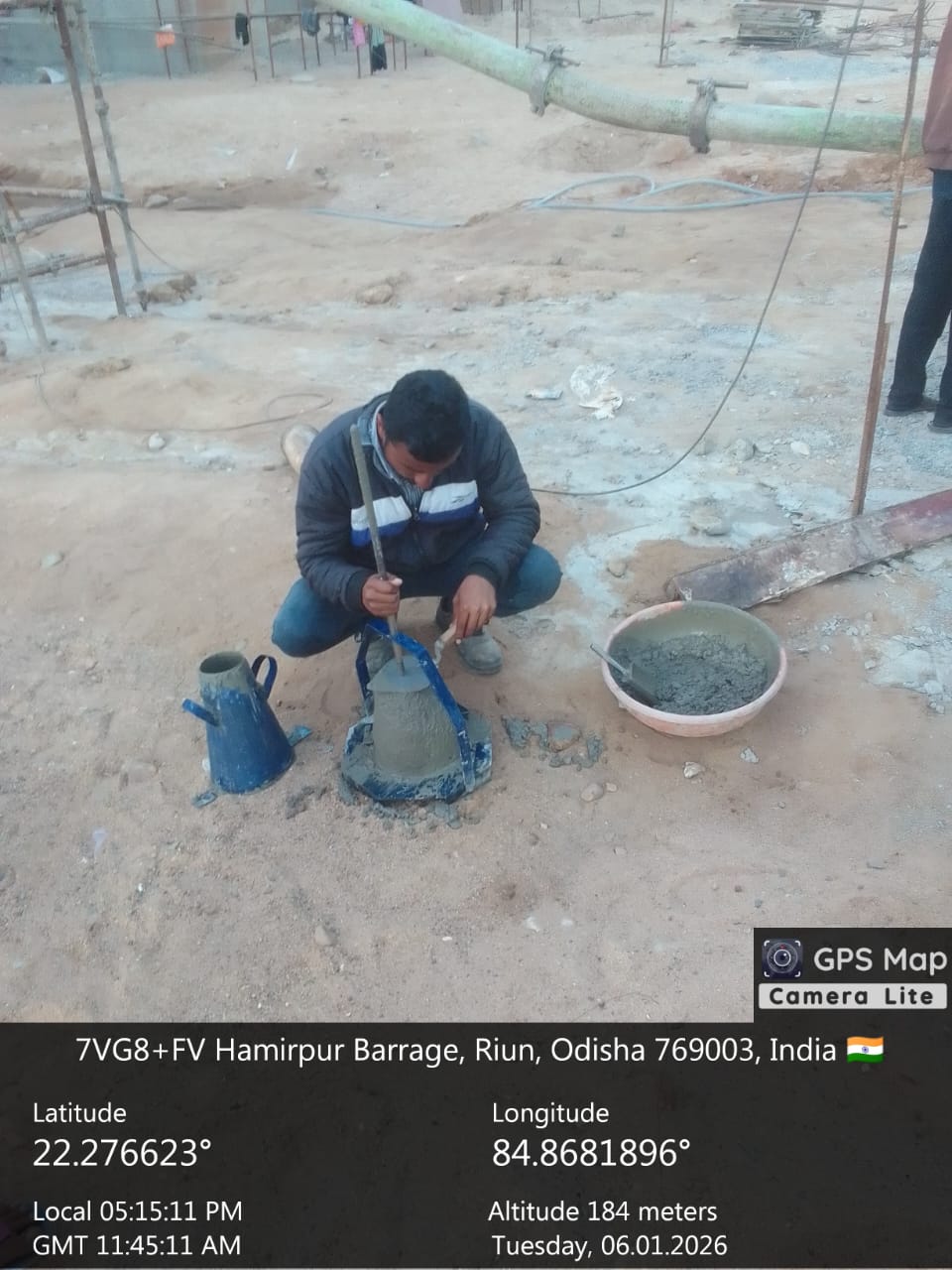

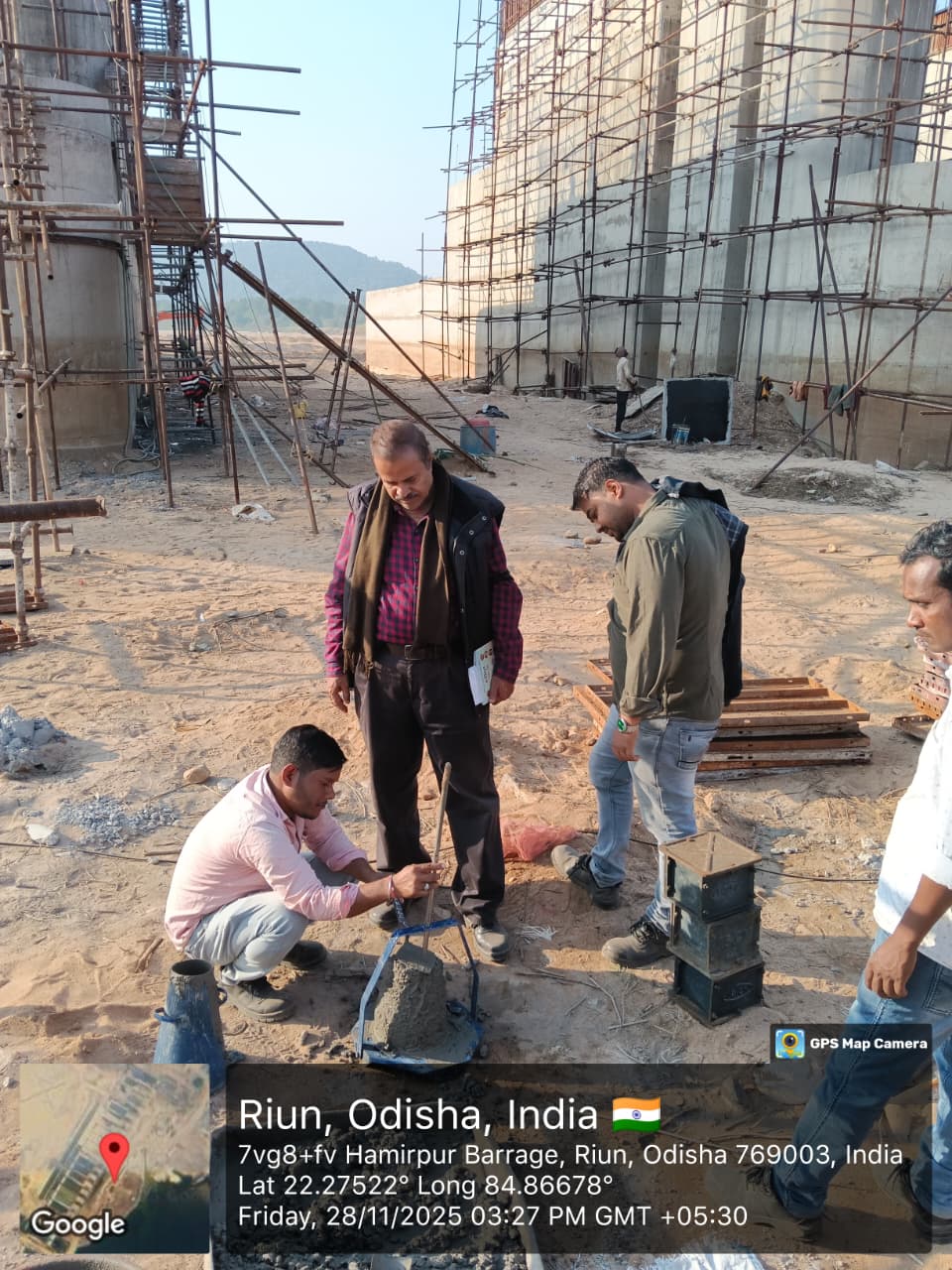

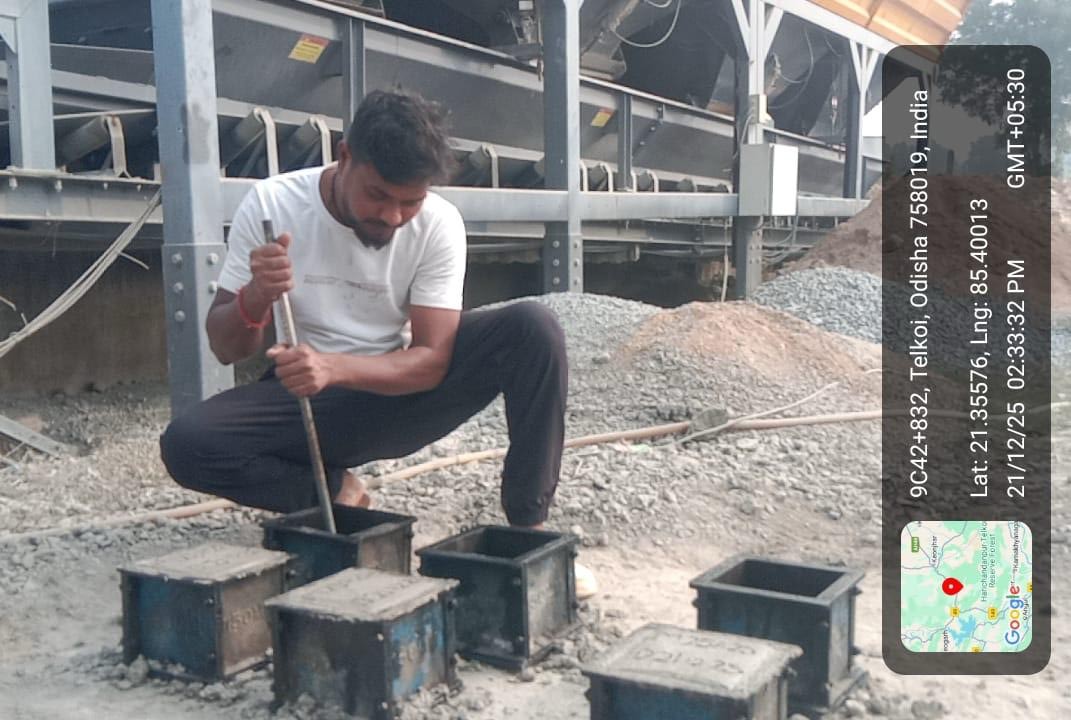

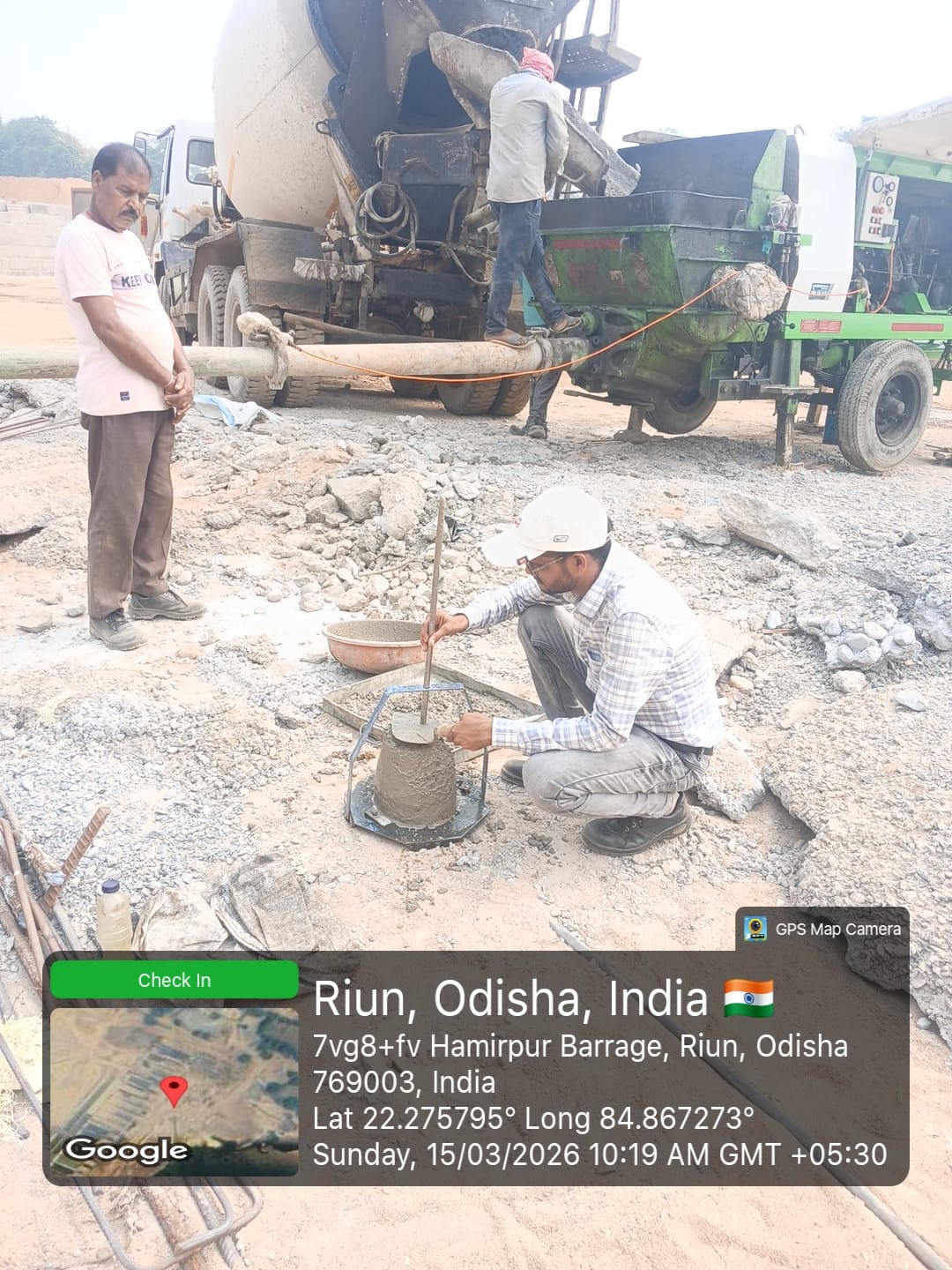

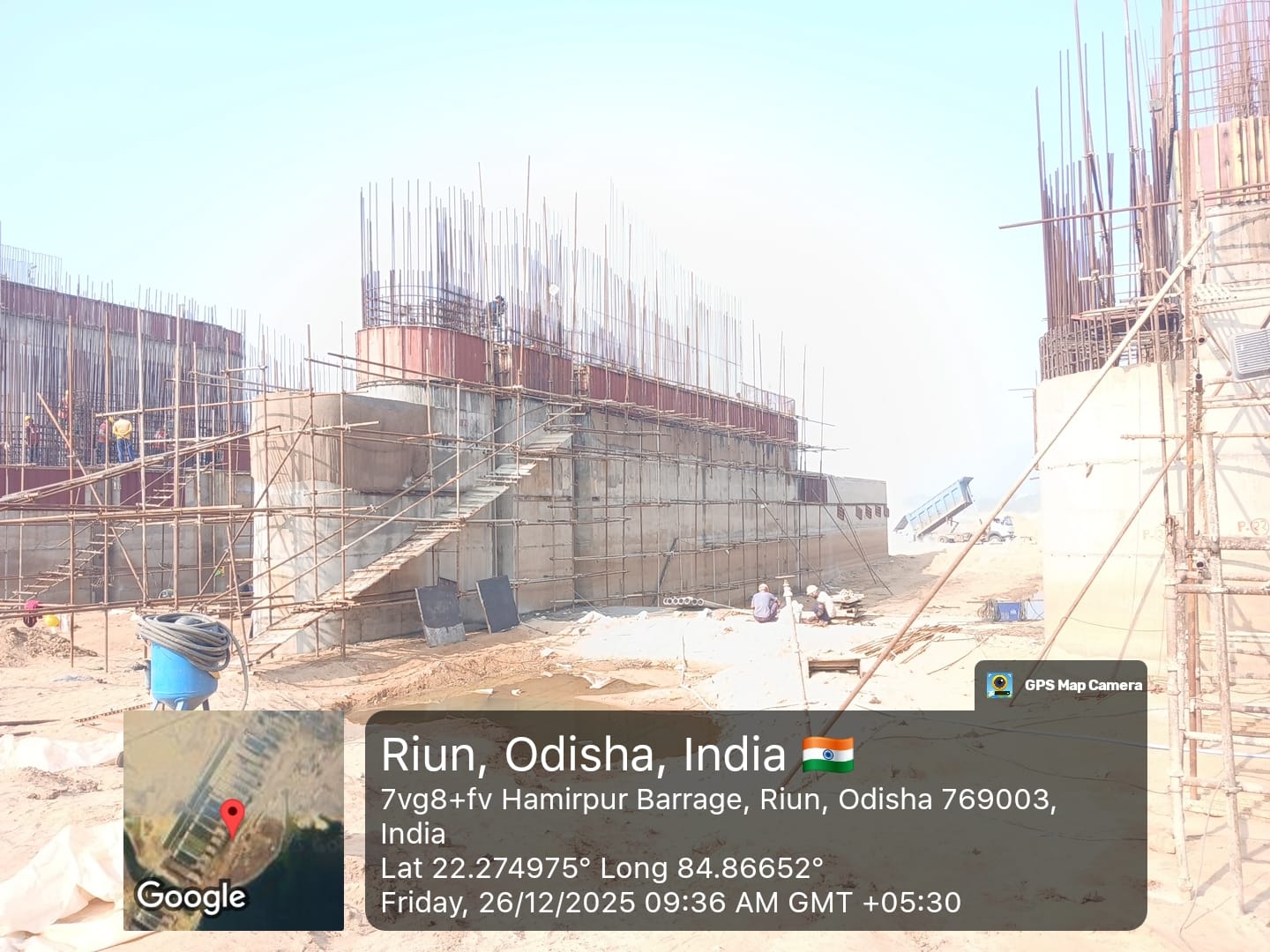

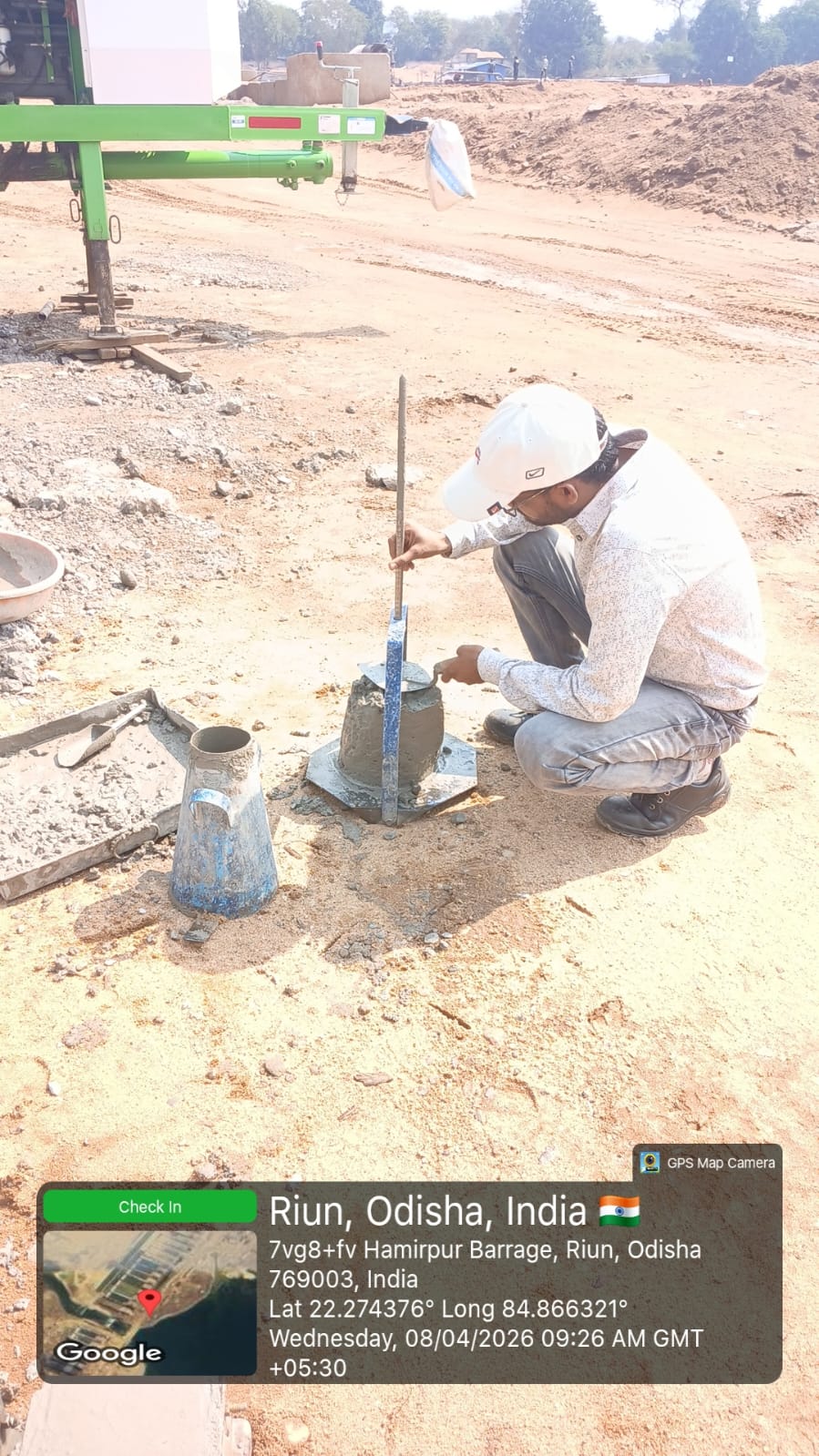

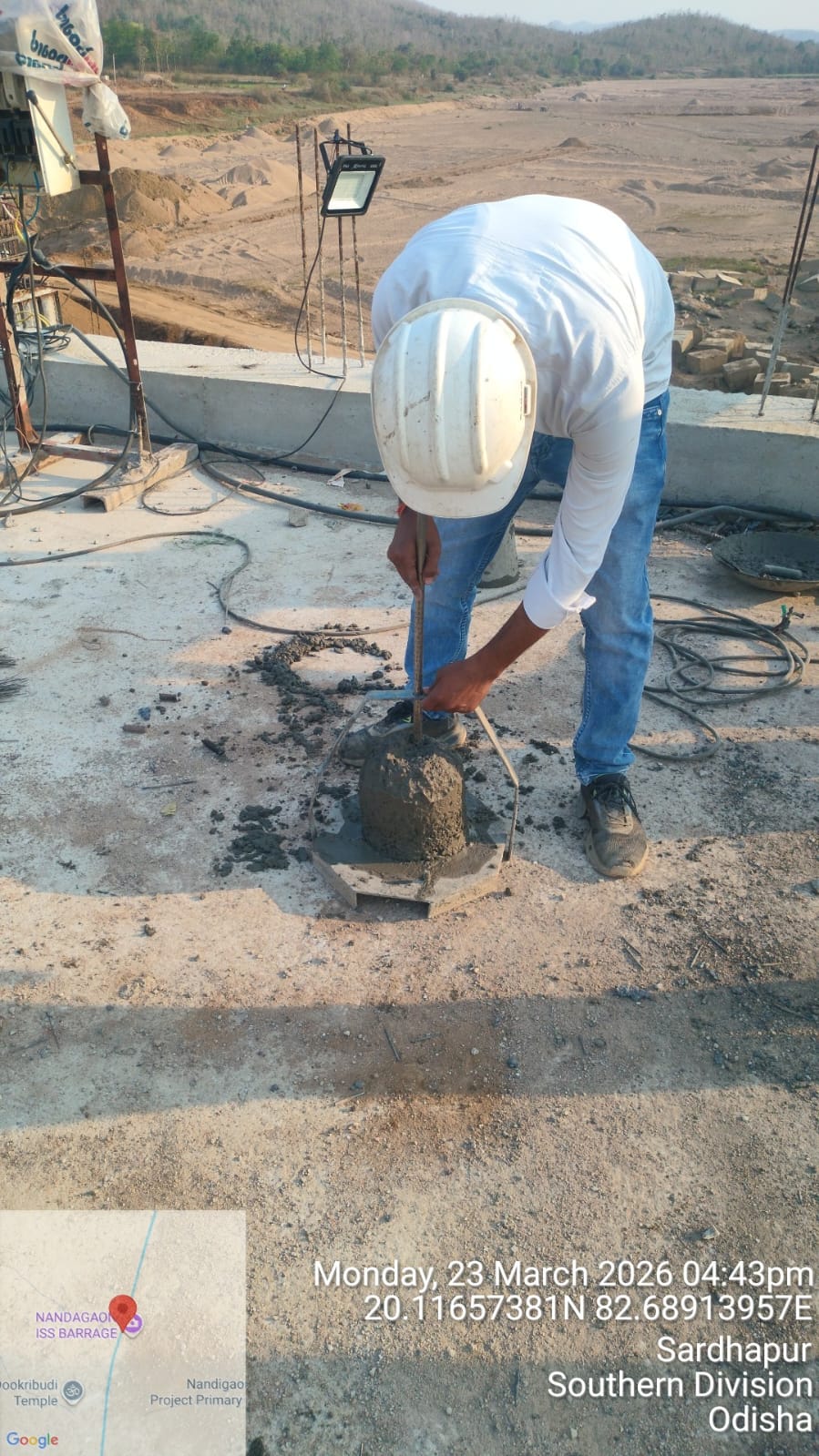

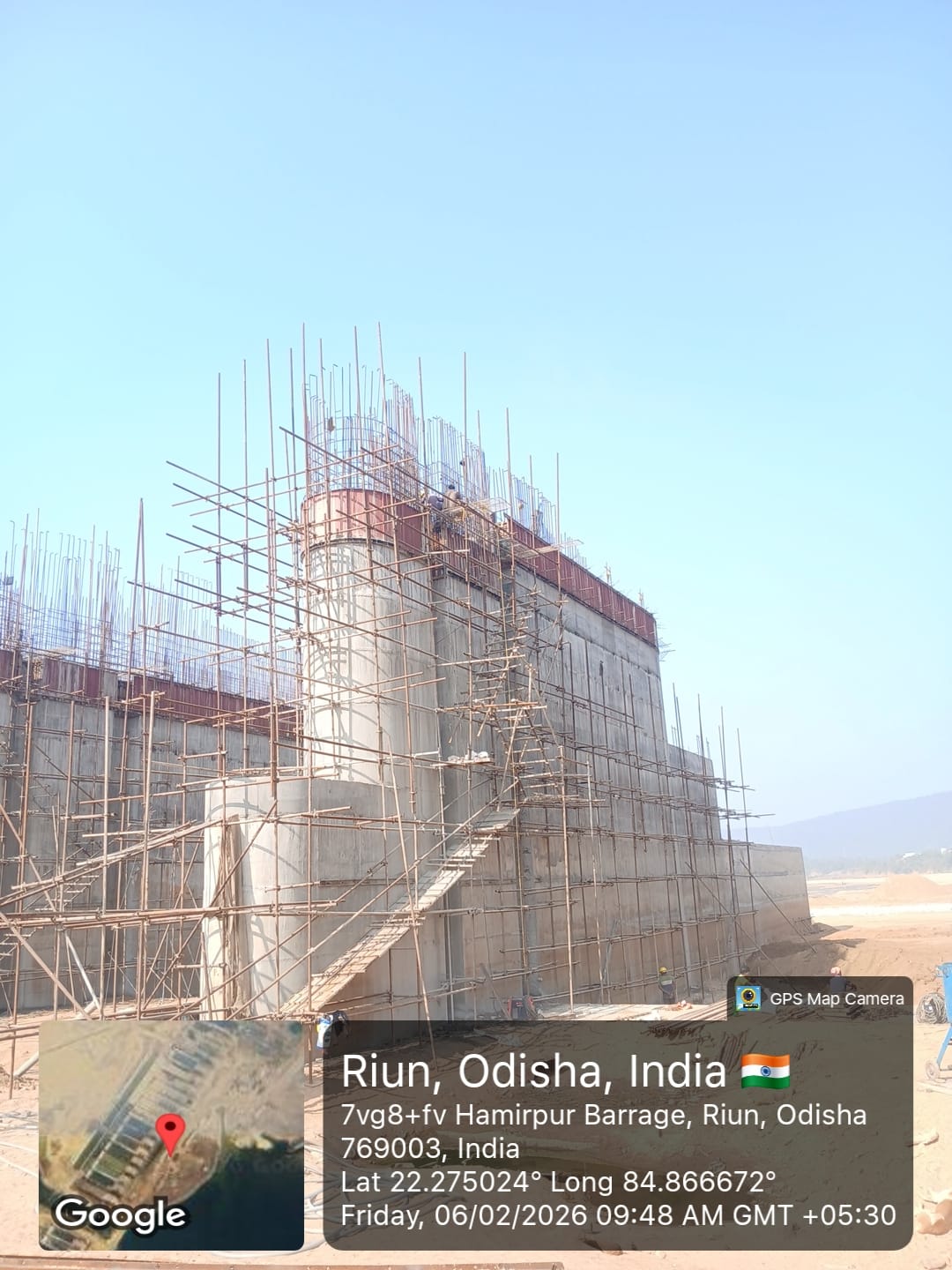

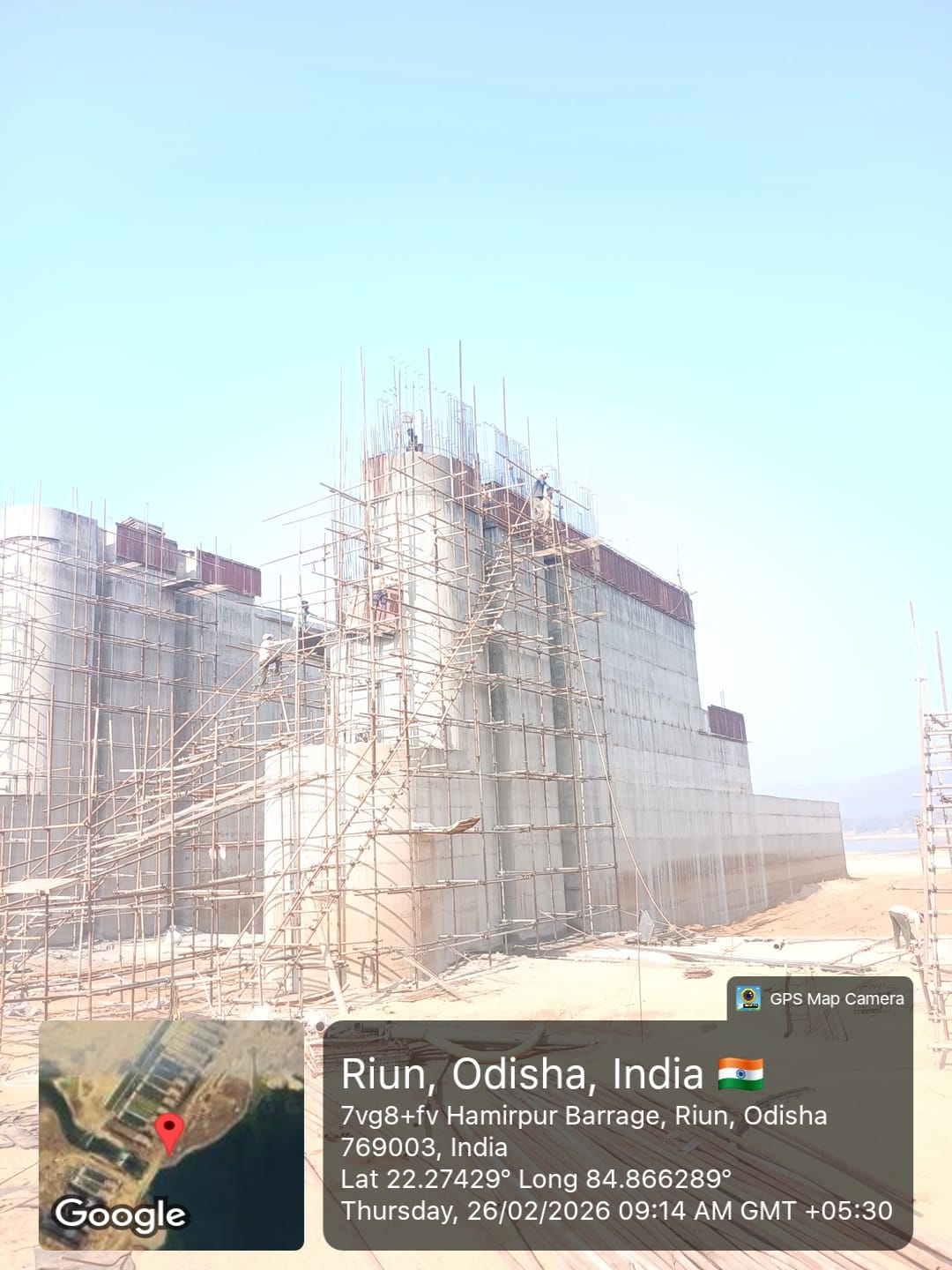

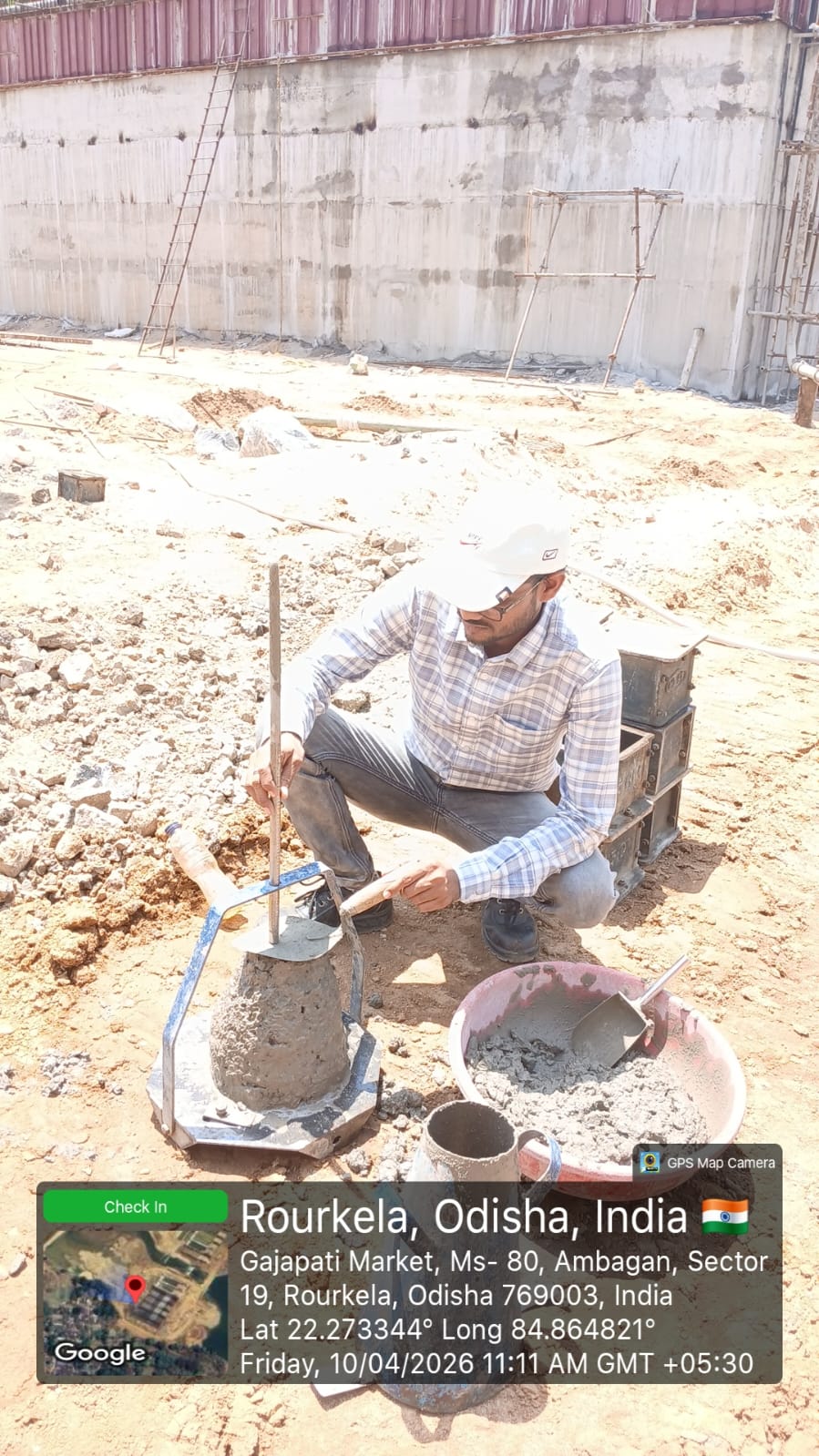

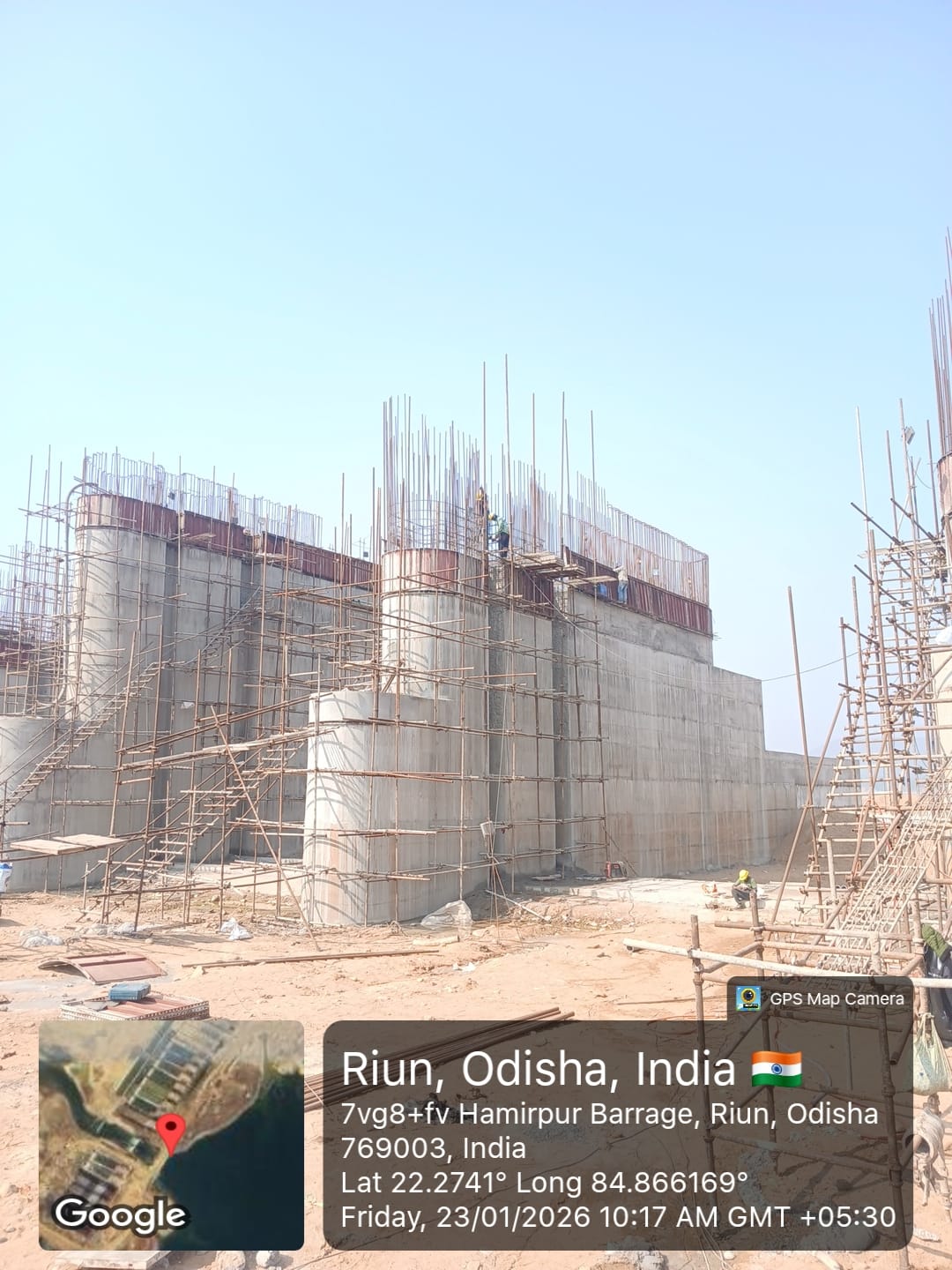

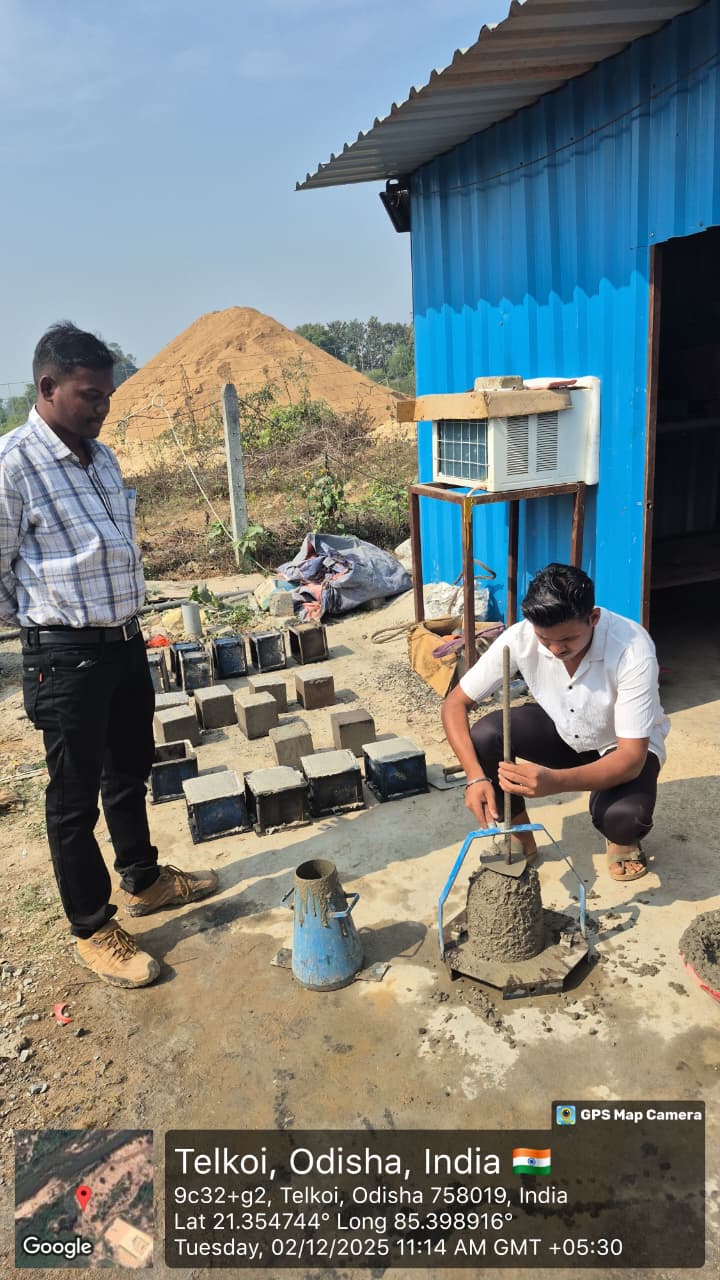

Testing of Compressive M25A20 (Strength is 30.89/mm2 for 28 days) of D/S Flank wall, 7th lift at Block No-5 and M35A20 (Strength is 37.63/mm2 for 07 days) of Deck slab (Bay No-18) has done in presence of Client & PSS team.

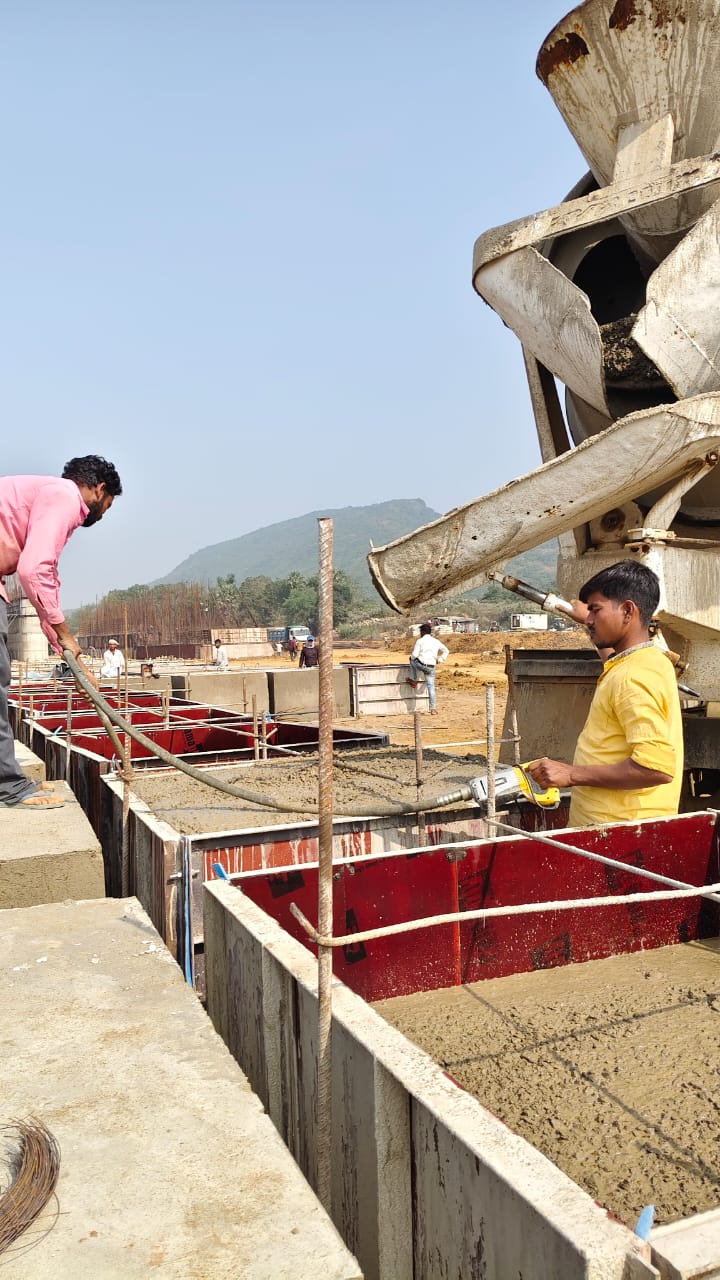

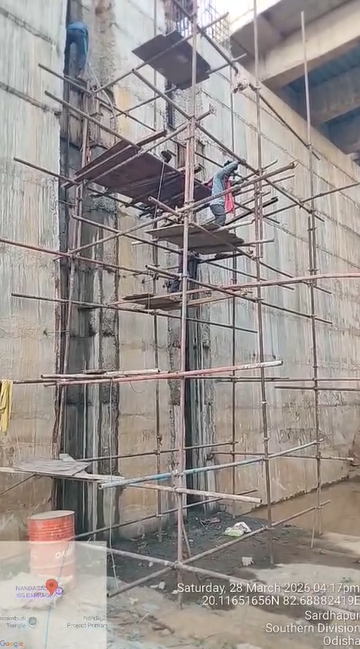

37/100

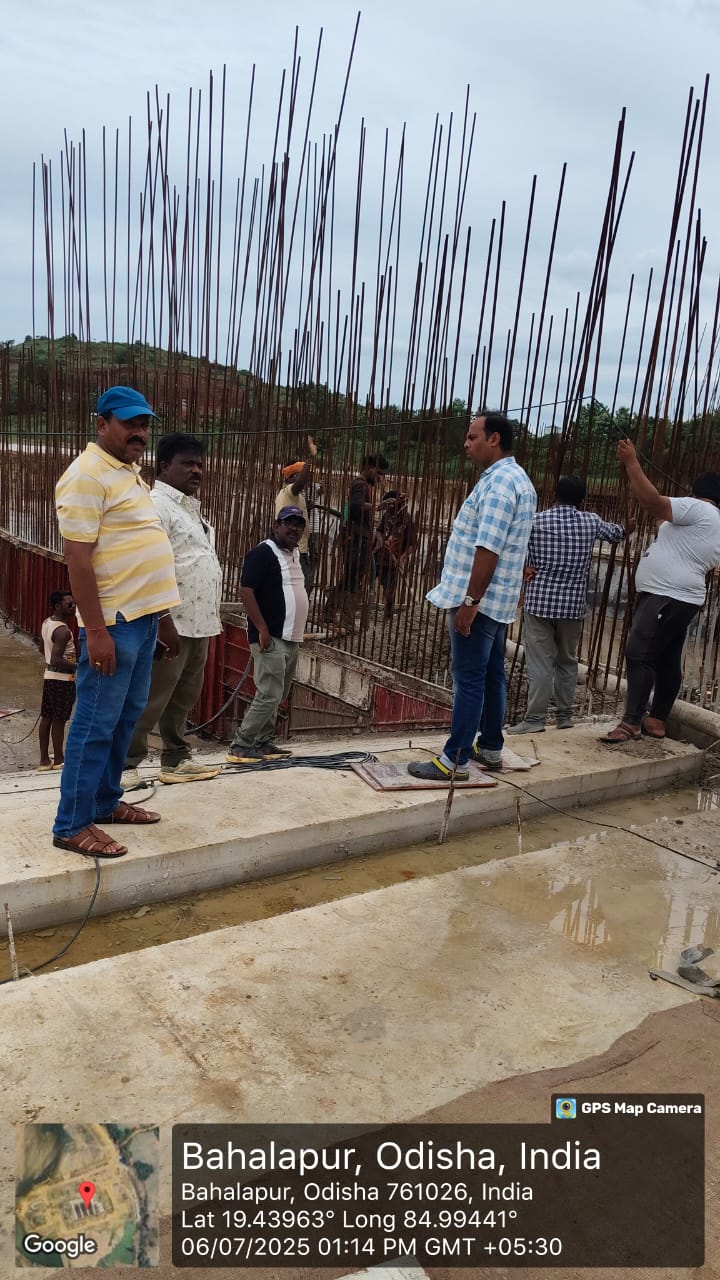

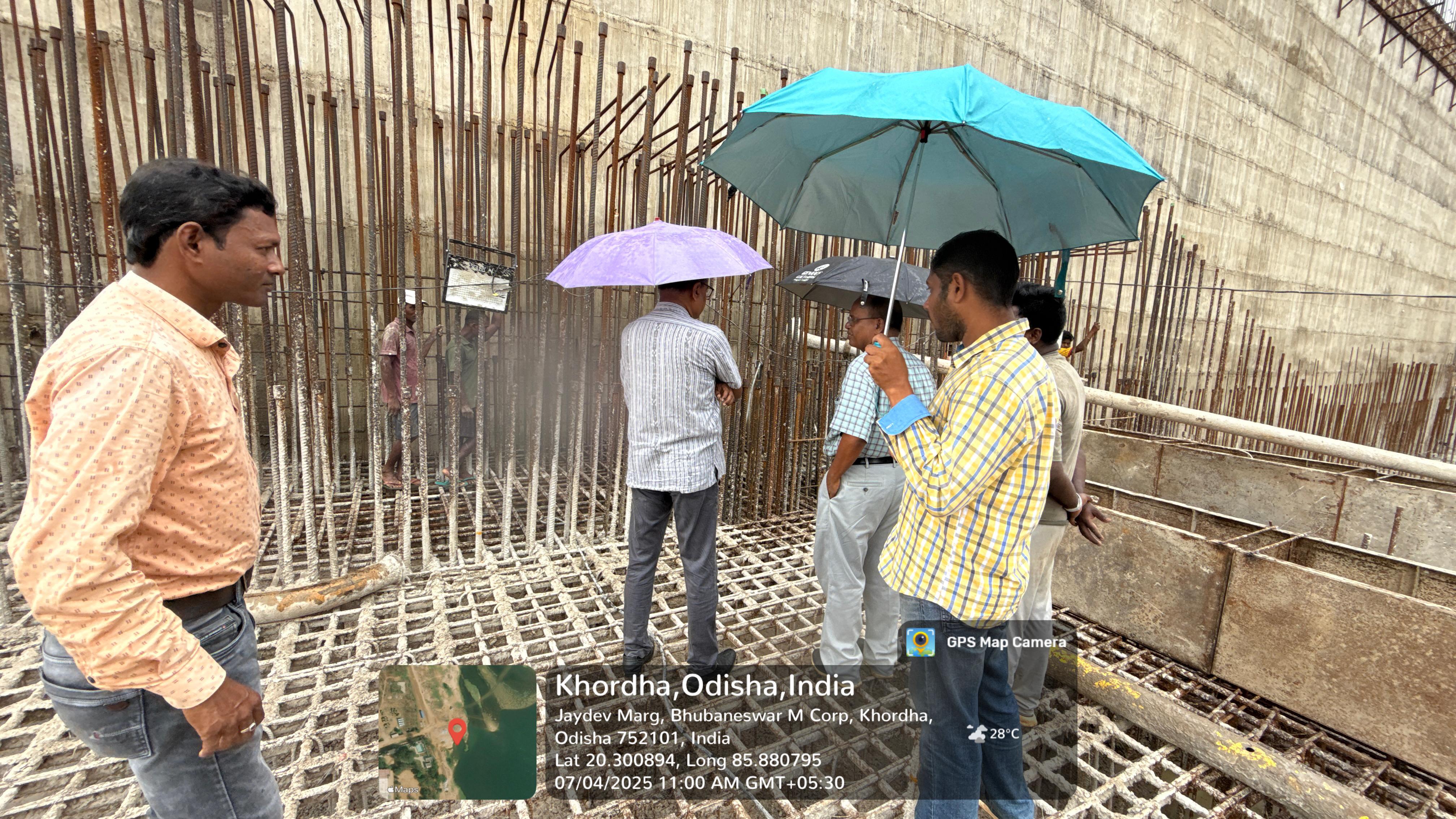

Instream Storage Structure, Hamirpur

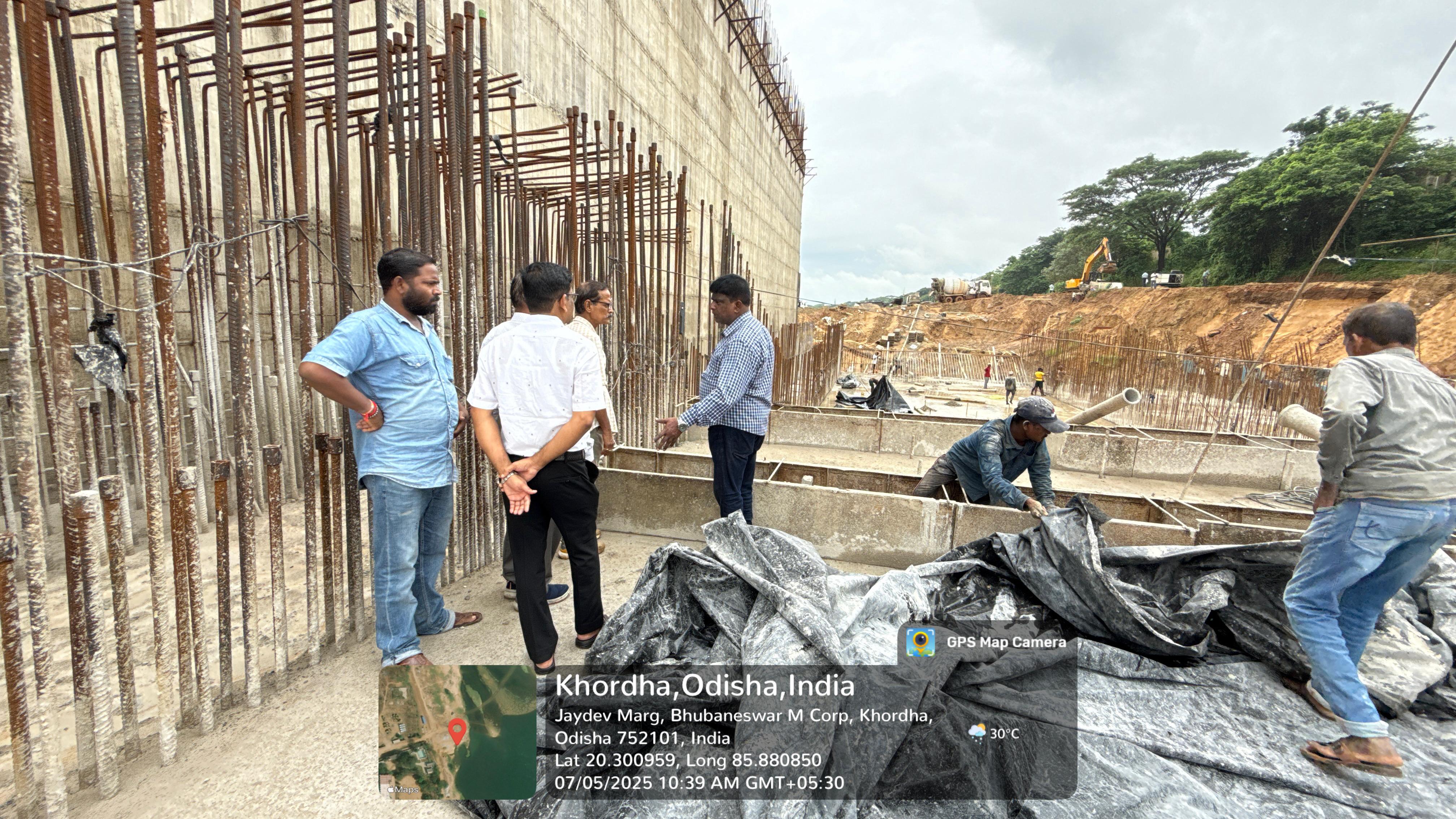

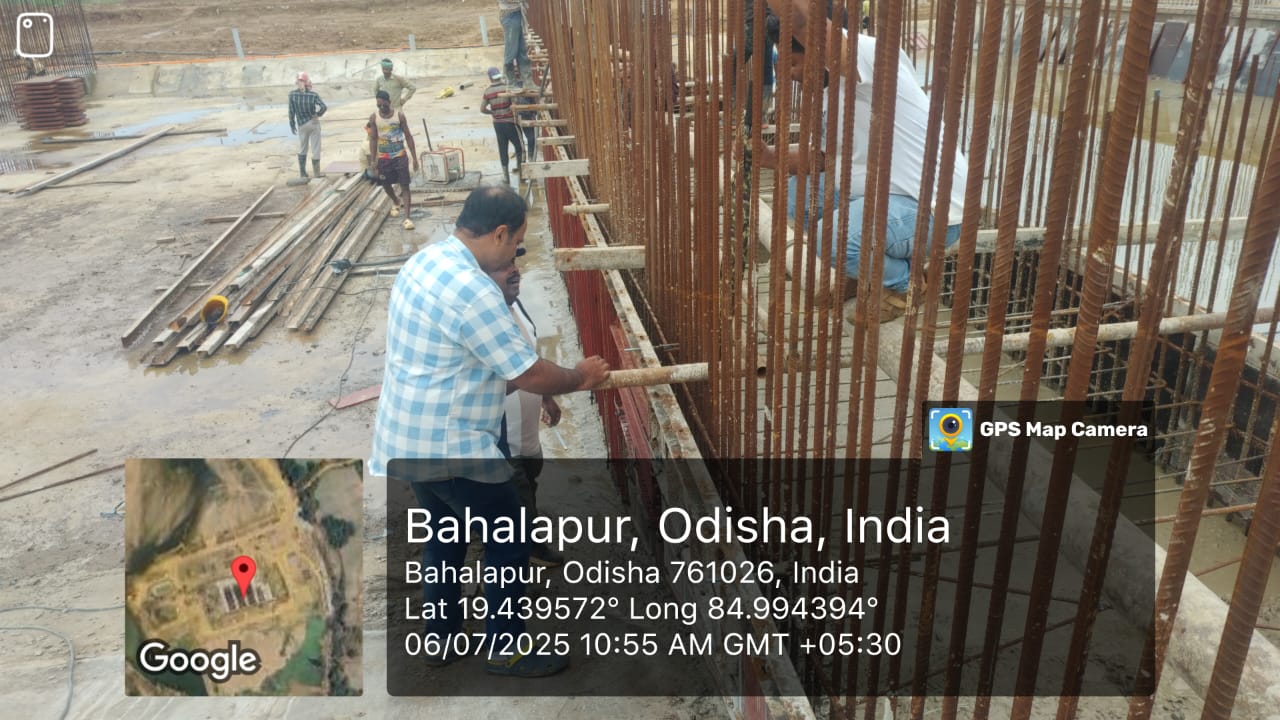

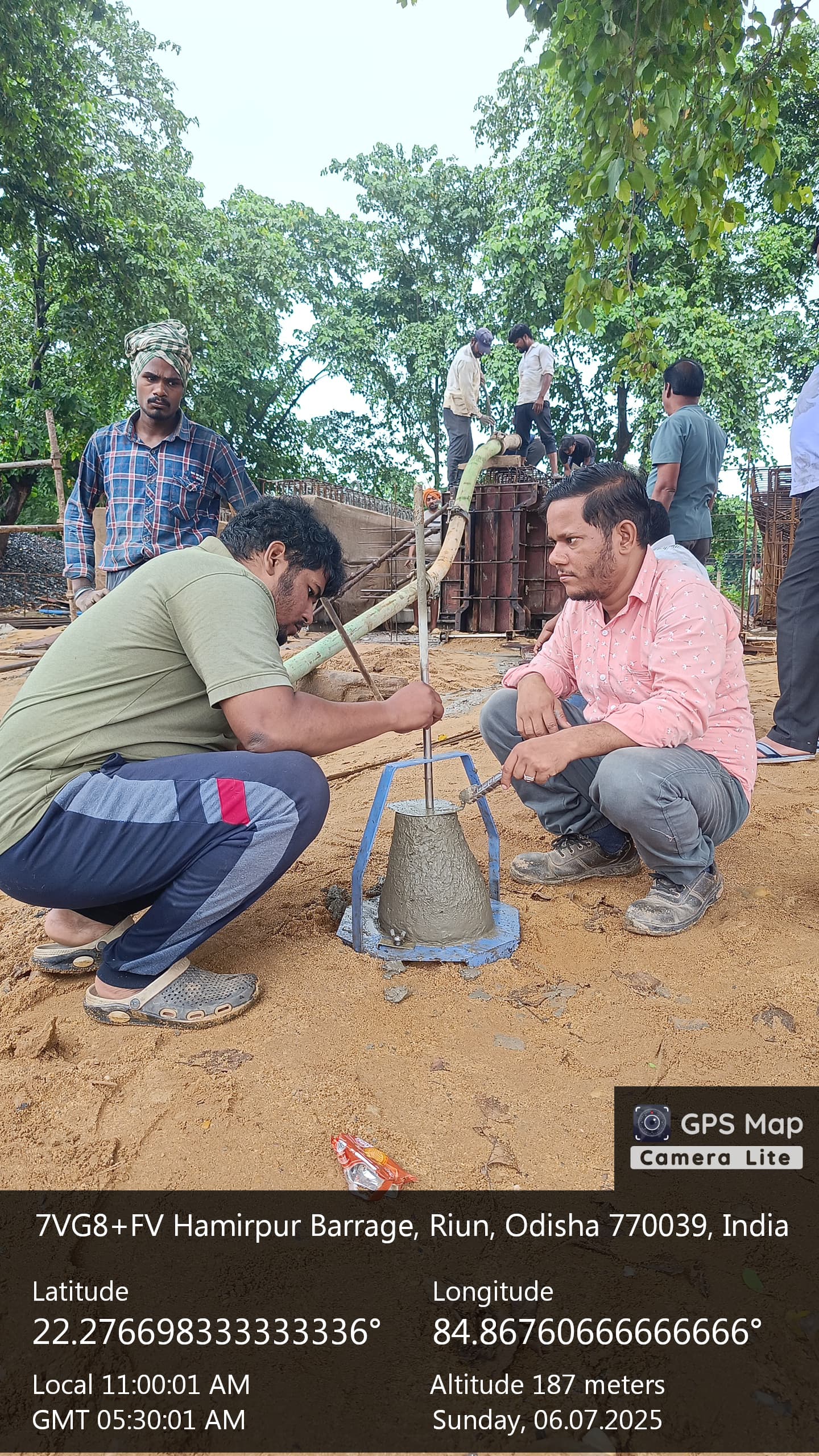

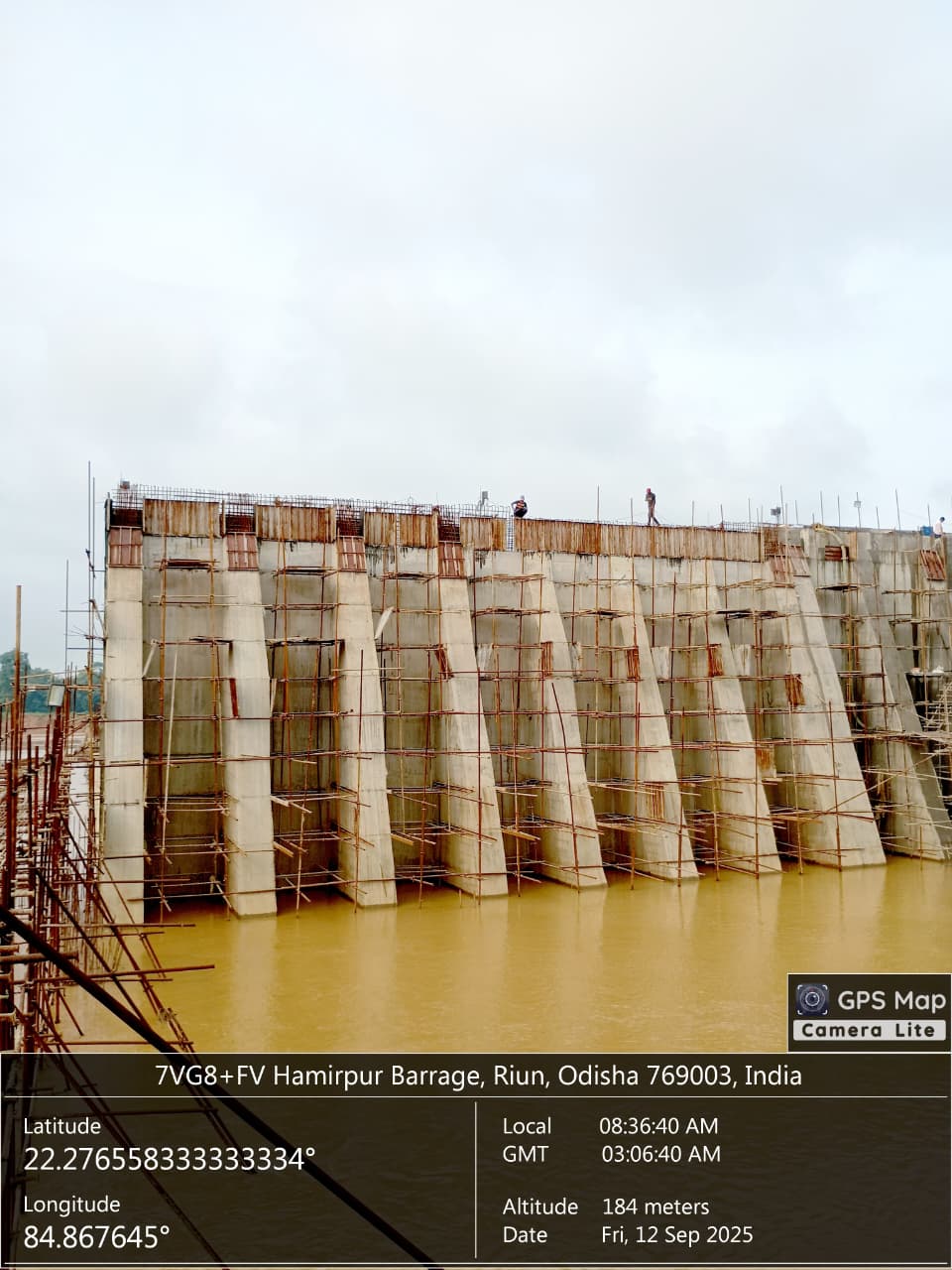

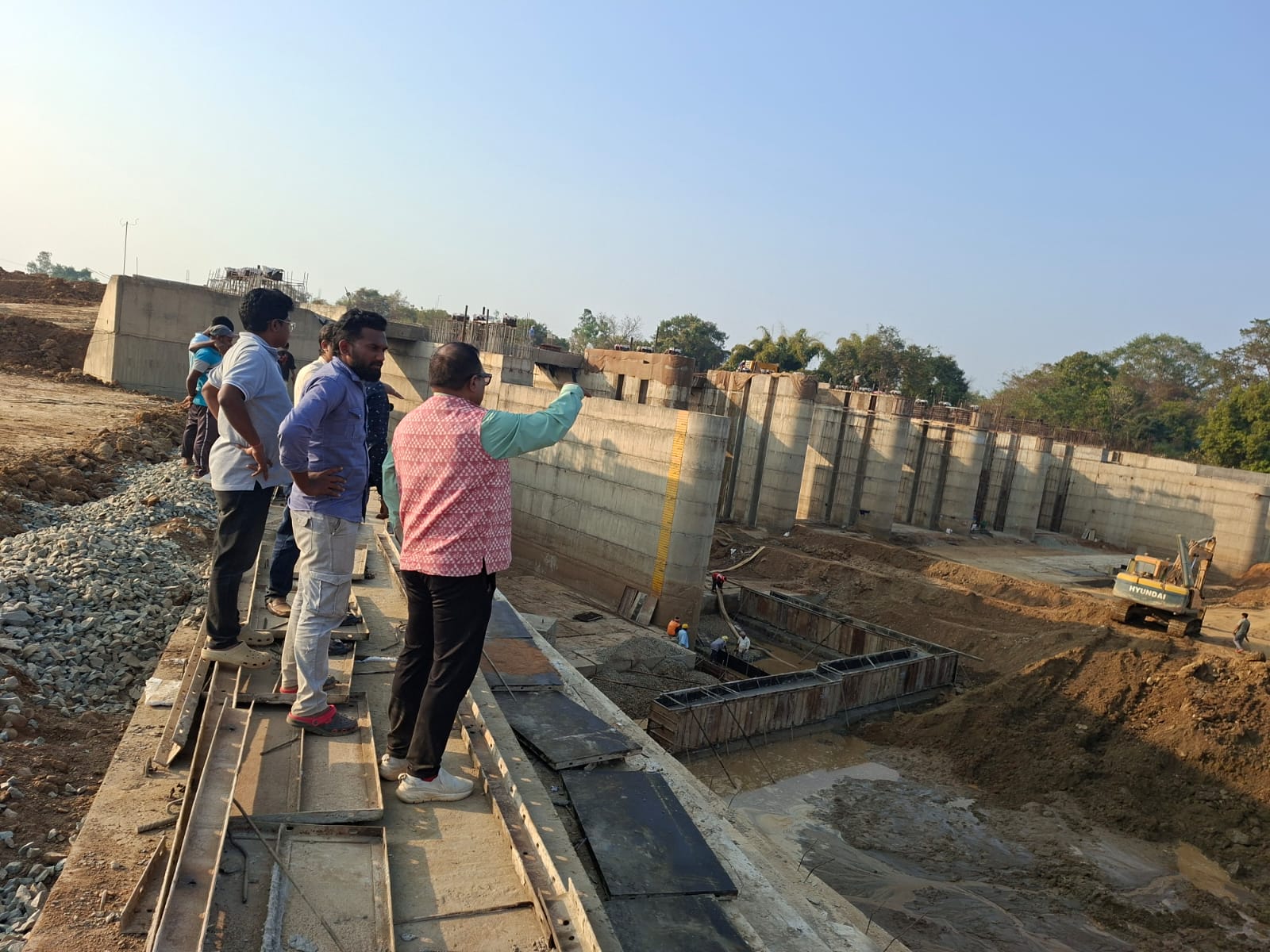

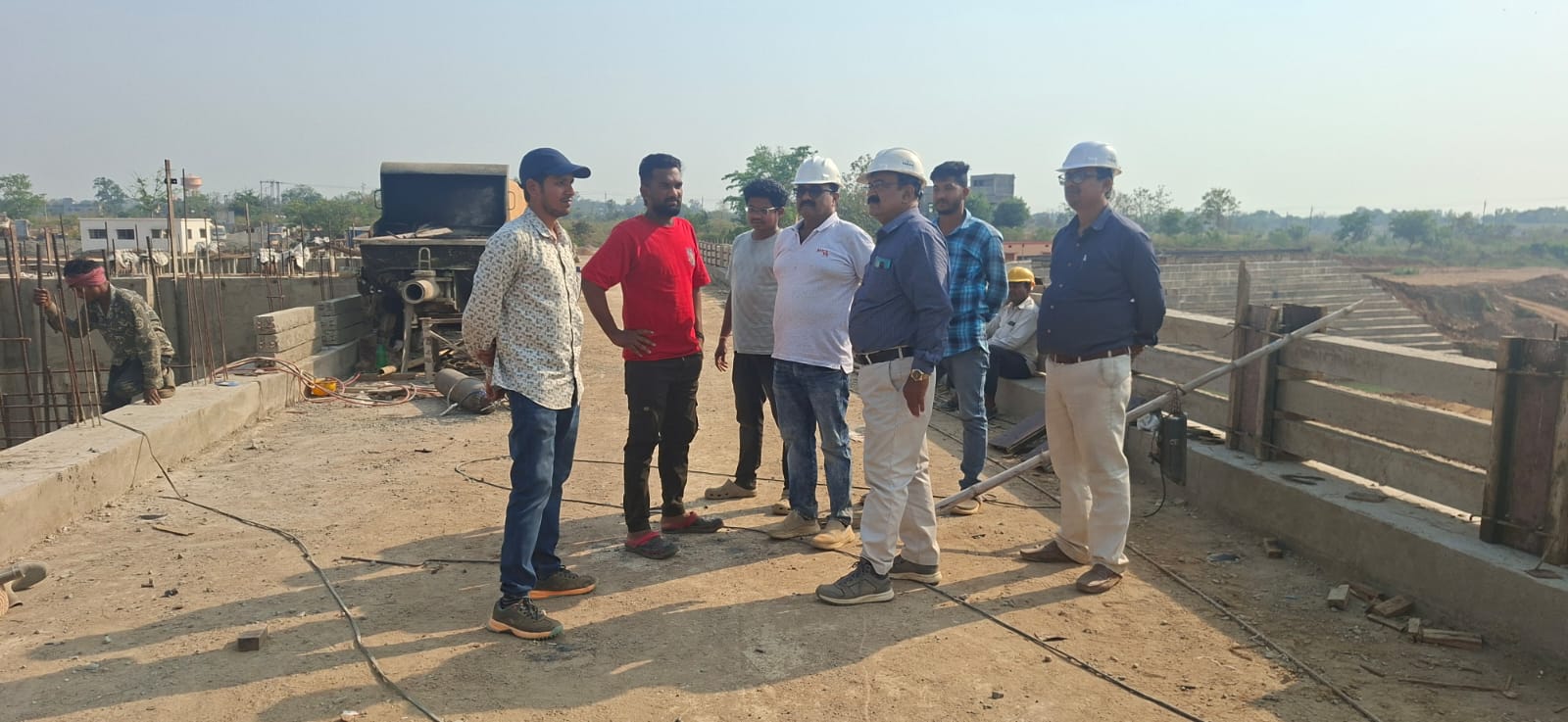

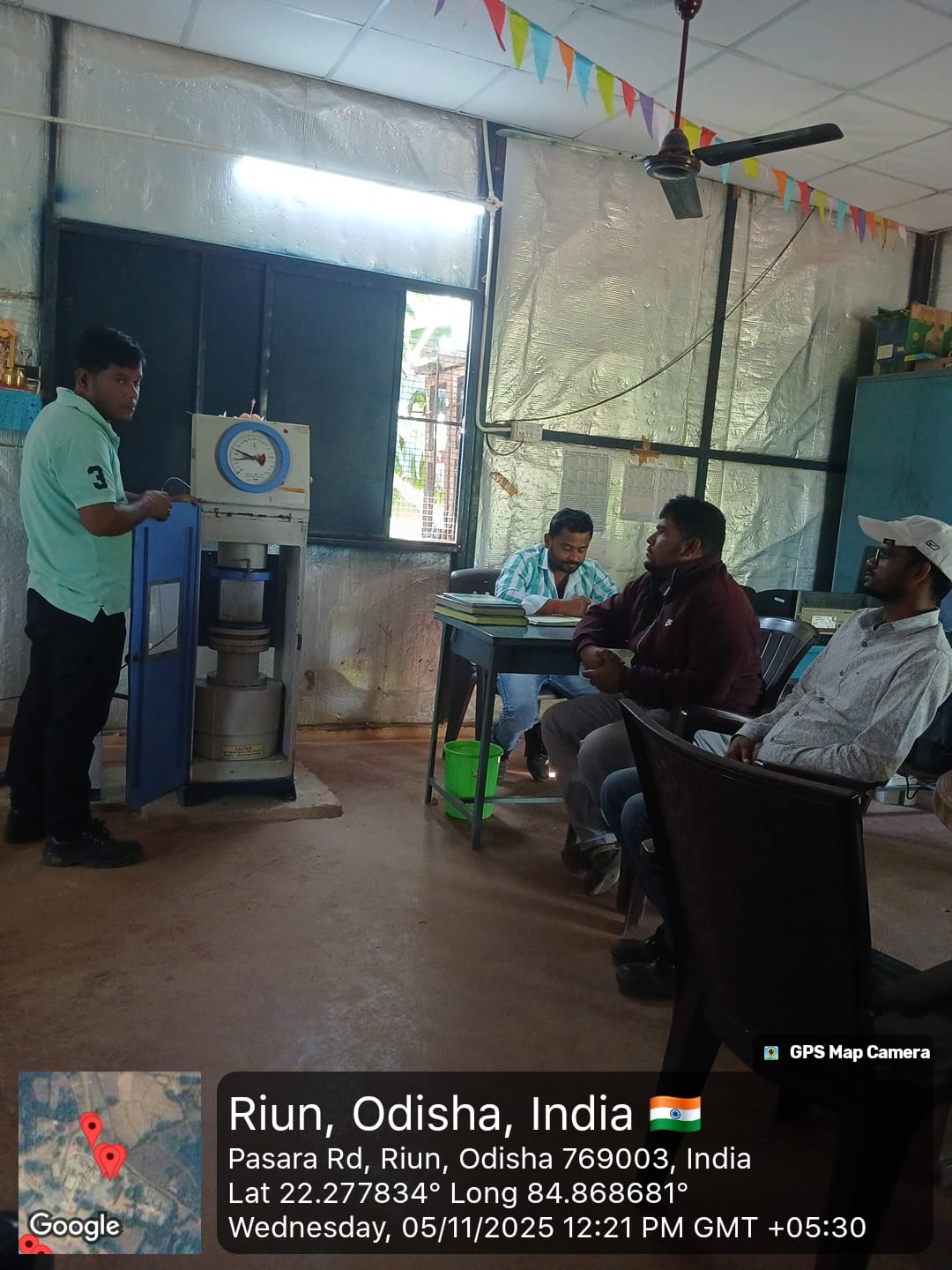

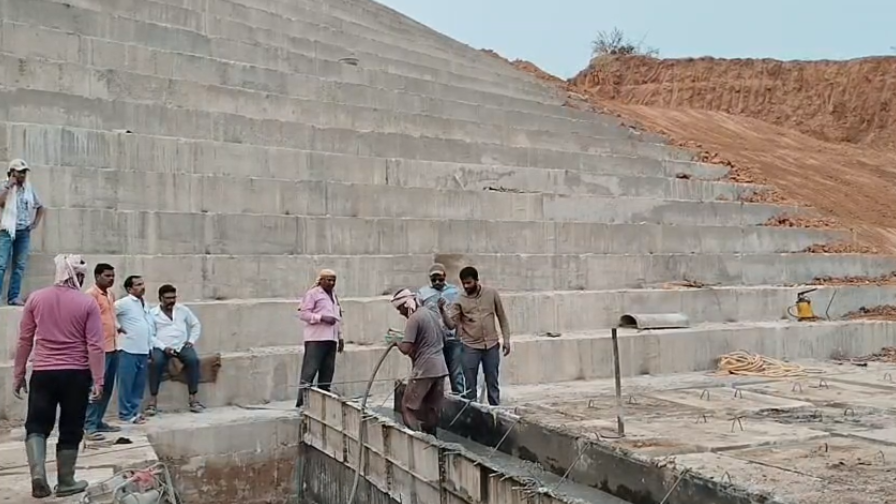

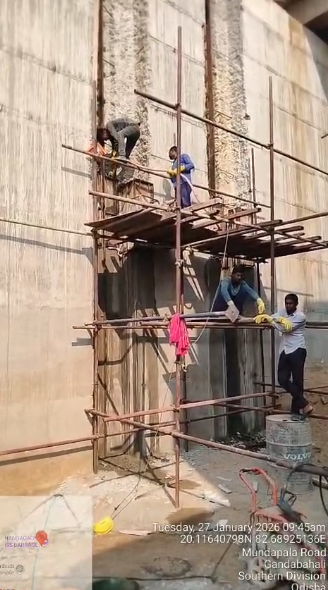

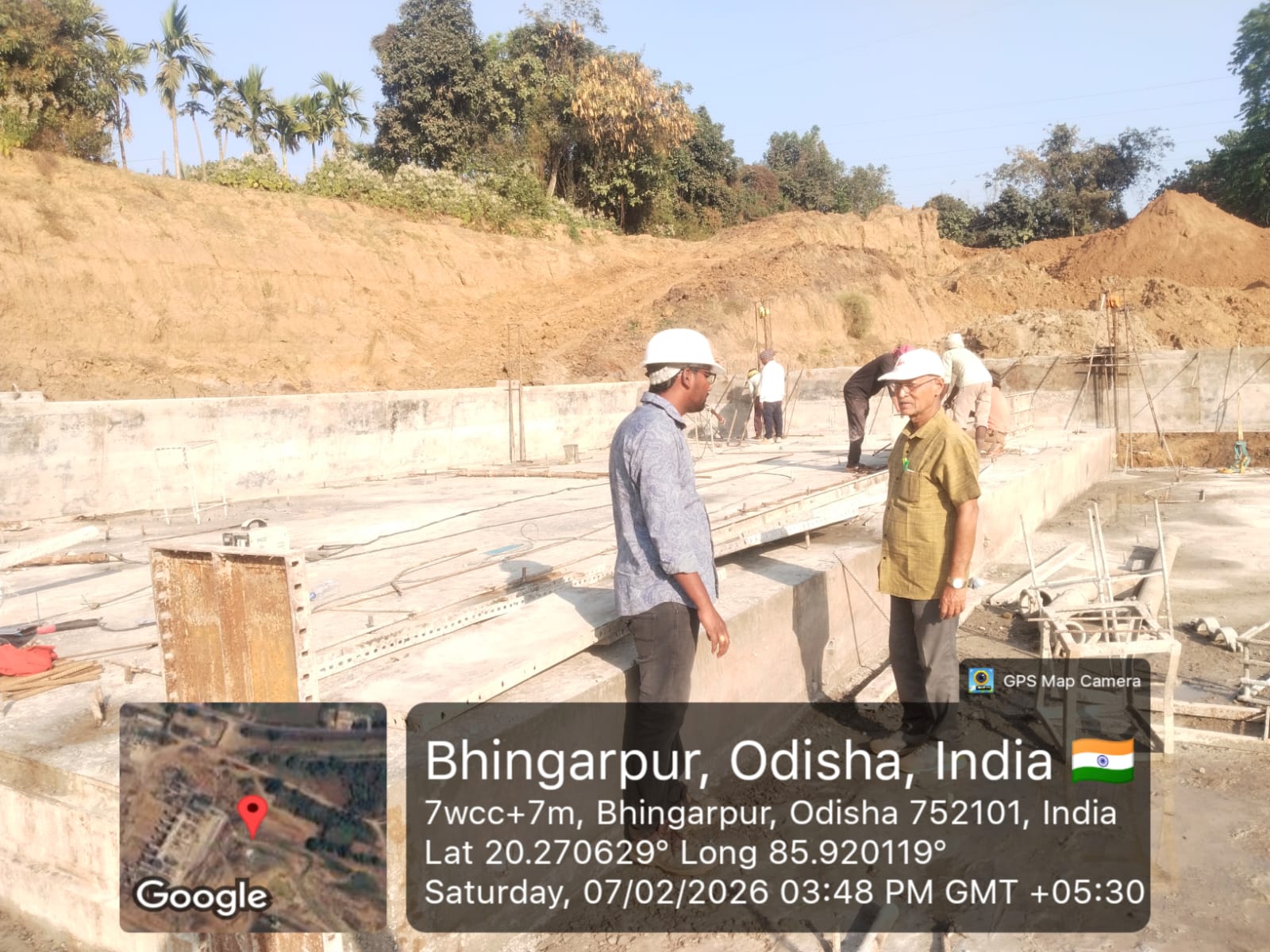

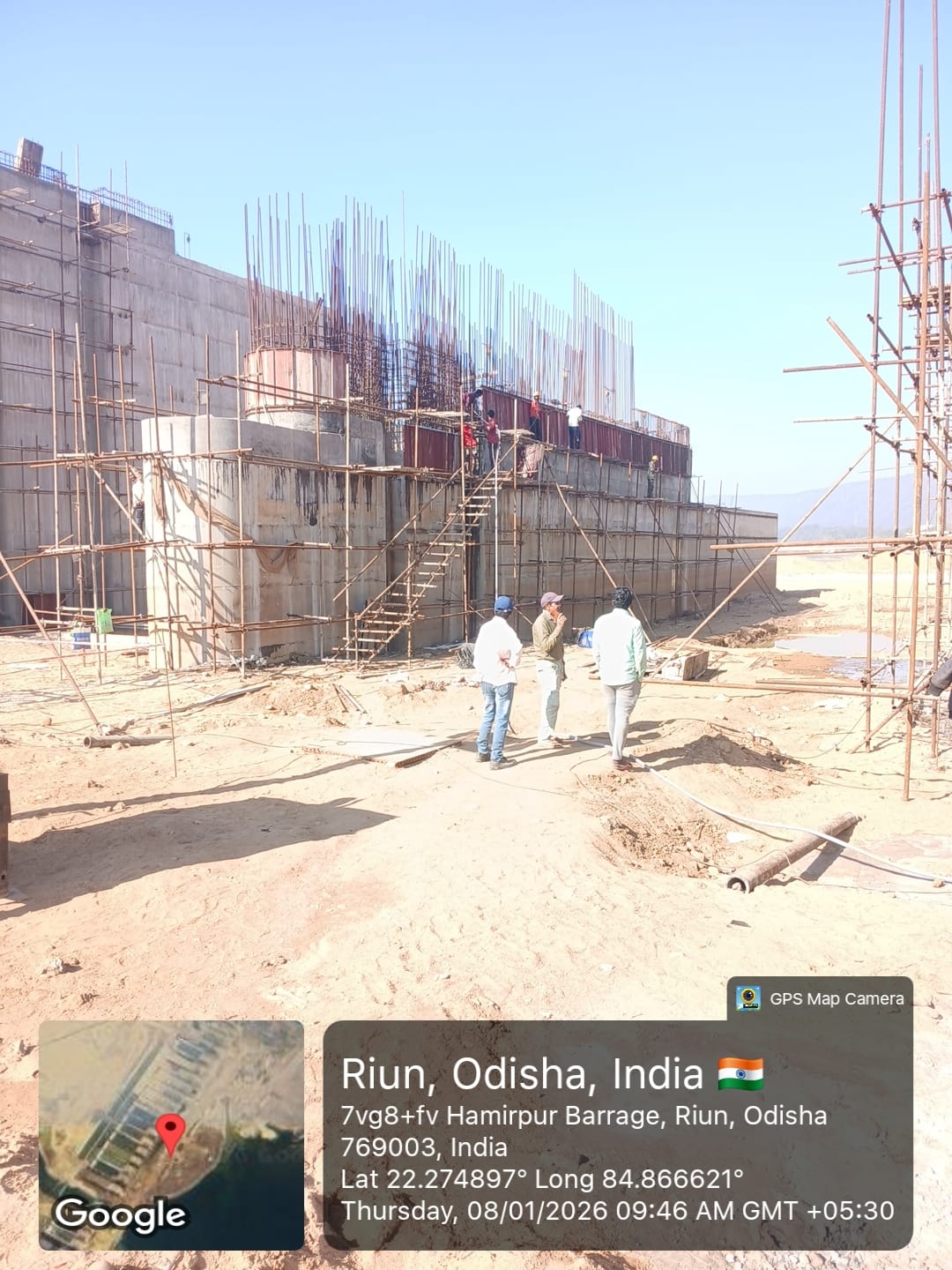

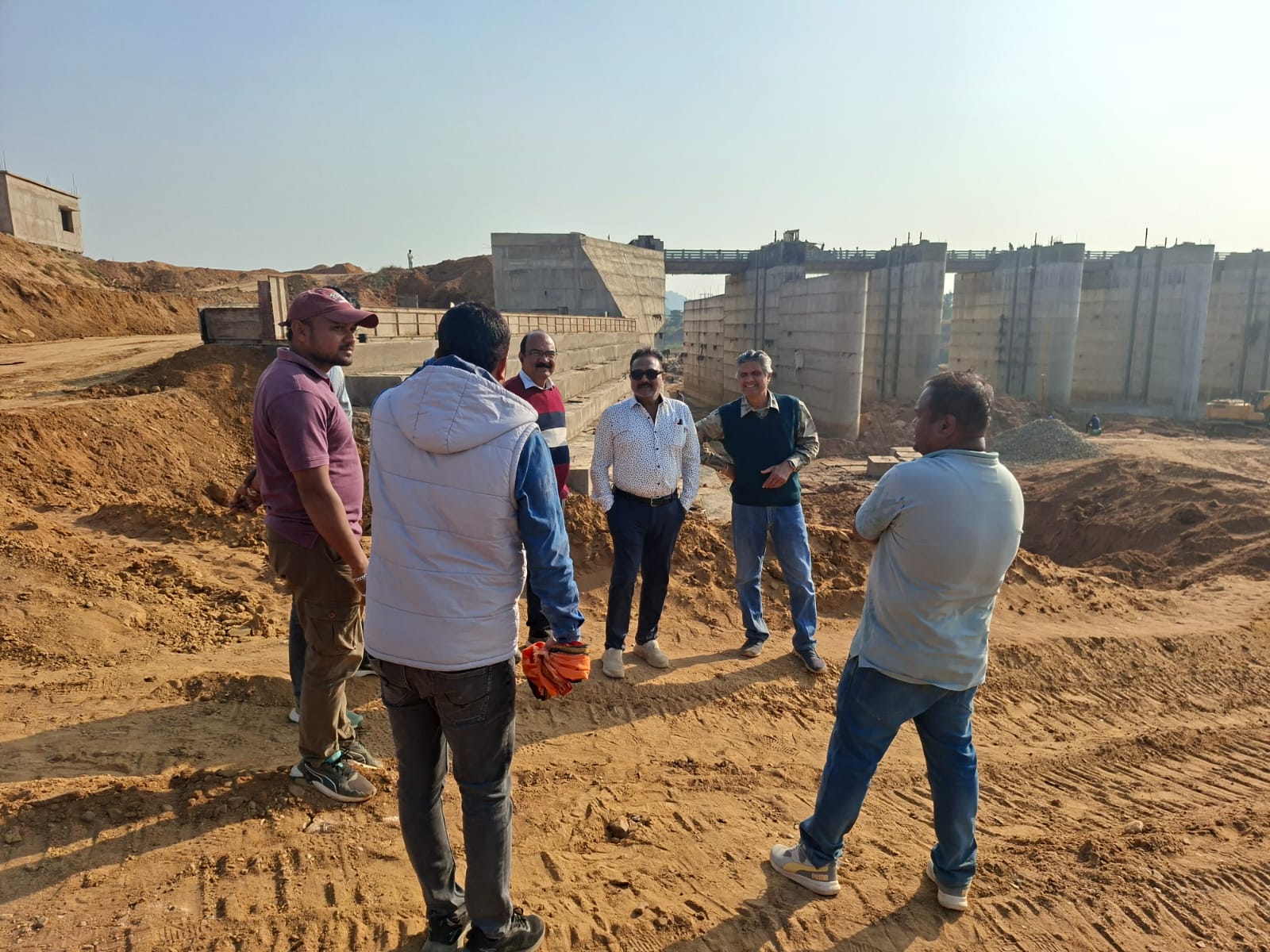

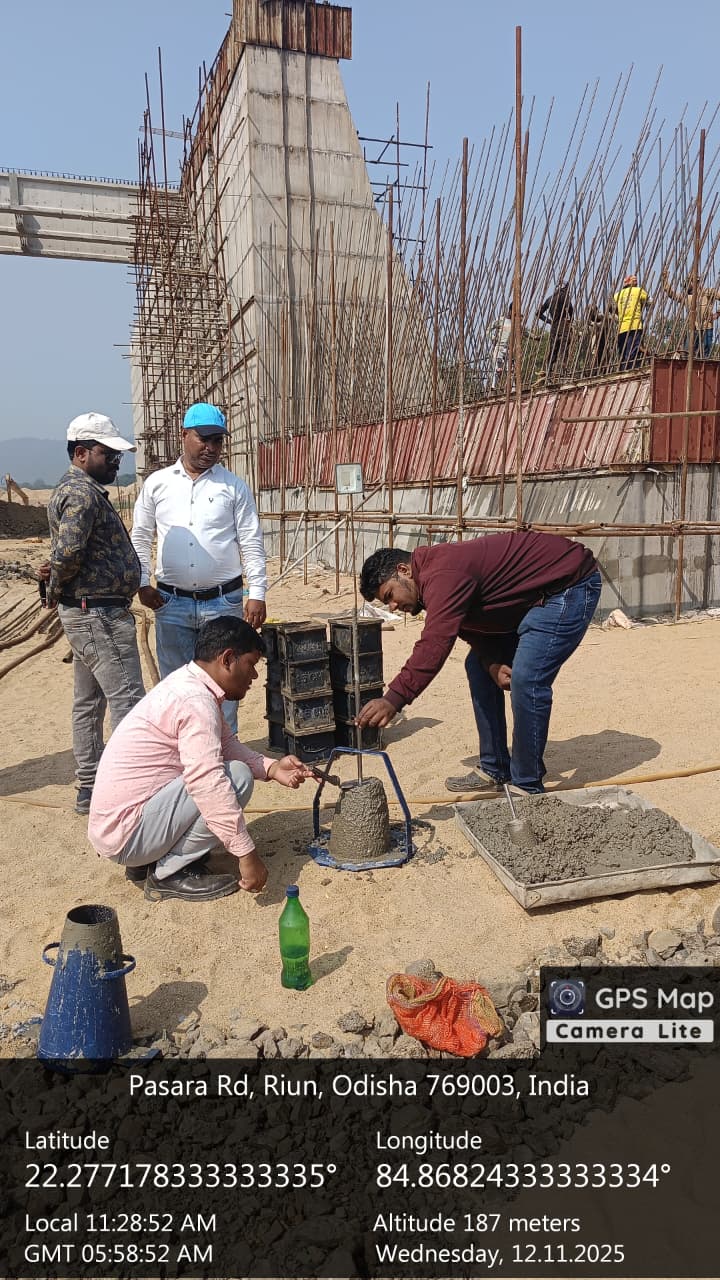

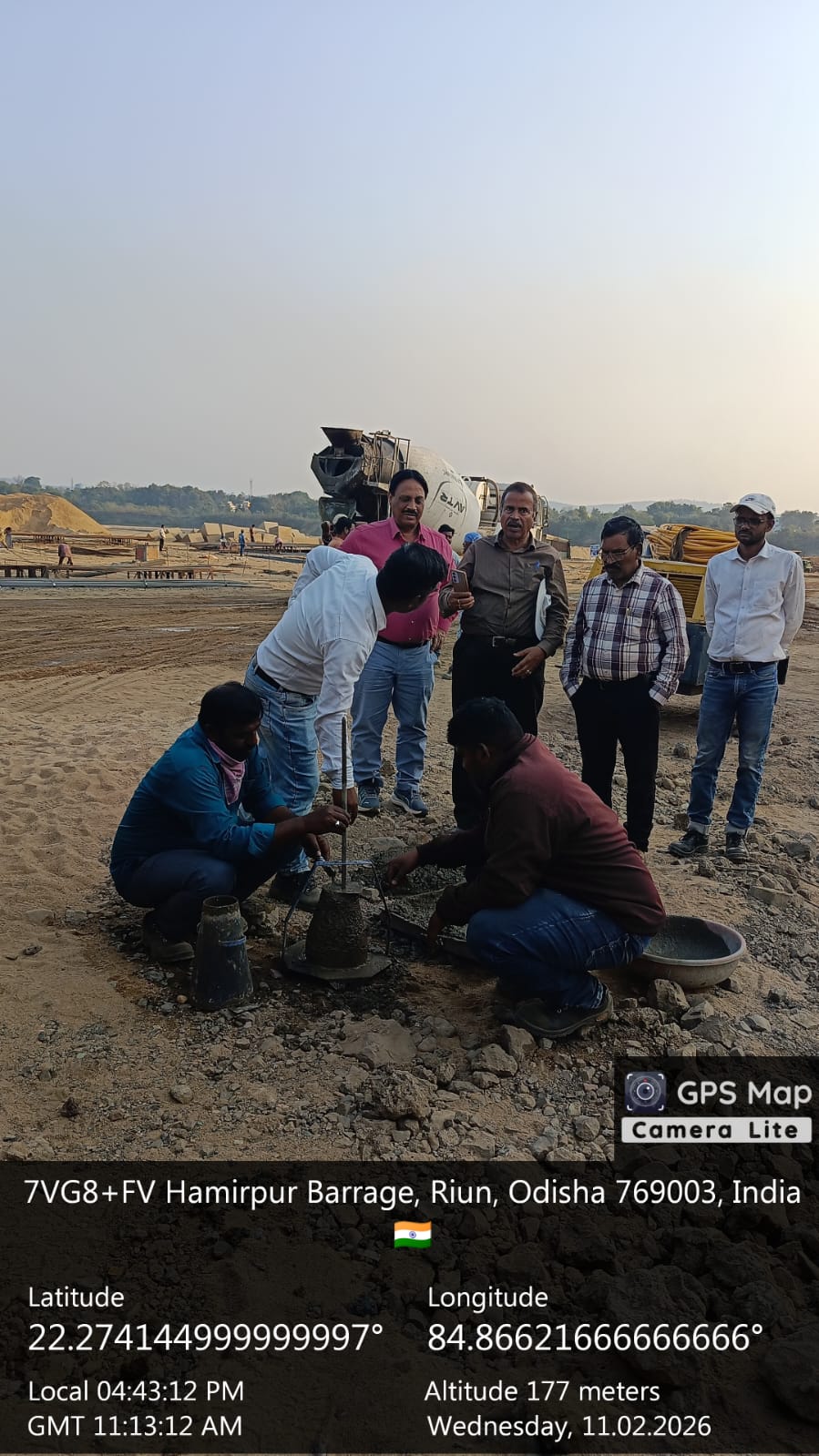

Visited by S.E, RID, A.E.E, A.E RID of Client & PSS team along with representative of EPC agency at site.
38/100

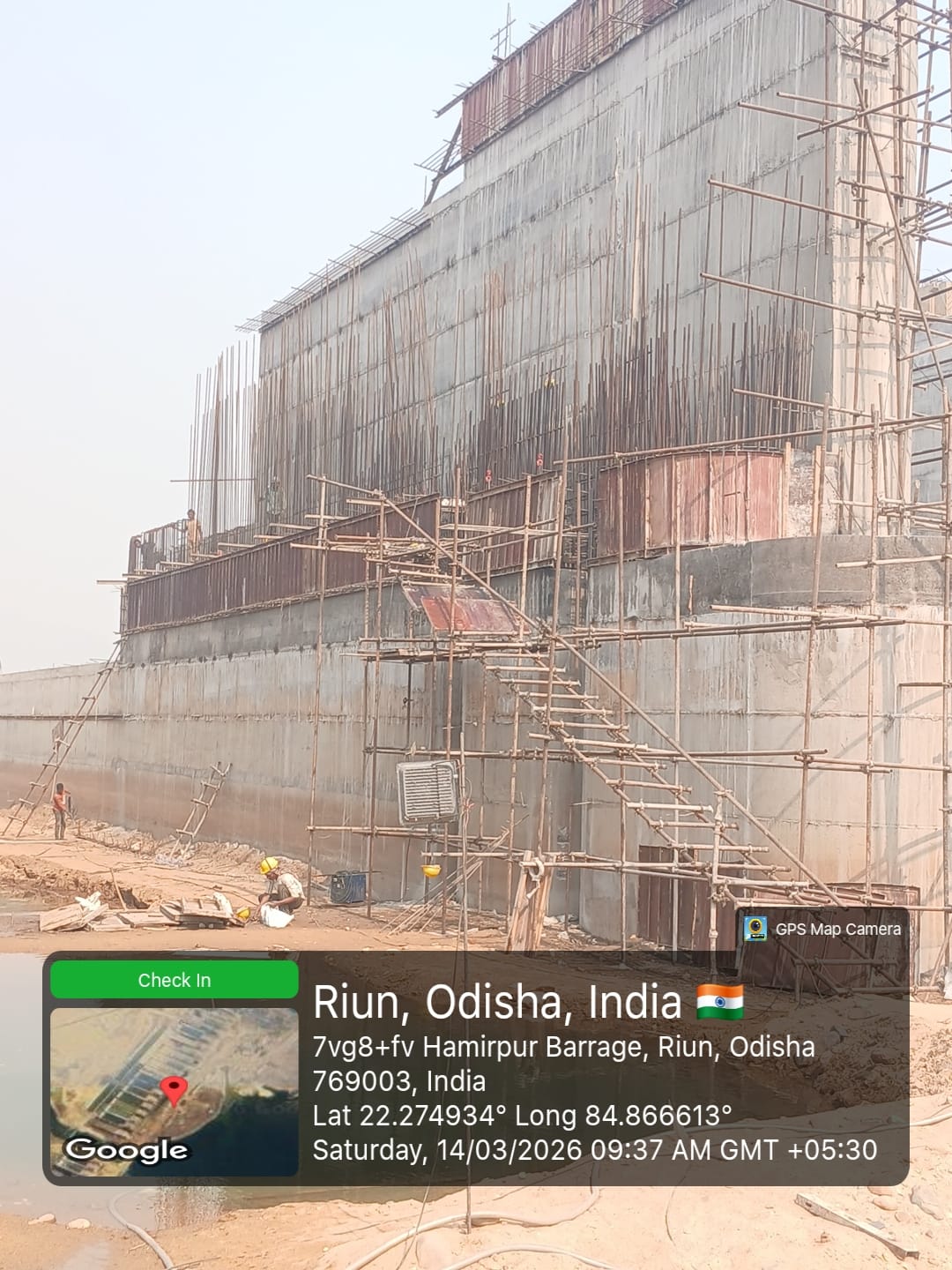

Instream Storage Structure, Hamirpur

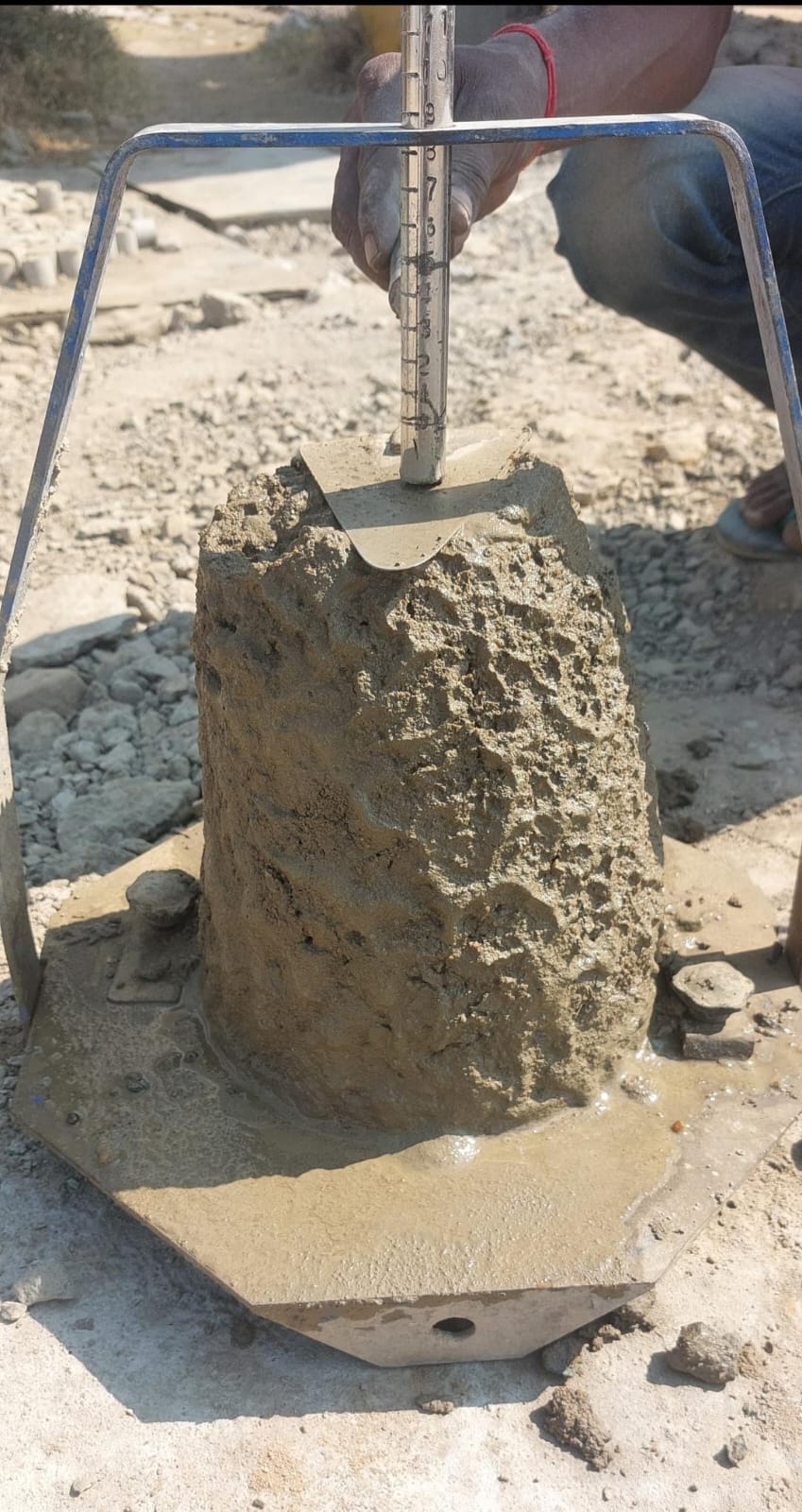

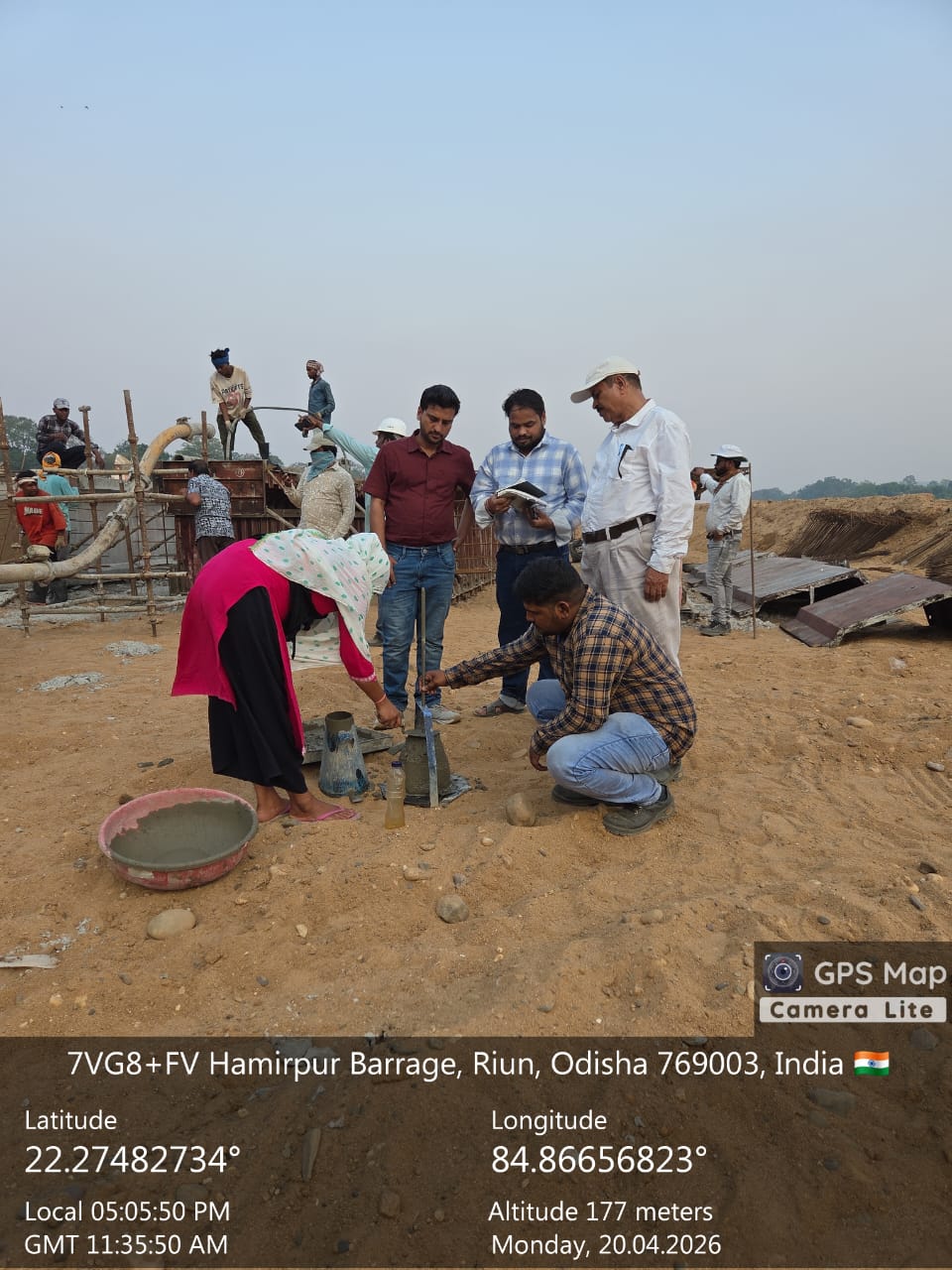

Slump testing M35A20 (Value 85 mm) of Slab hand railing at Block No-4 done in presence of Client & PSS Team.

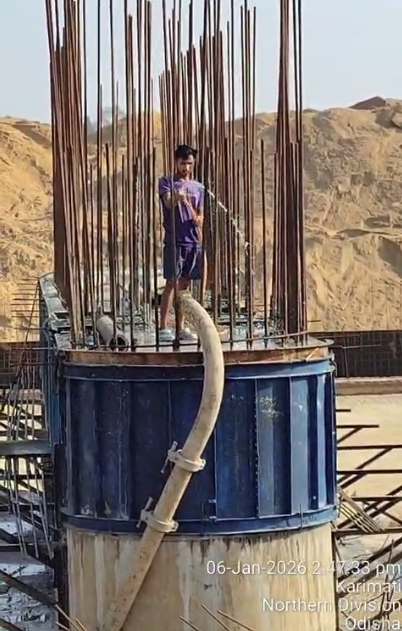

39/100

Instream Storage Structure, Hamirpur

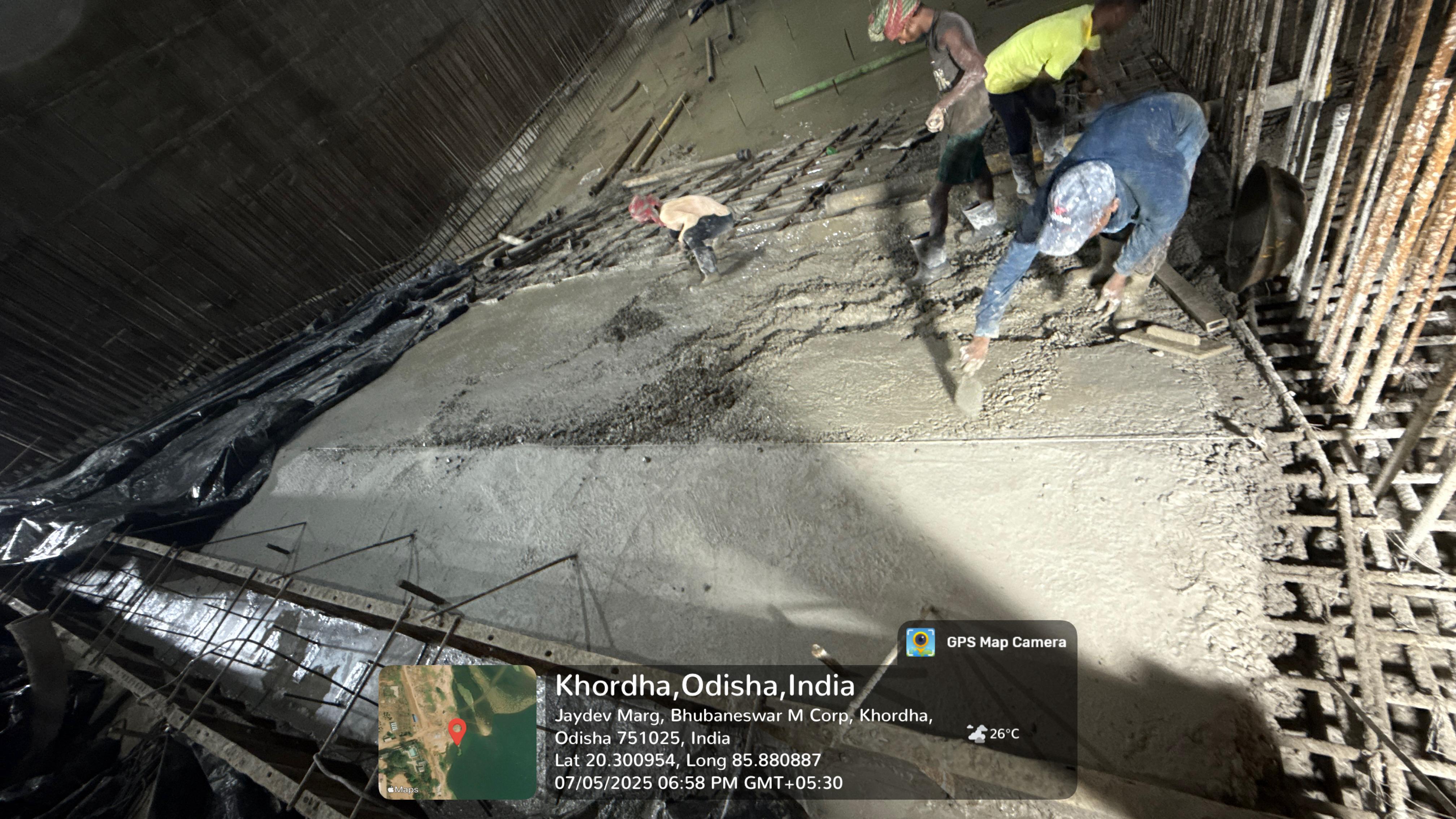

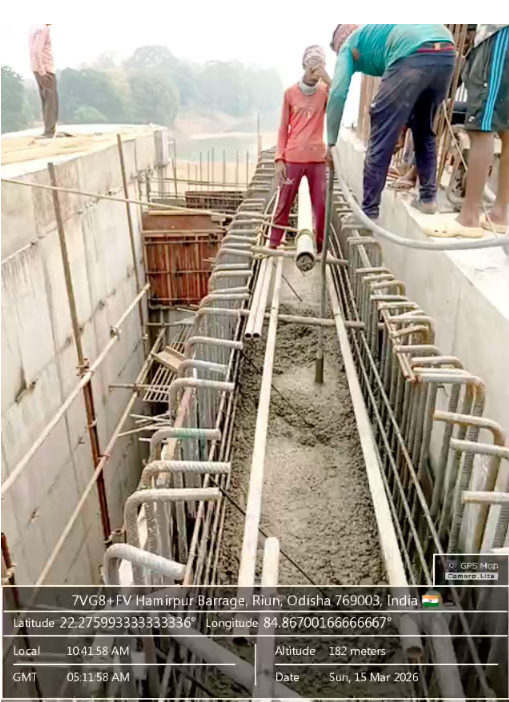

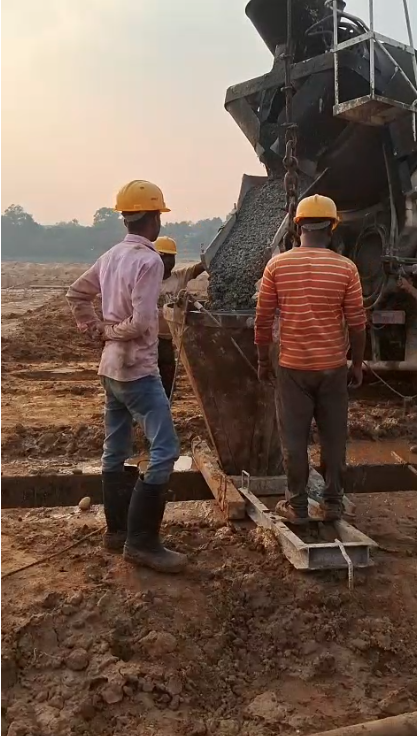

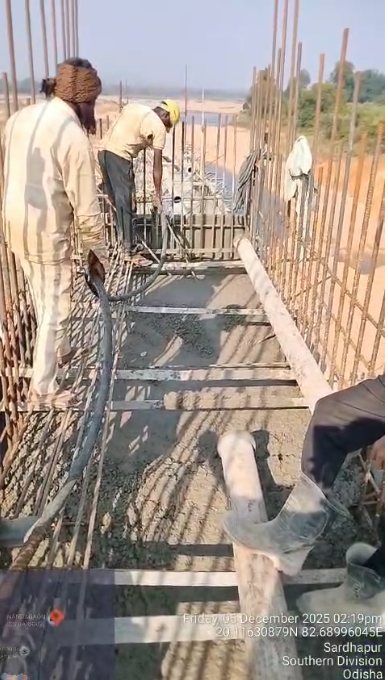

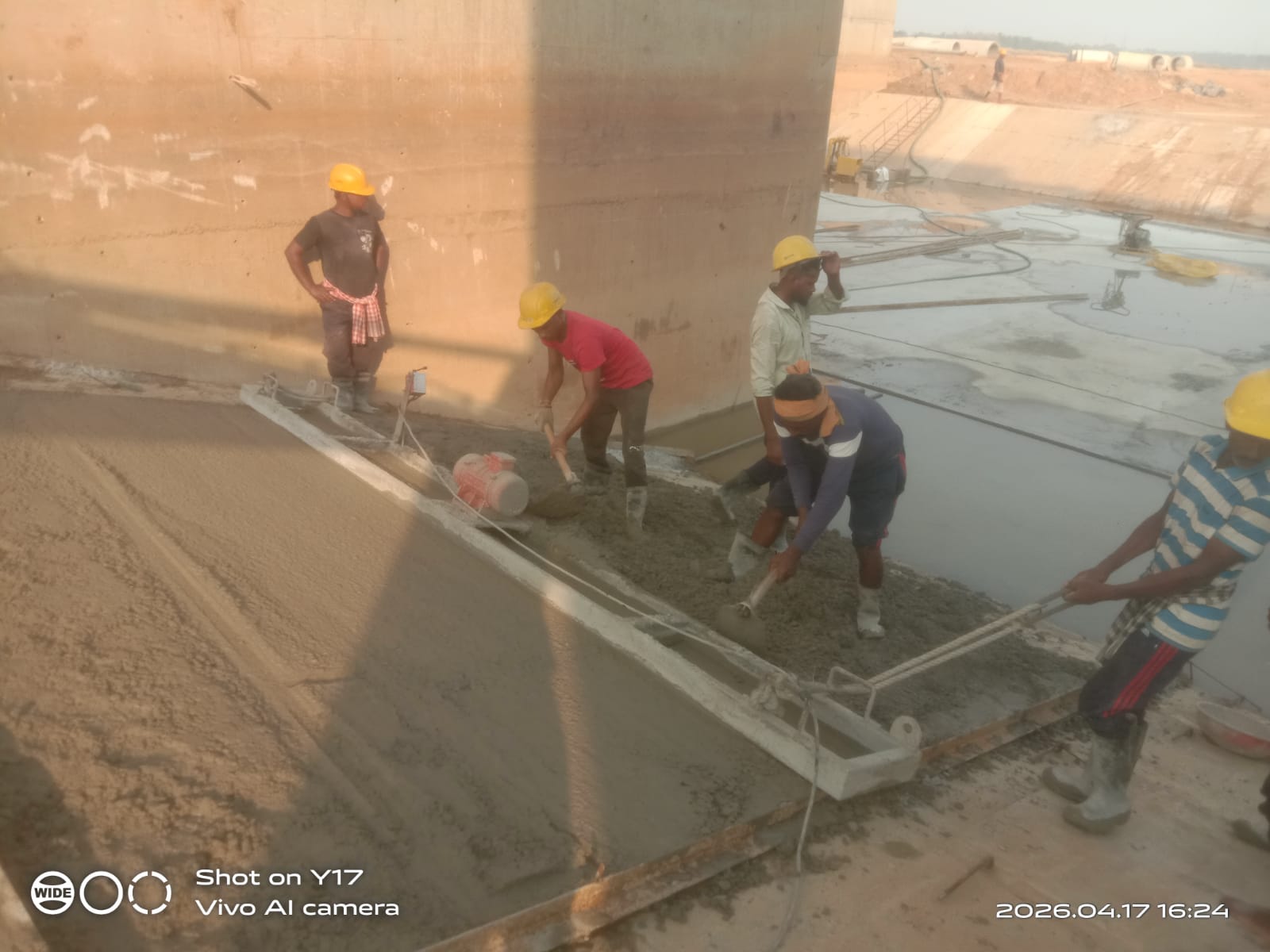

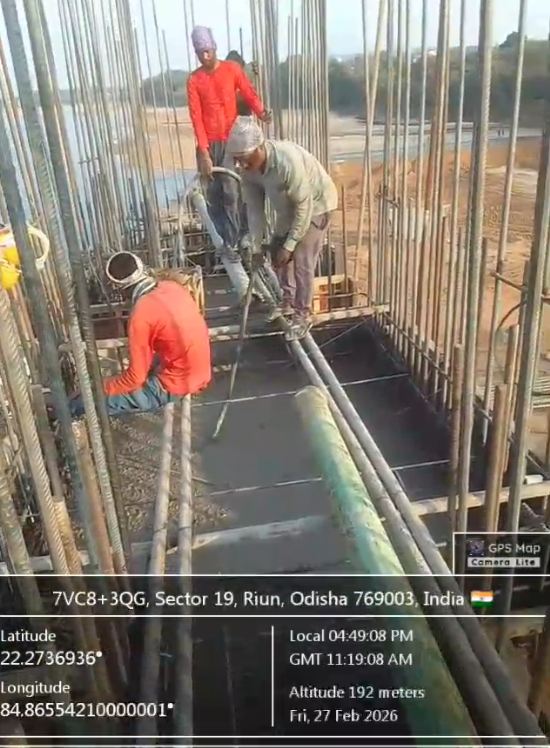

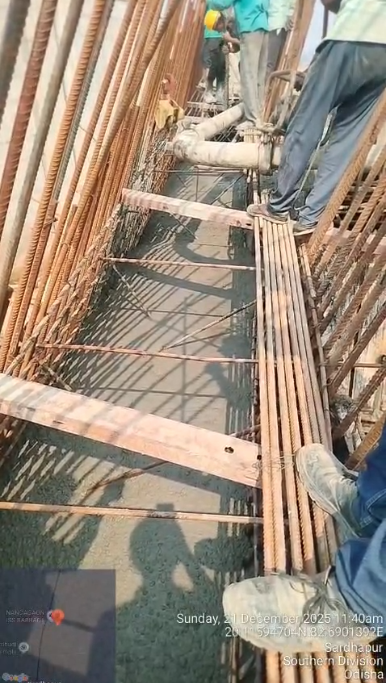

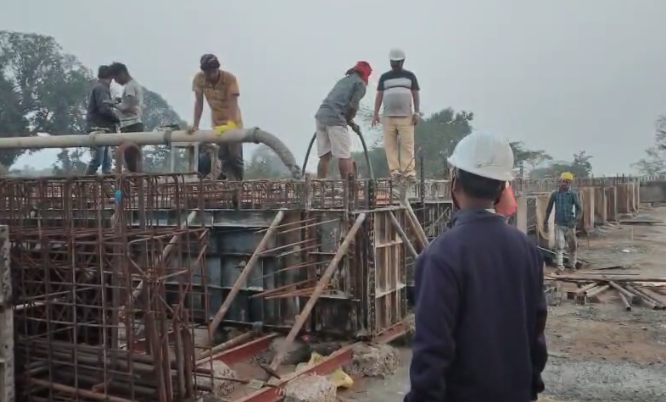

Concreting M35A20 of Slab hand railing at Block No-4 is under progress in presence of Client & PSS Team.
40/100

Instream Storage Structure, Hamirpur

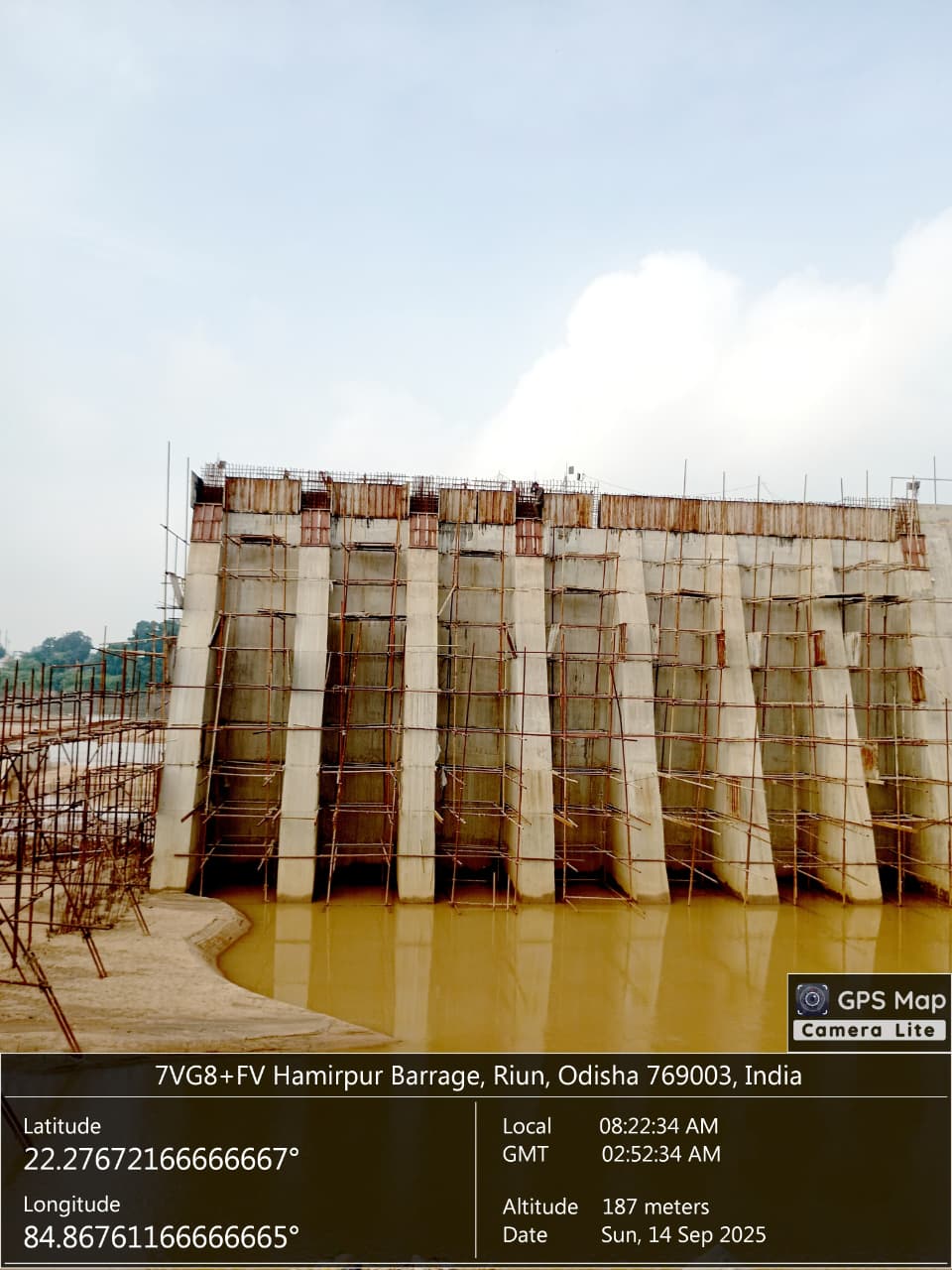

Present flow condition of river at Hamirpur site water level RL 179.620m.
41/100

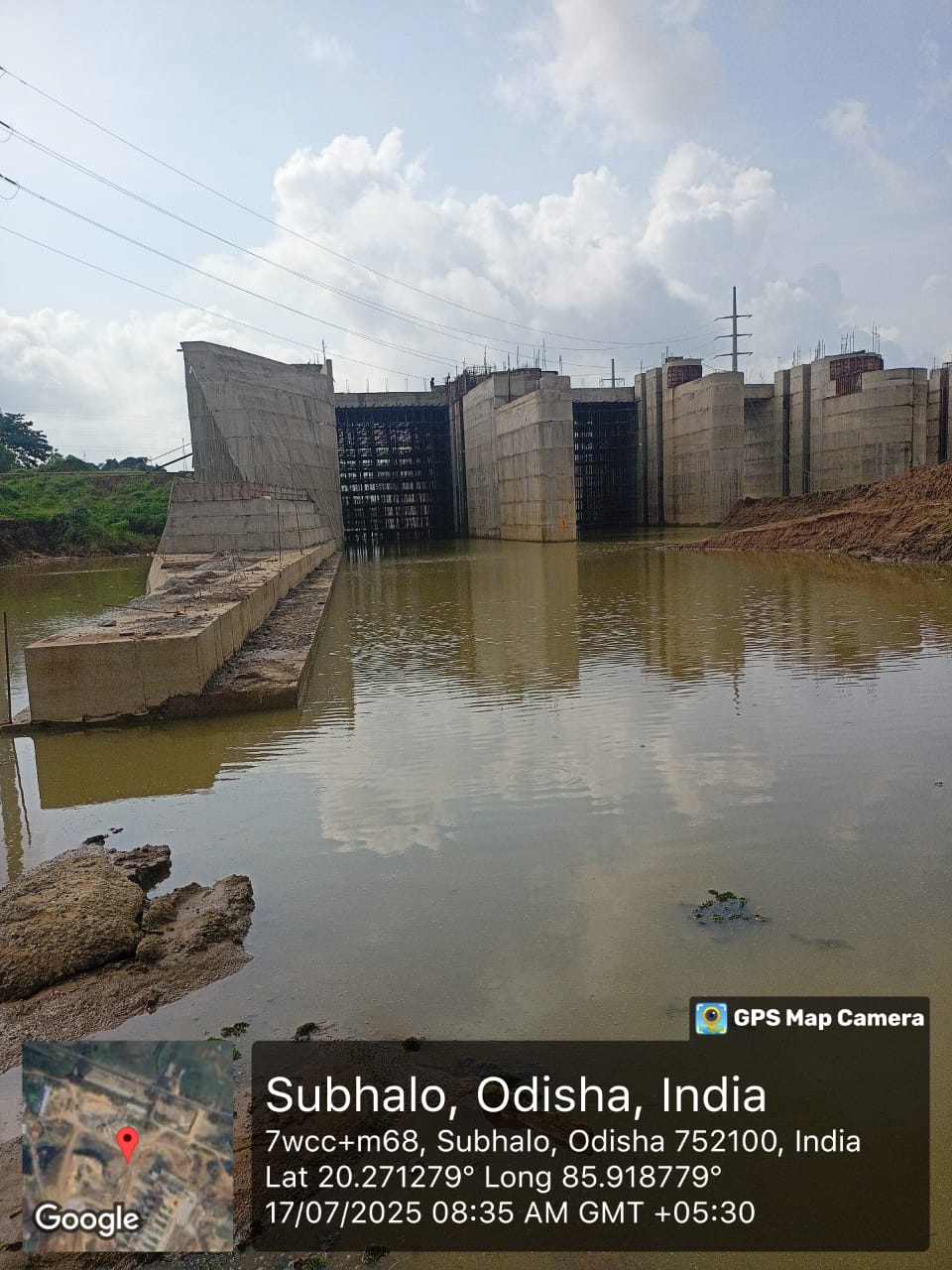

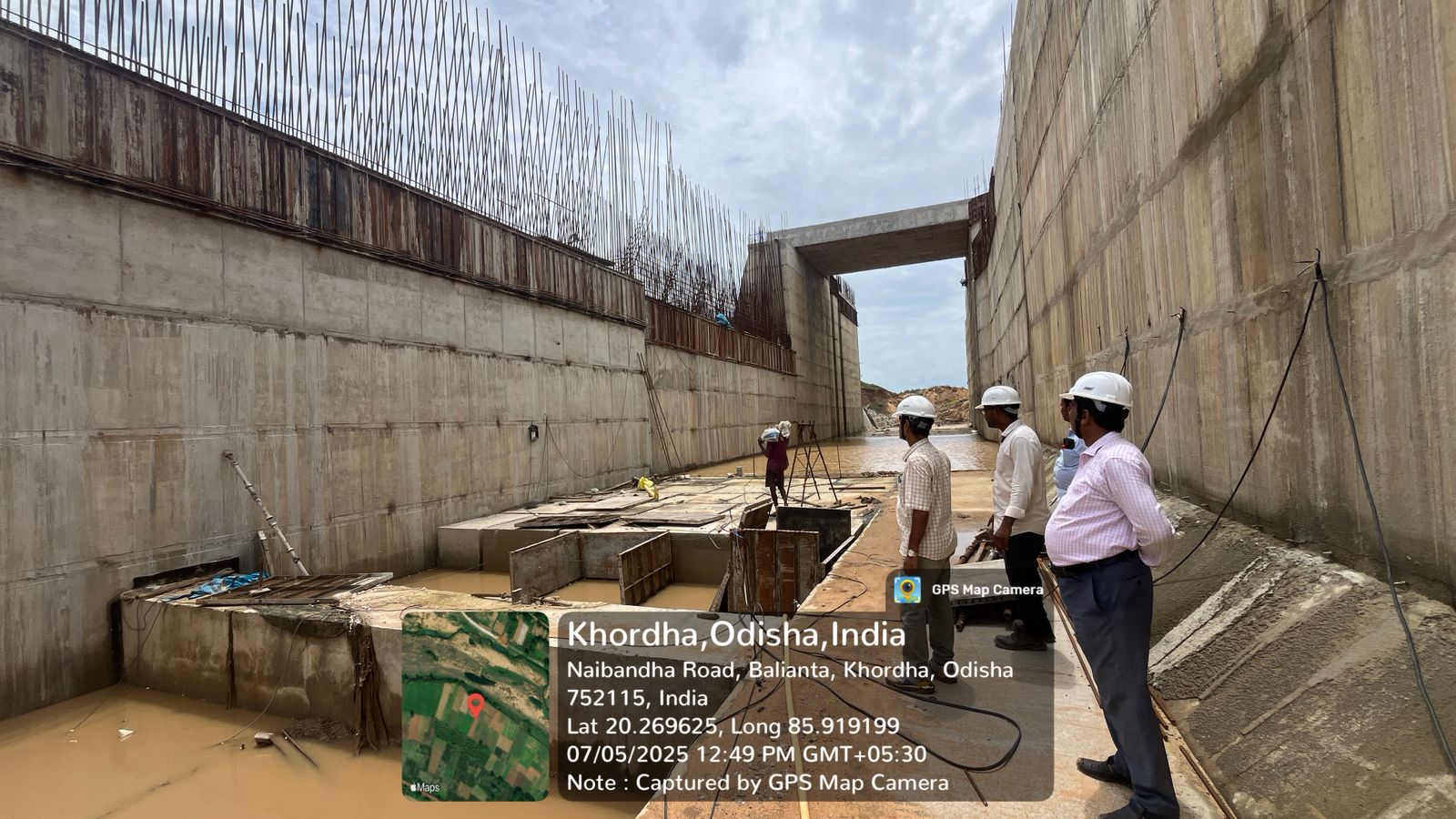

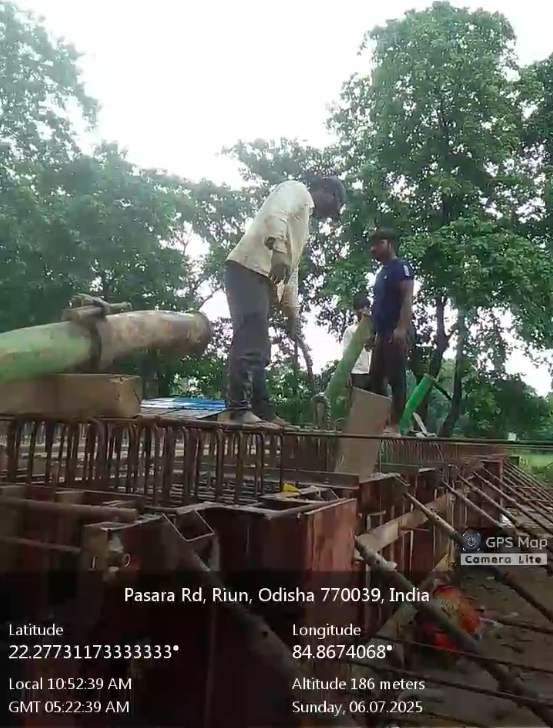

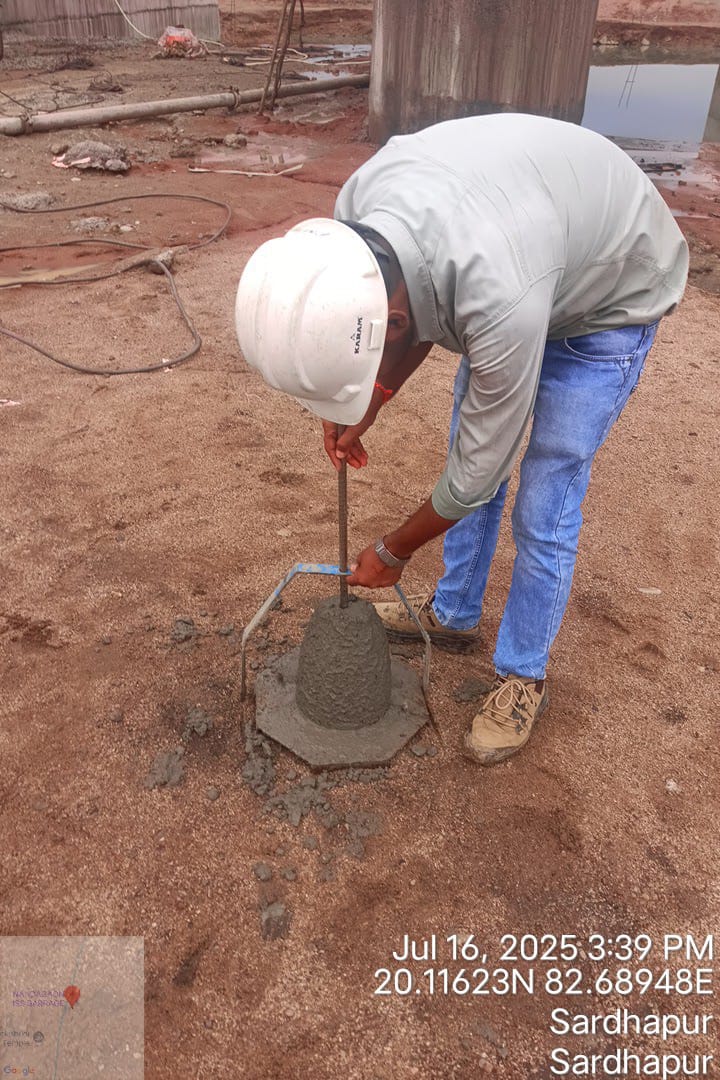

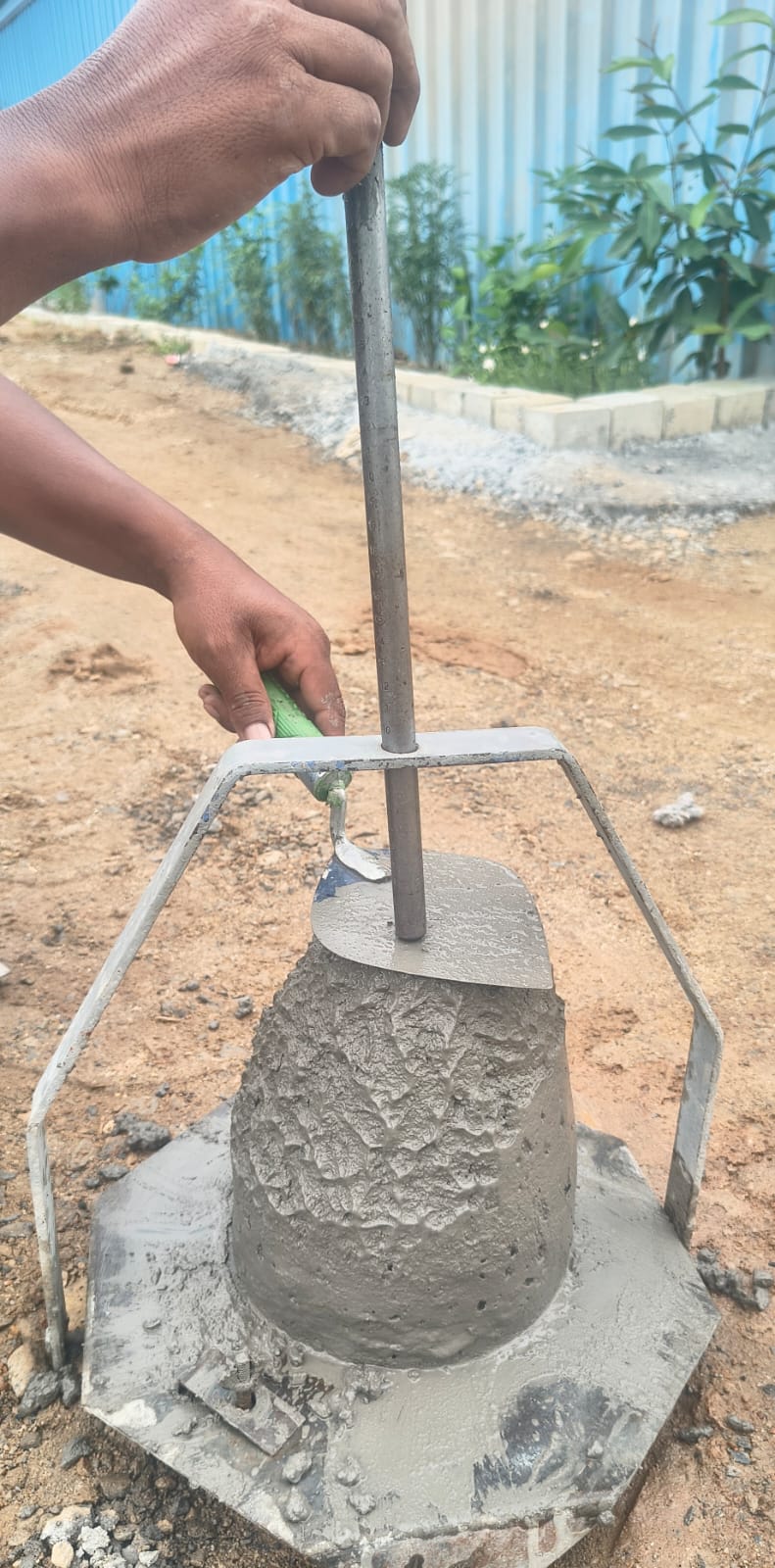

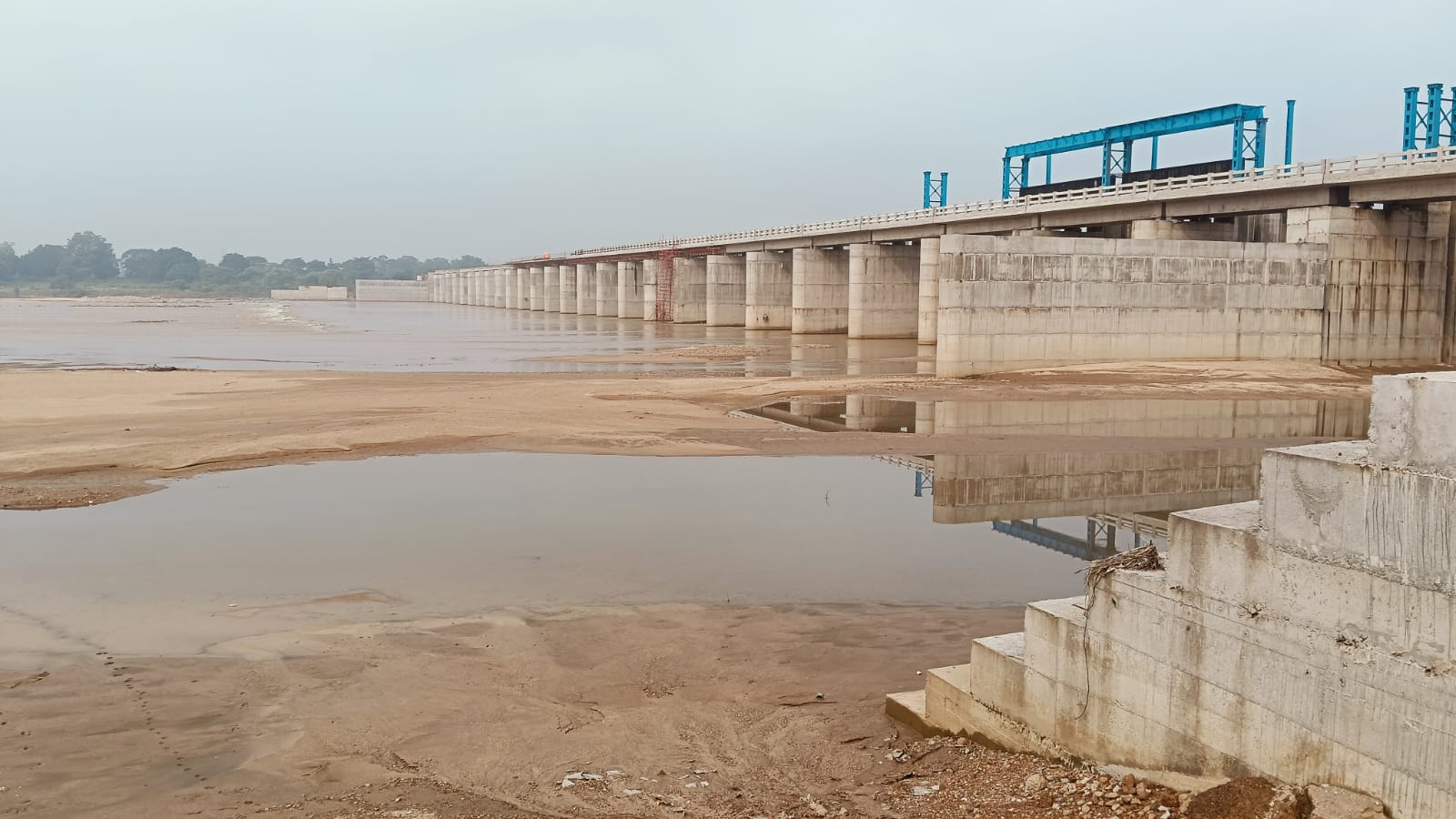

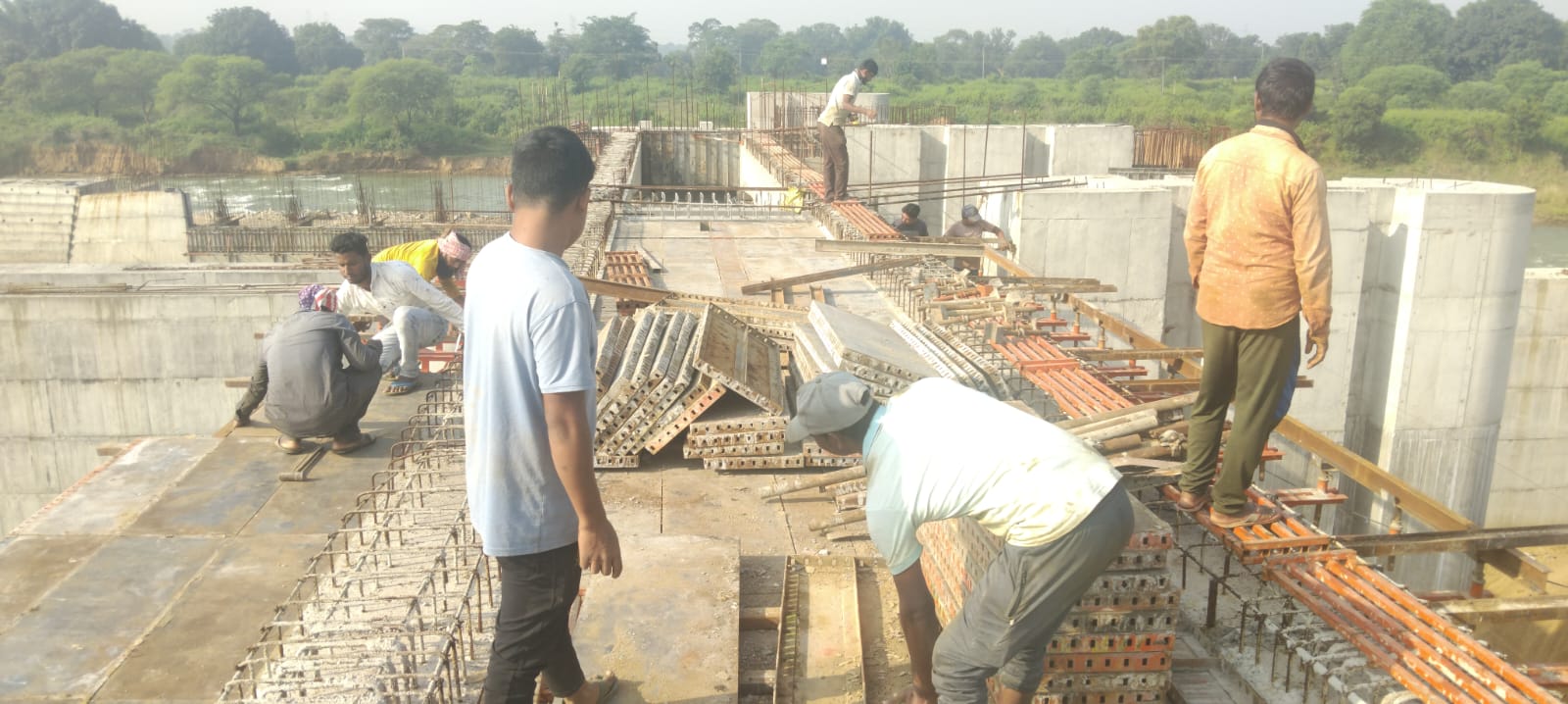

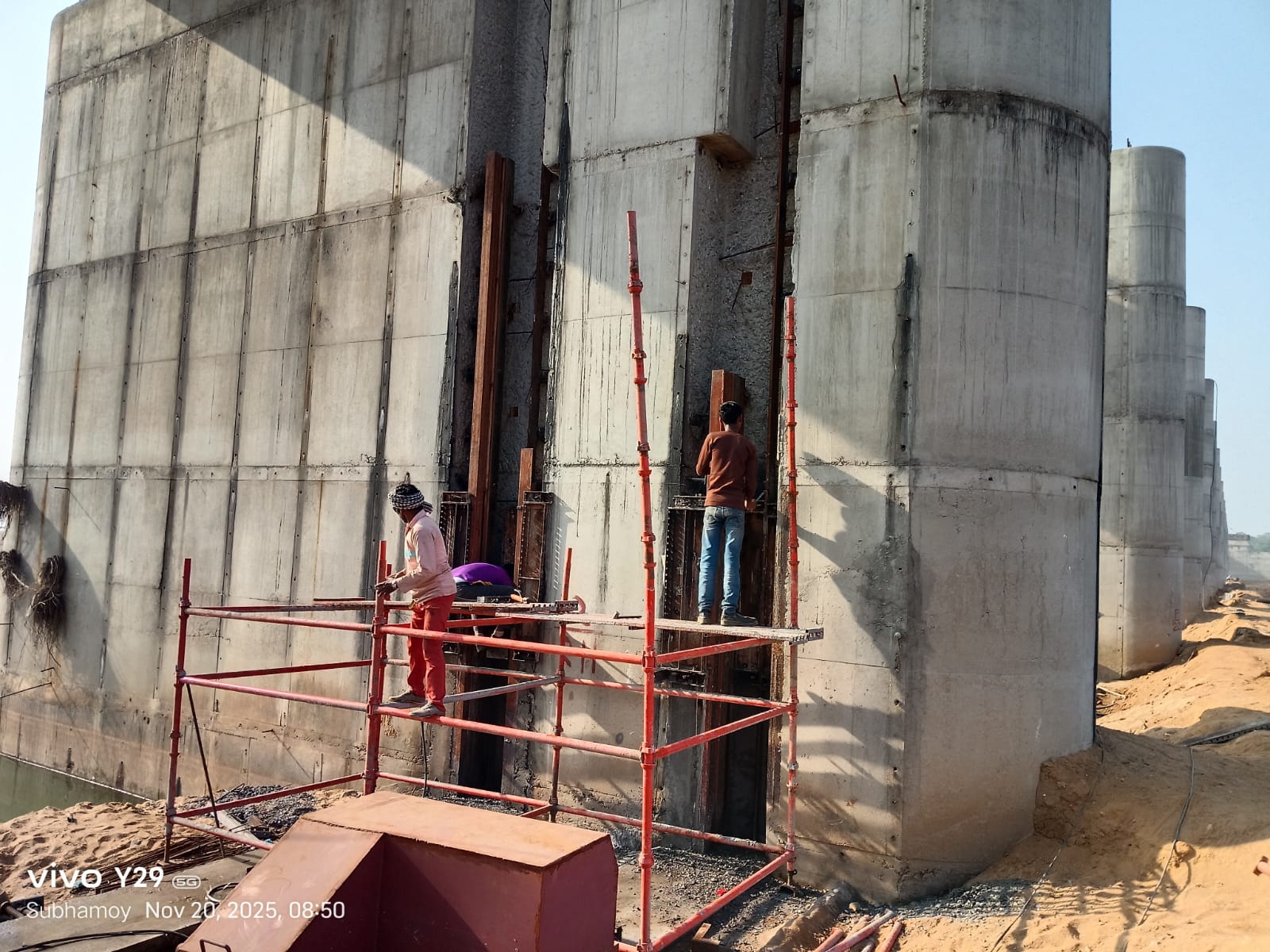

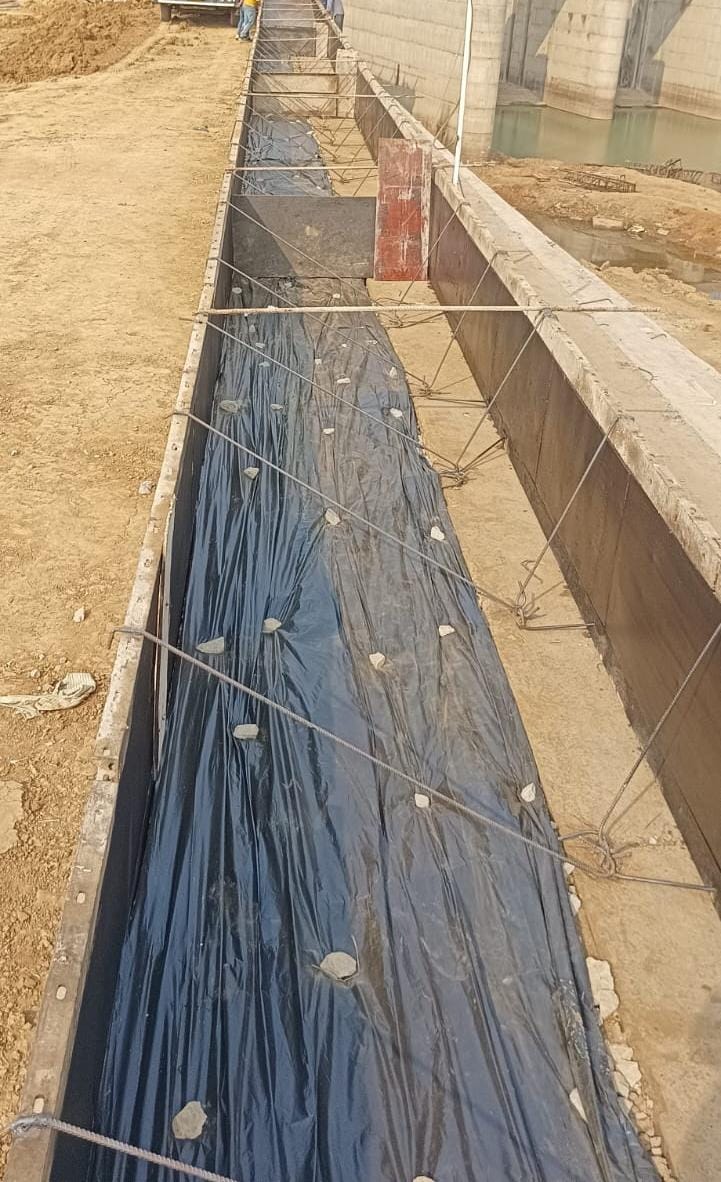

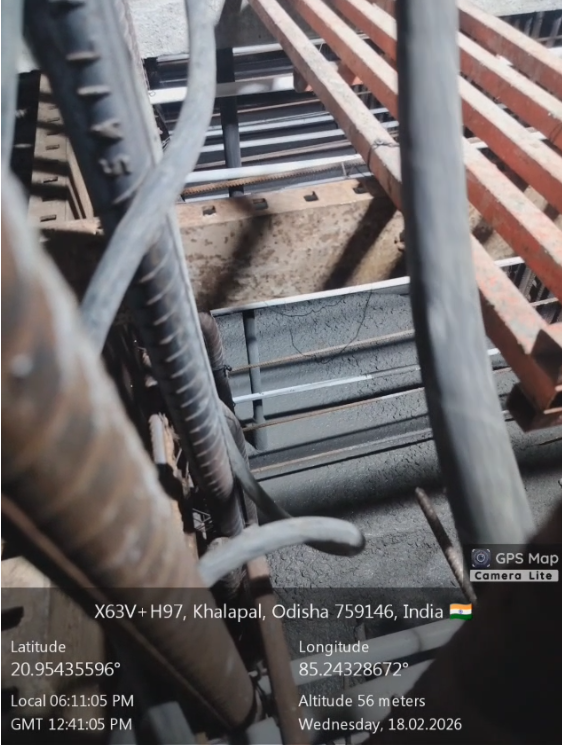

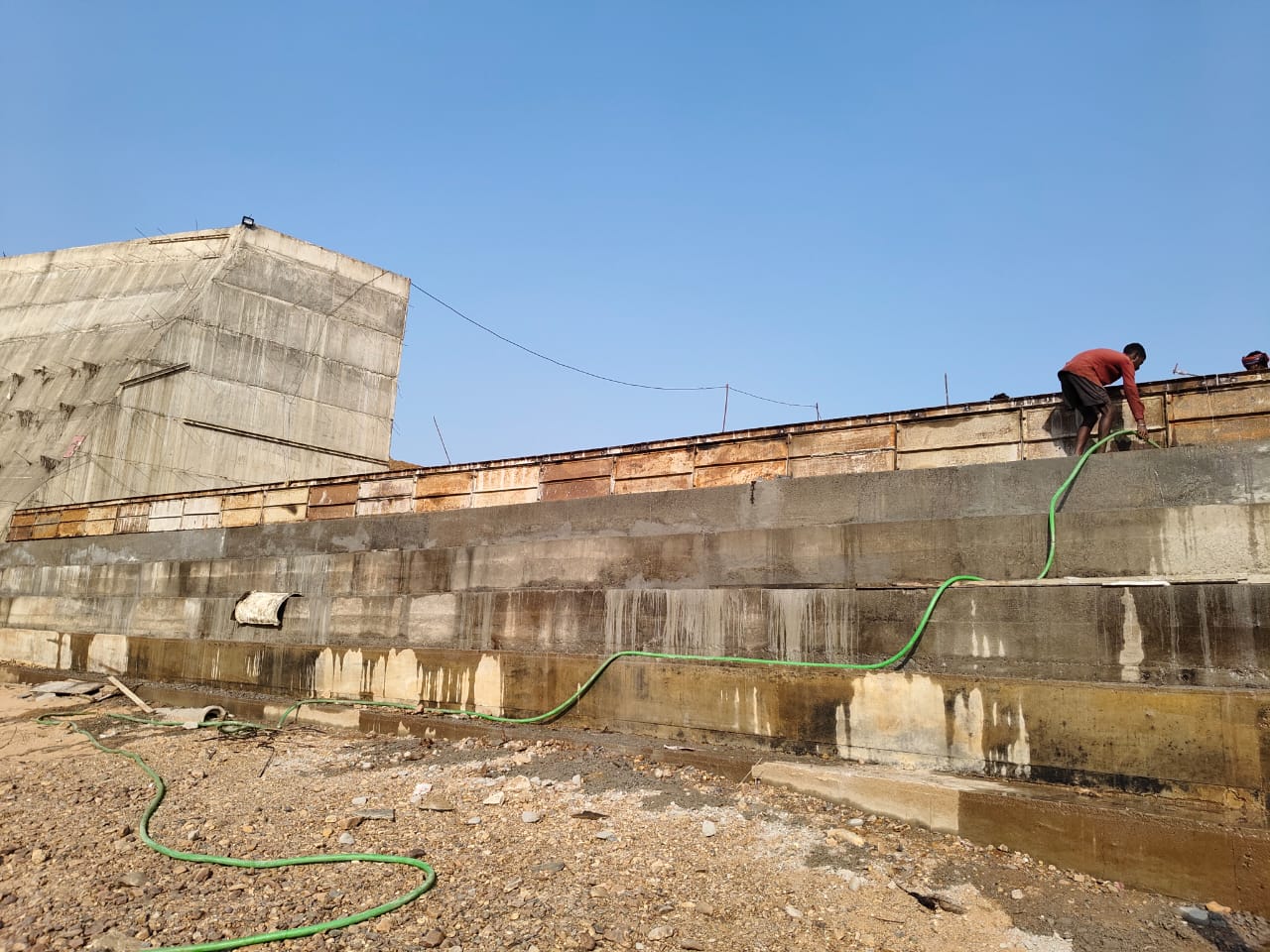

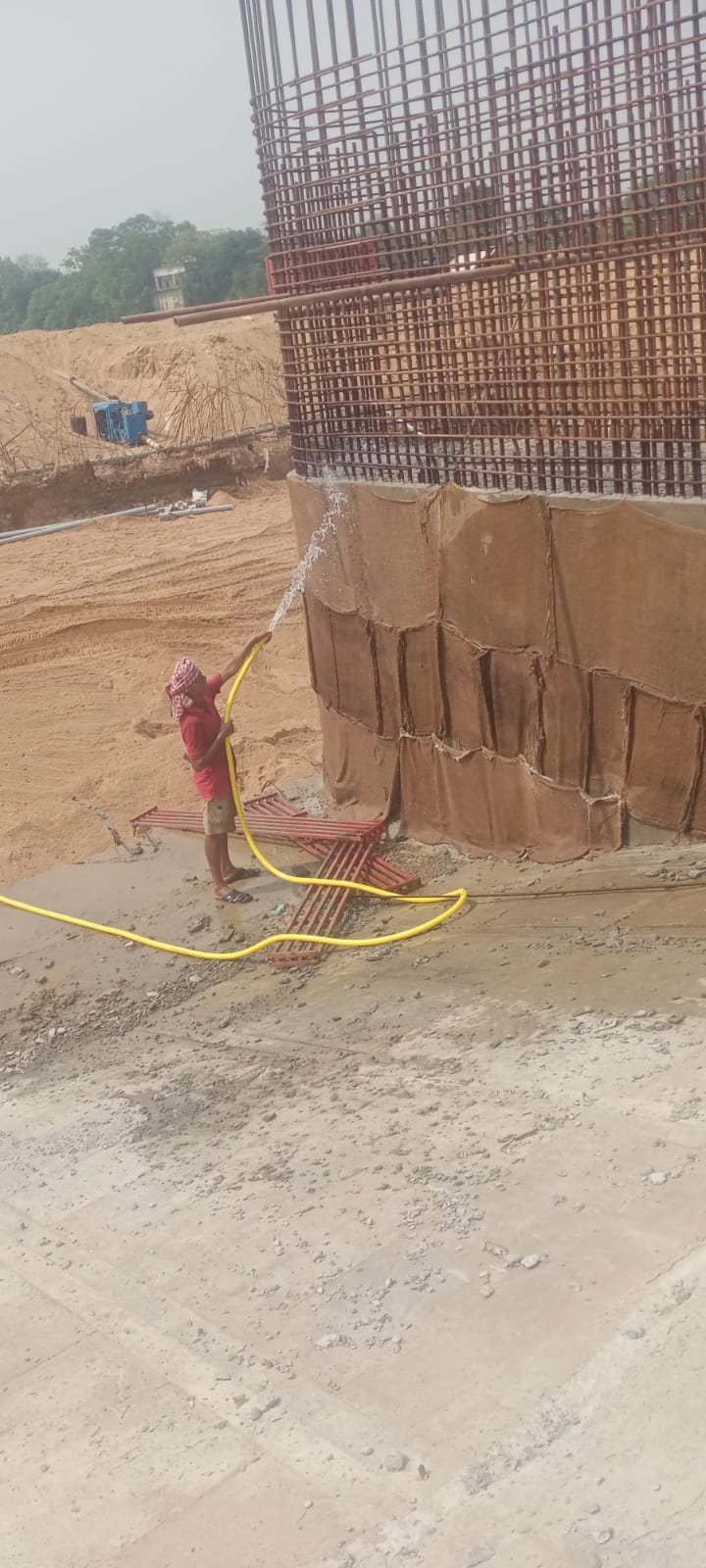

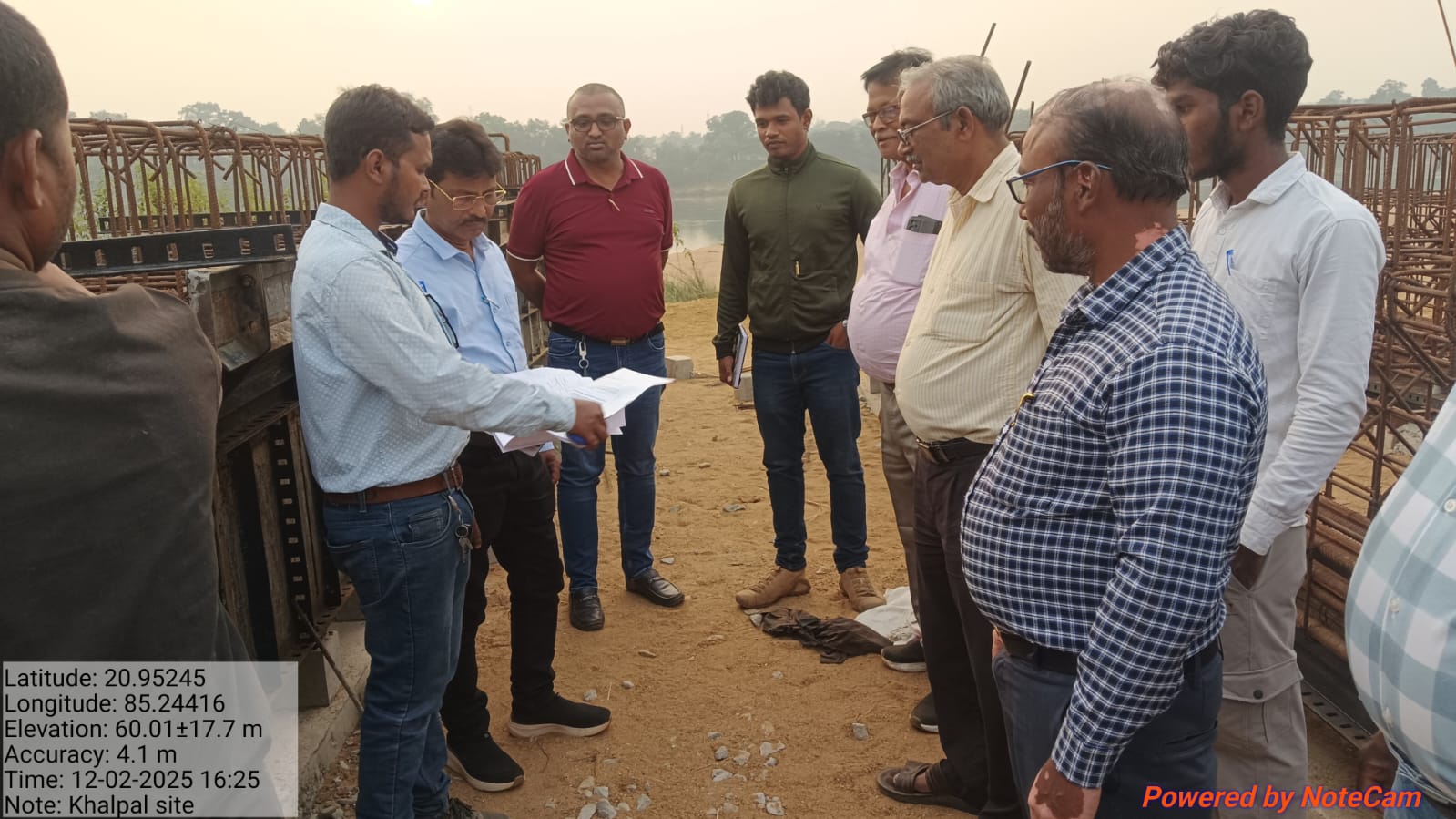

Instream Storage Structure, Khalpal

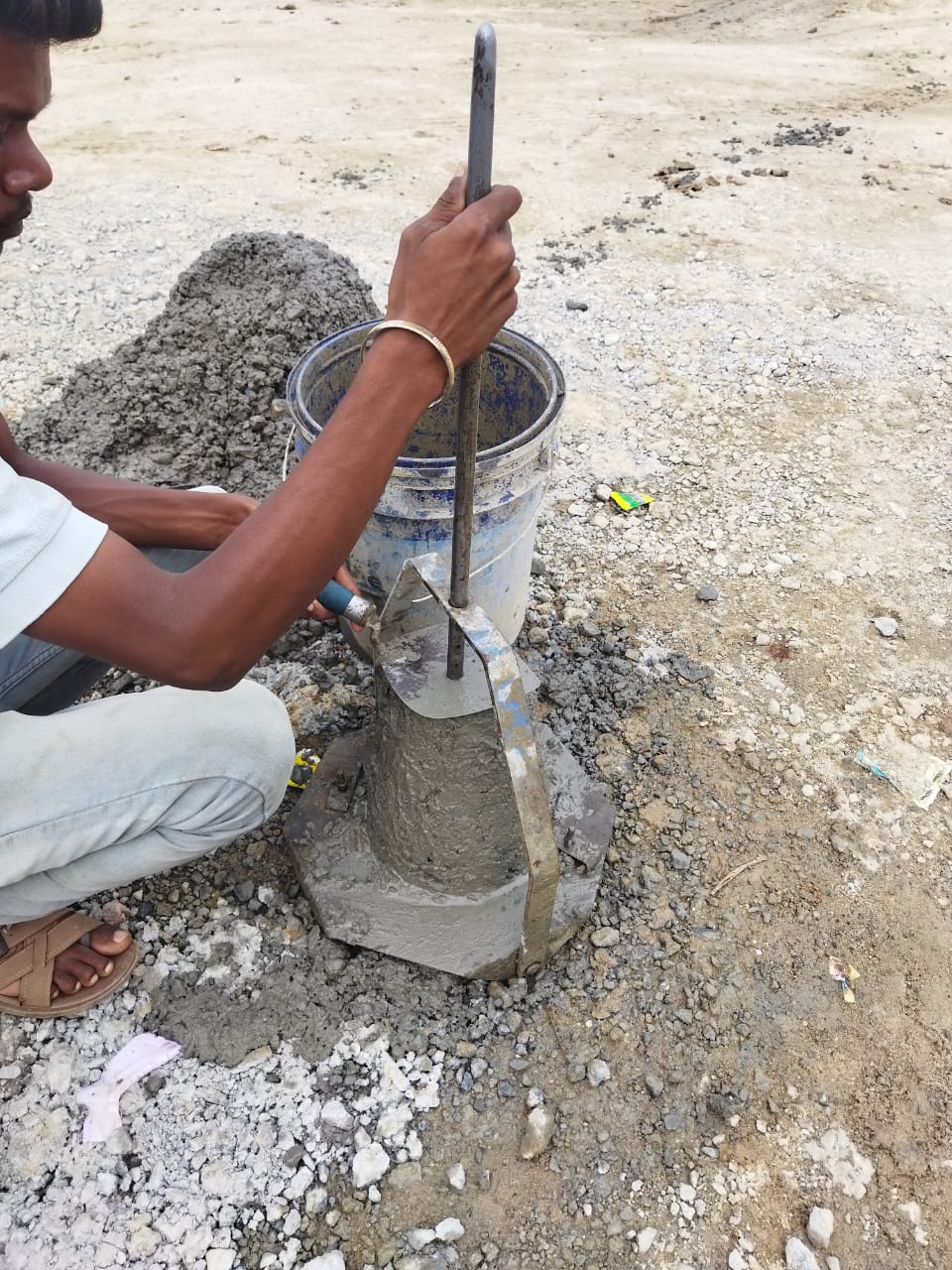

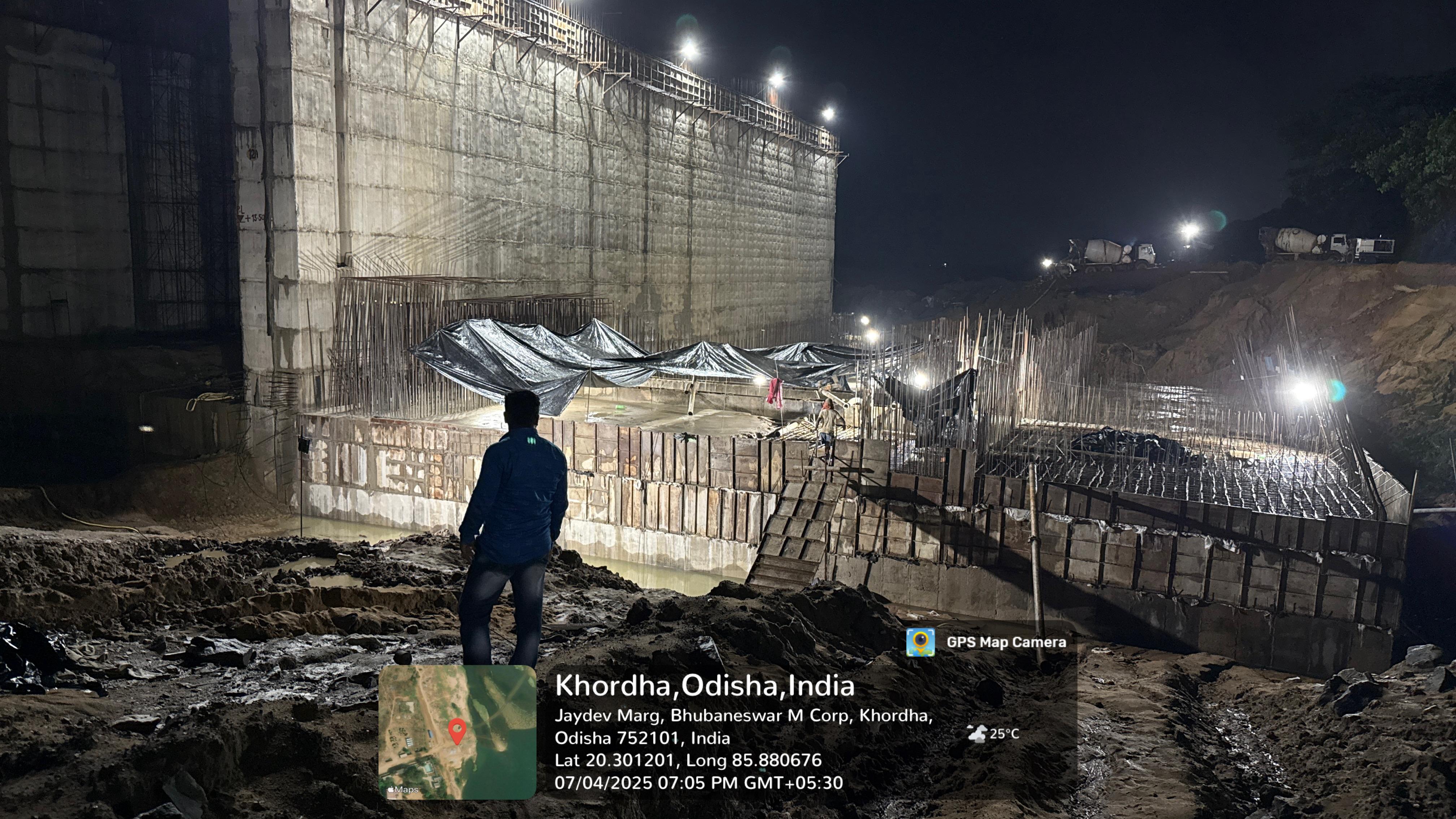

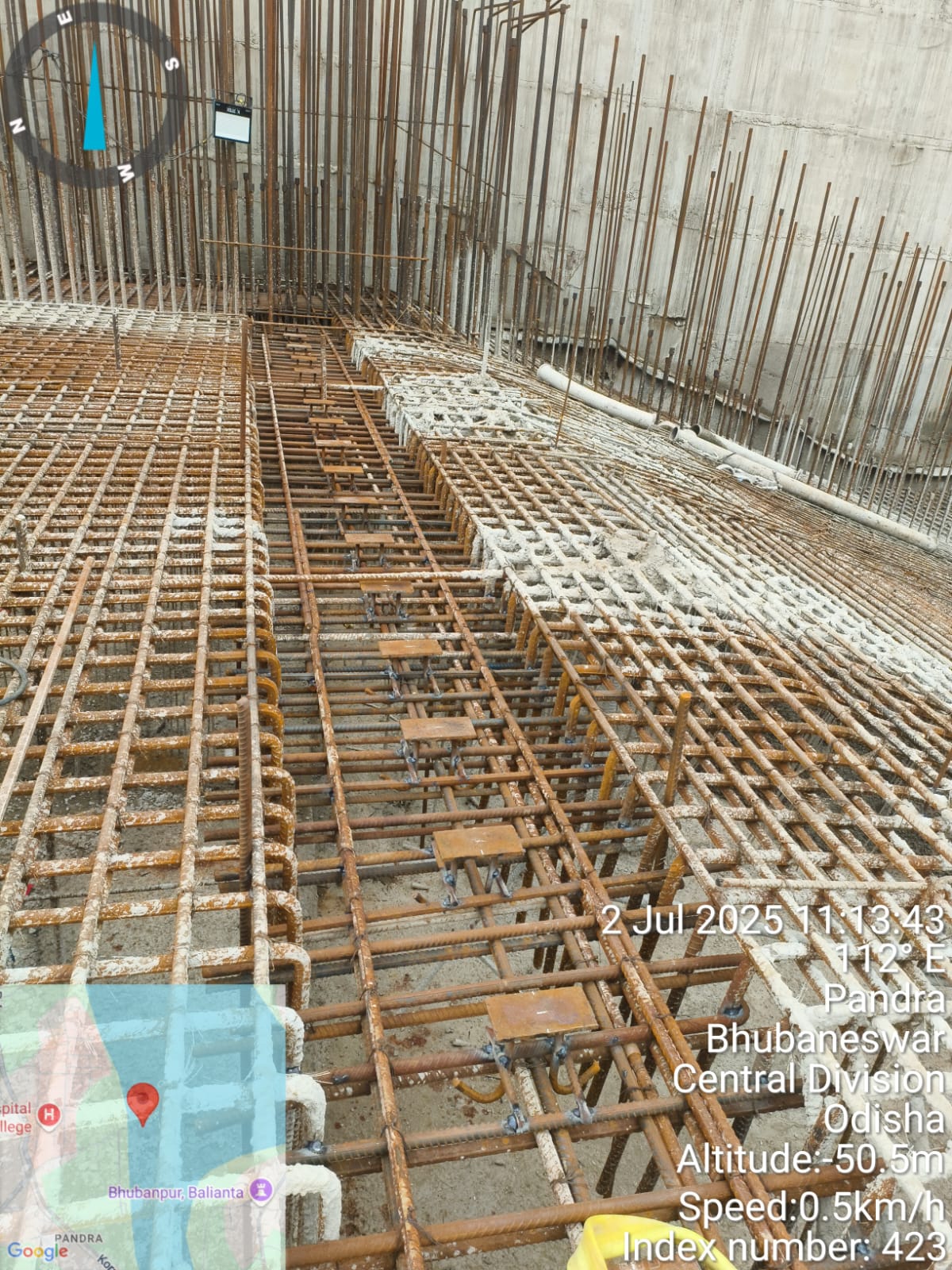

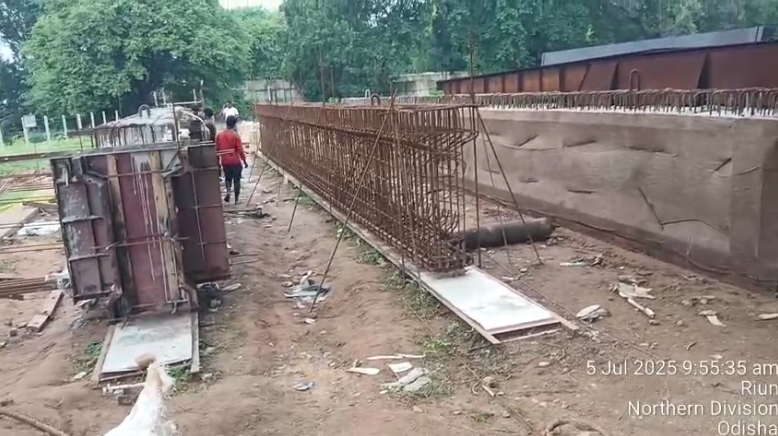

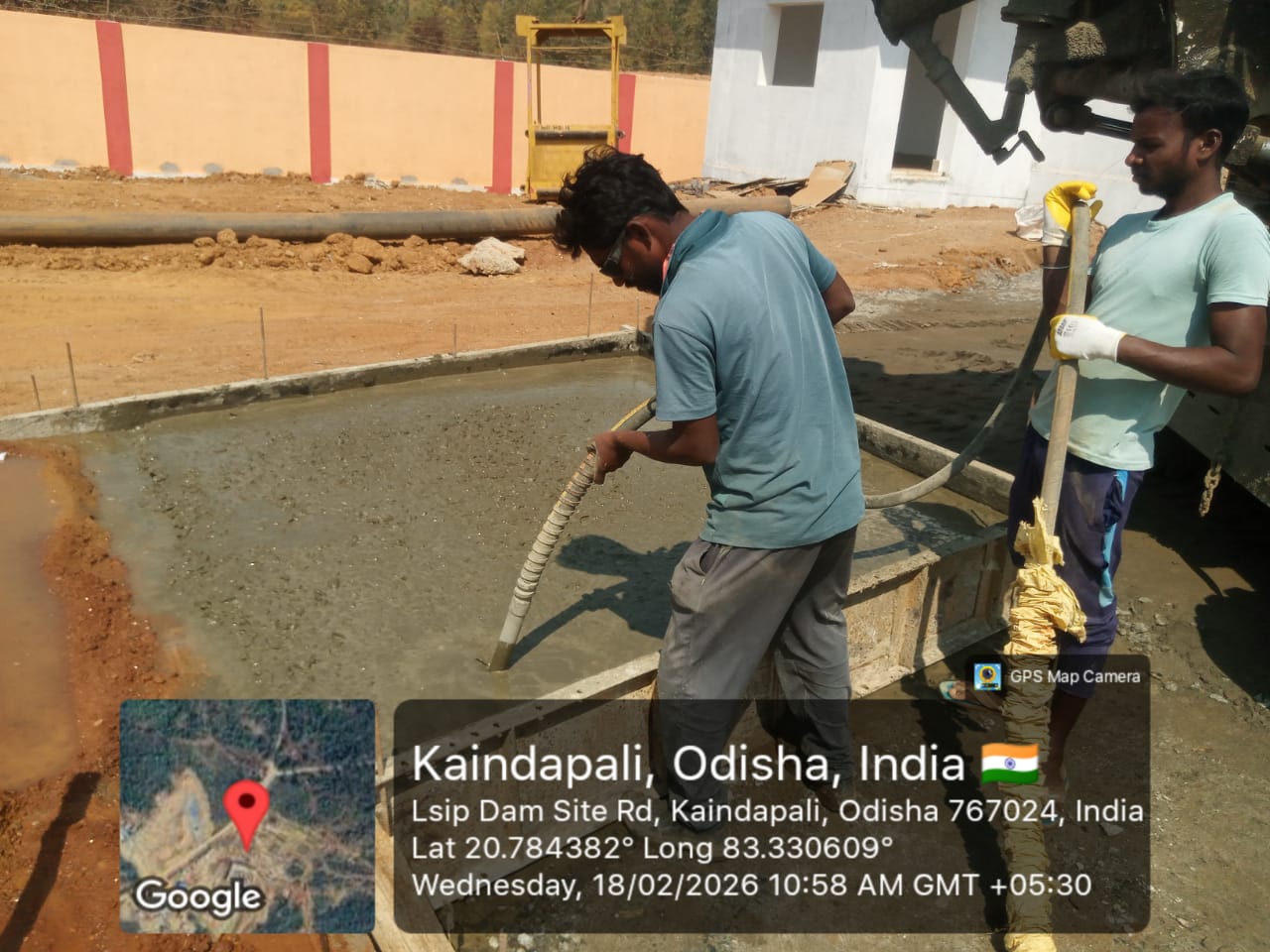

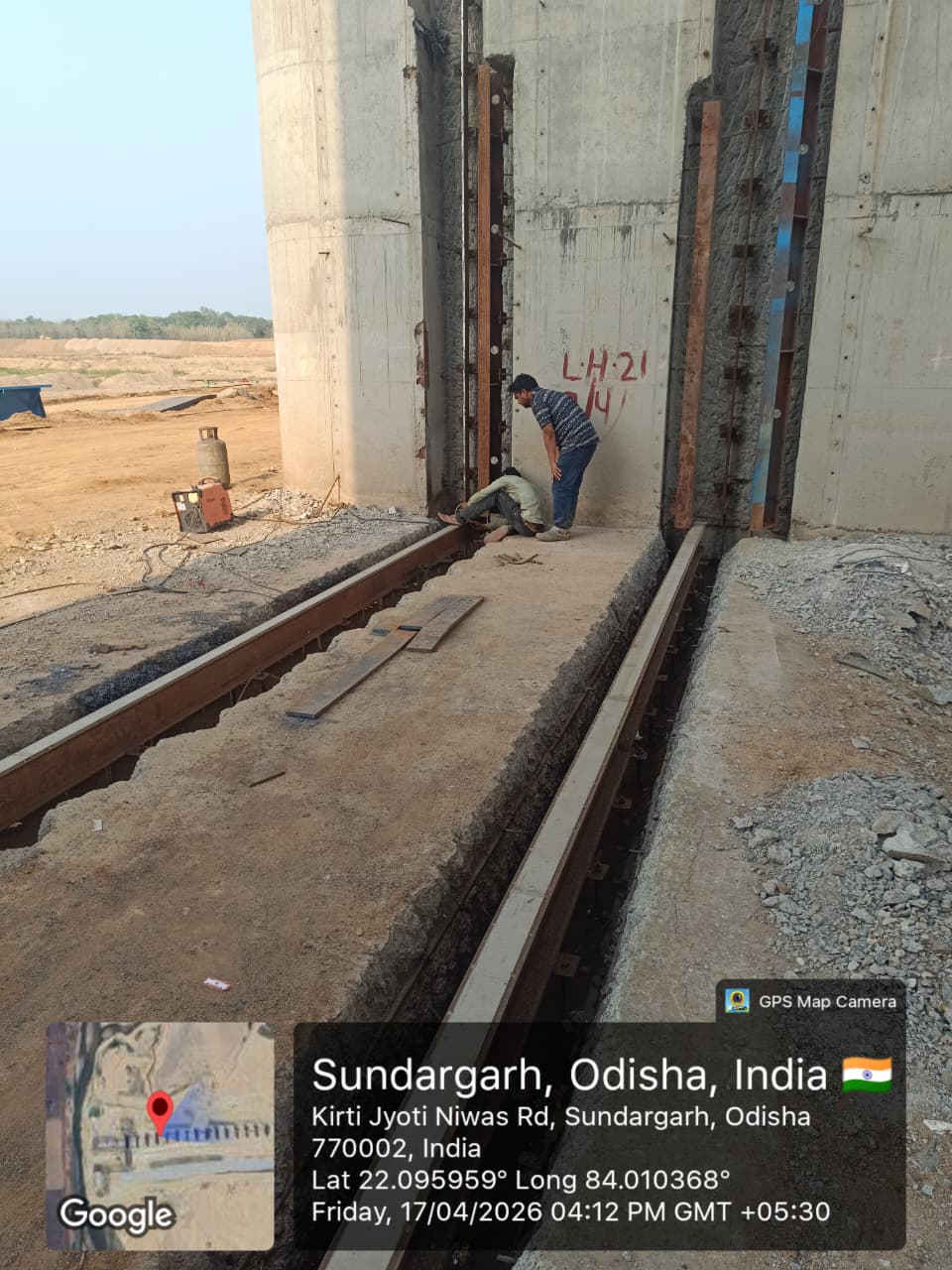

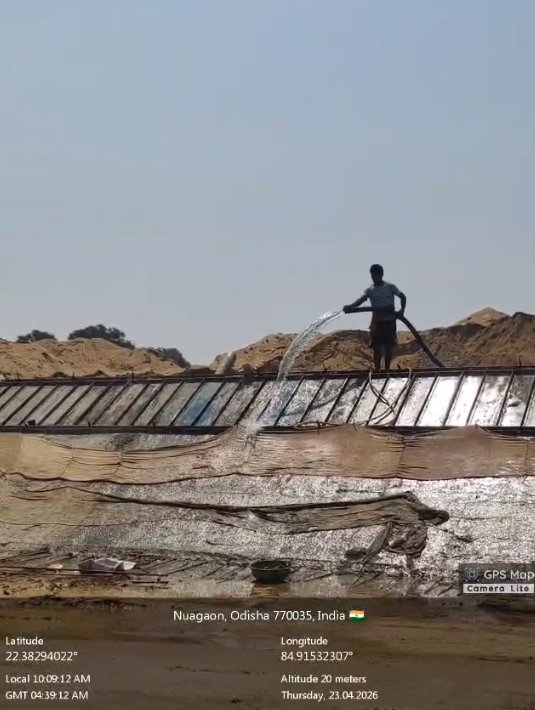

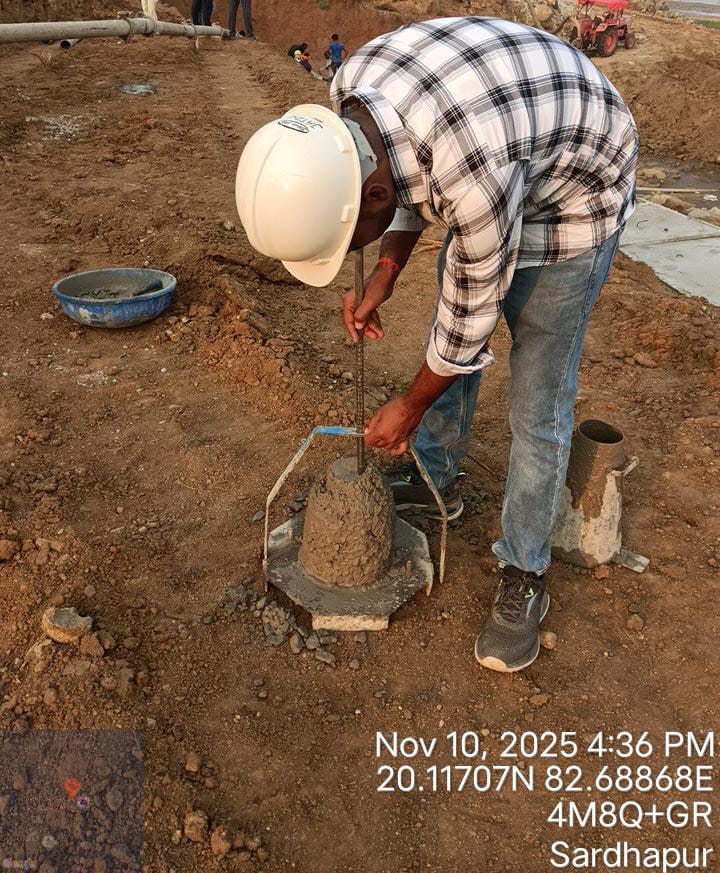

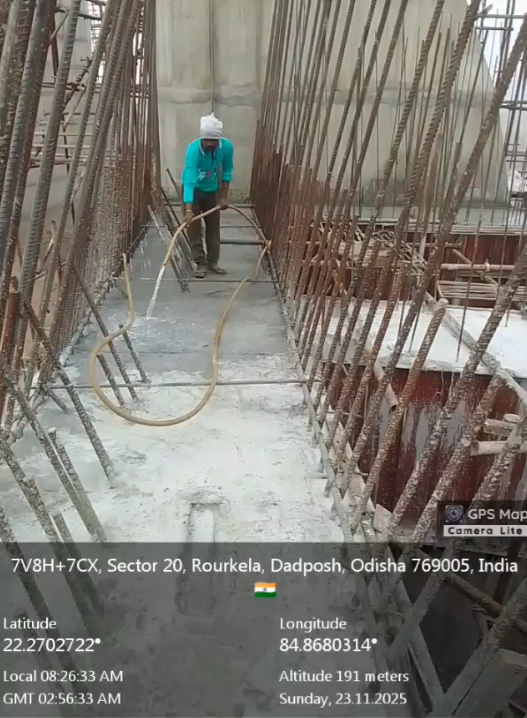

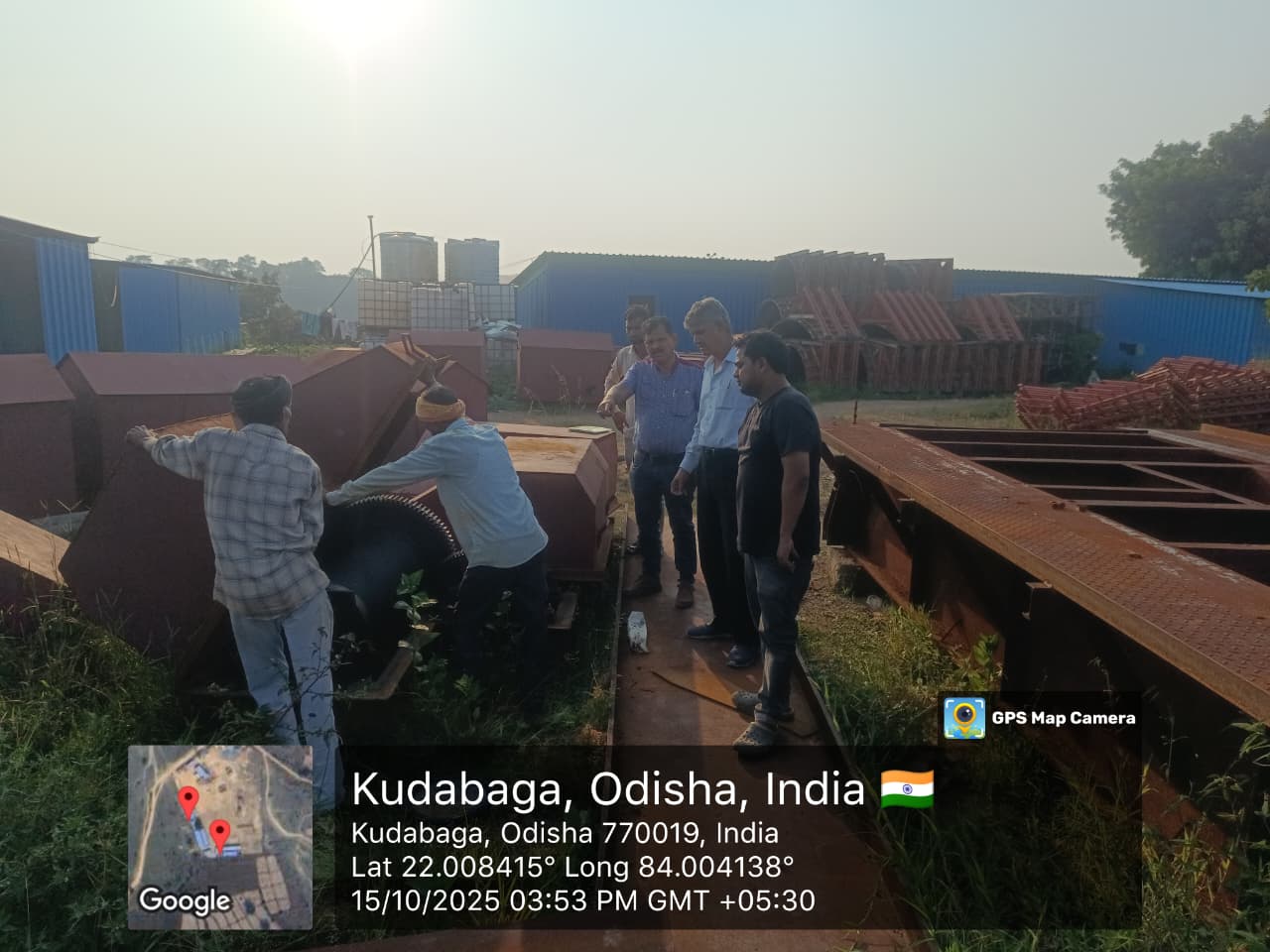

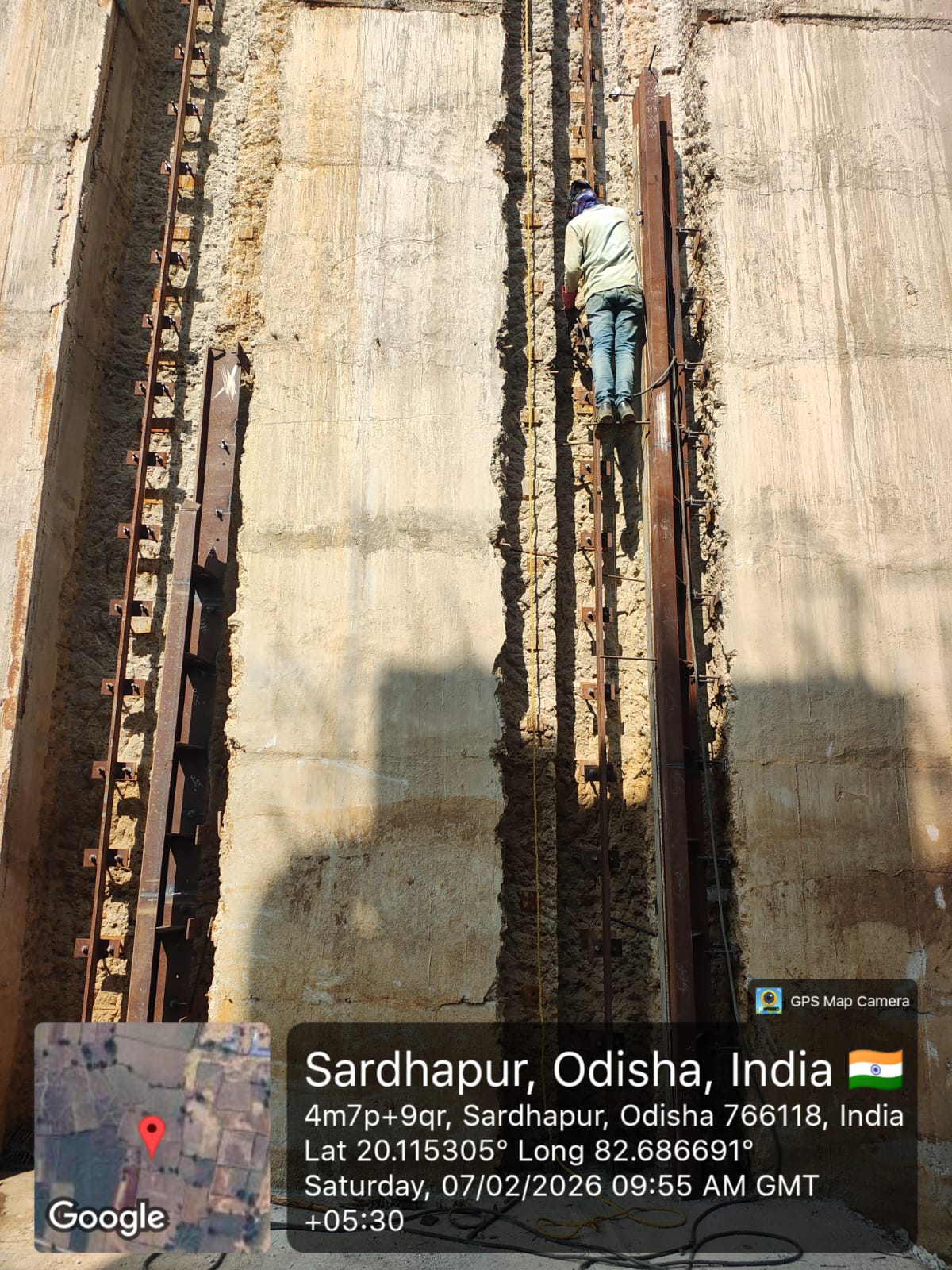

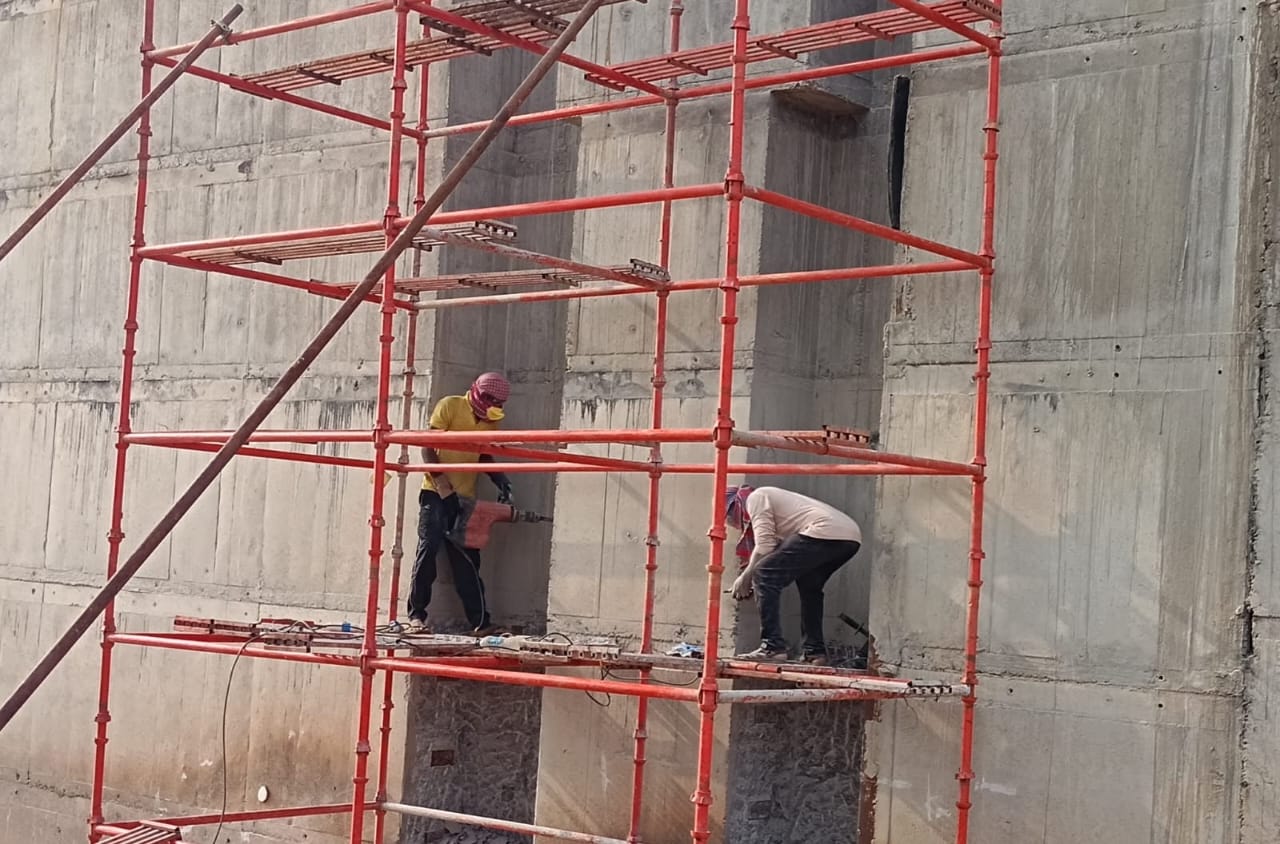

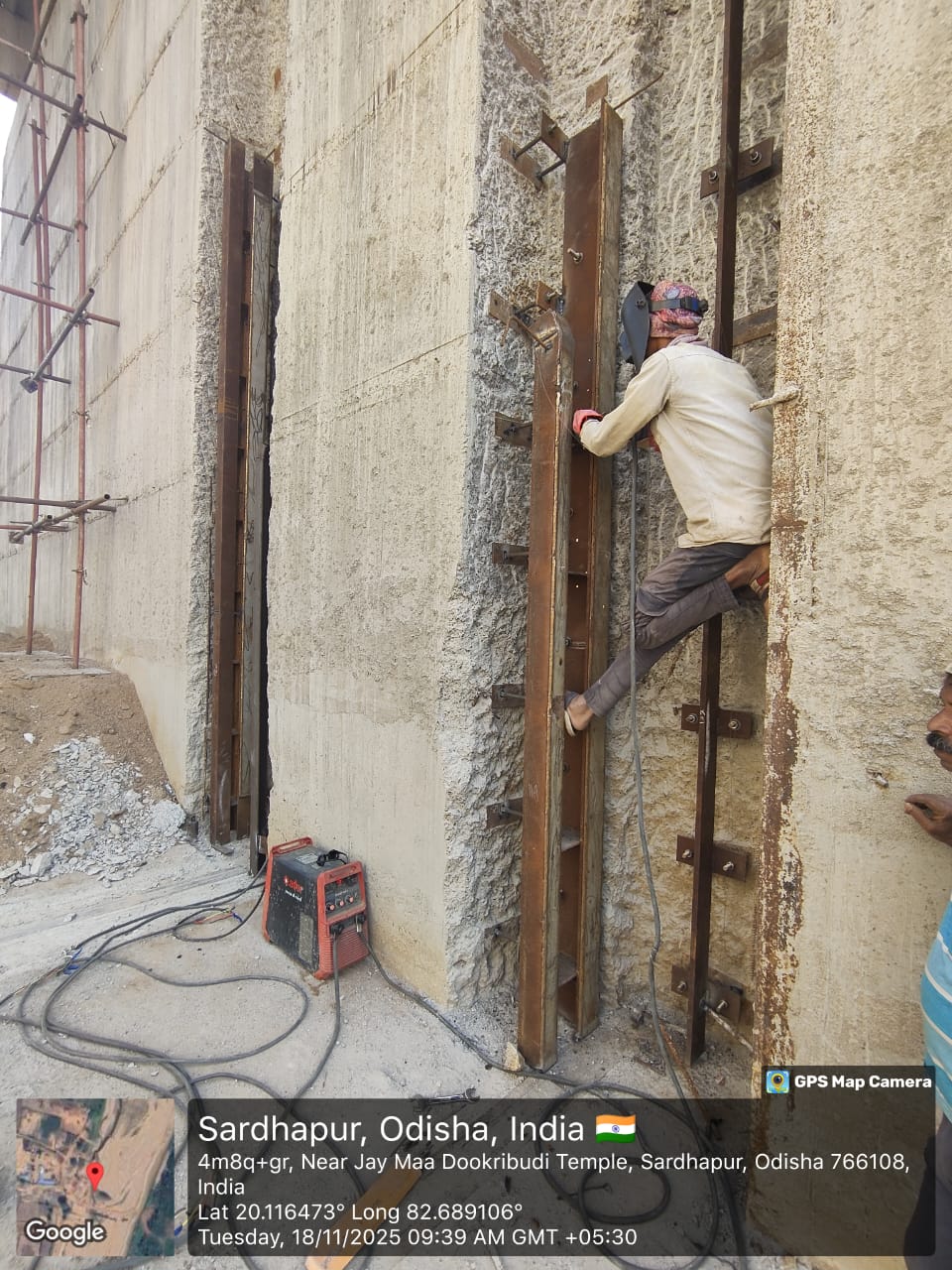

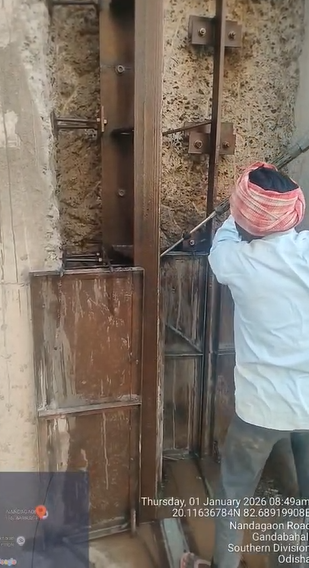

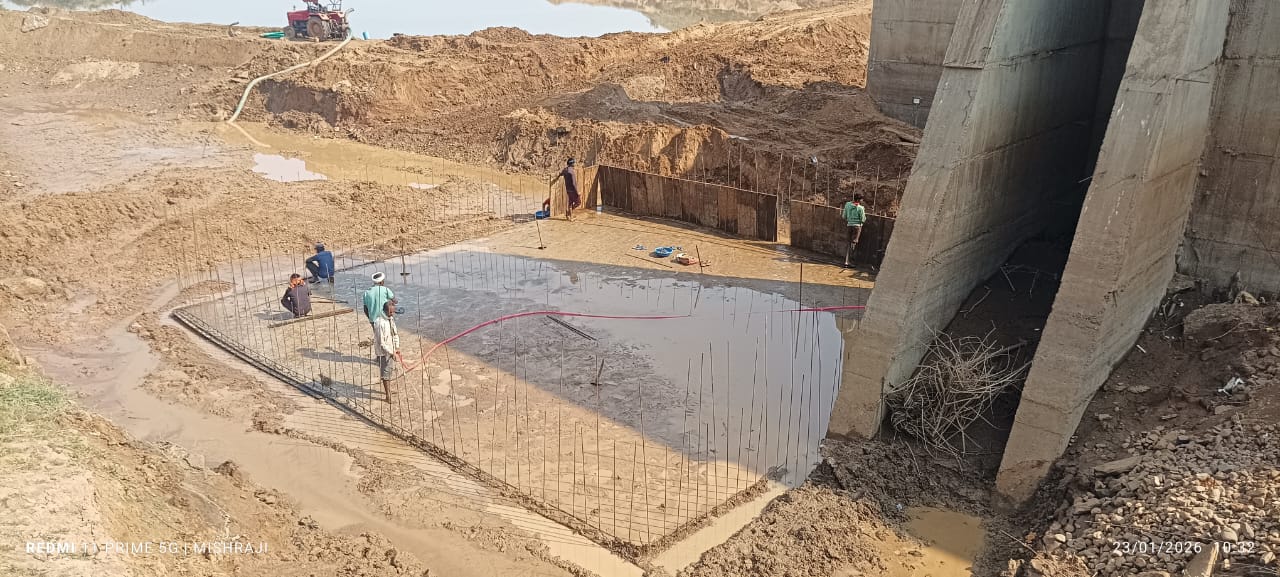

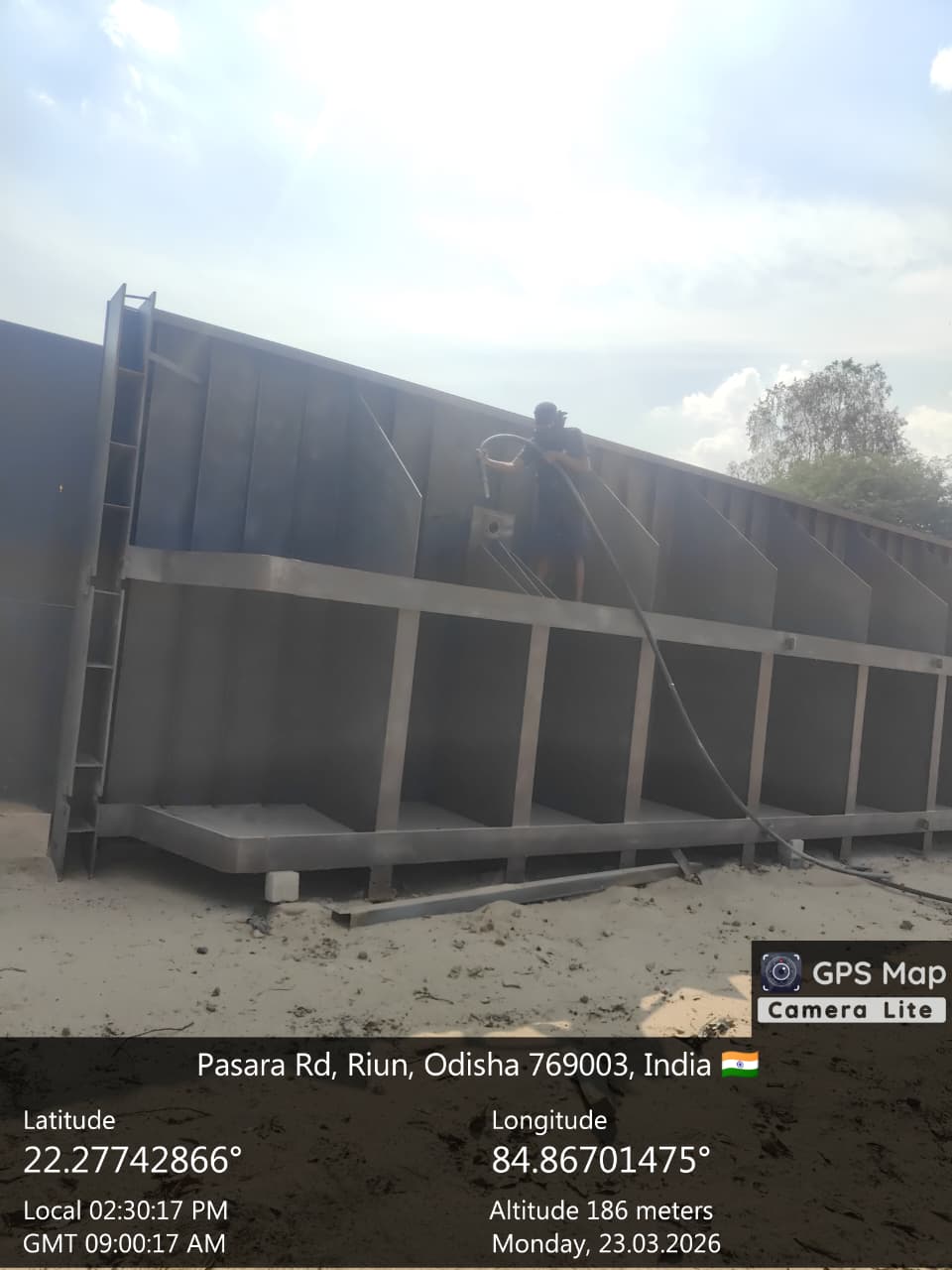

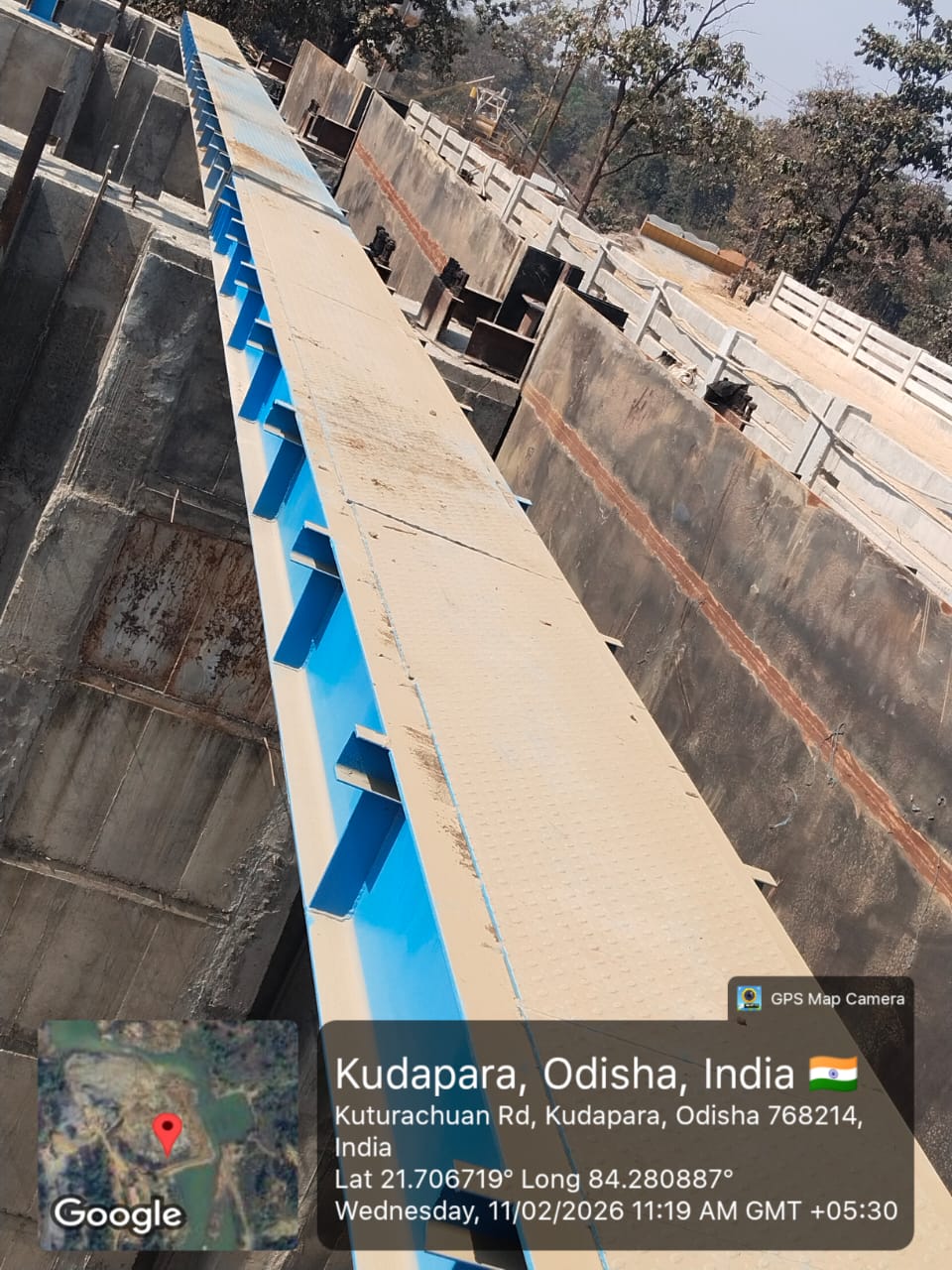

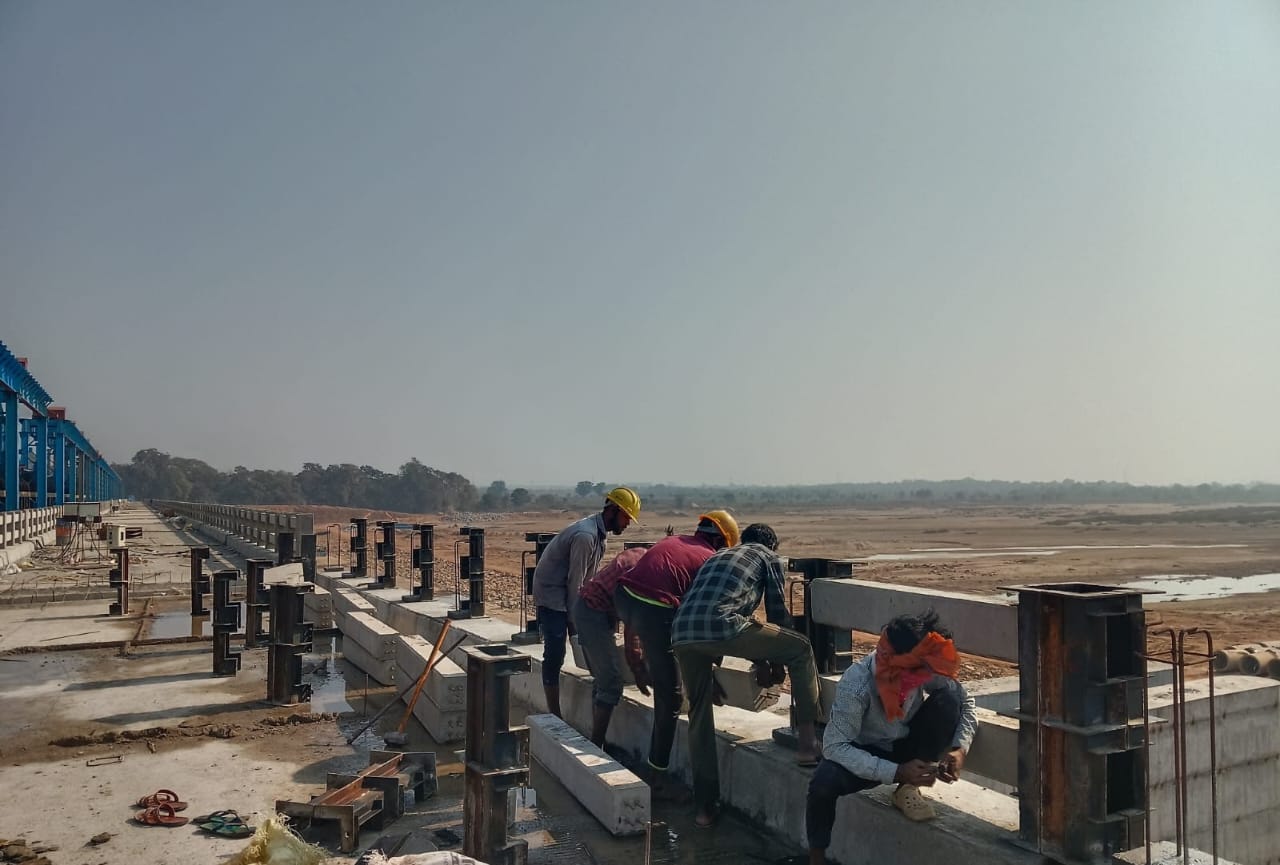

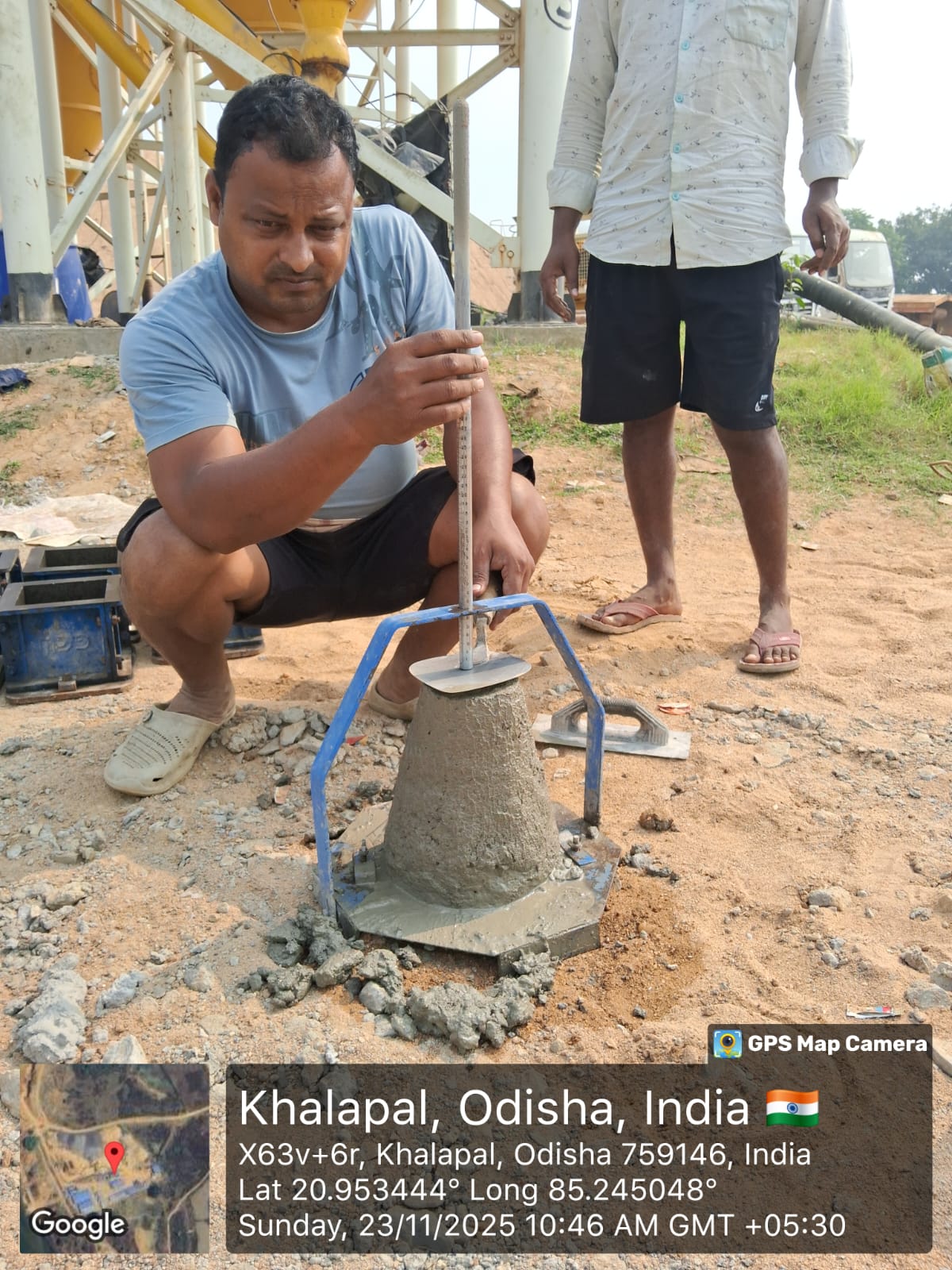

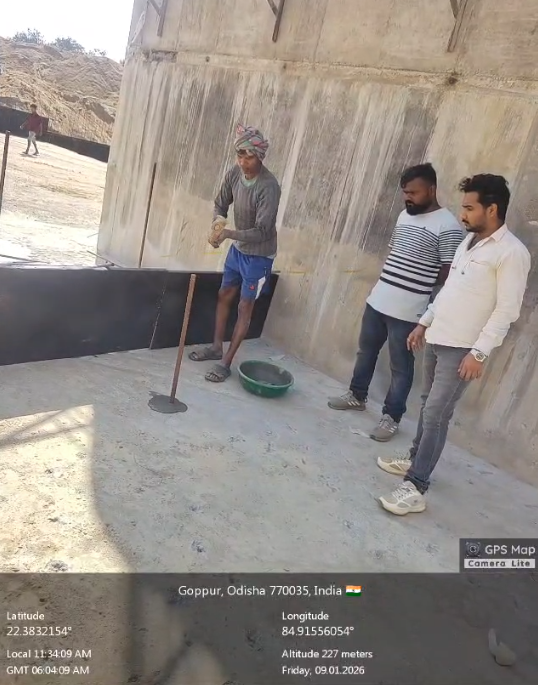

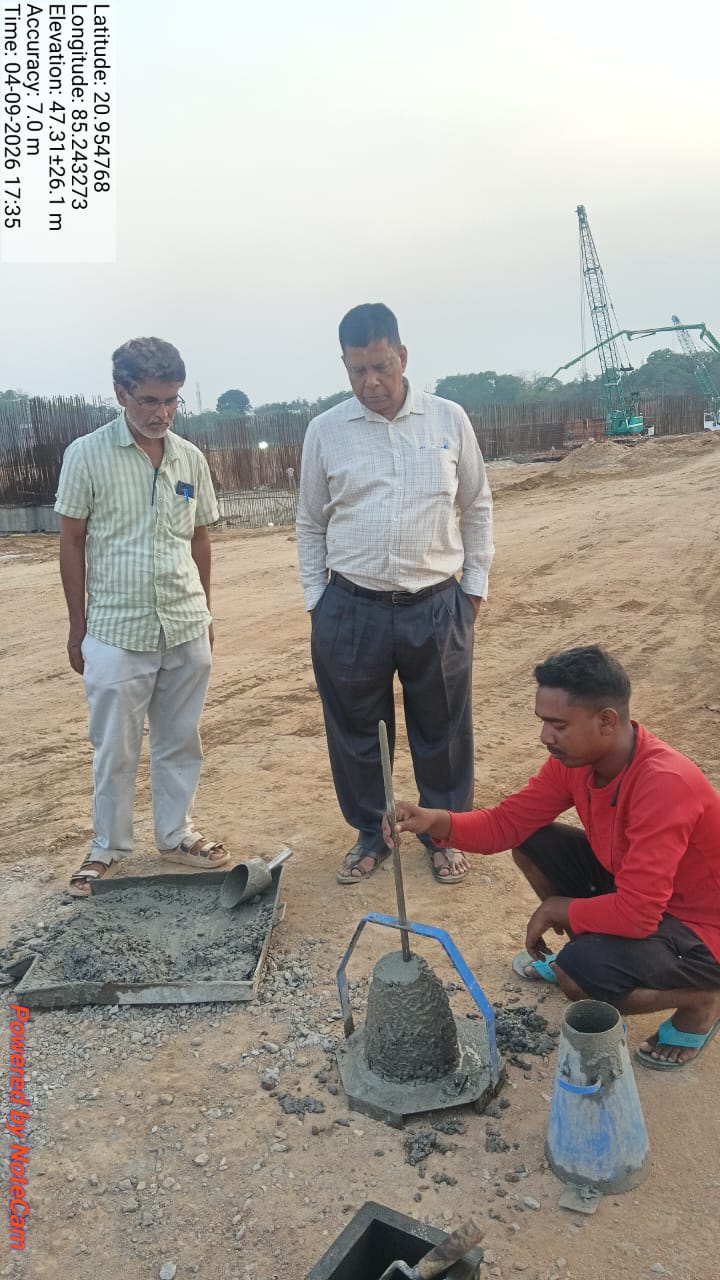

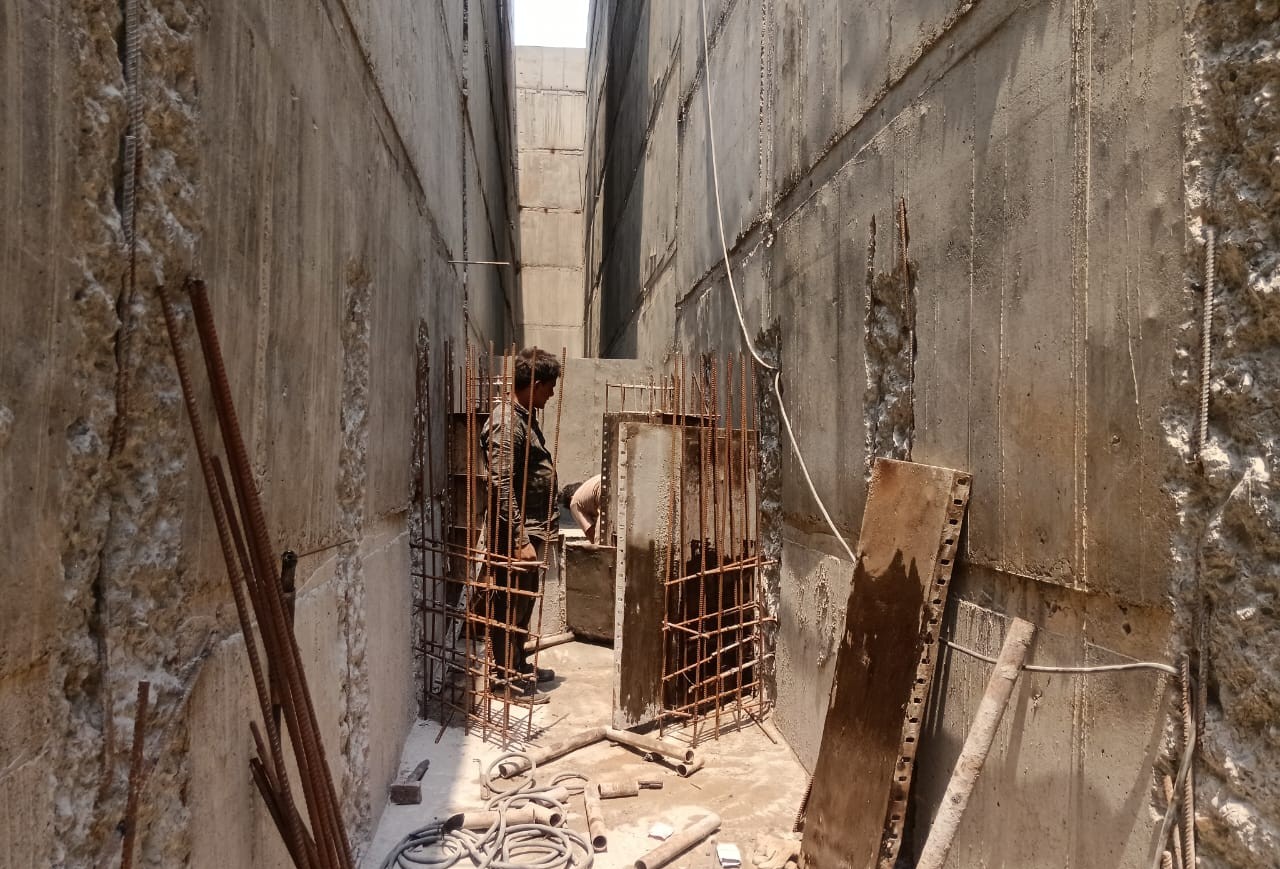

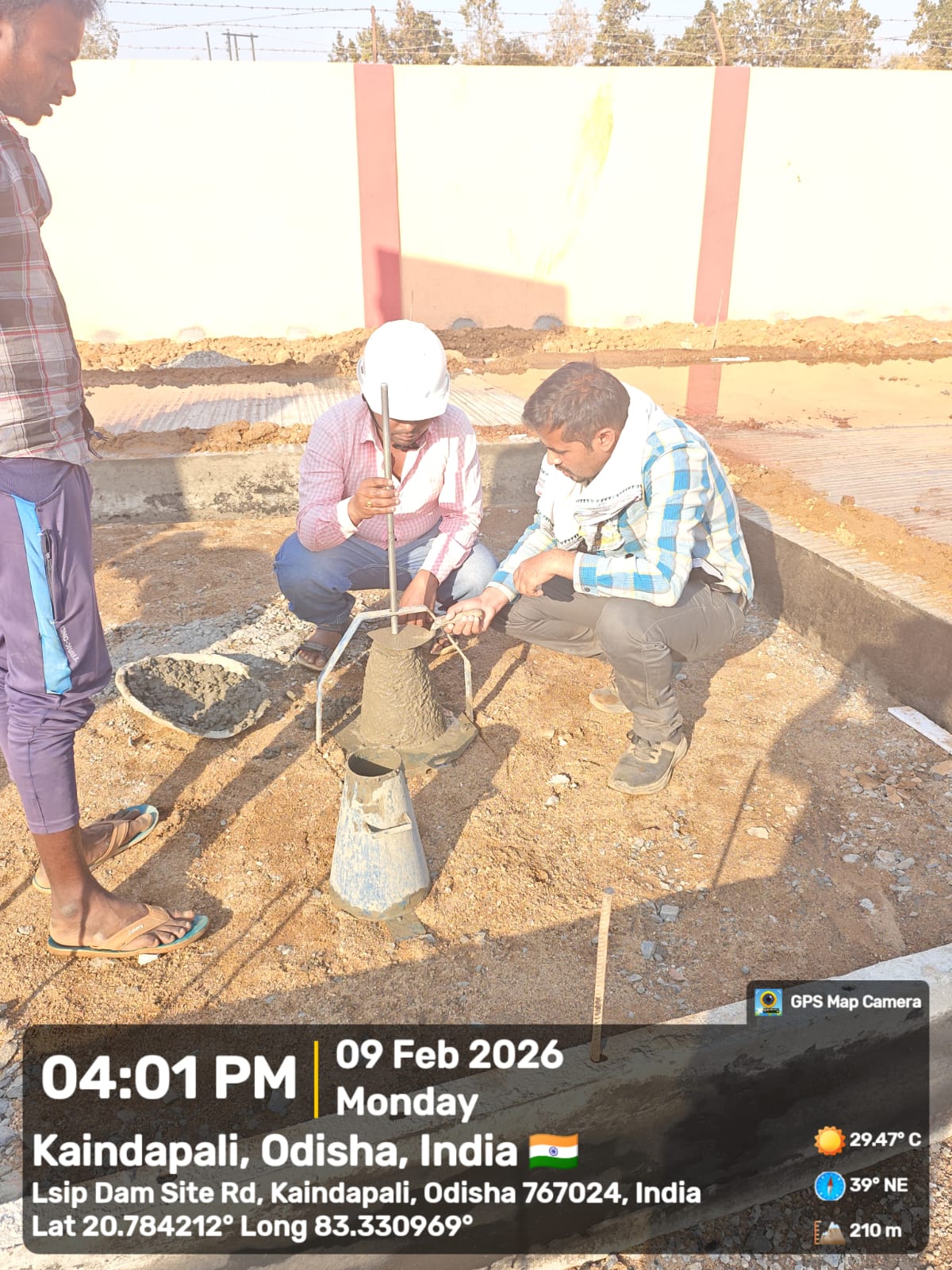

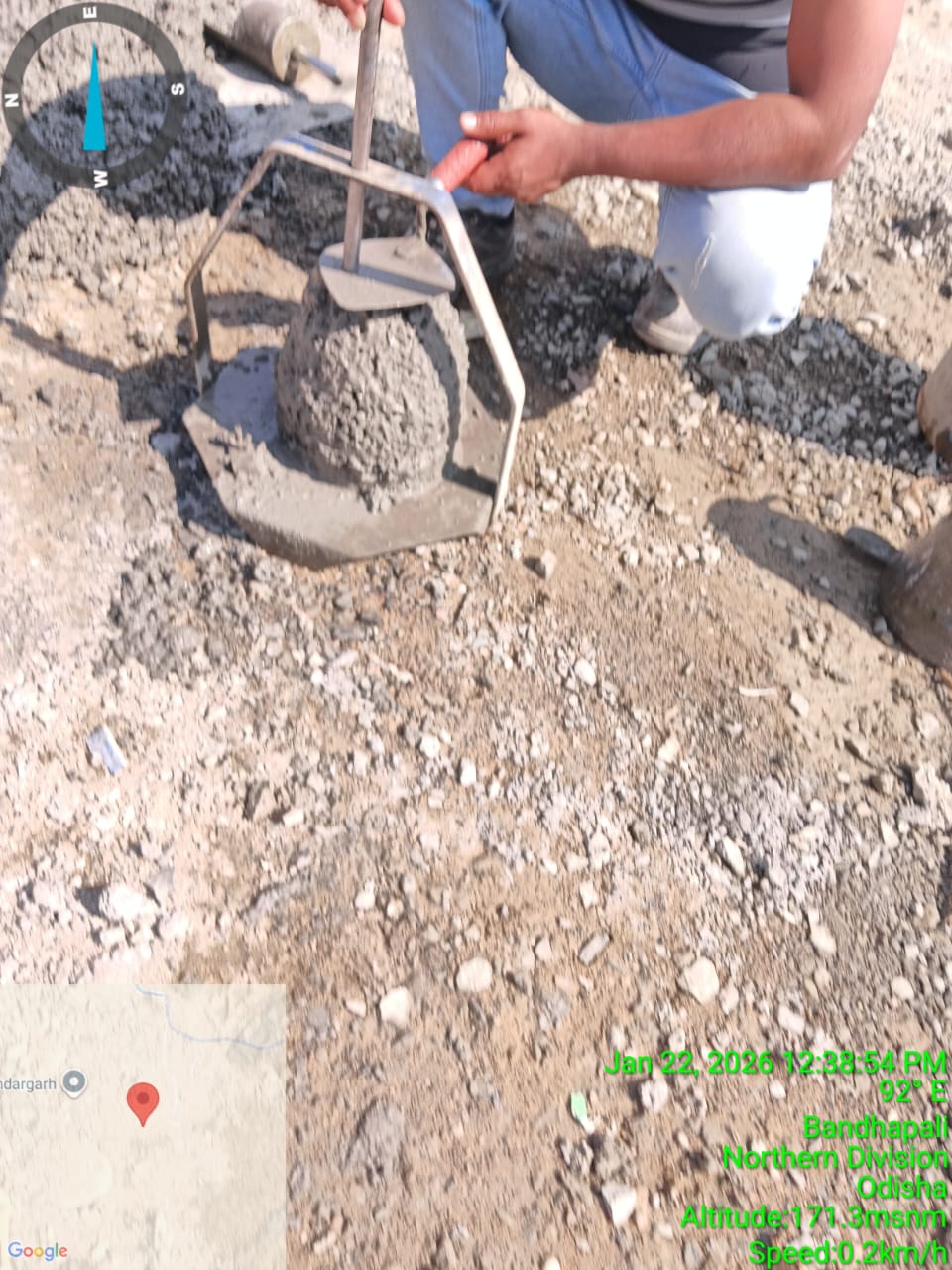

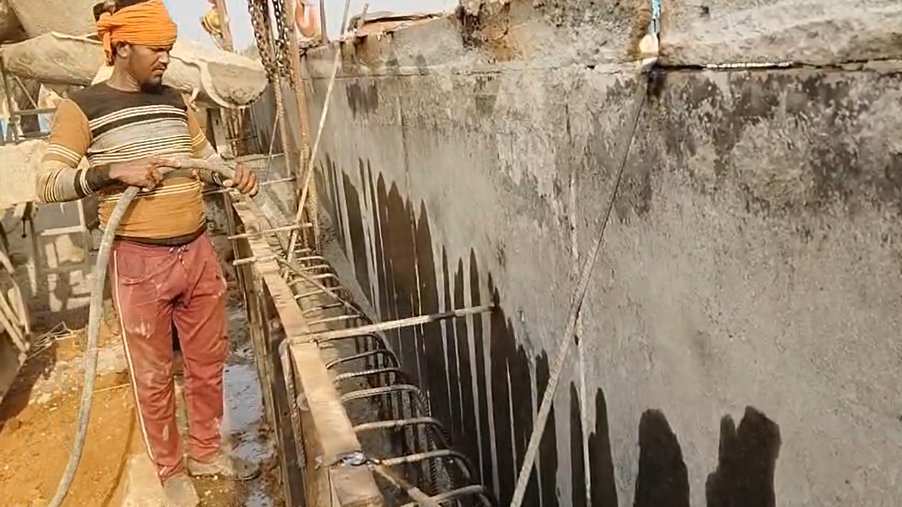

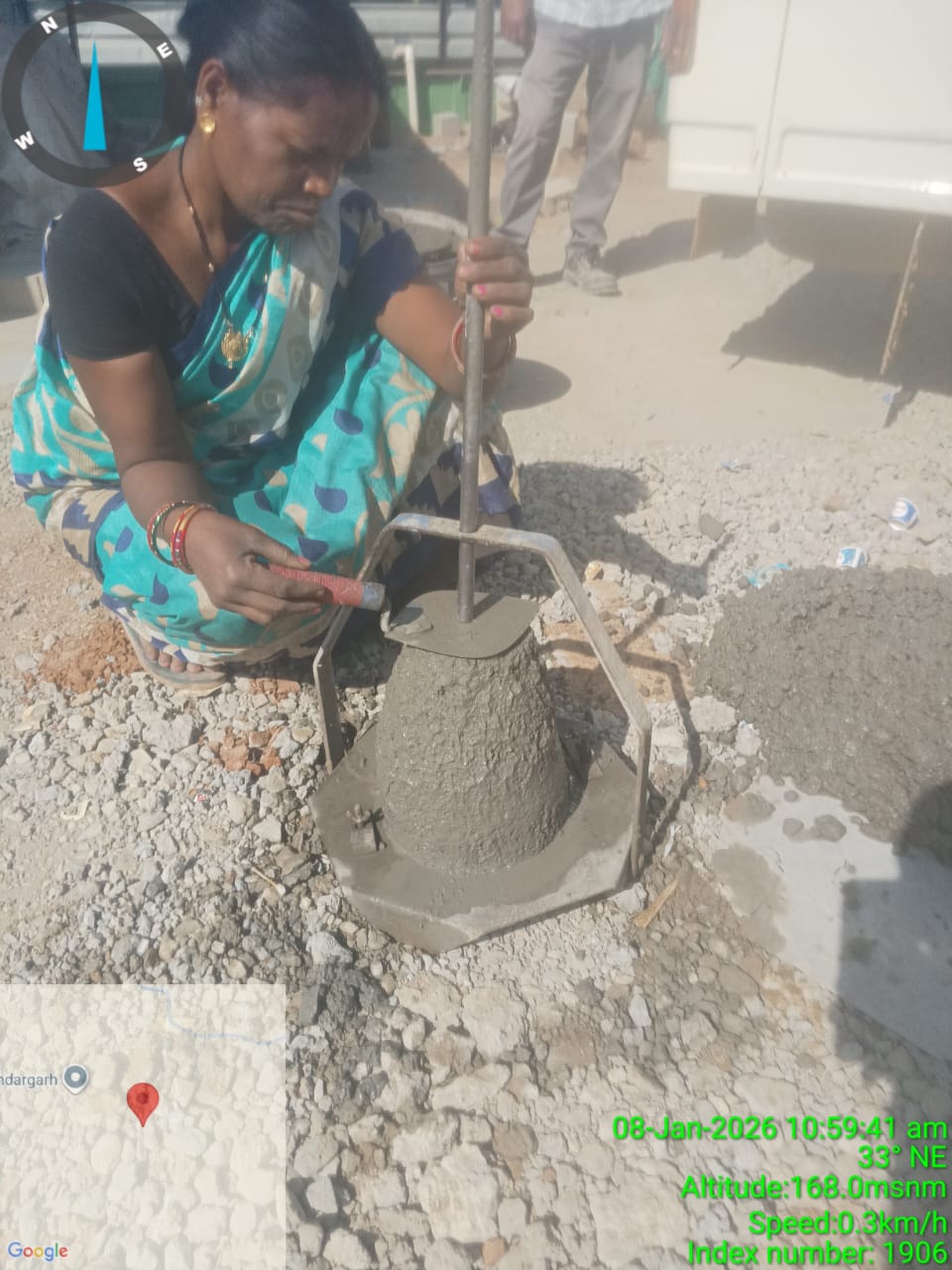

Curing of Girders is under progress.
42/100
Instream Storage Structure, Khalpal

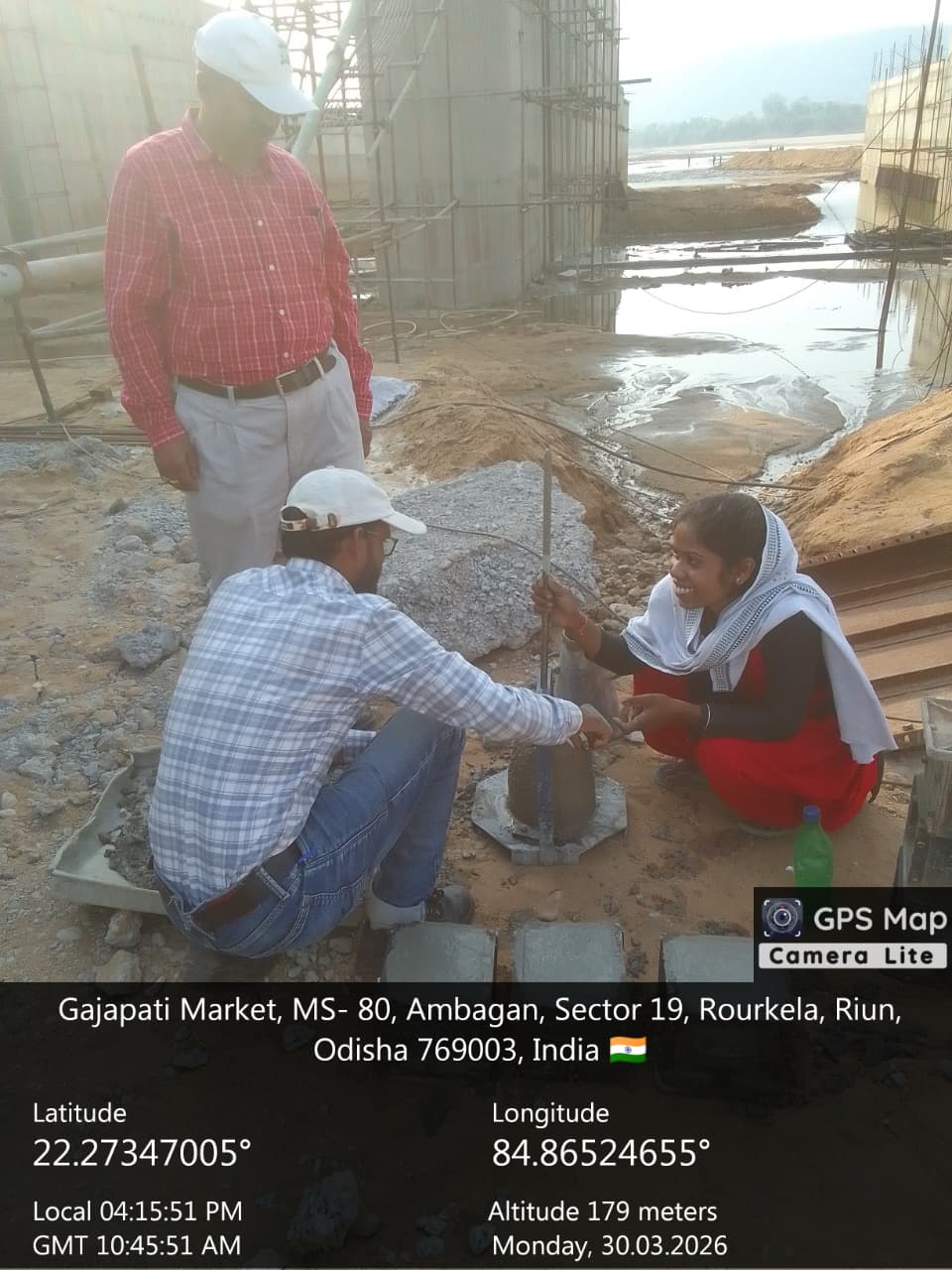

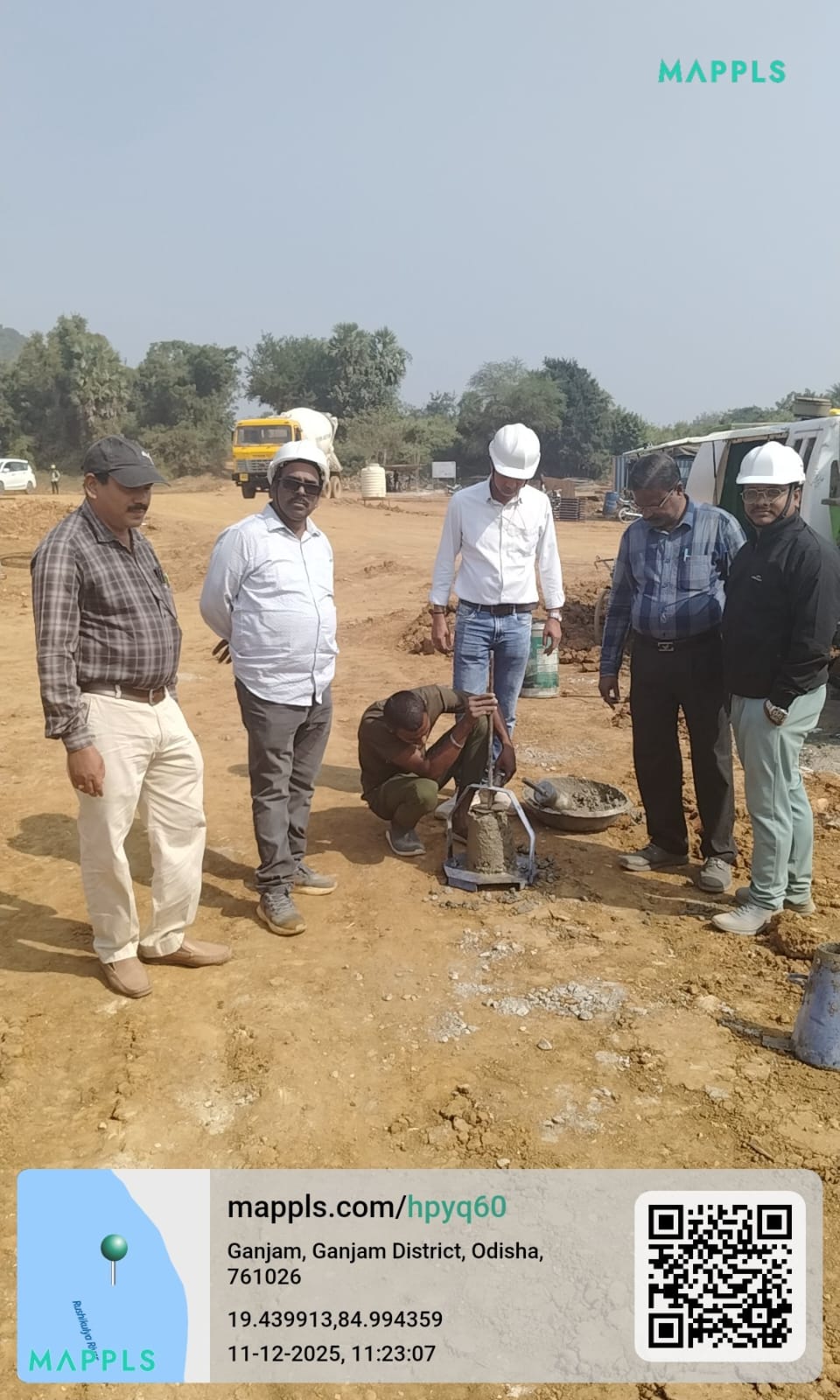

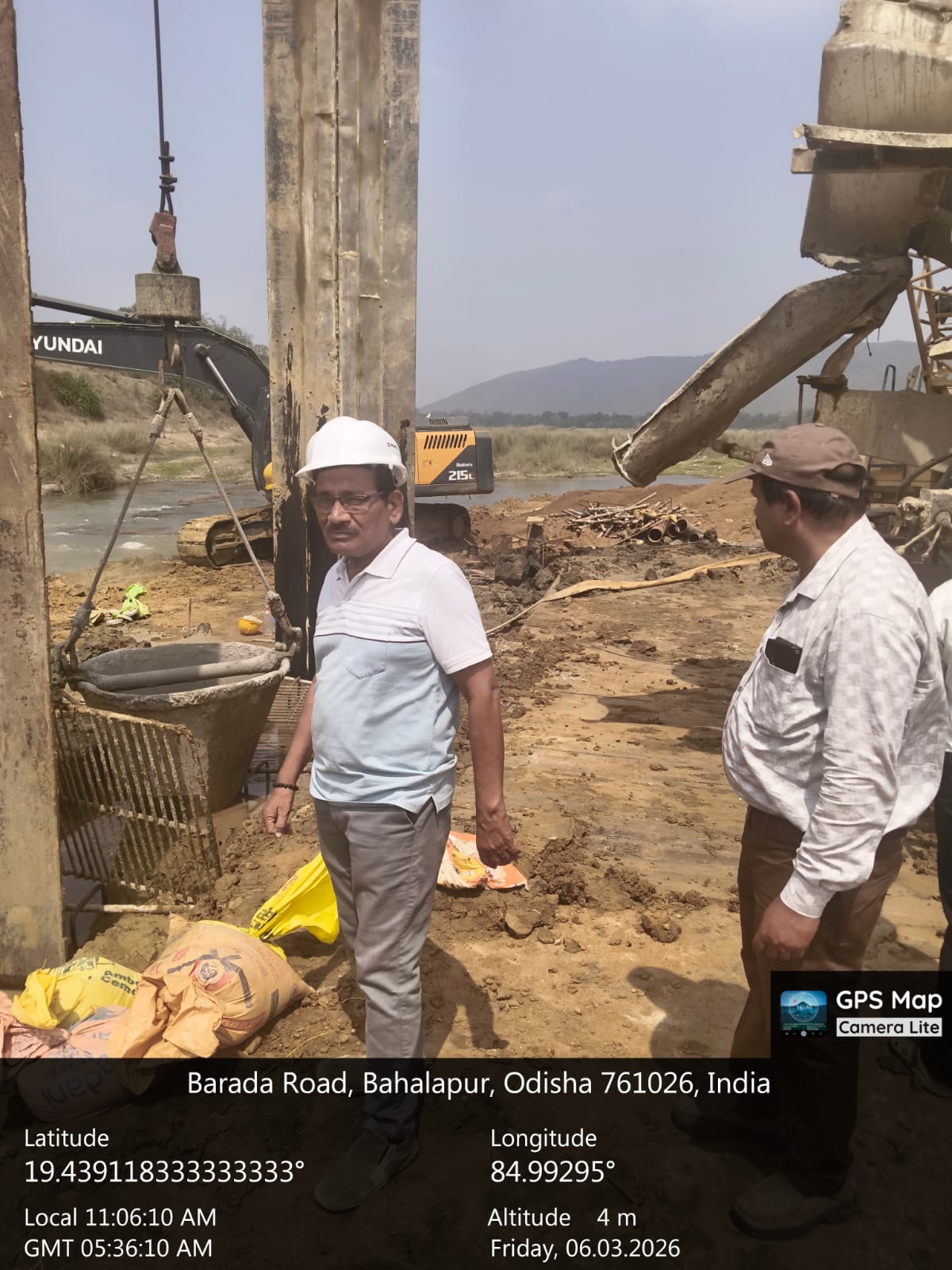

Inspection by Dy. TL, Site Engineer Of PSS team along with EPC agency at site.
43/100

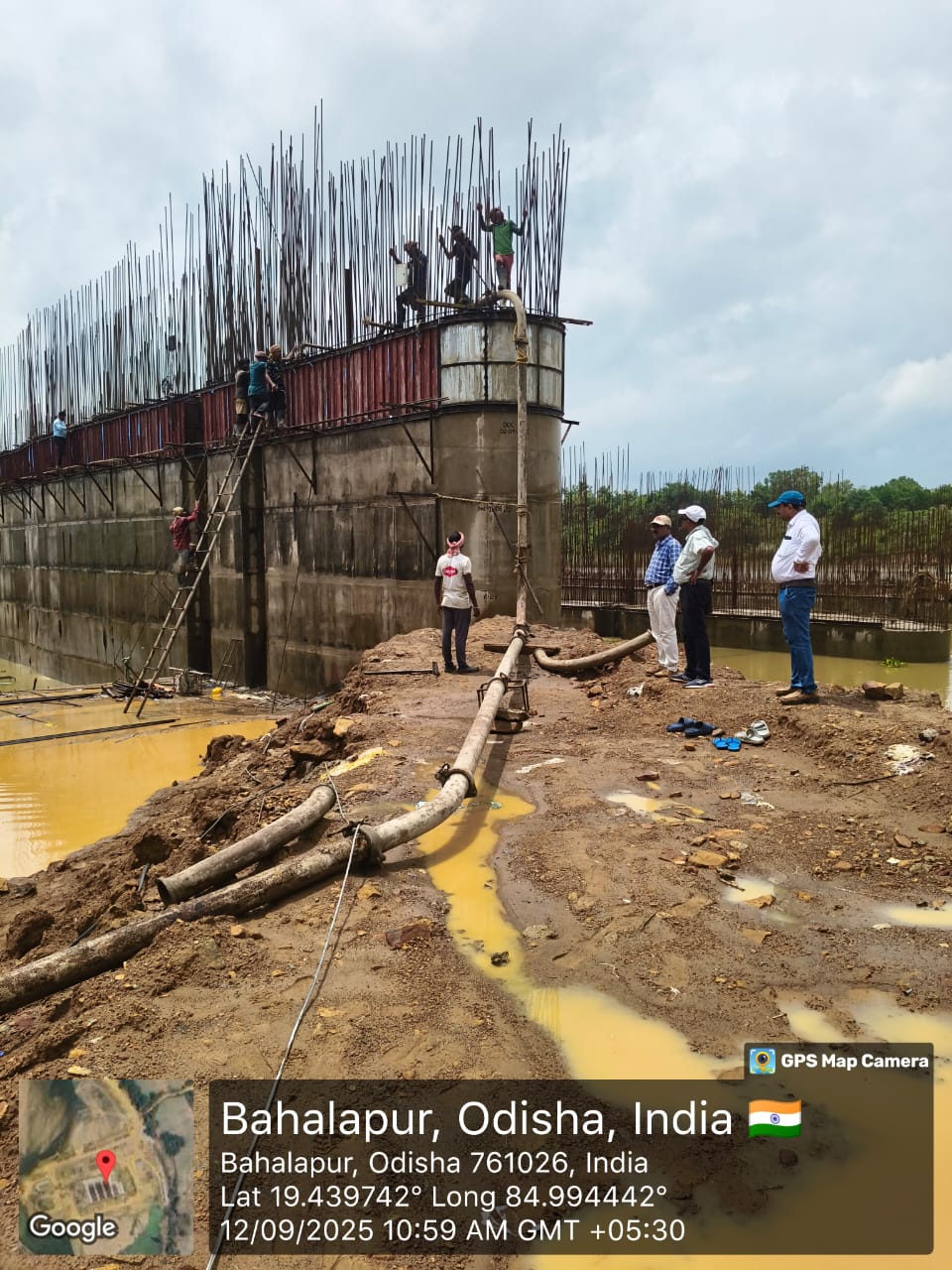

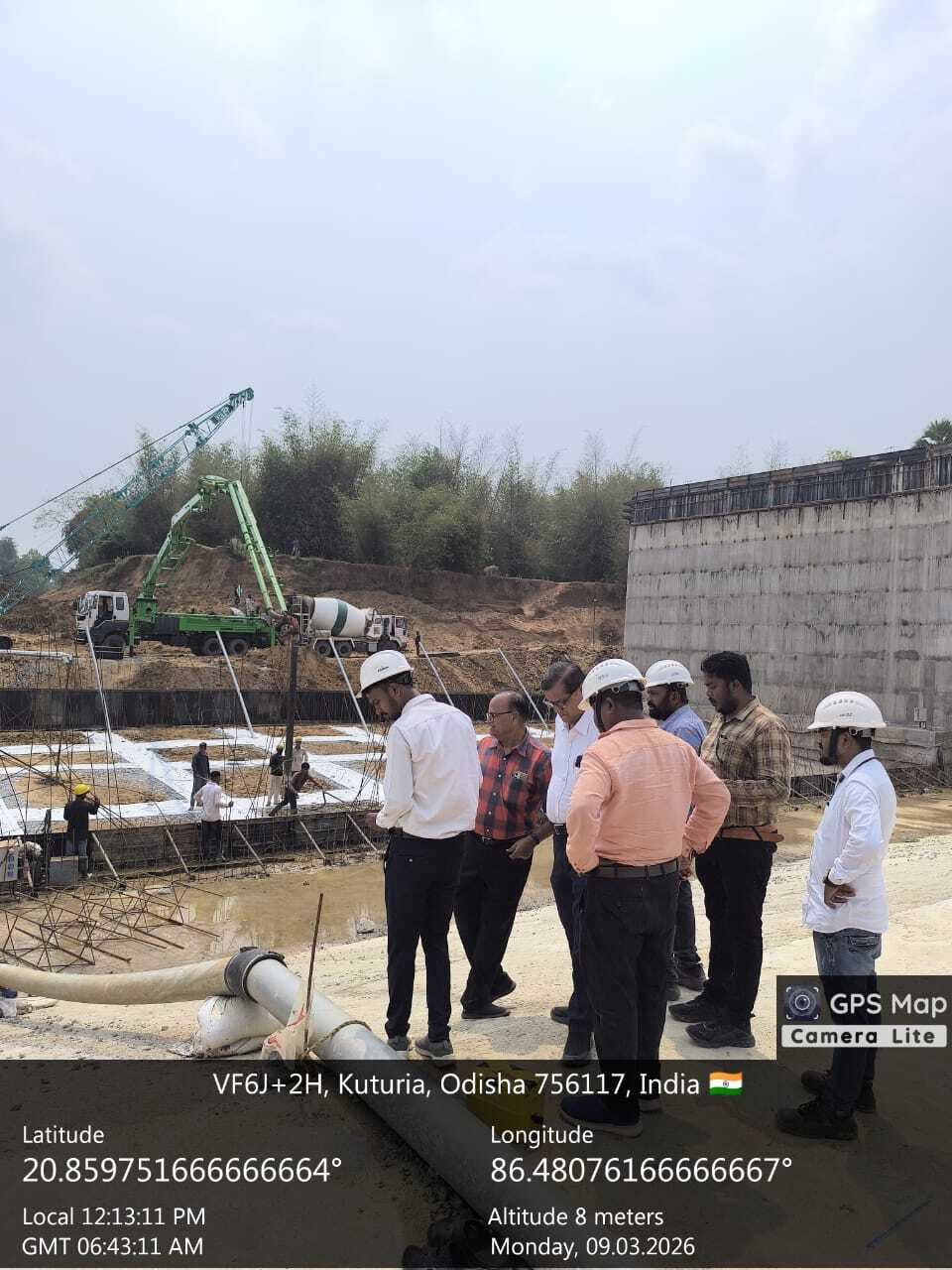

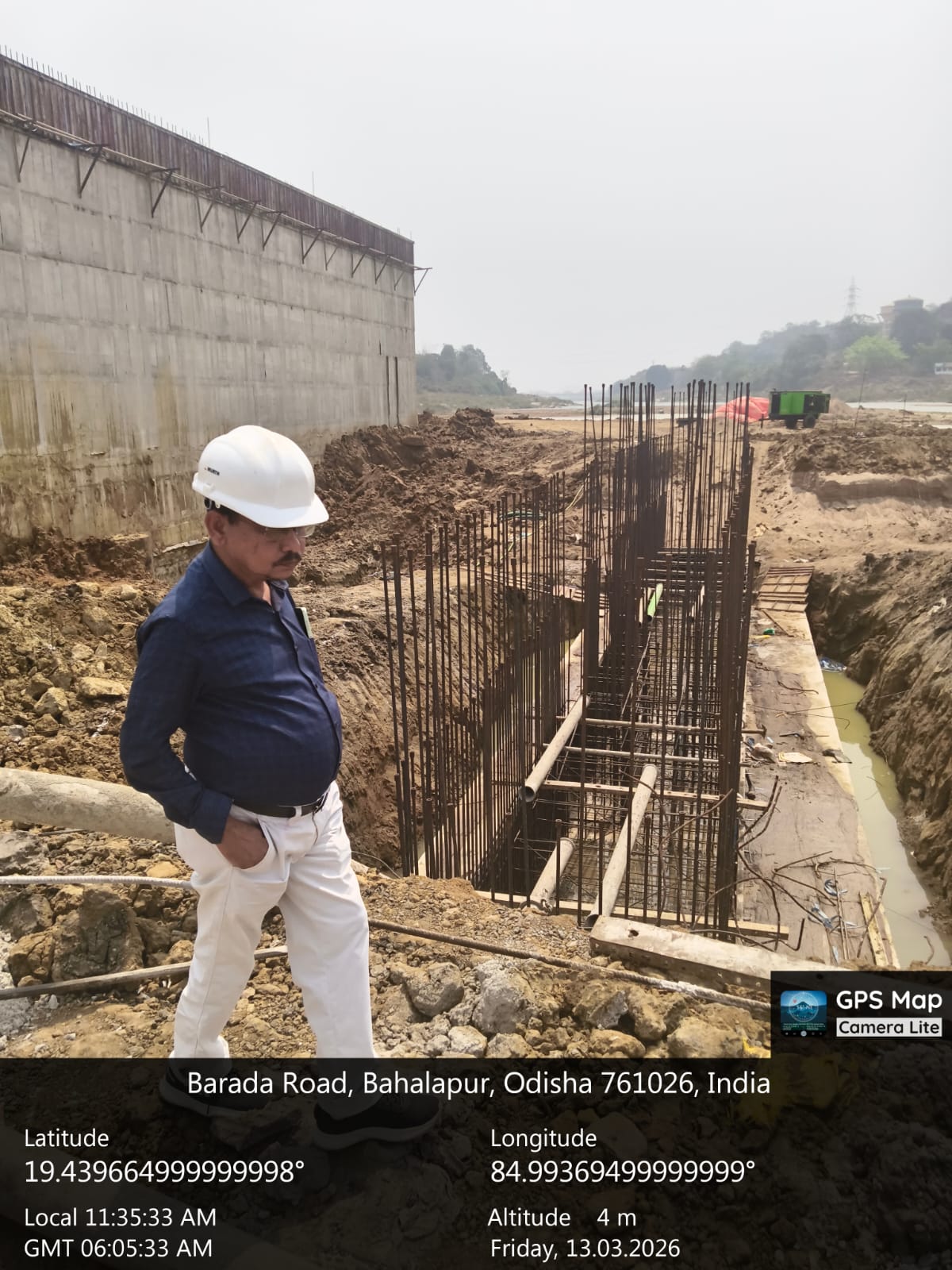

Instream Storage Structure, Near Village Basantpur across River Daya

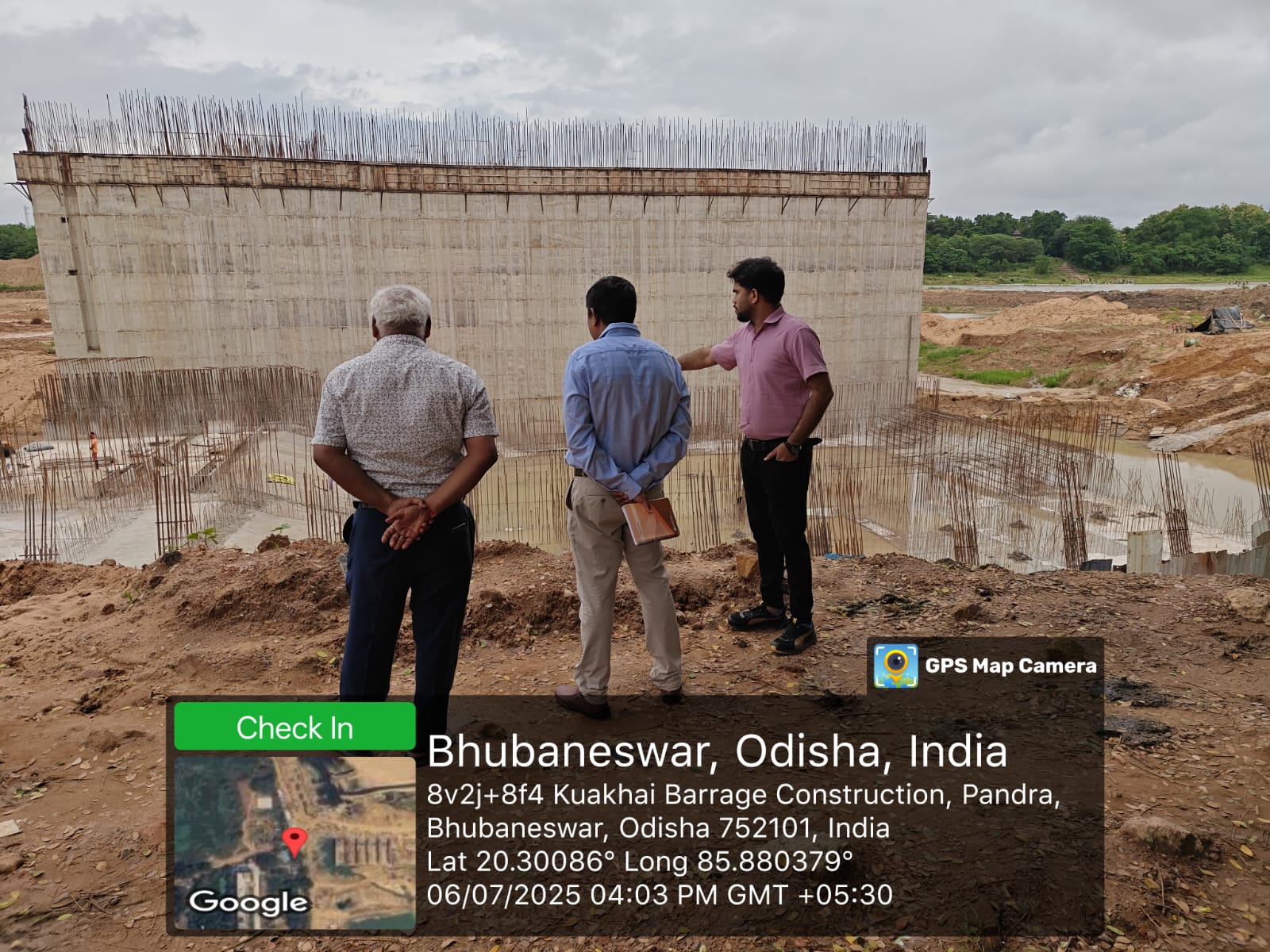

CE, MKS, SE, Prachi division with departmental engineers along with PSS team visited the ISS work Site.
44/100

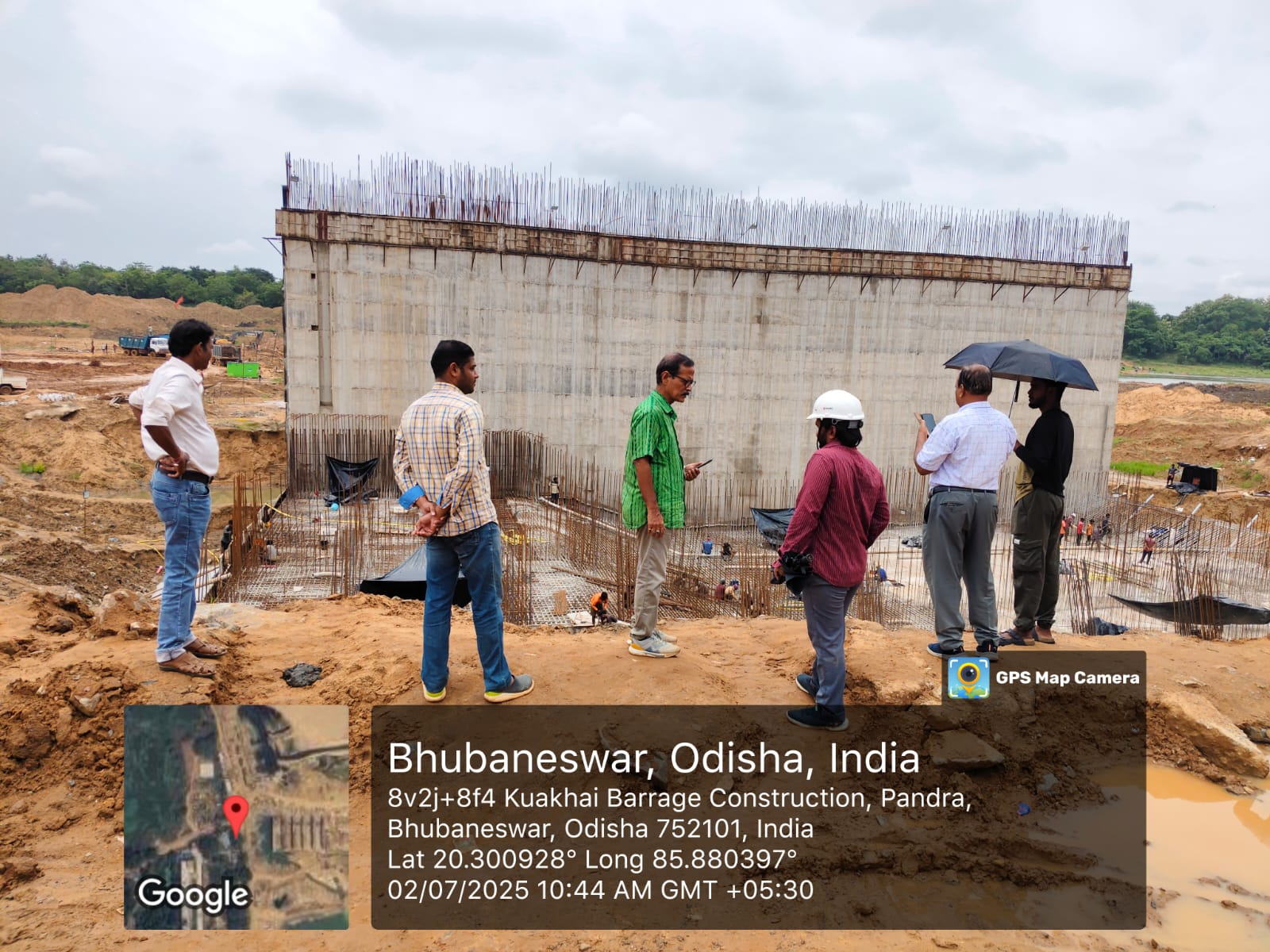

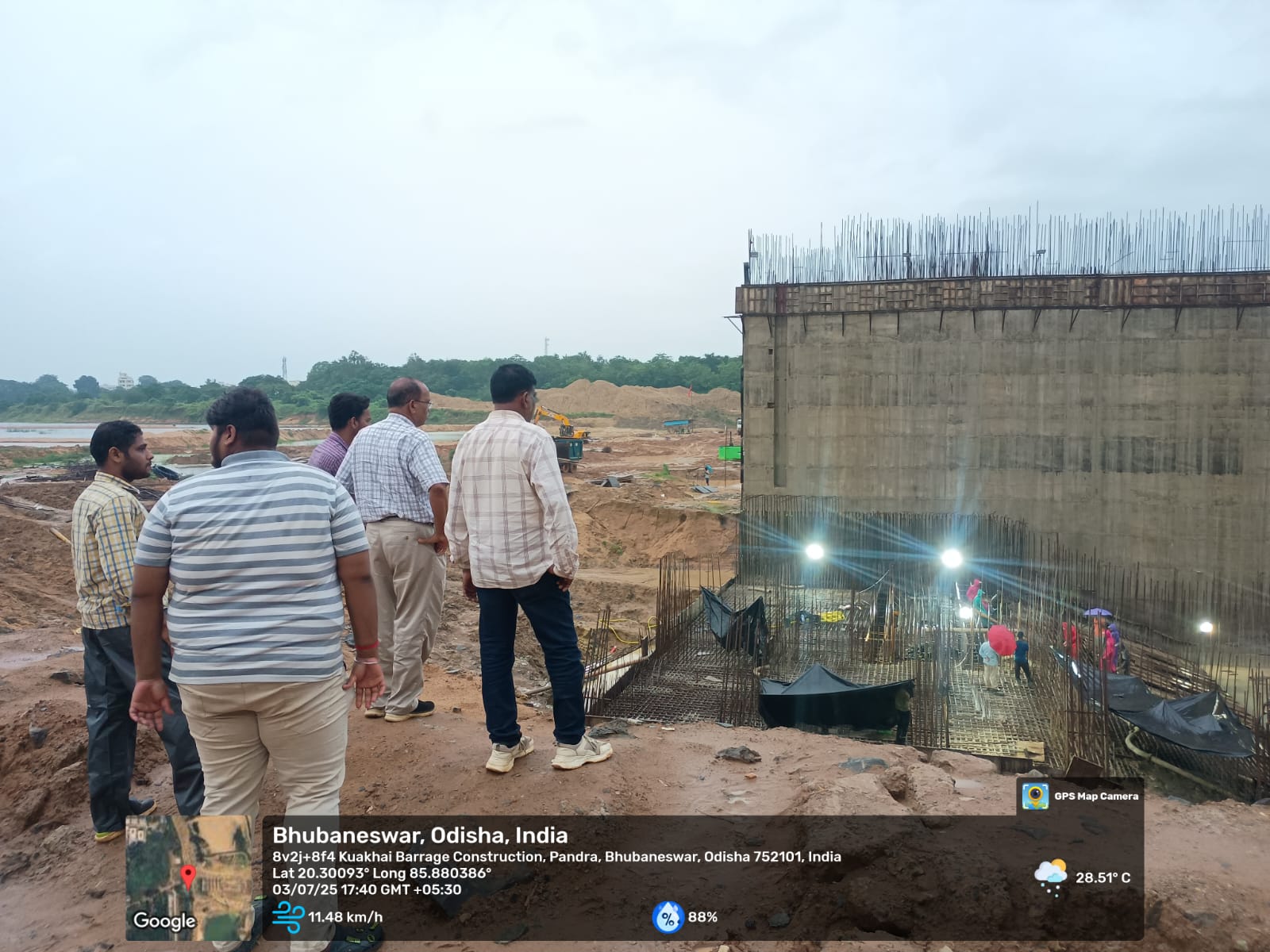

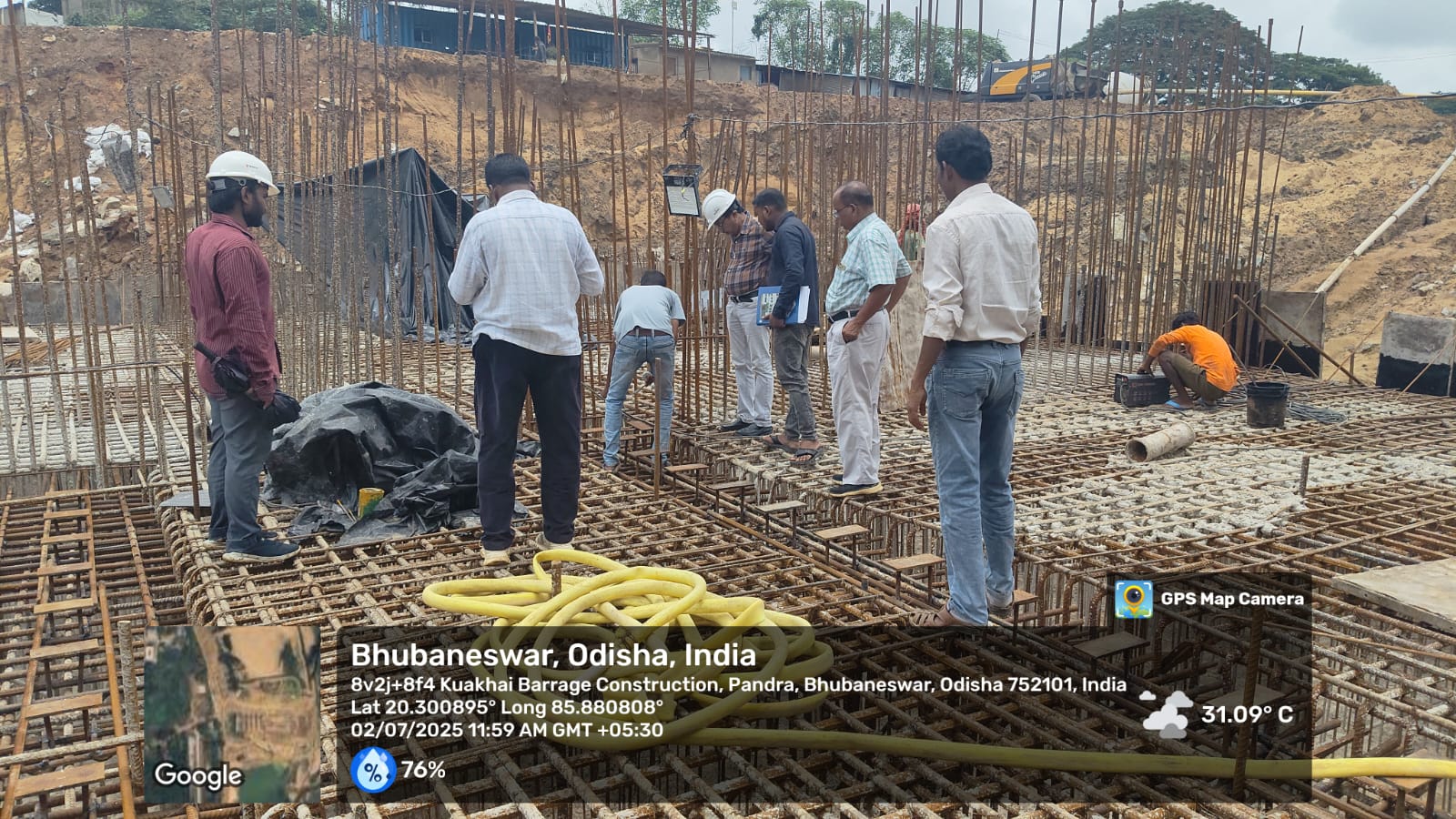

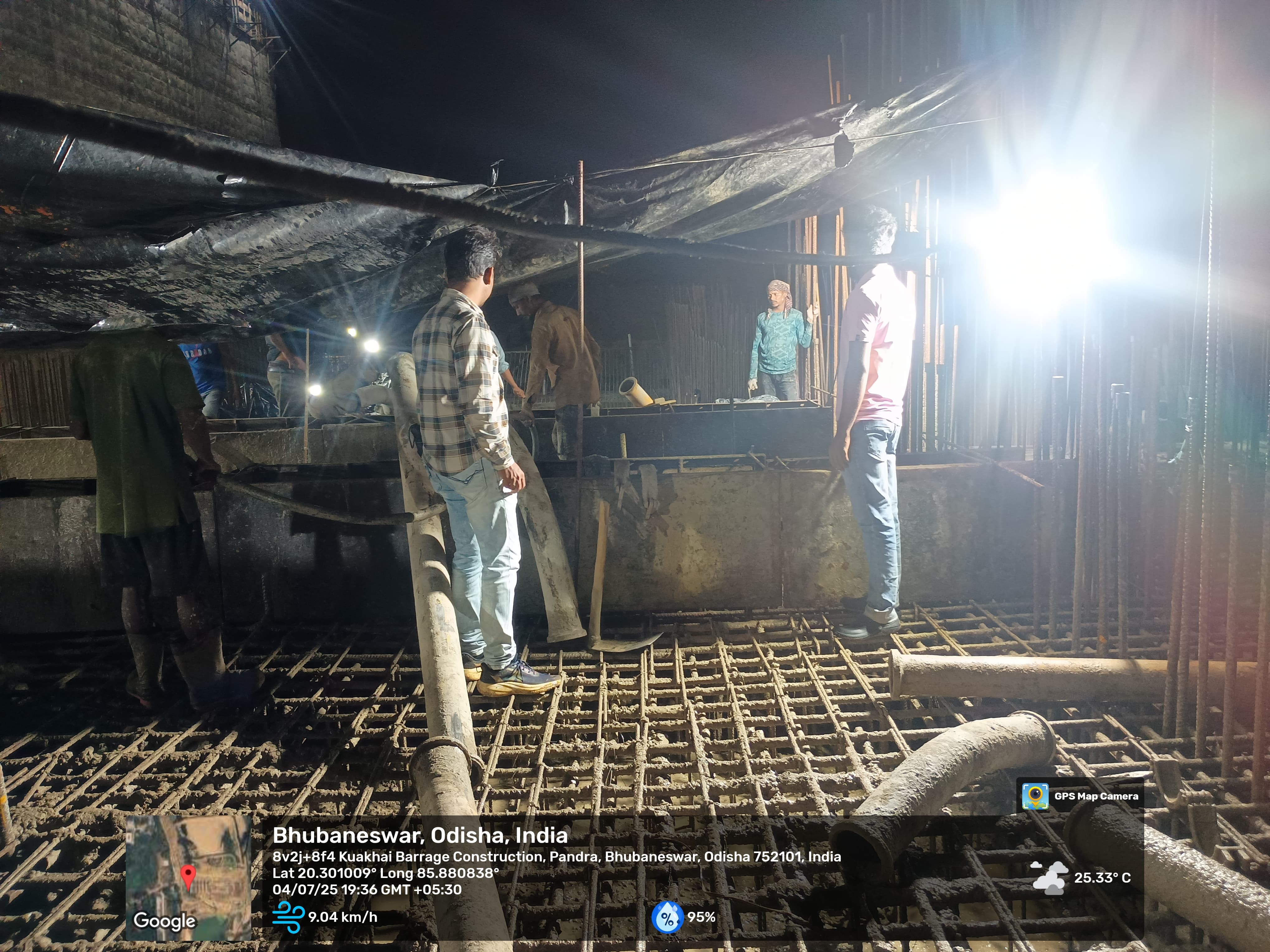

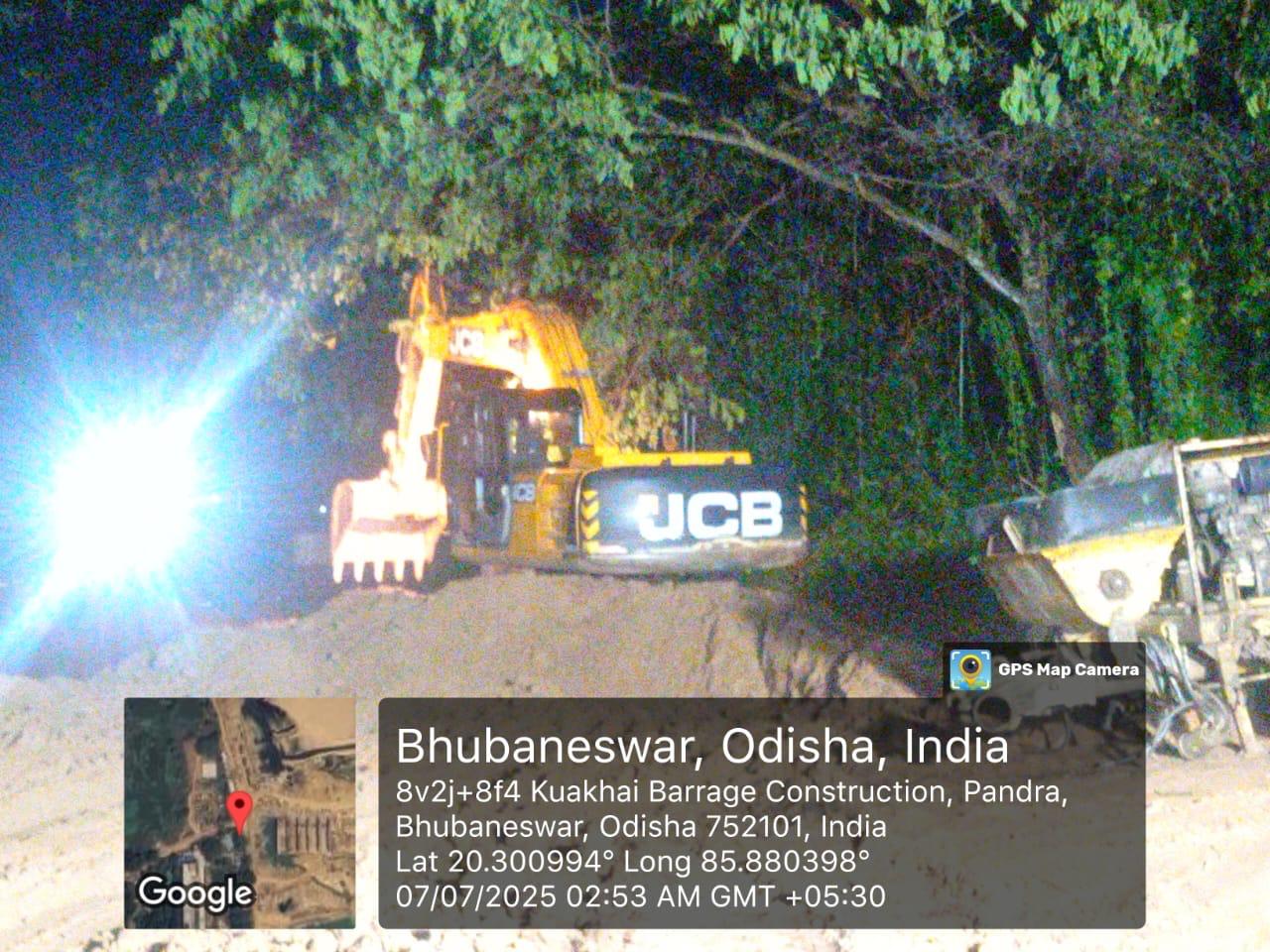

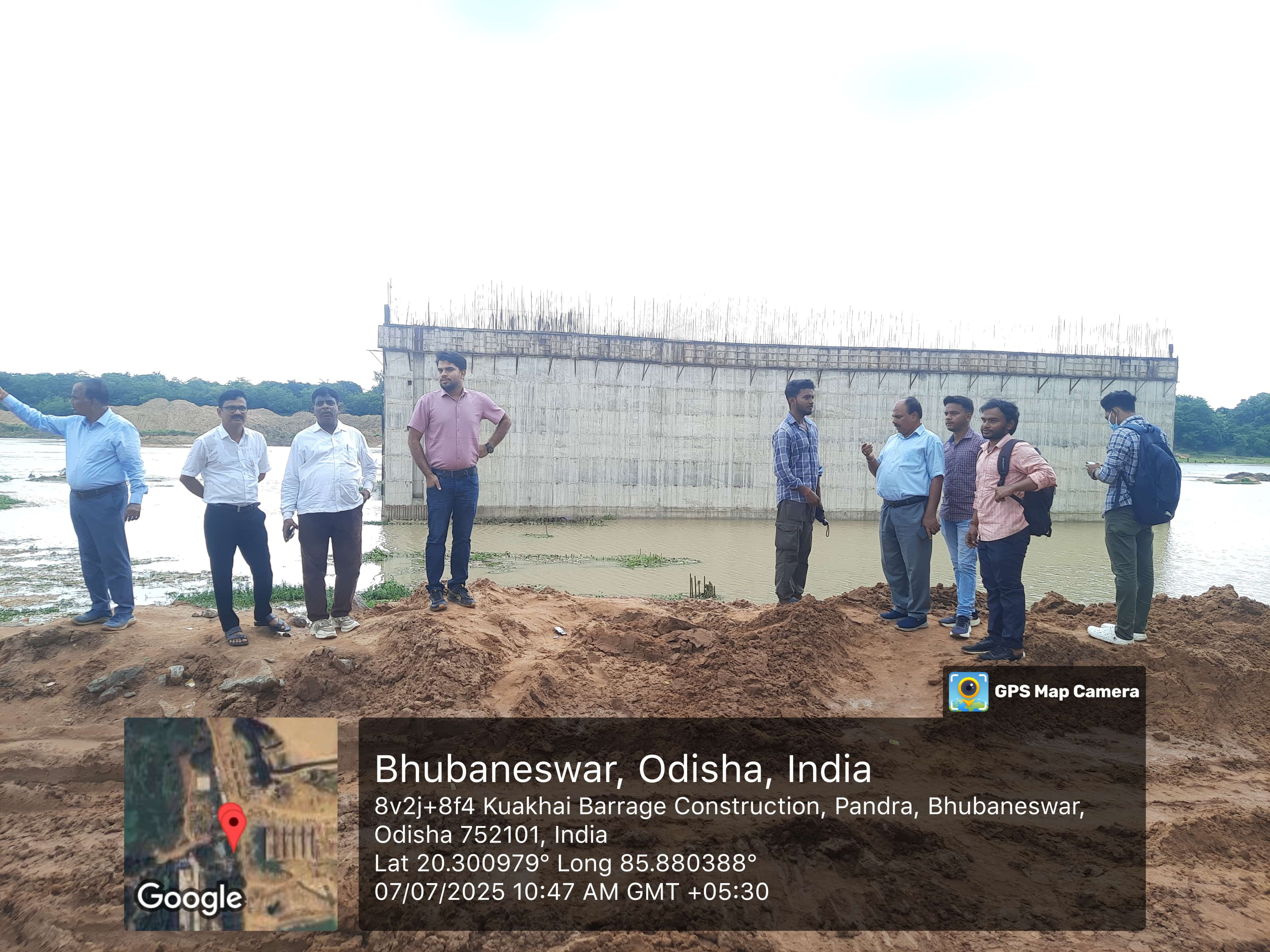

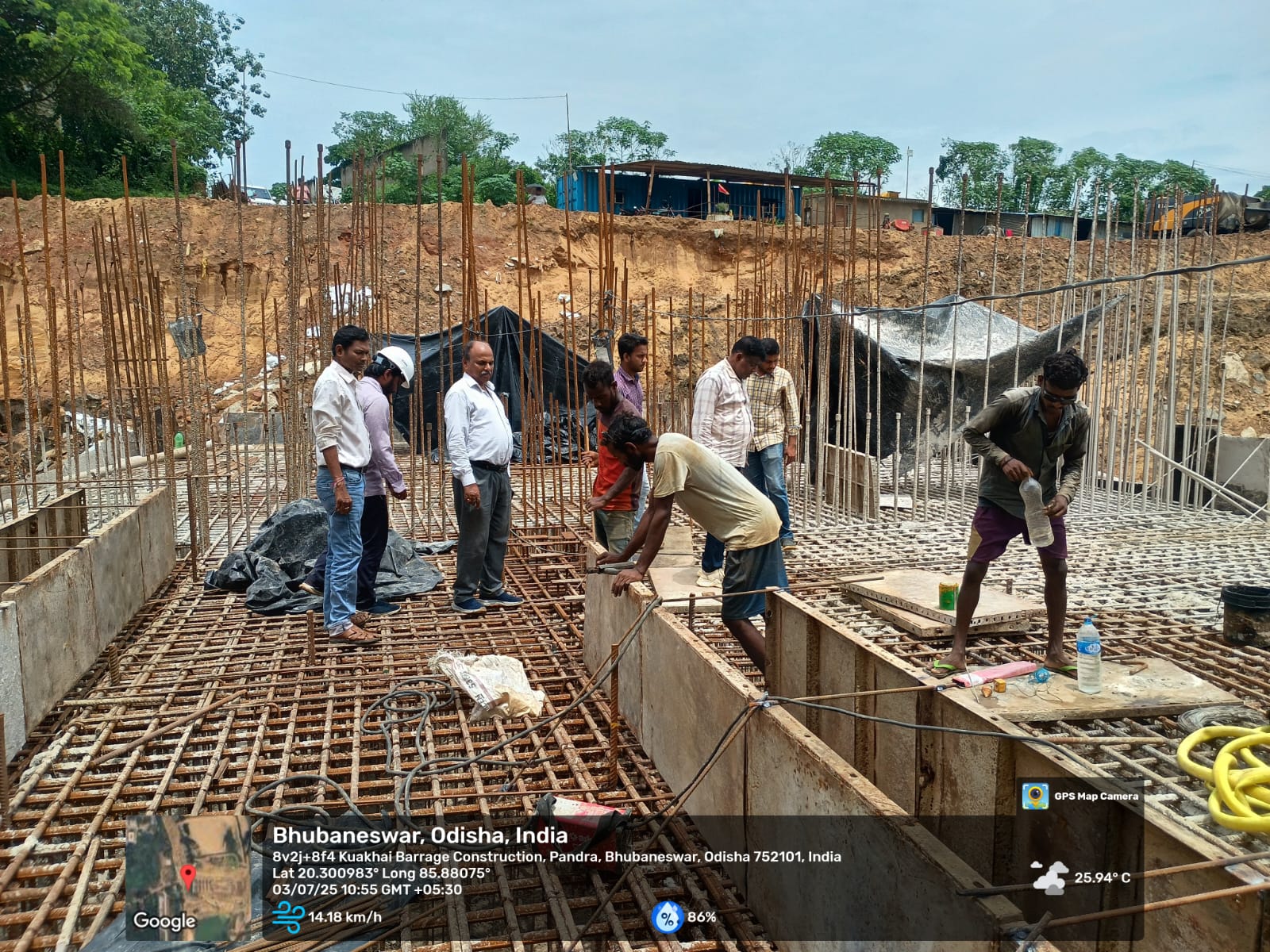

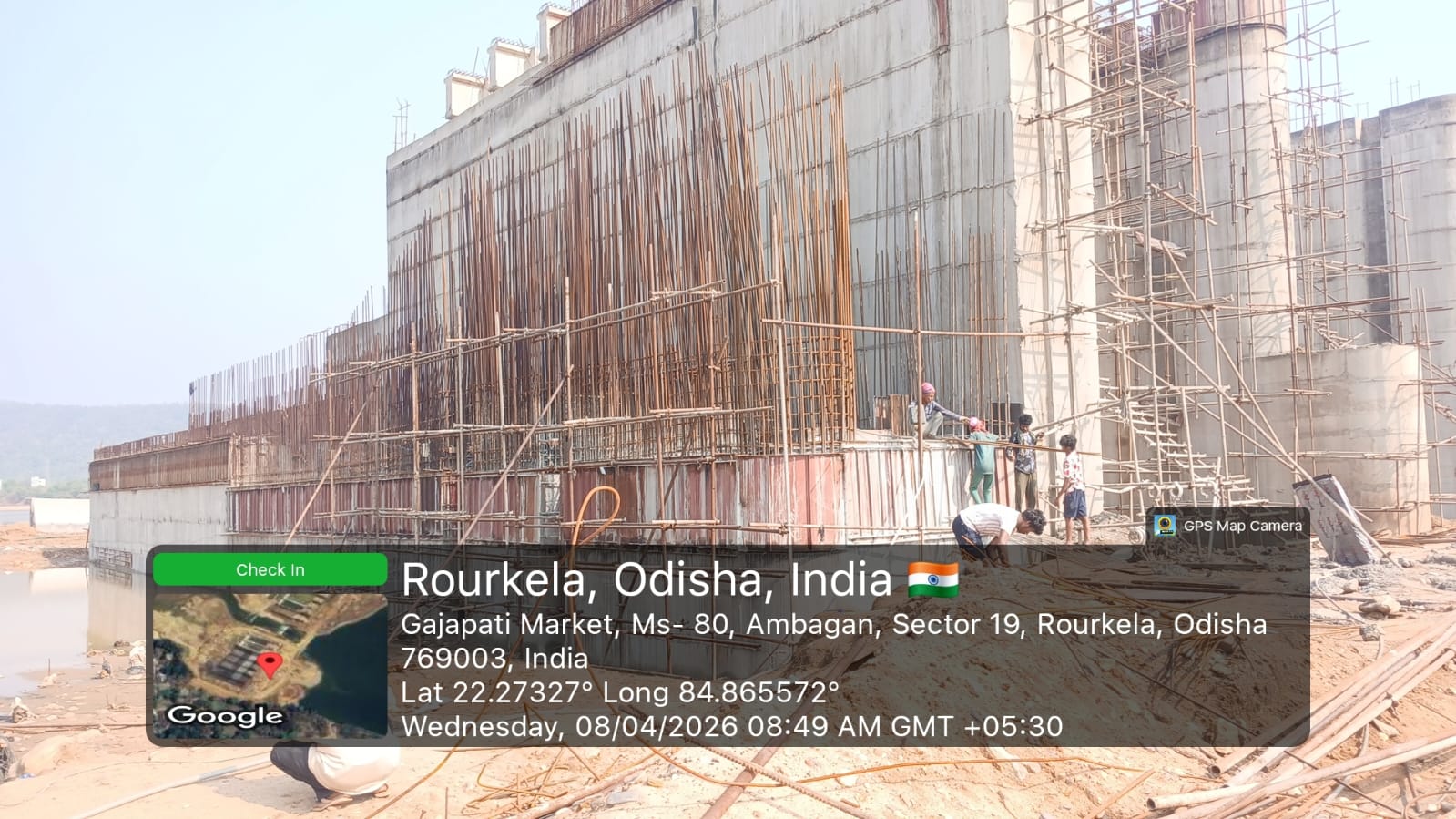

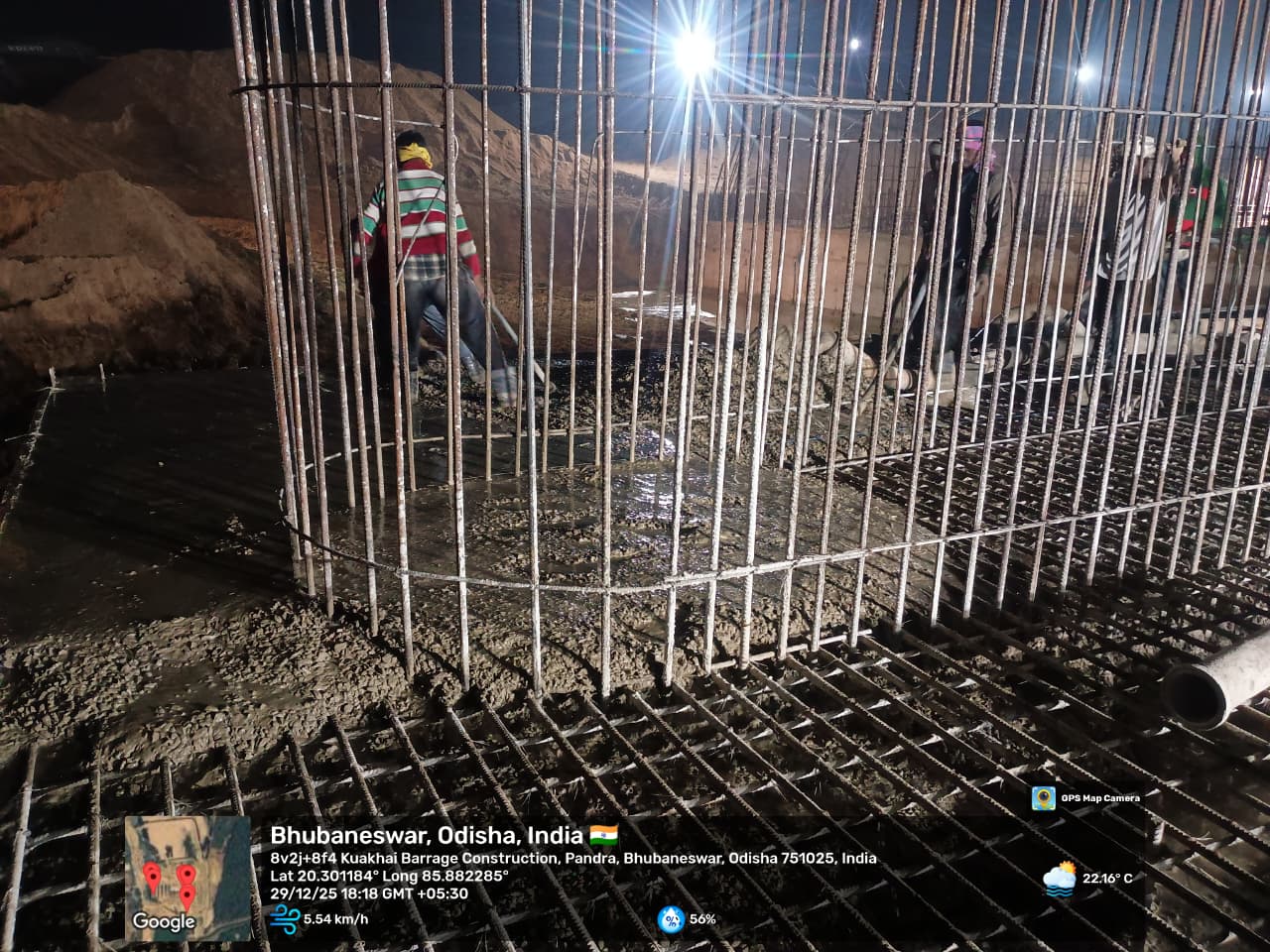

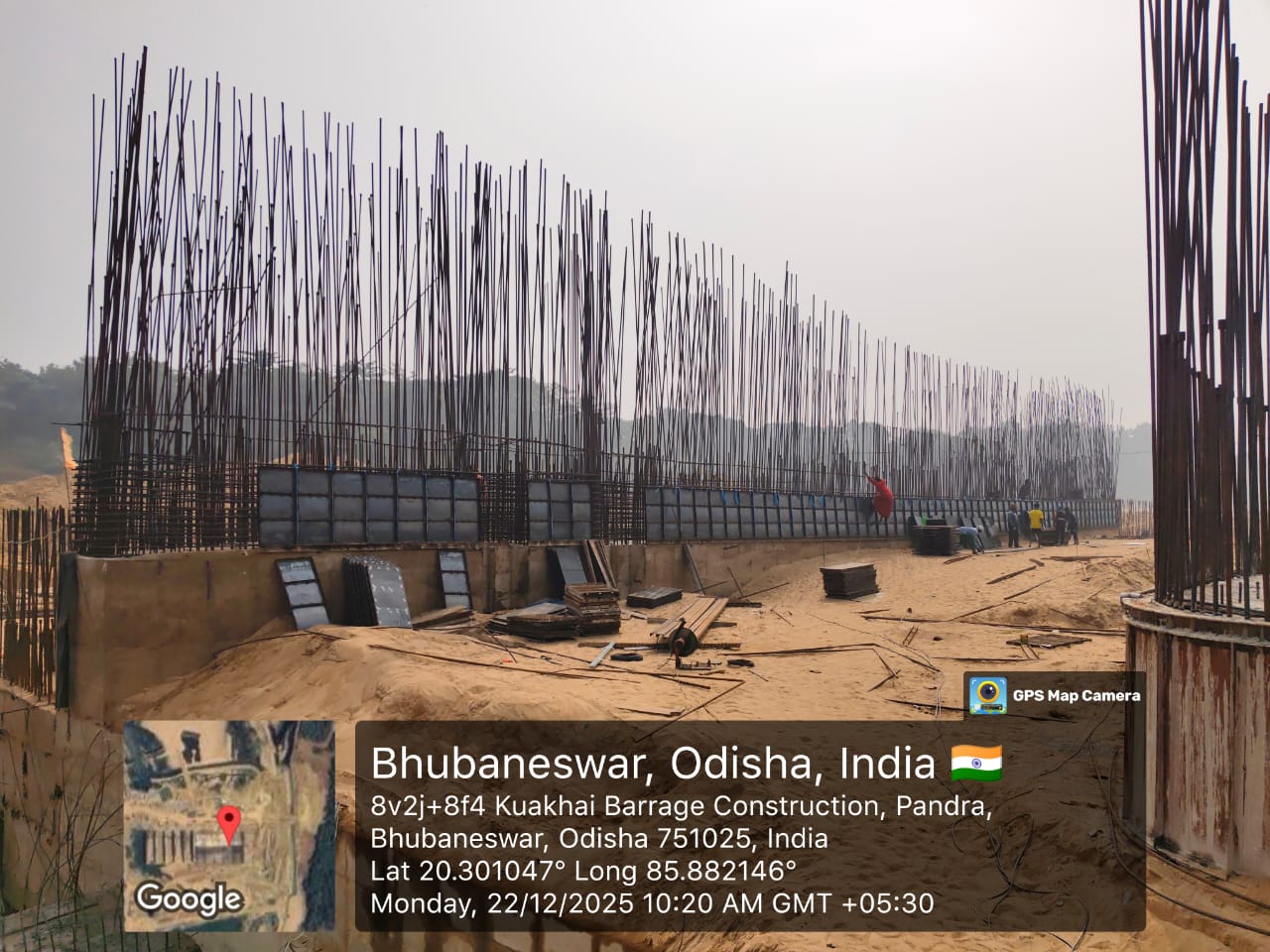

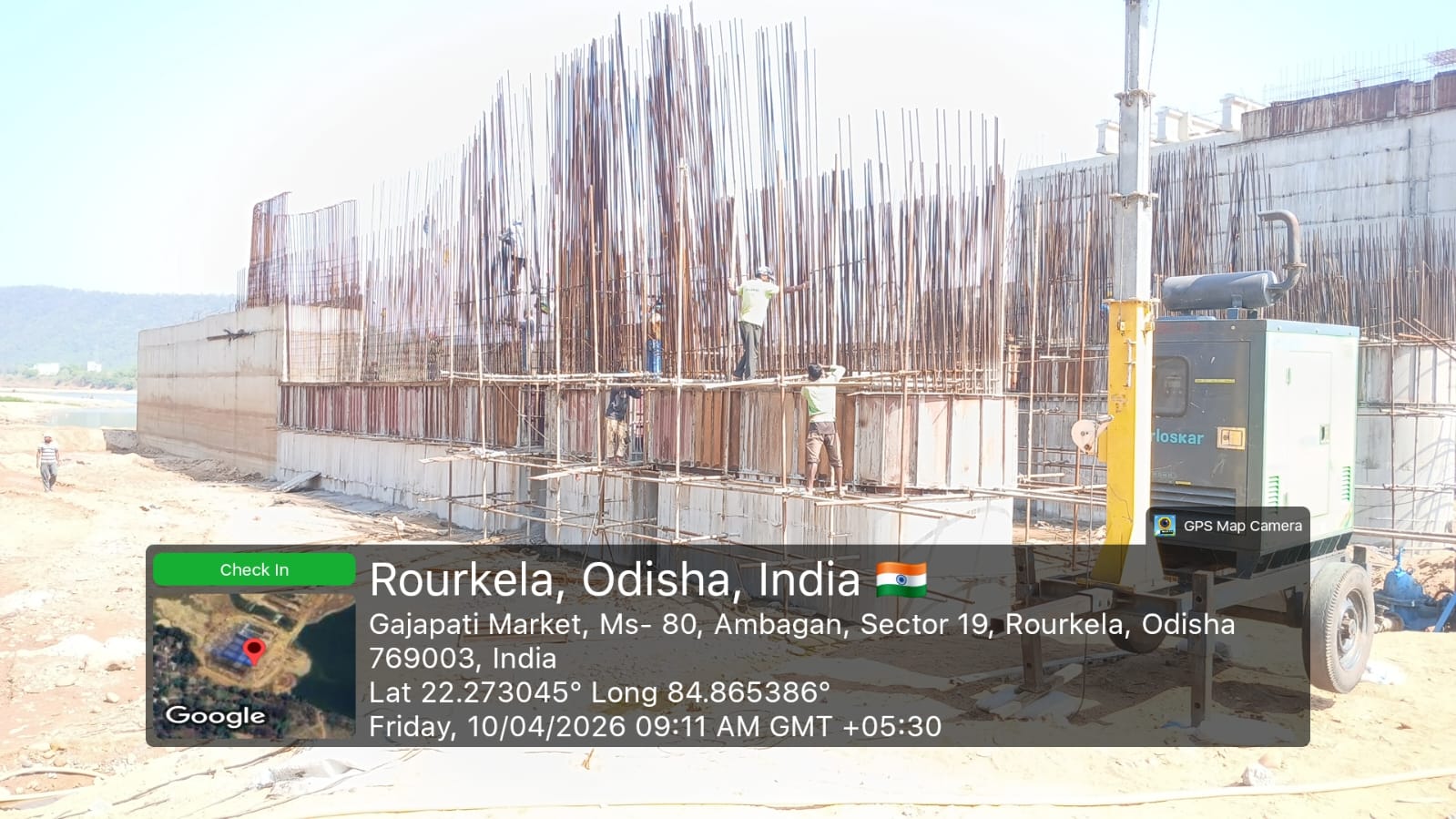

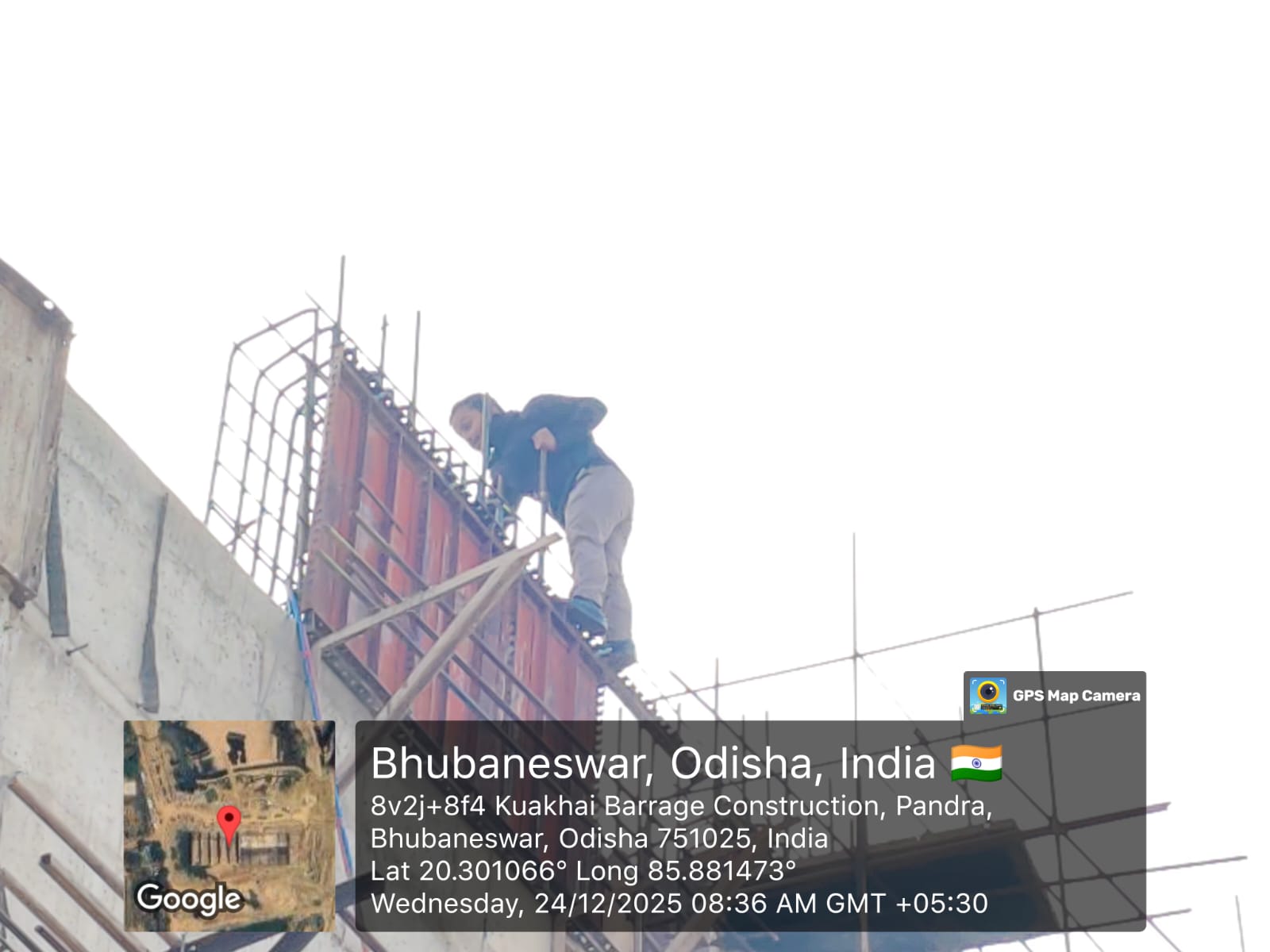

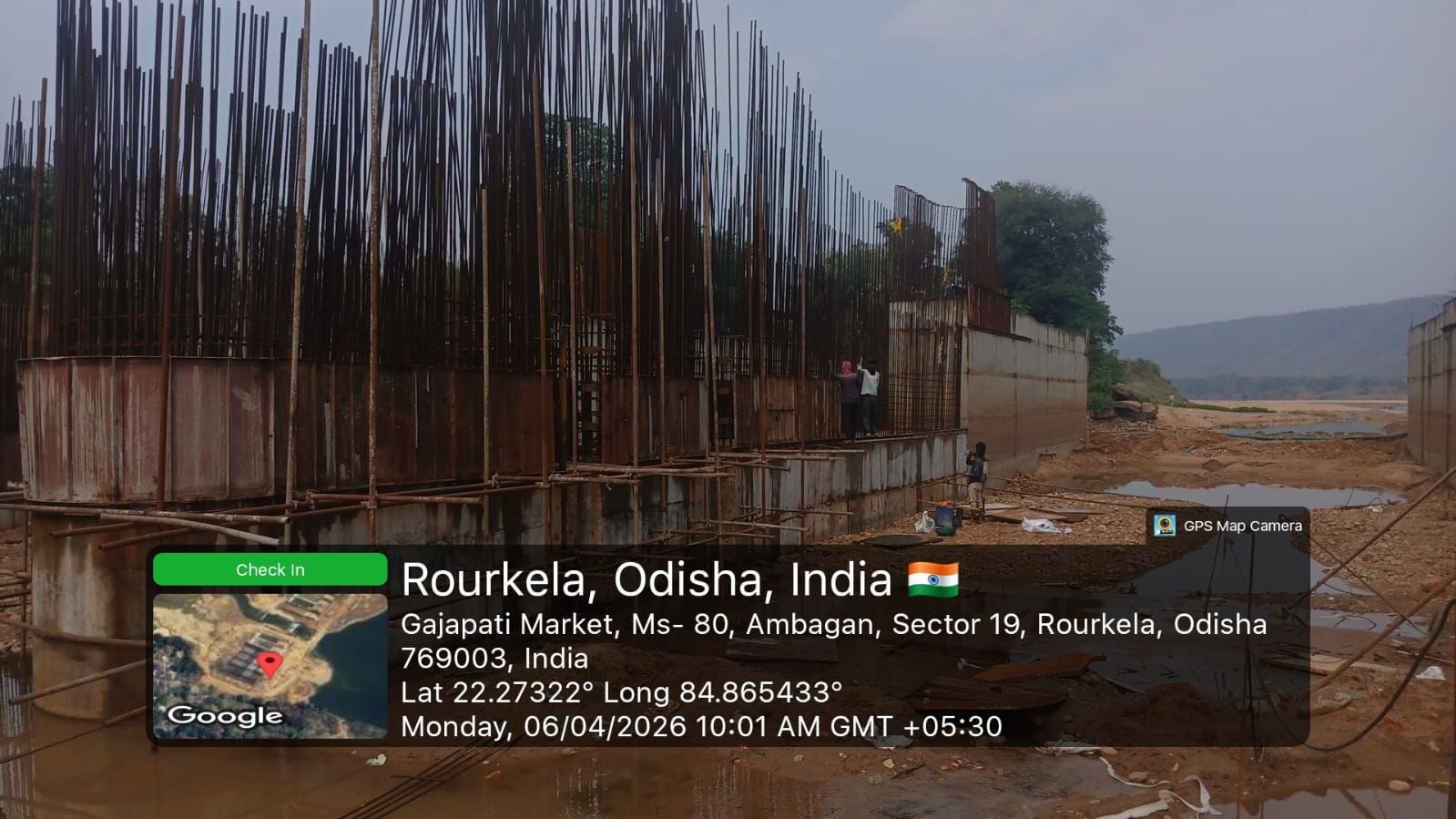

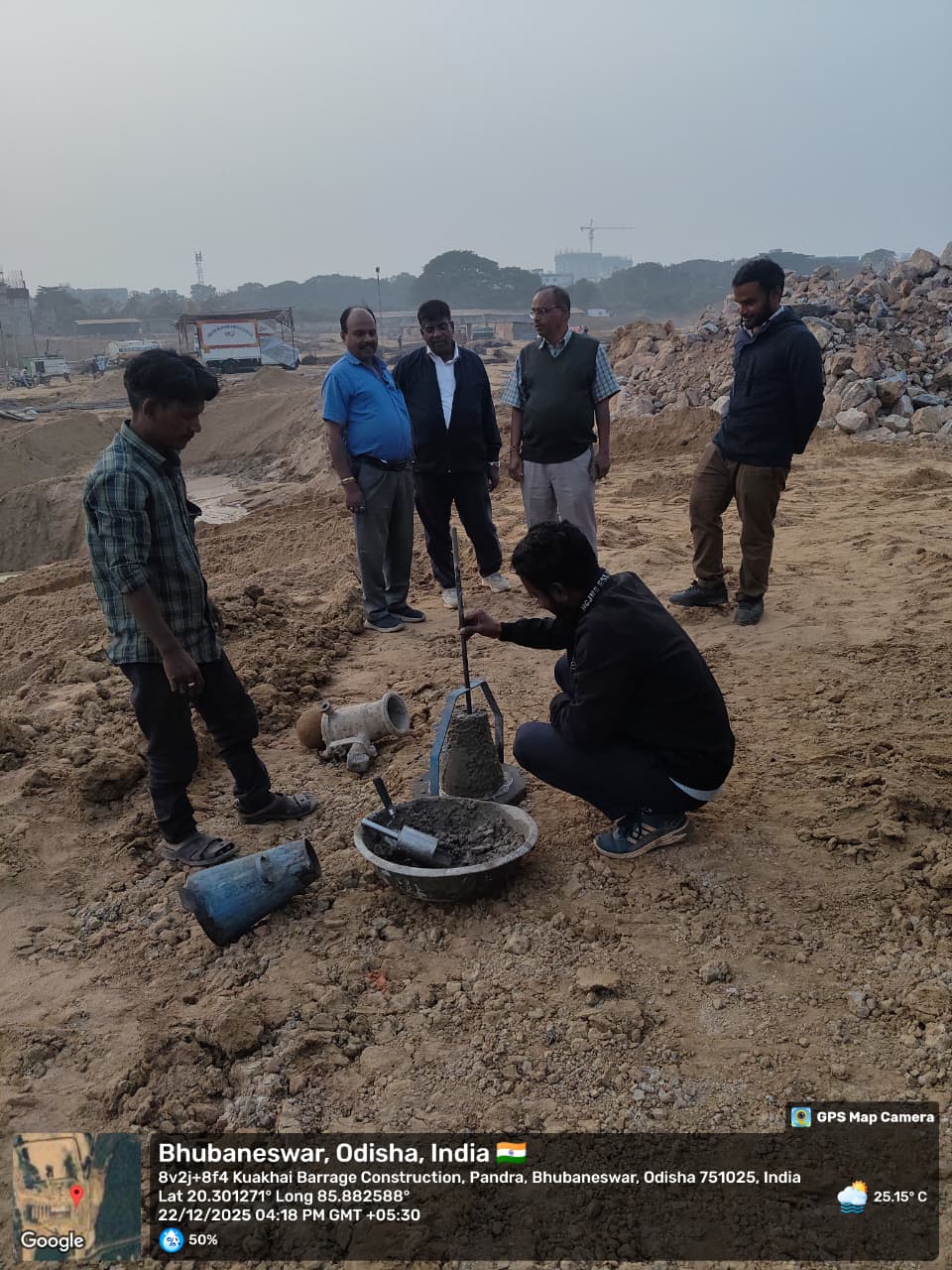

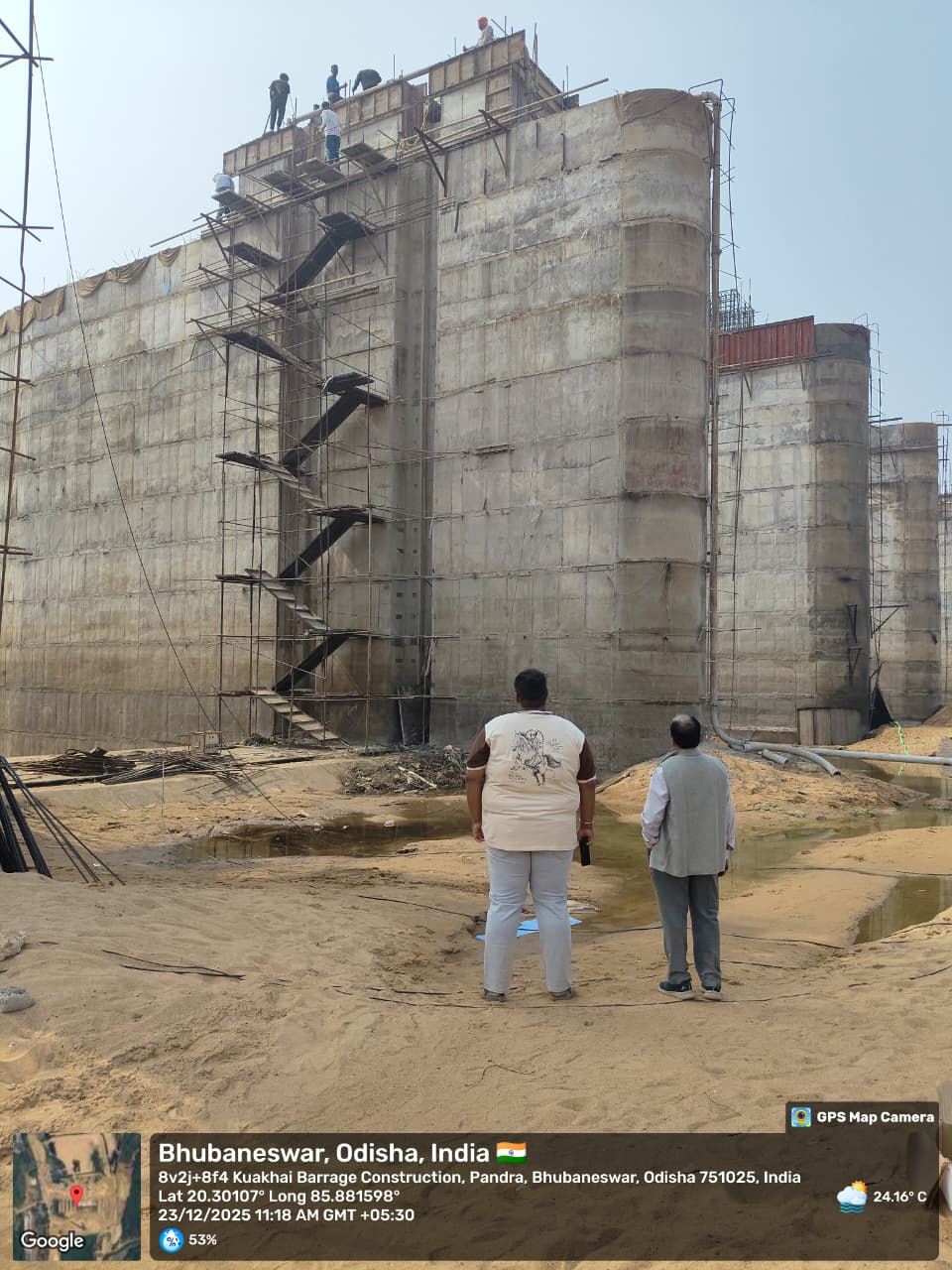

Instream Storage Structure, Kuakhai

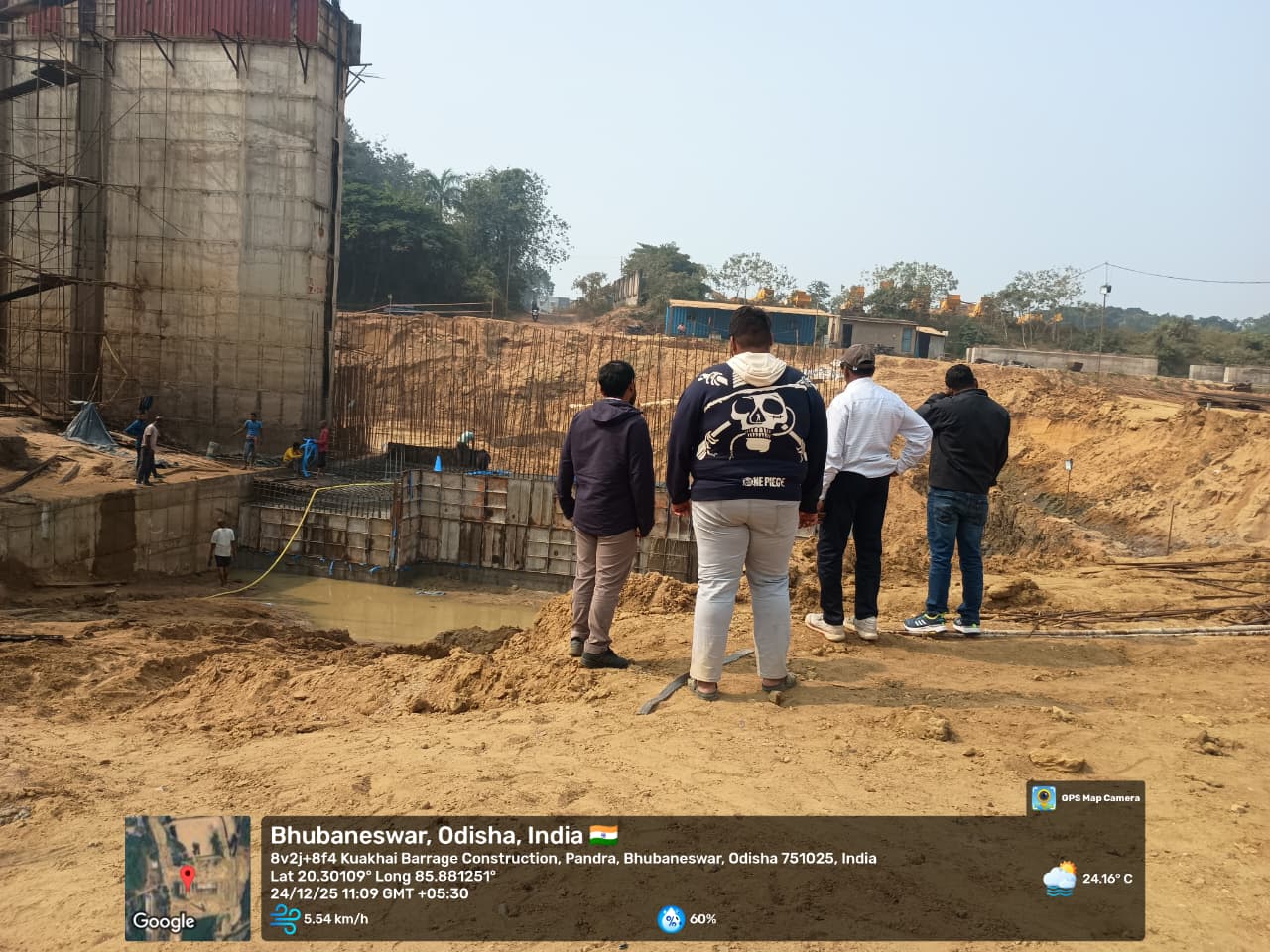

CE ,MKS, SE,Prachi division with departmental engineers along with PSS team visited the work Site .
45/100

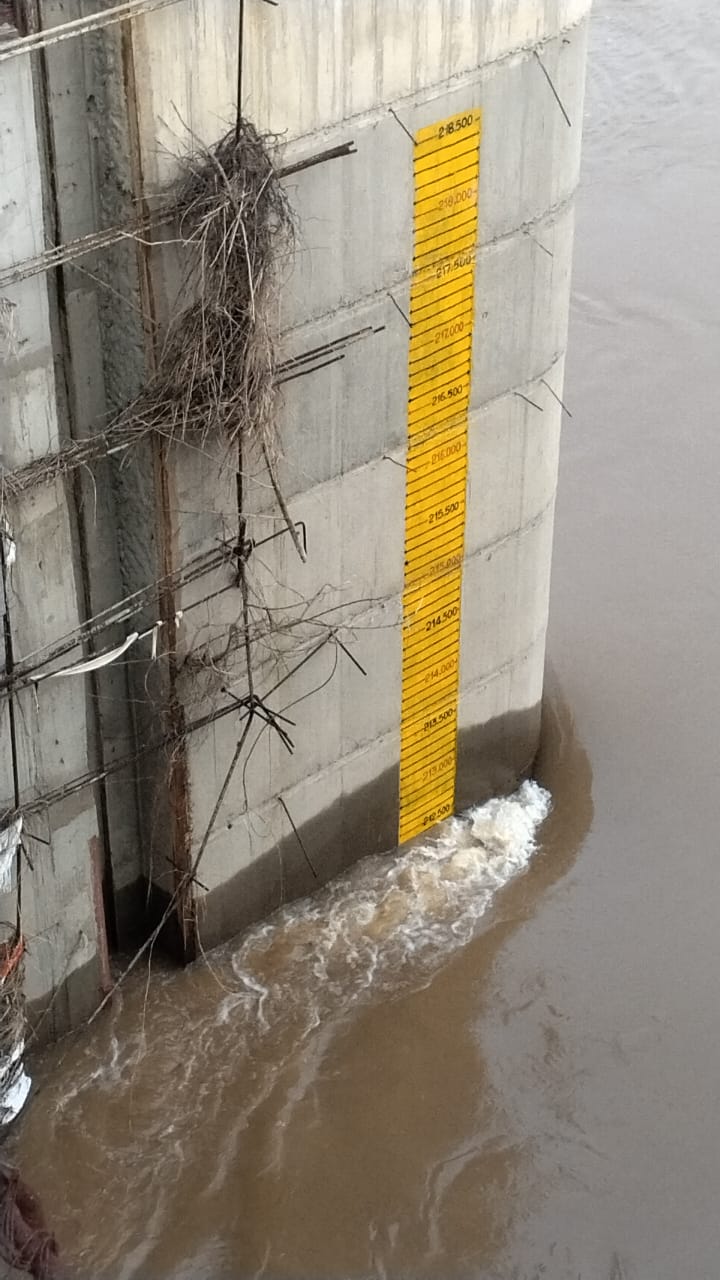

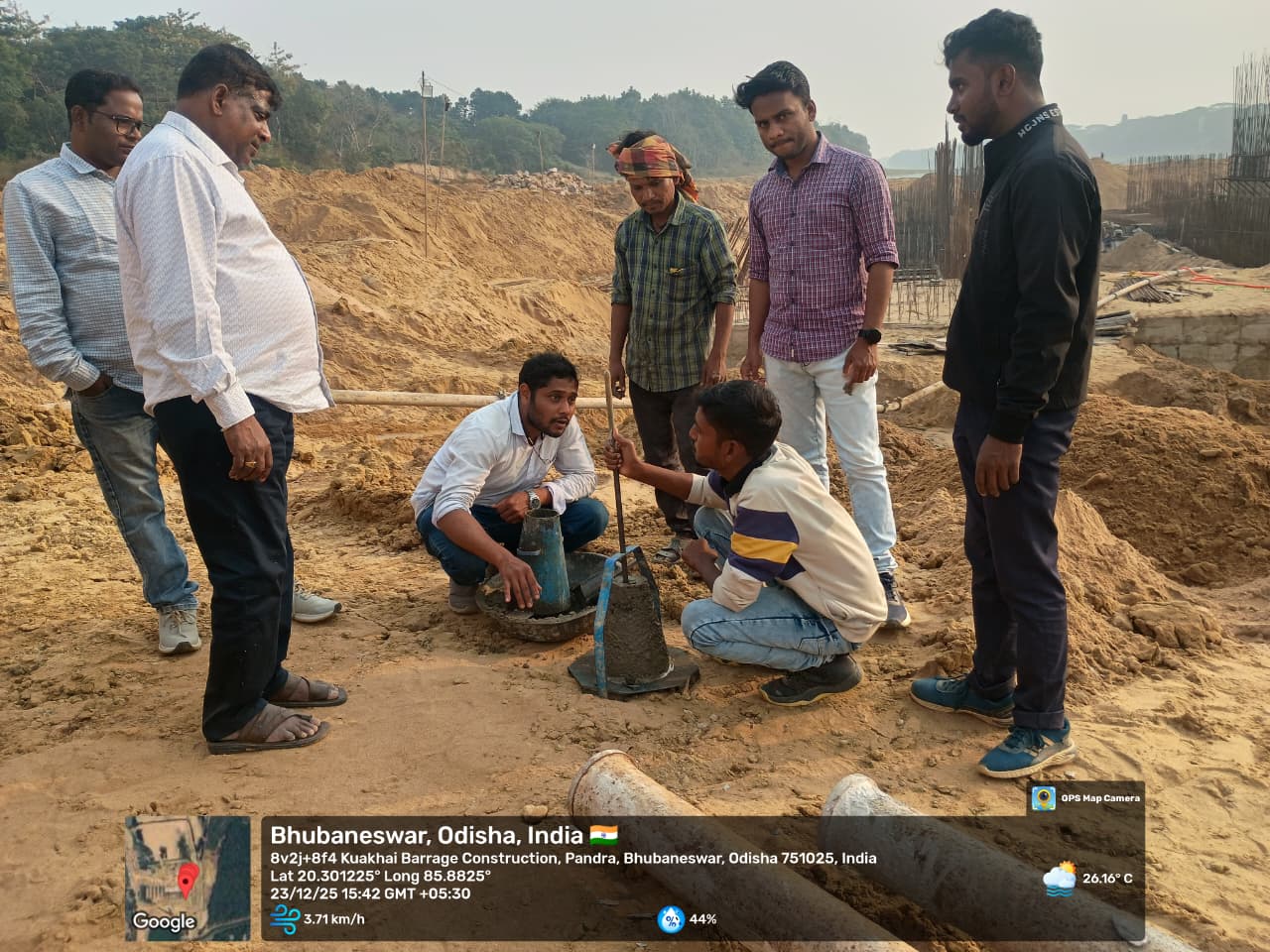

Instream Storage Structure, Kuakhai

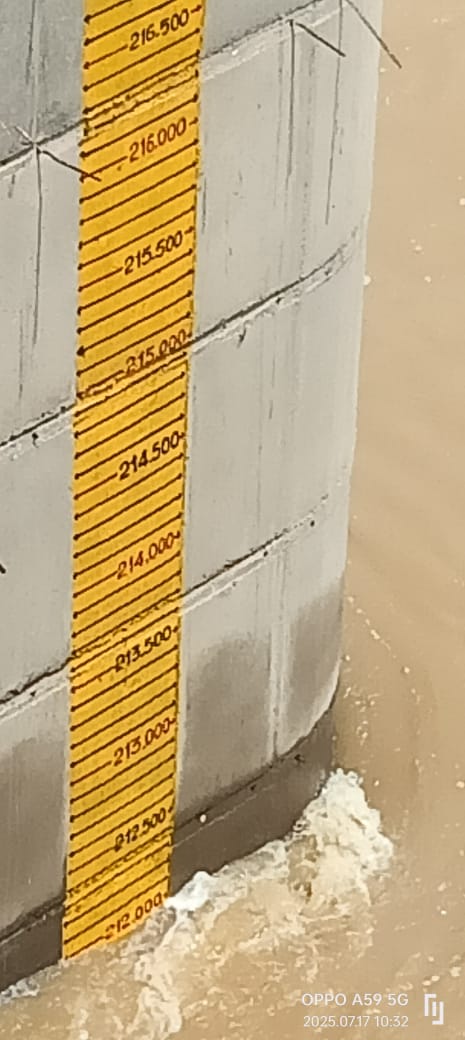

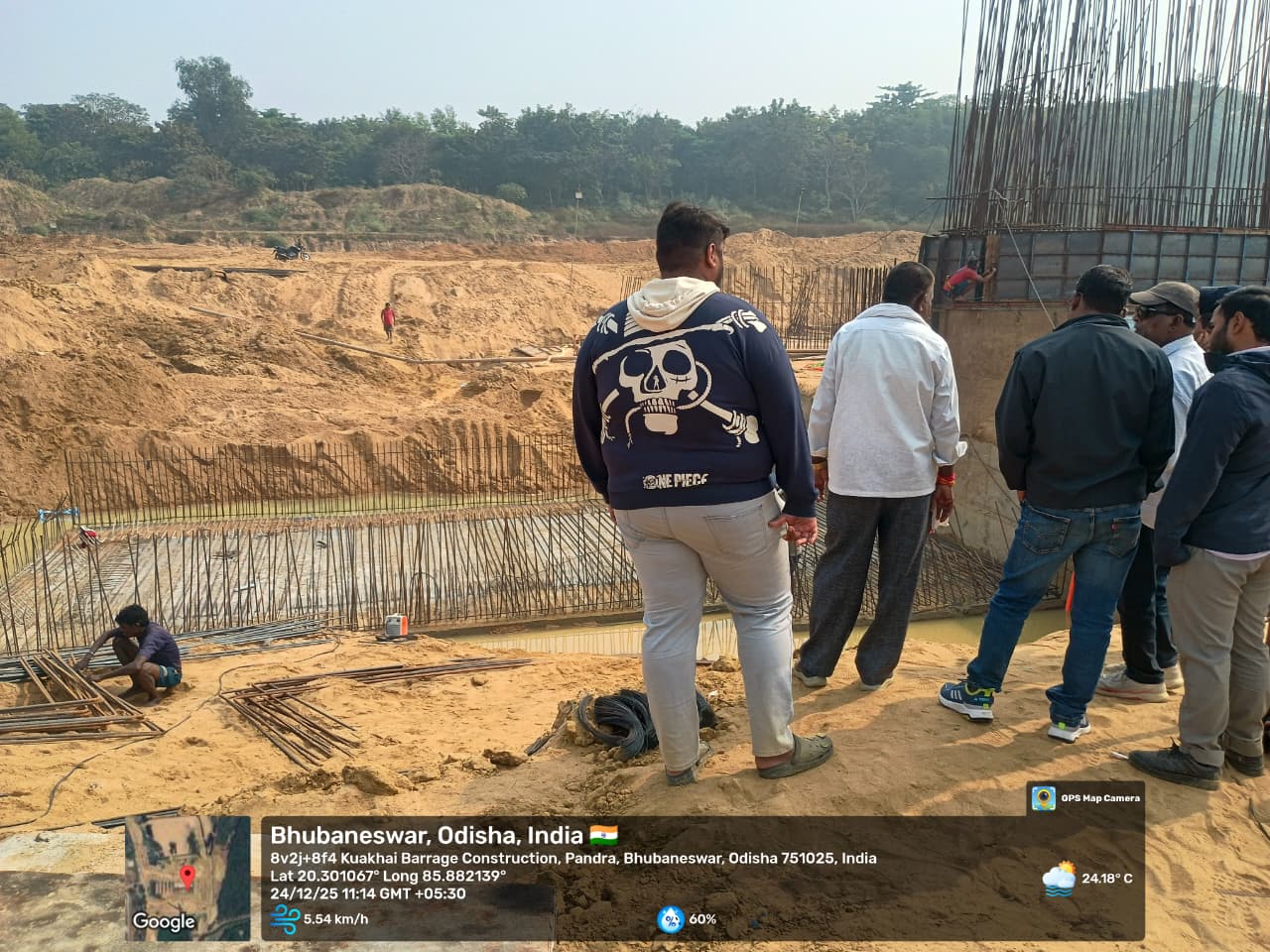

Water level RL 12.9m.
46/100

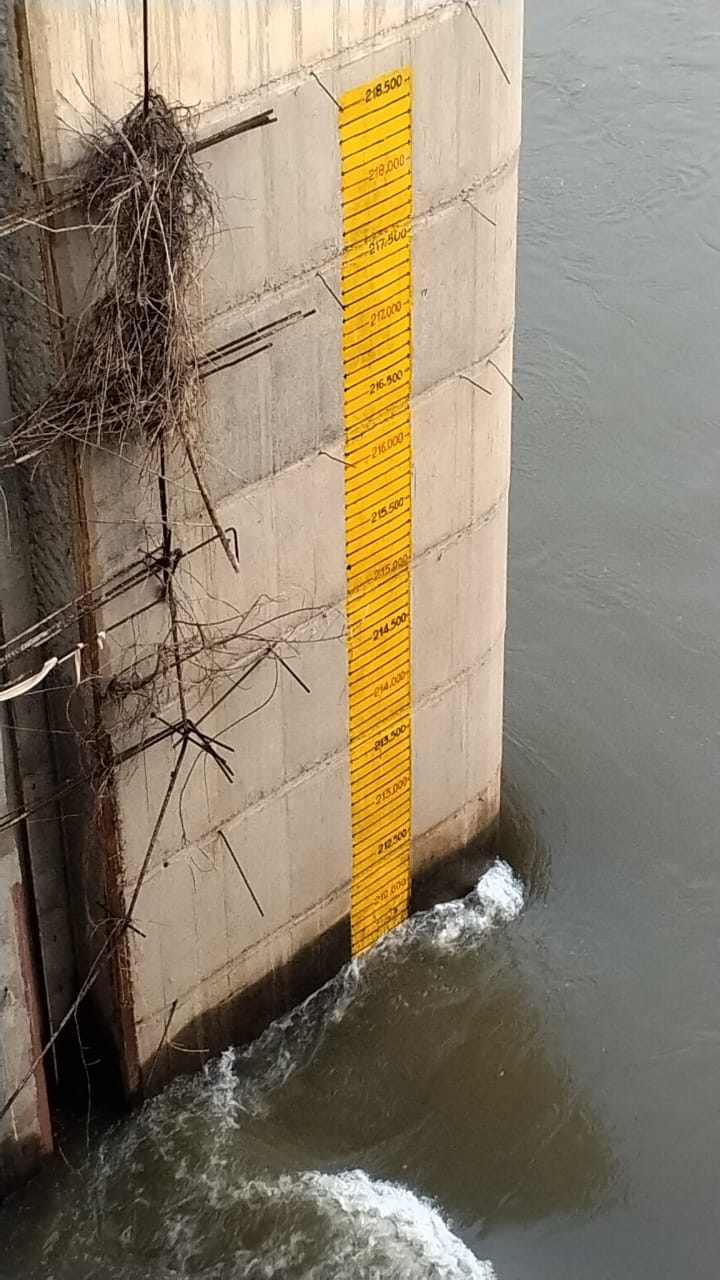

Instream Storage Structure, Kuakhai
Water level RL 13.6m.
47/100
Instream Storage Structure, Kuakhai
Water level RL 14.25m.

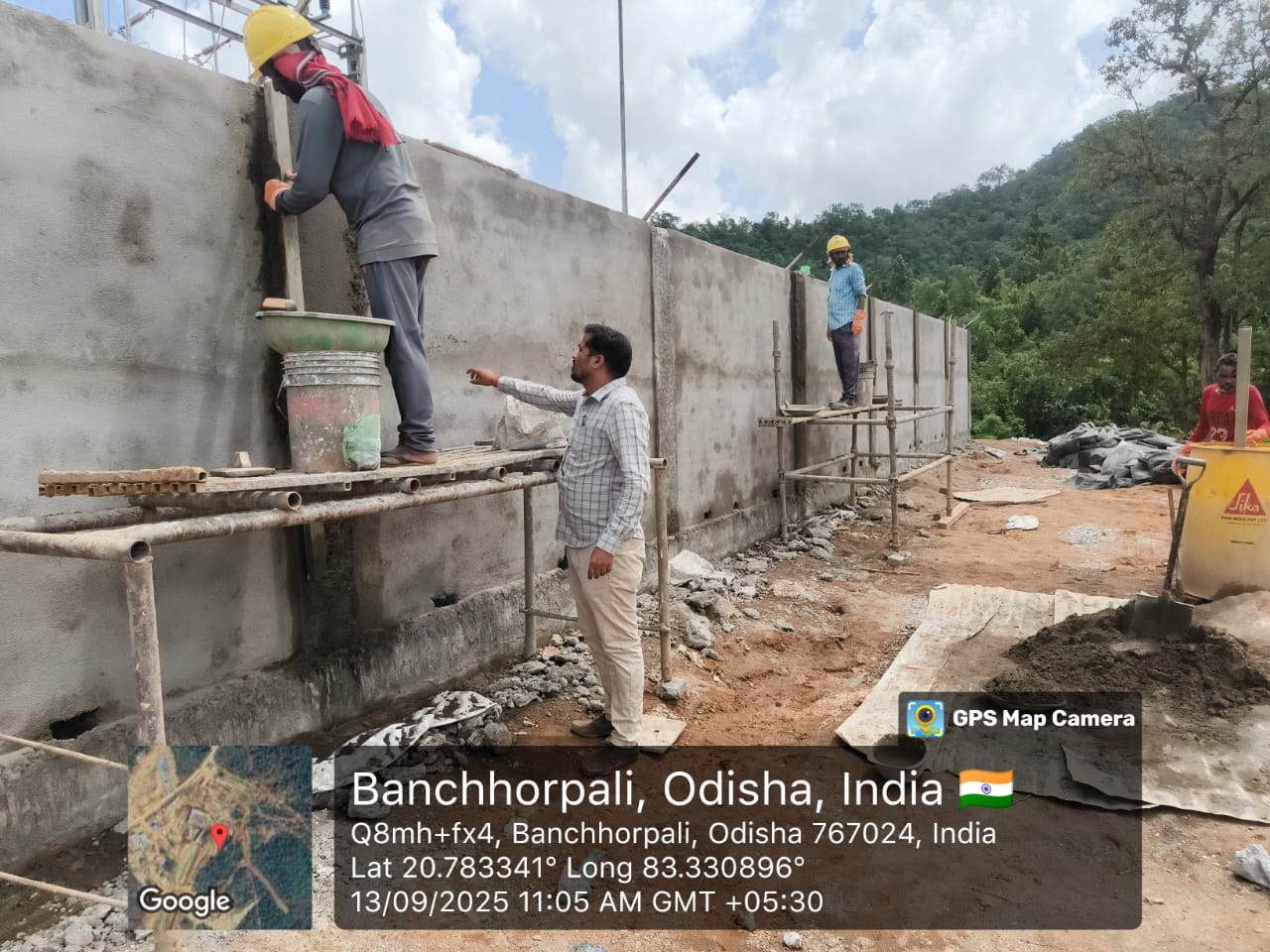

48/100

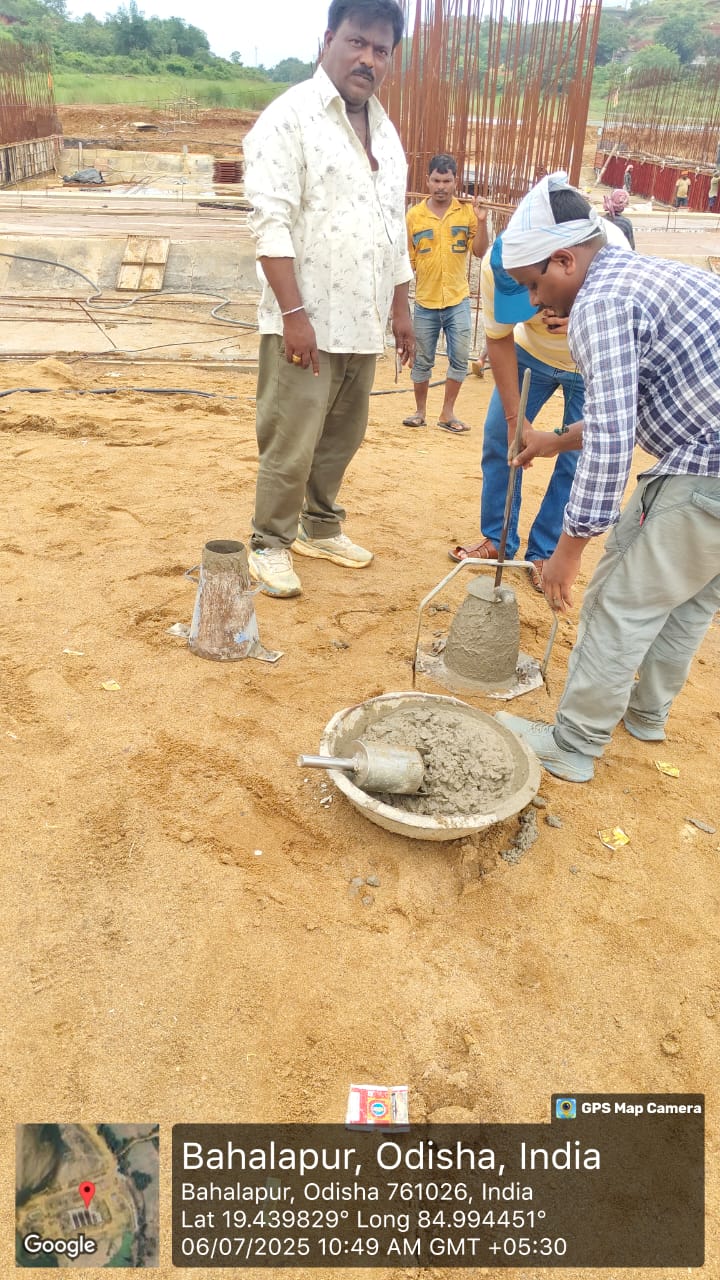

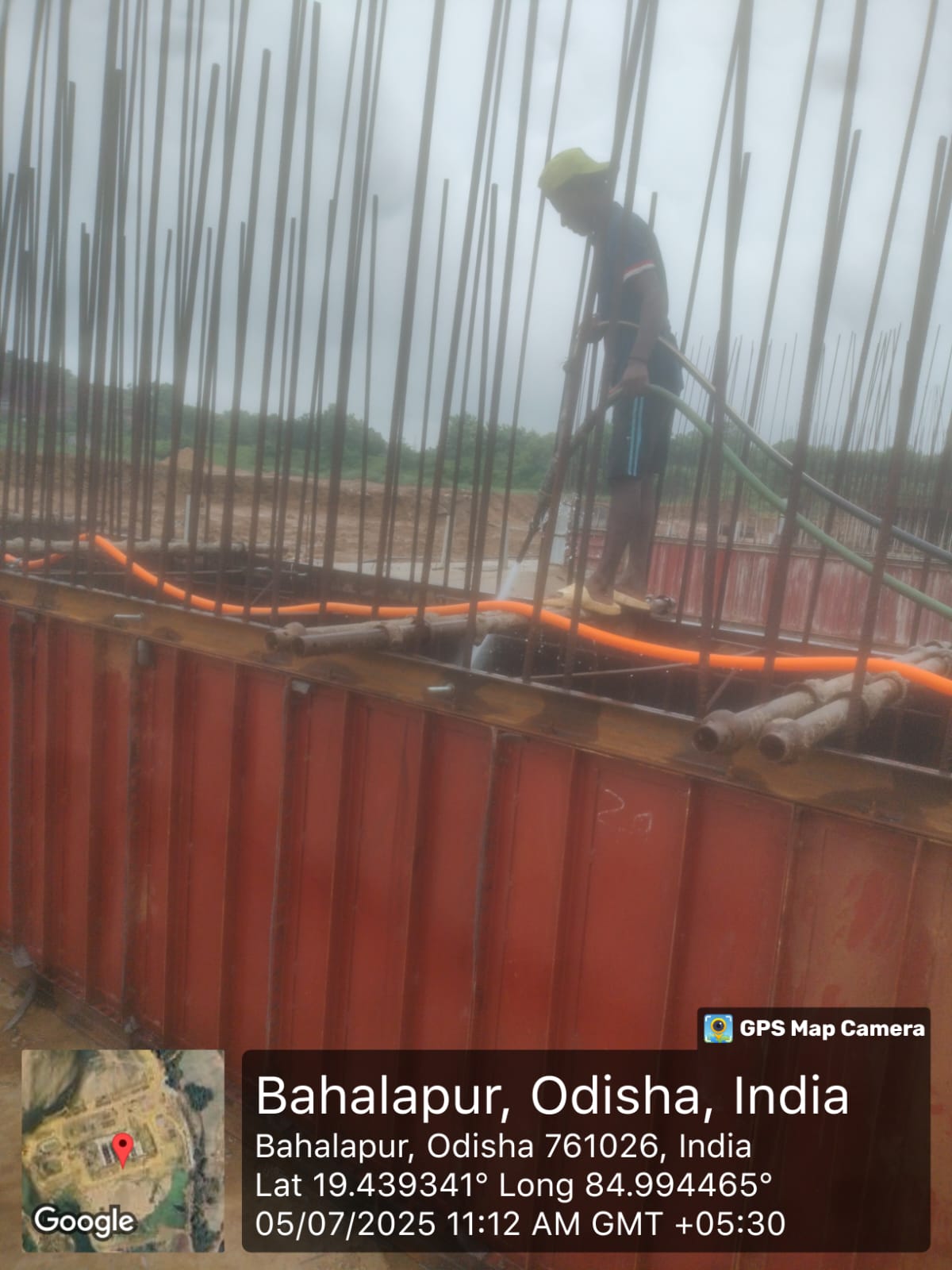

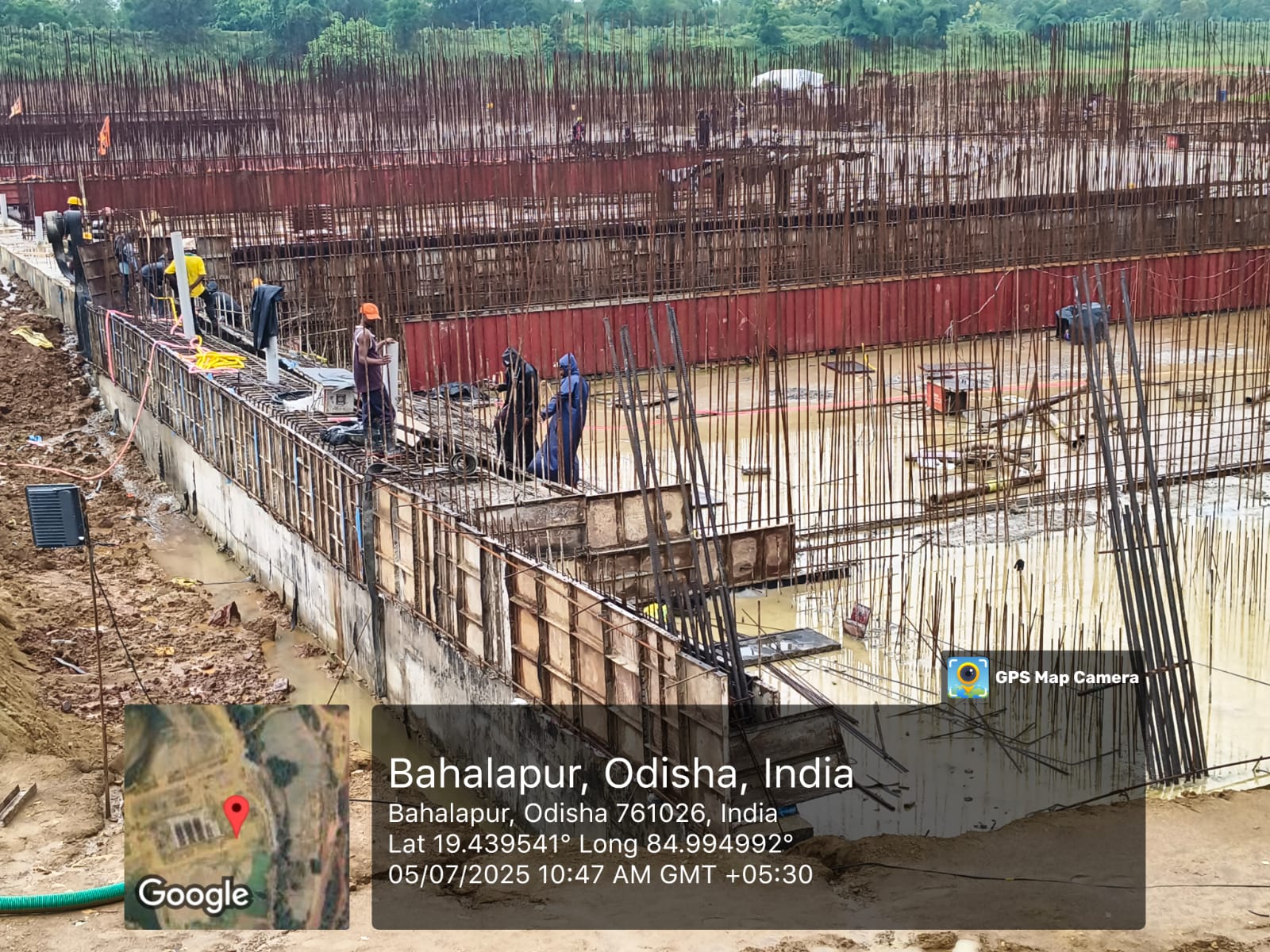

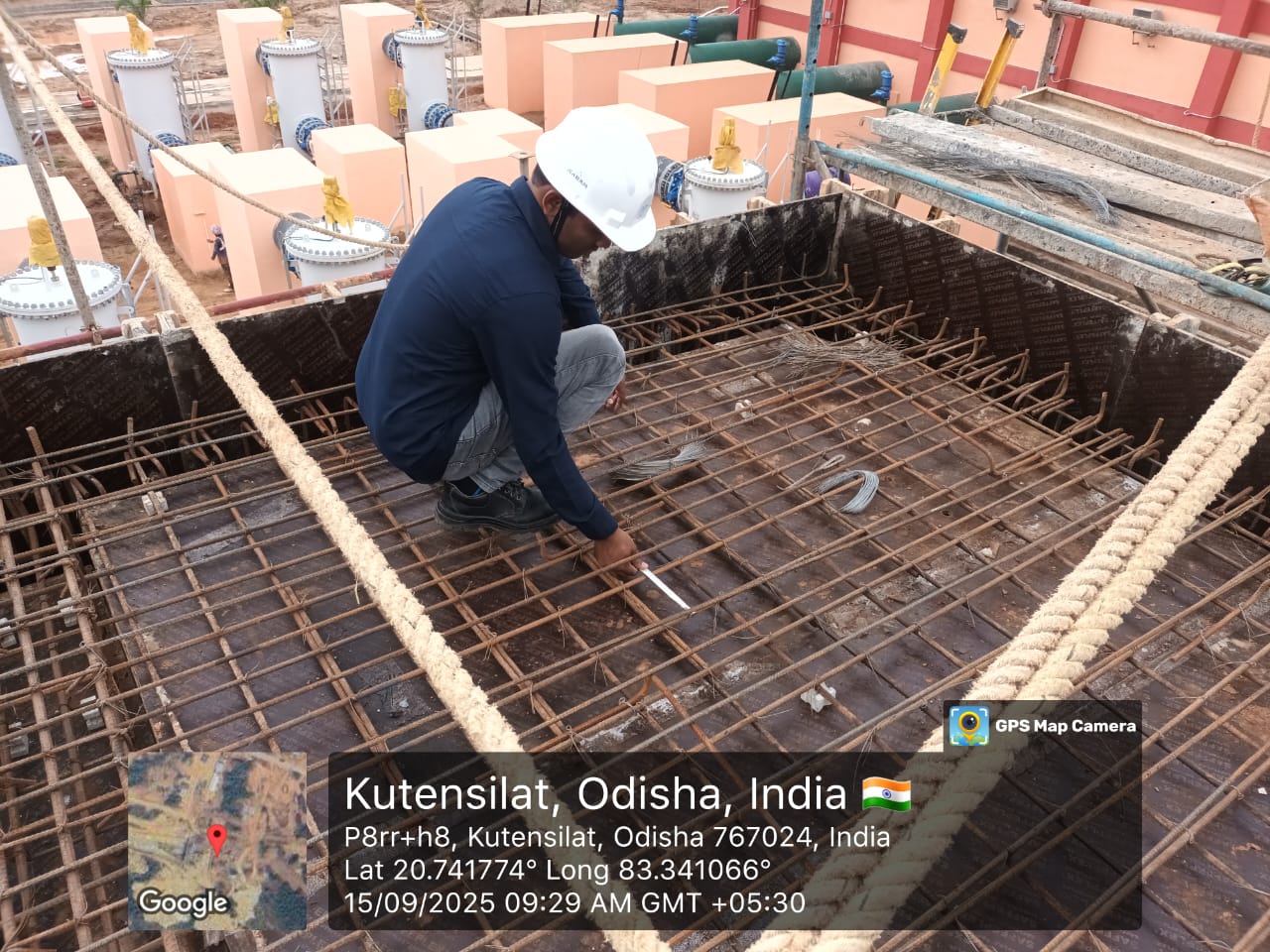

Instream Storage Structure, Kushabhadra

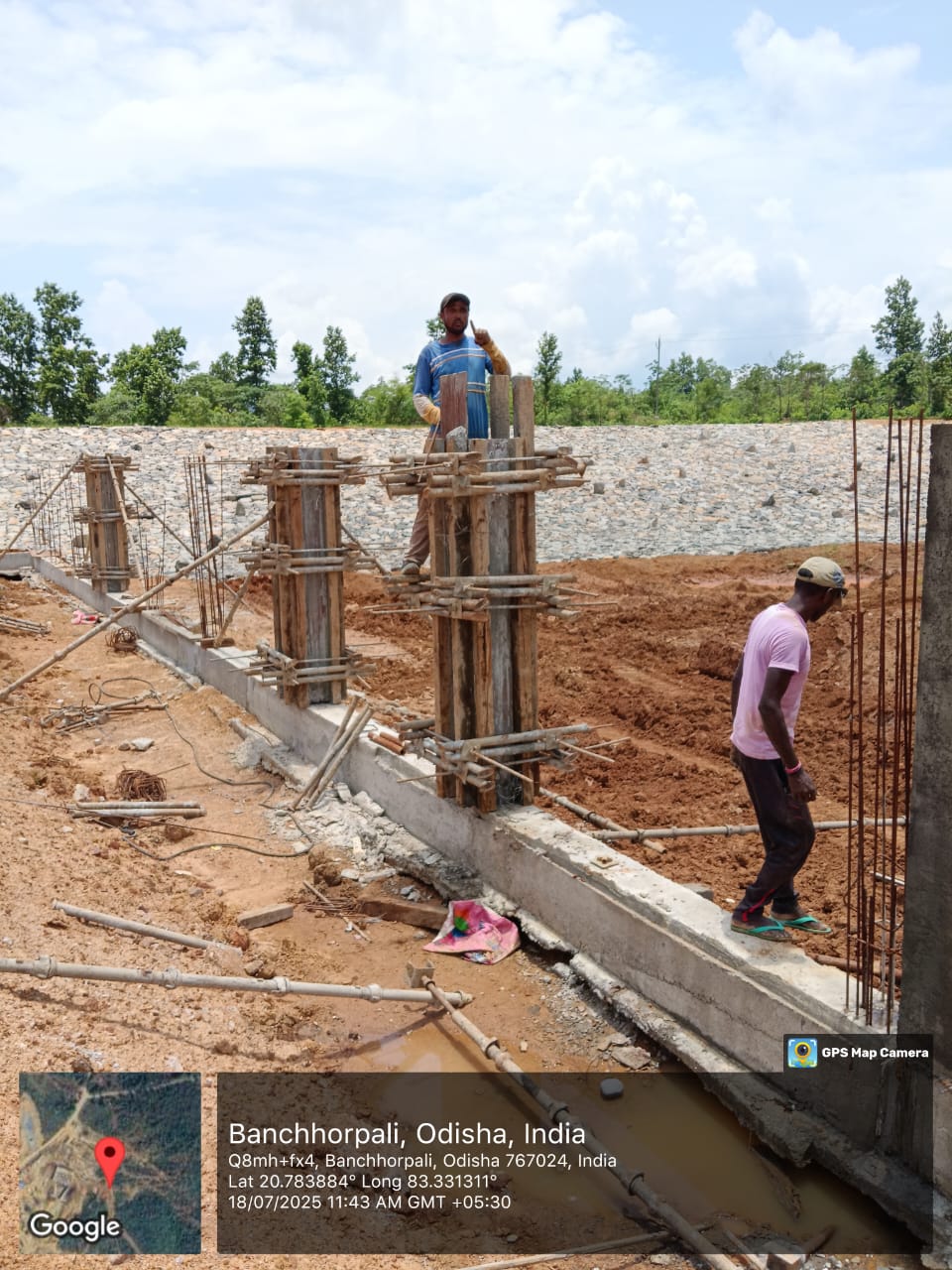

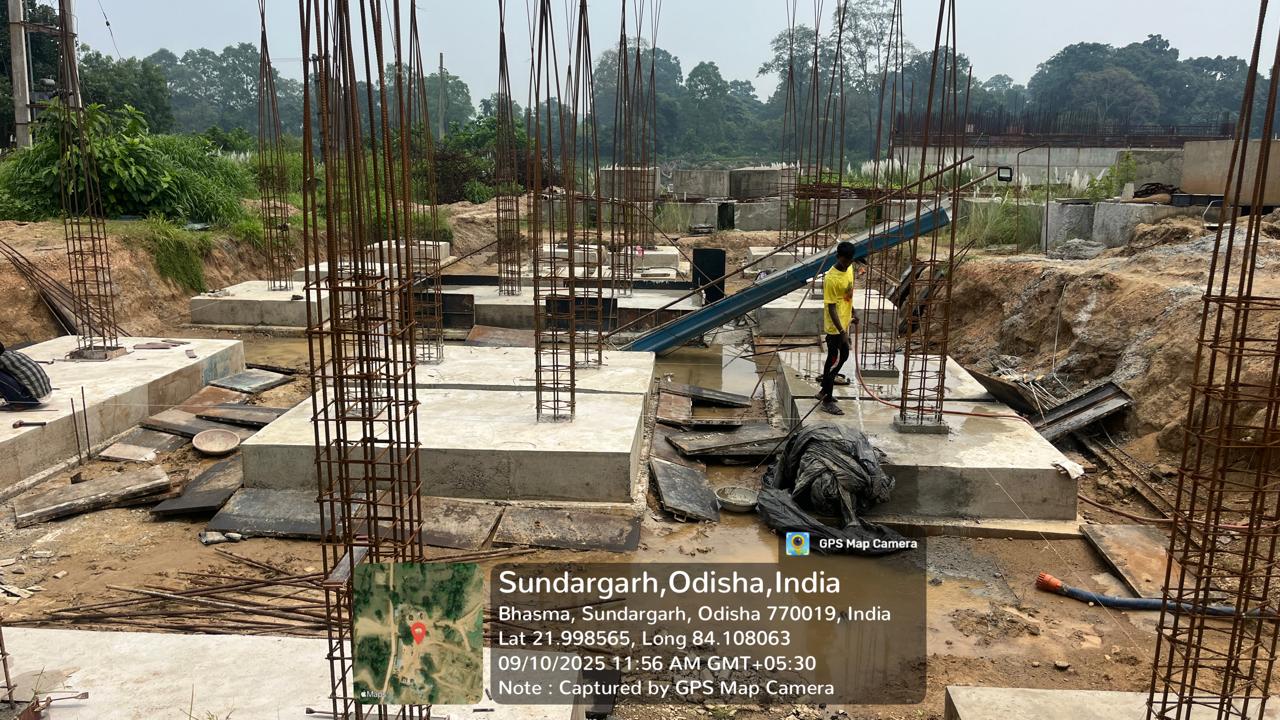

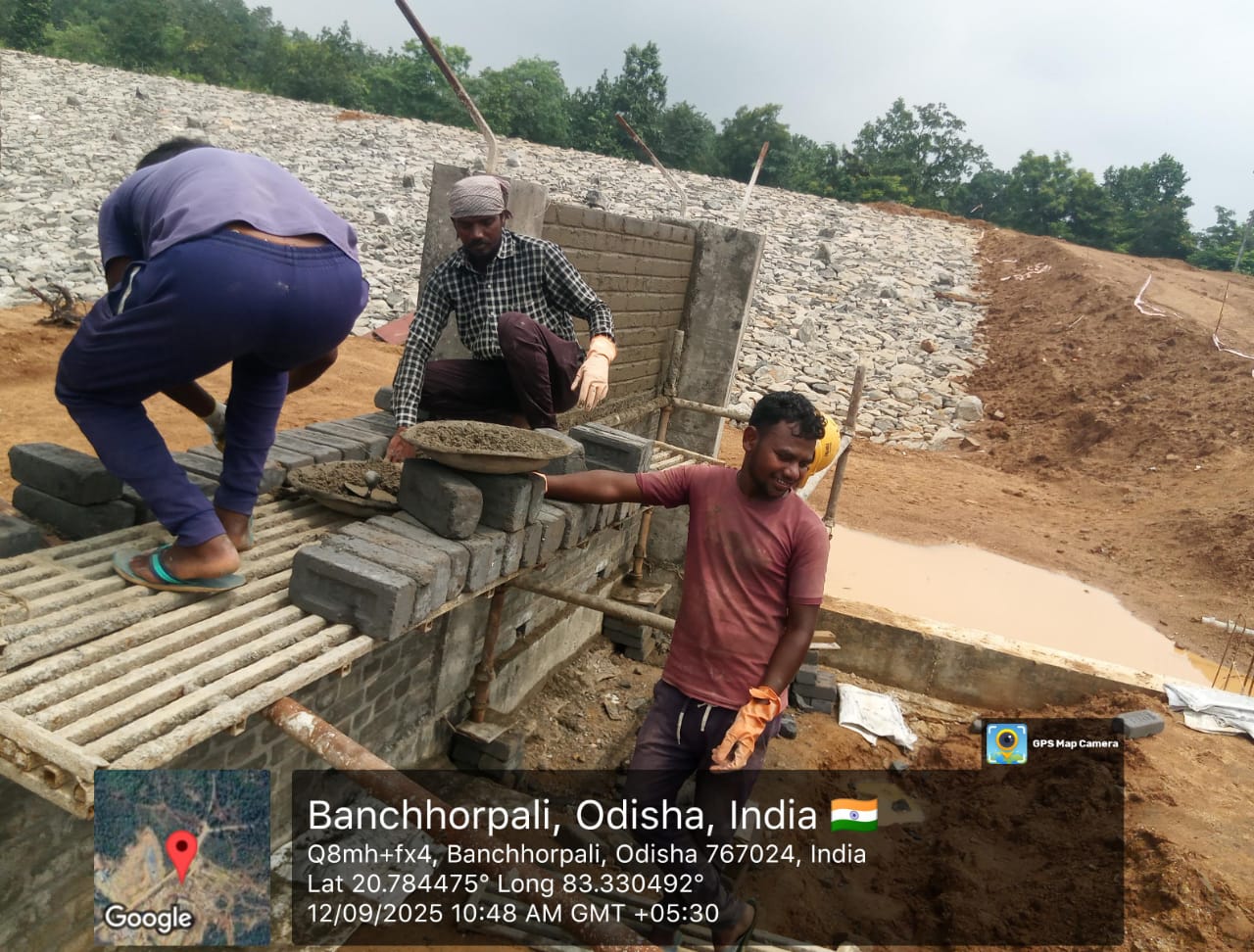

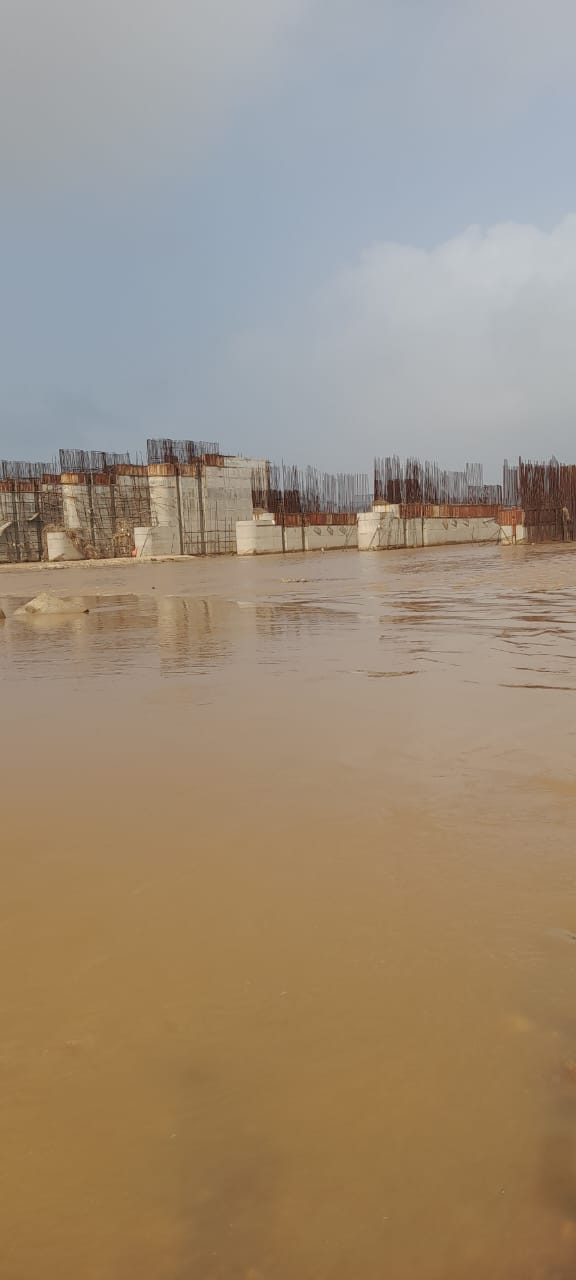

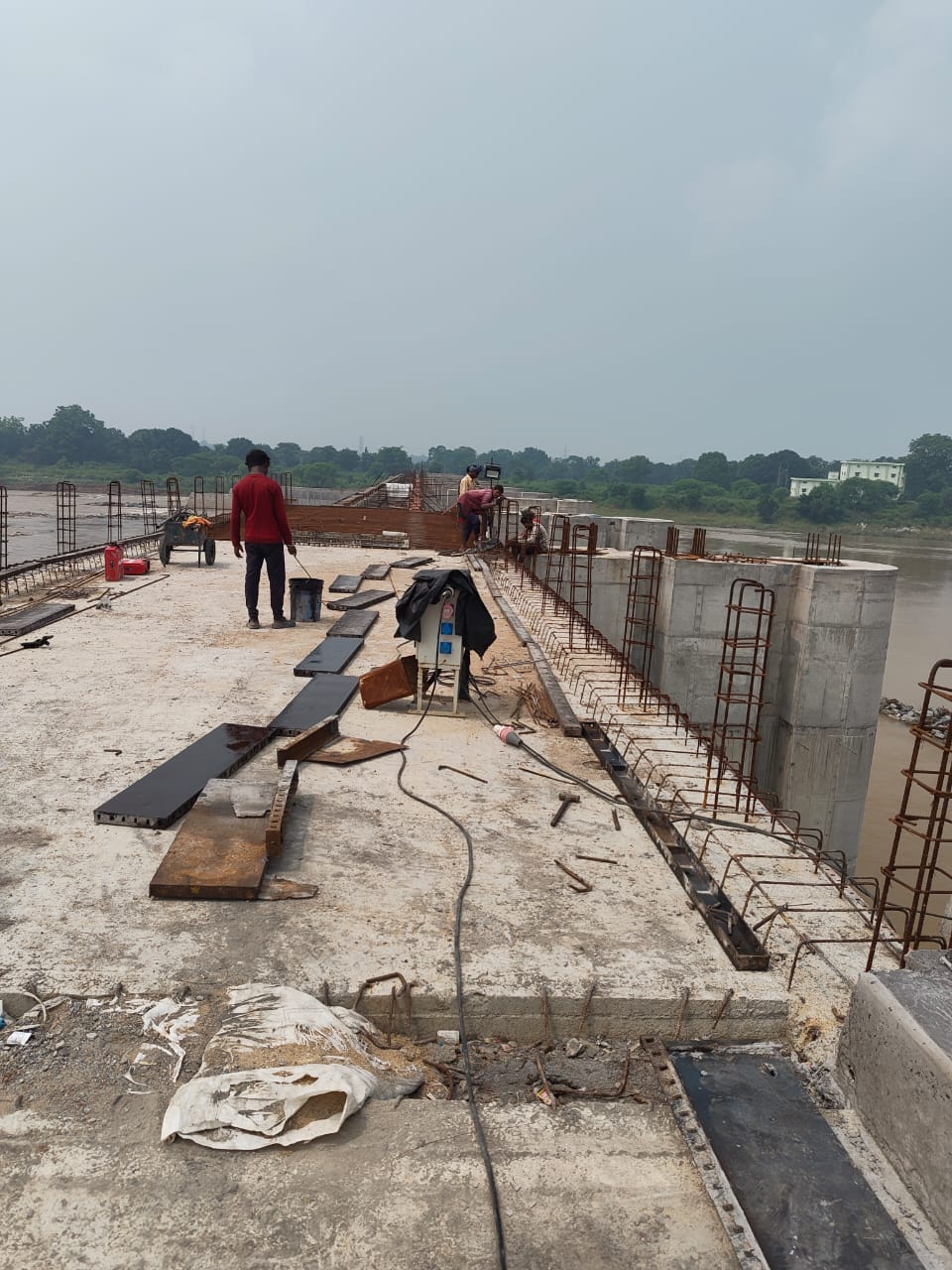

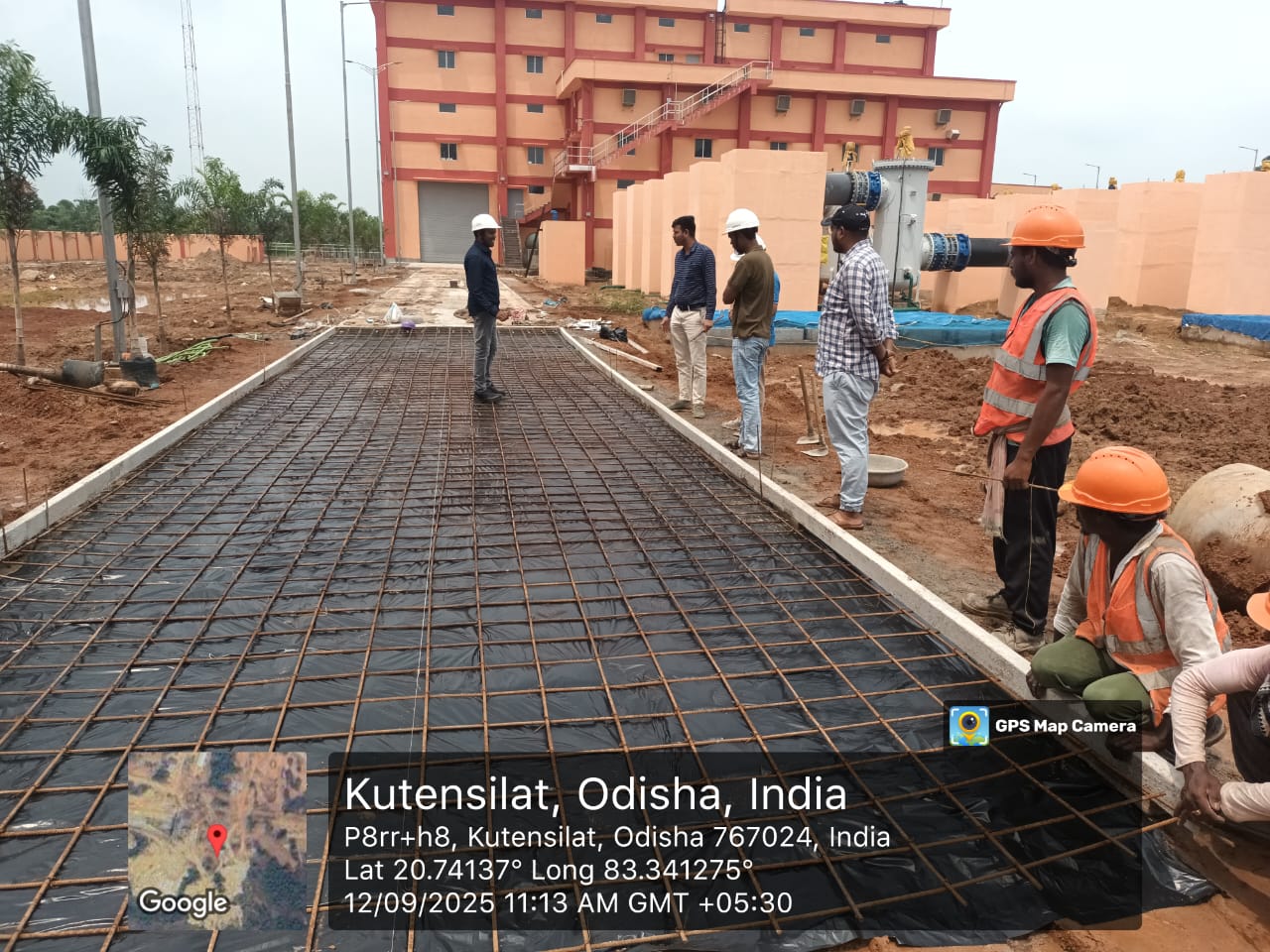

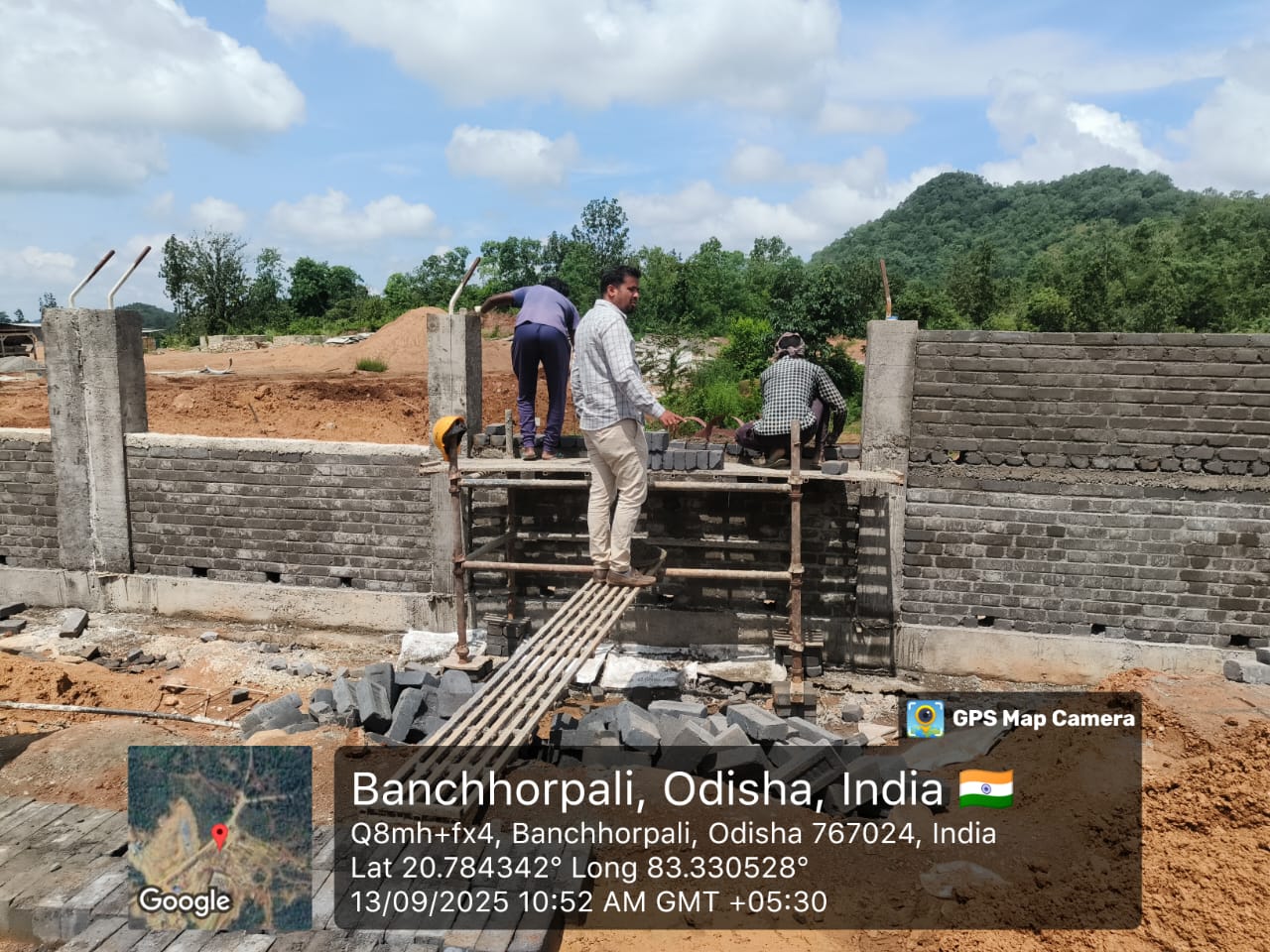

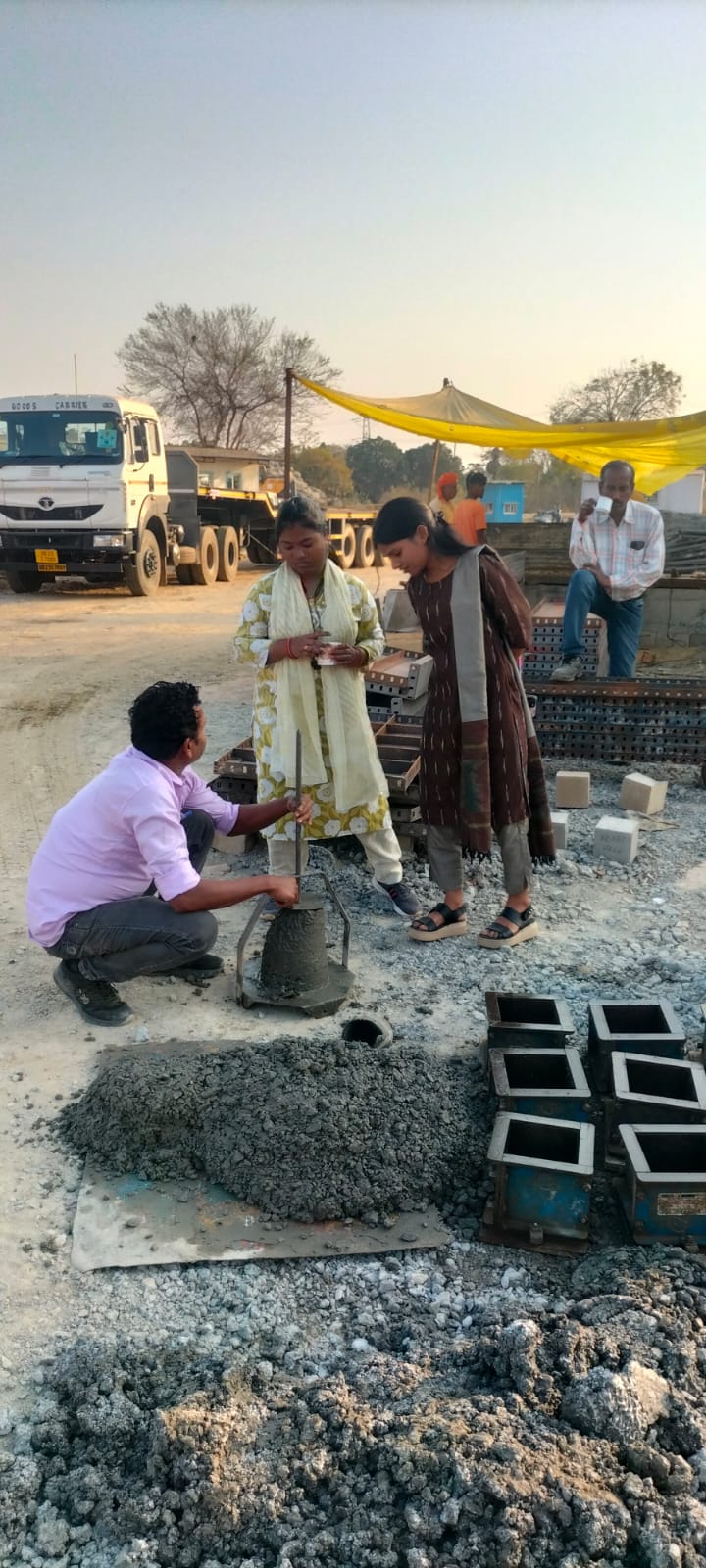

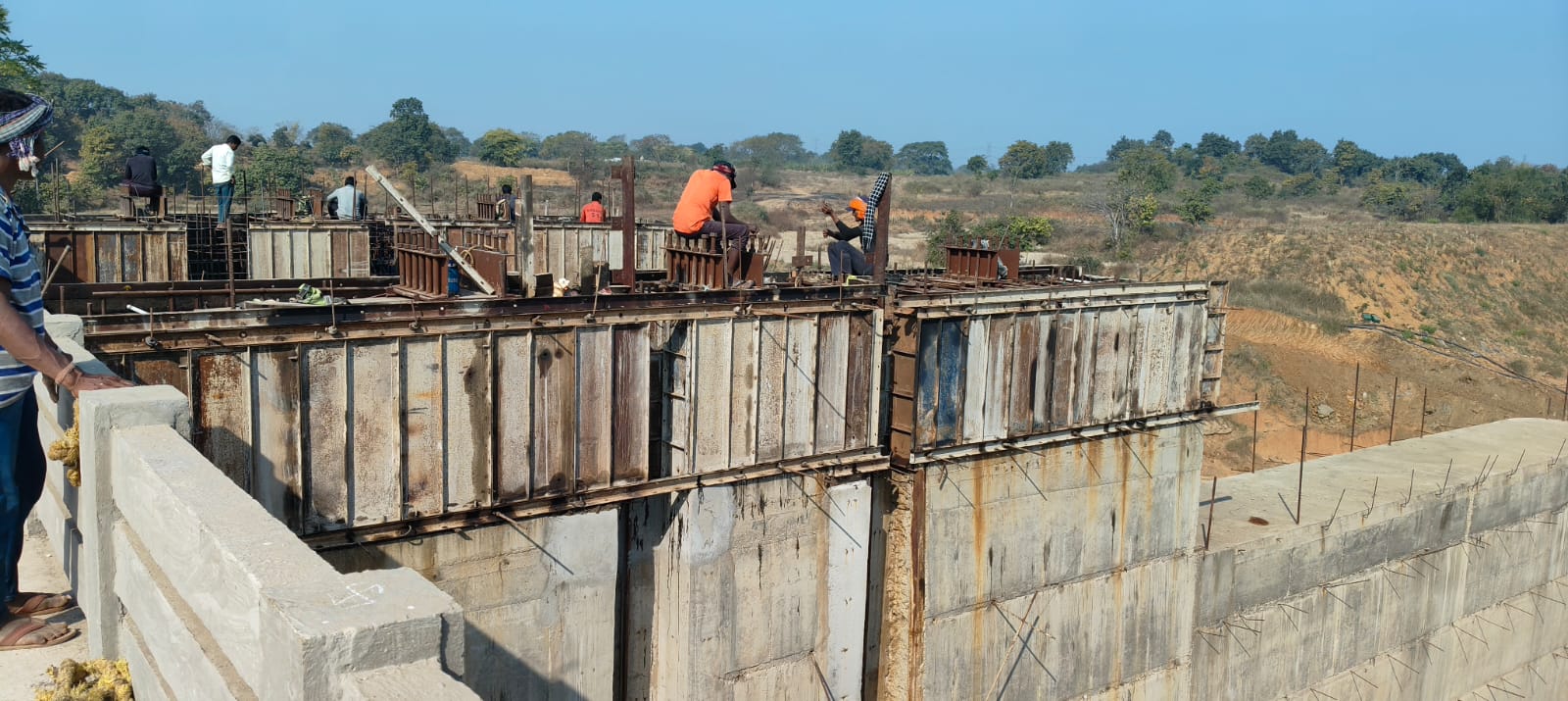

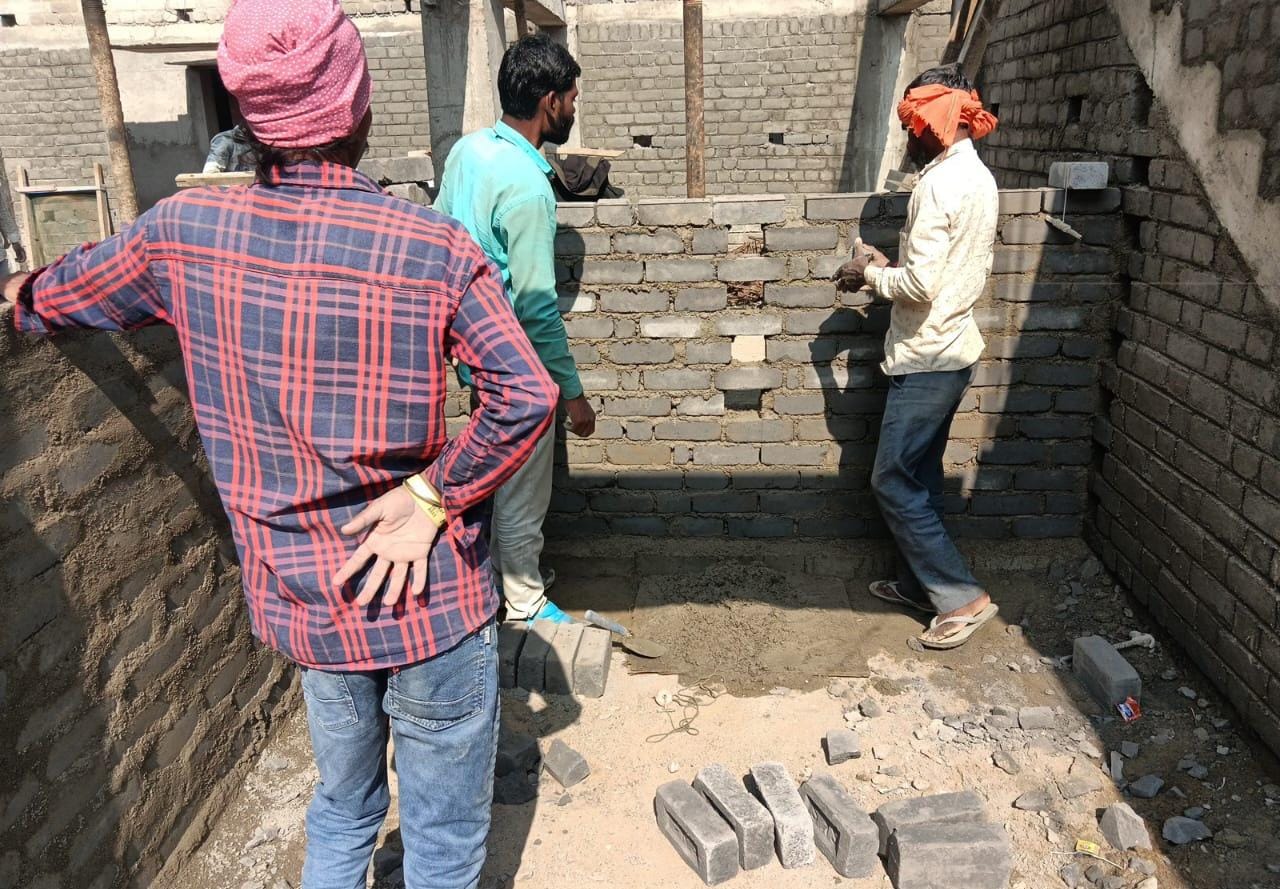

Brick masonry work is under progress in parapet of O&M building.
49/100

Instream Storage Structure, Kushabhadra

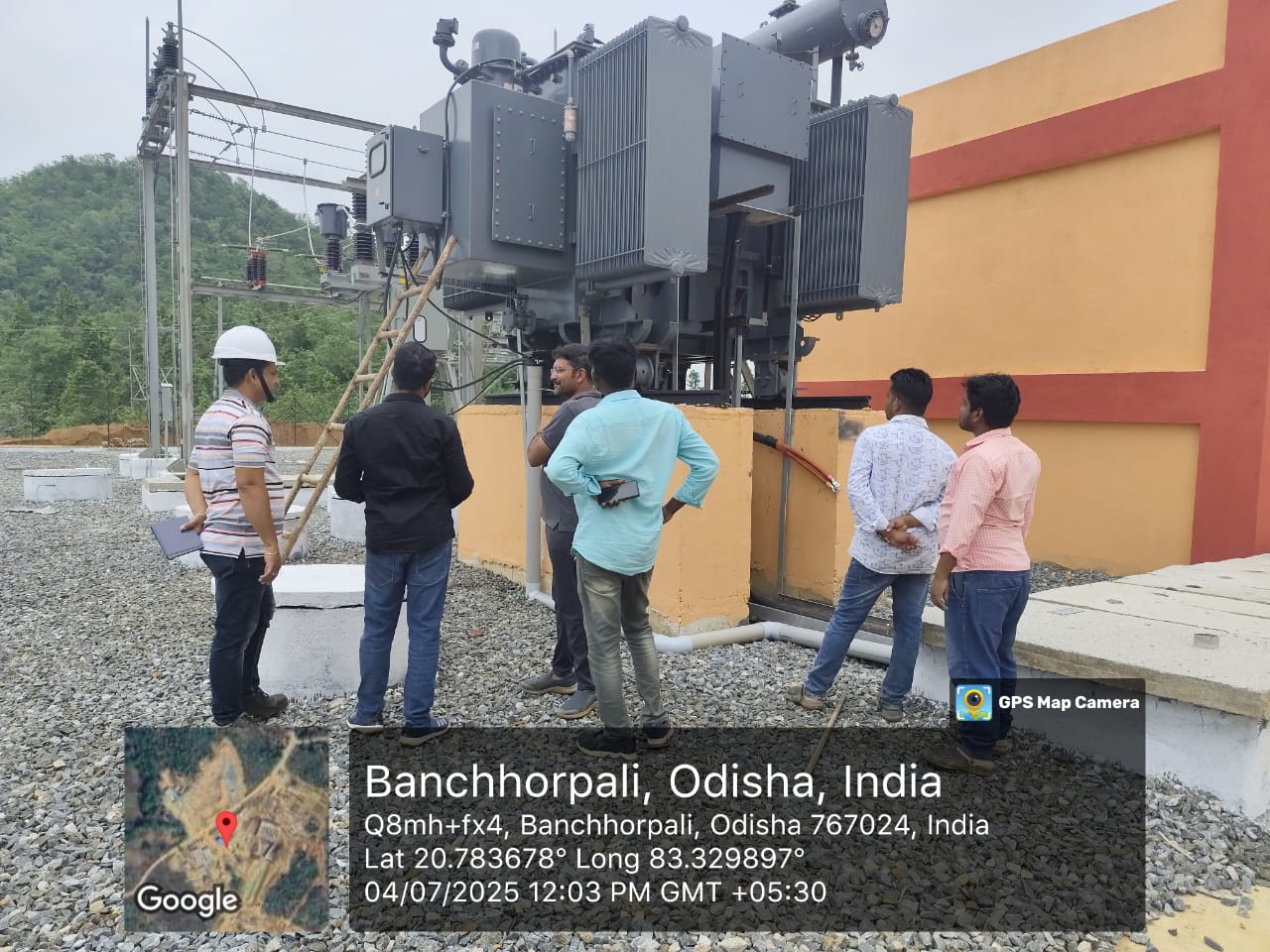

Inspection of gate works & other ancillary mechanical works by Hydro-Mechanical Expert with MKS Team & Agency at the worksite.
50/100
Instream Storage Structure, Kushabhadra

O&M Building parapet wall bricks work is under progress.
51/100
Instream Storage Structure, Kushabhadra

Canal road Clearing & grubbing work progress.
52/100

Instream Storage Structure, Kushabhadra
DTL & Team is Discussing with the Agency regarding completion of .head room, constn. of parapet, septic tank & soak pit etc.
53/100
Instream Storage Structure, Kushabhadra
Inspection of O&M building work by MKS Team along with the Agency at the ISS site.
54/100
Instream Storage Structure, Kushabhadra

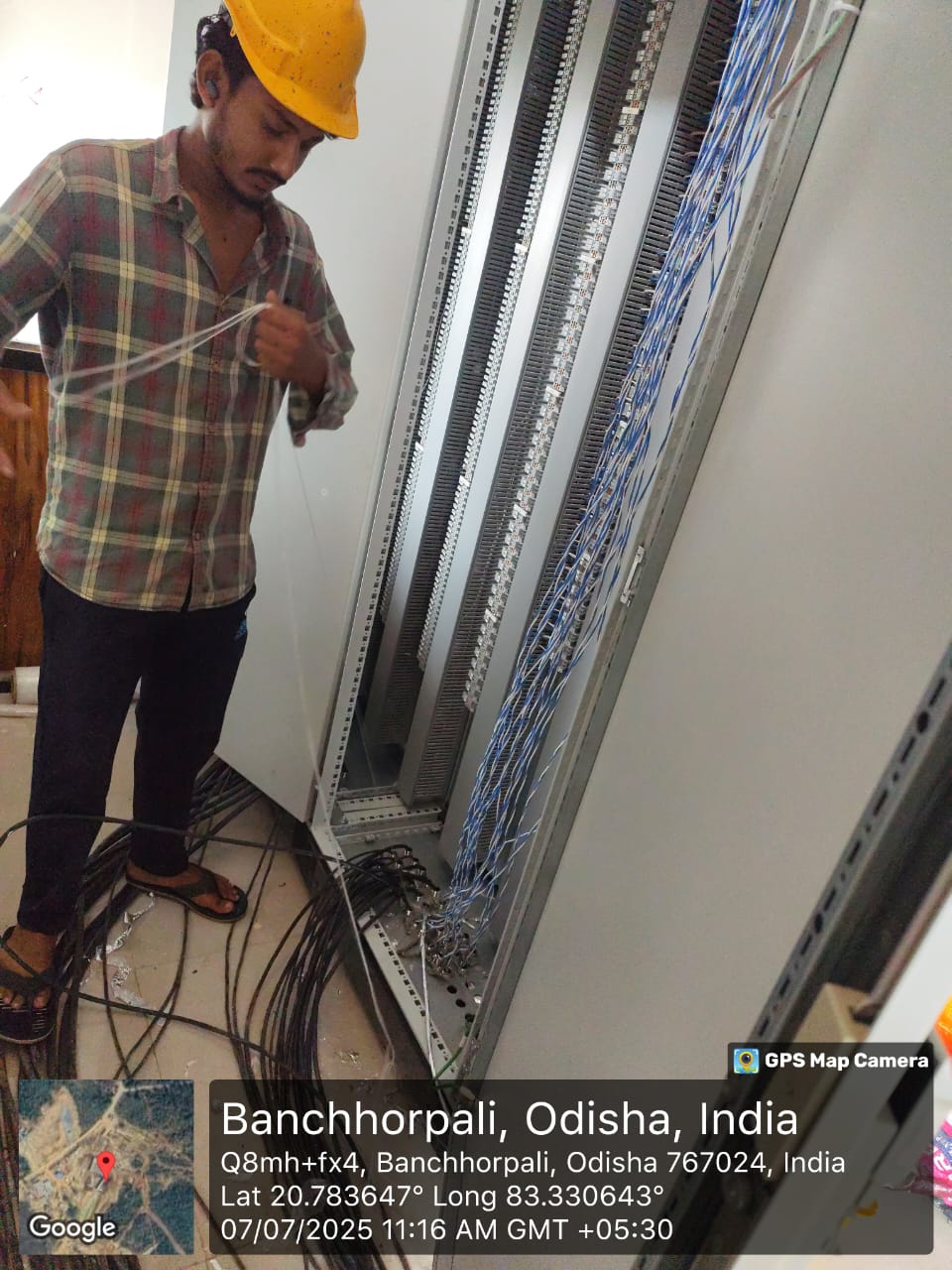

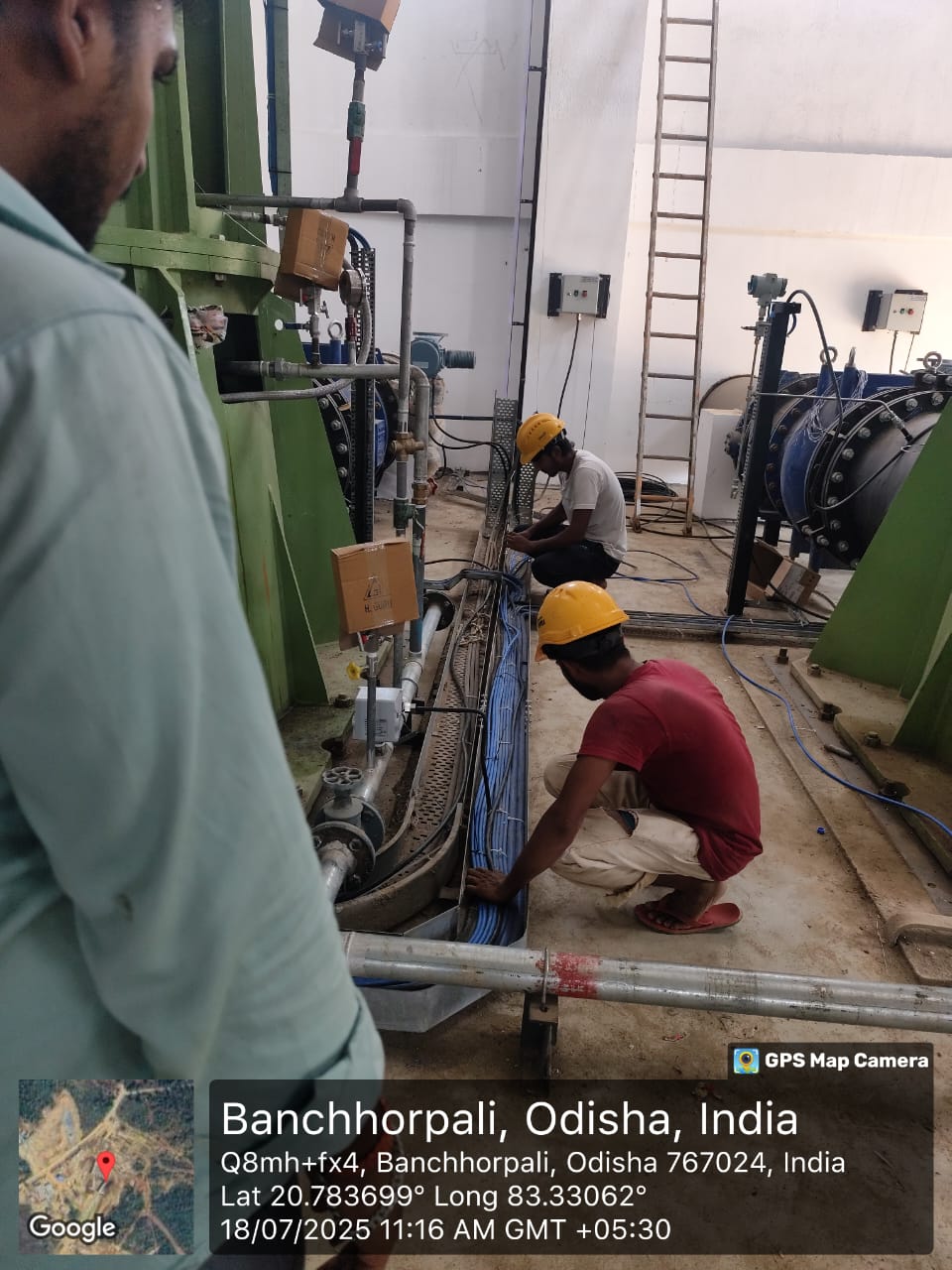

Cdu motor and gearbox installation work under progress.
55/100
Instream Storage Structure, Kushabhadra
Mechanical work center drive unit, motor, gearbox, ropeway, installation work is in progress.
56/100
Instream Storage Structure, Kushabhadra
Canal road Clearing & grubbing work progress.
57/100
Instream Storage Structure, Kushabhadra
O&M Building ground floor electrical chasing / chipping work inside the building is under progress.
58/100
Instream Storage Structure, Kushabhadra

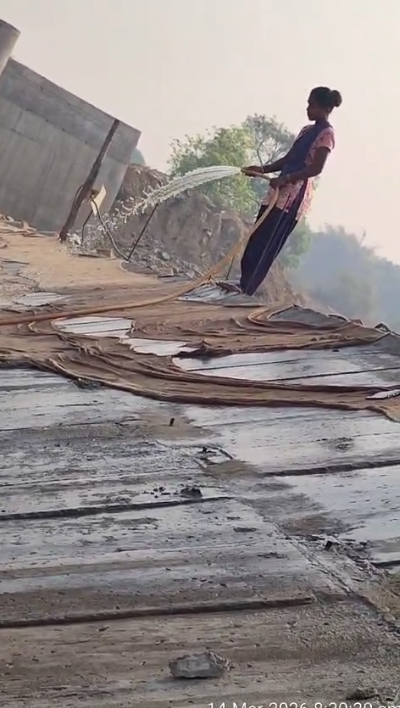

Curing work going on.
59/100
Instream Storage Structure, Kushabhadra
O&M Building 1st floor brick work is under progress.

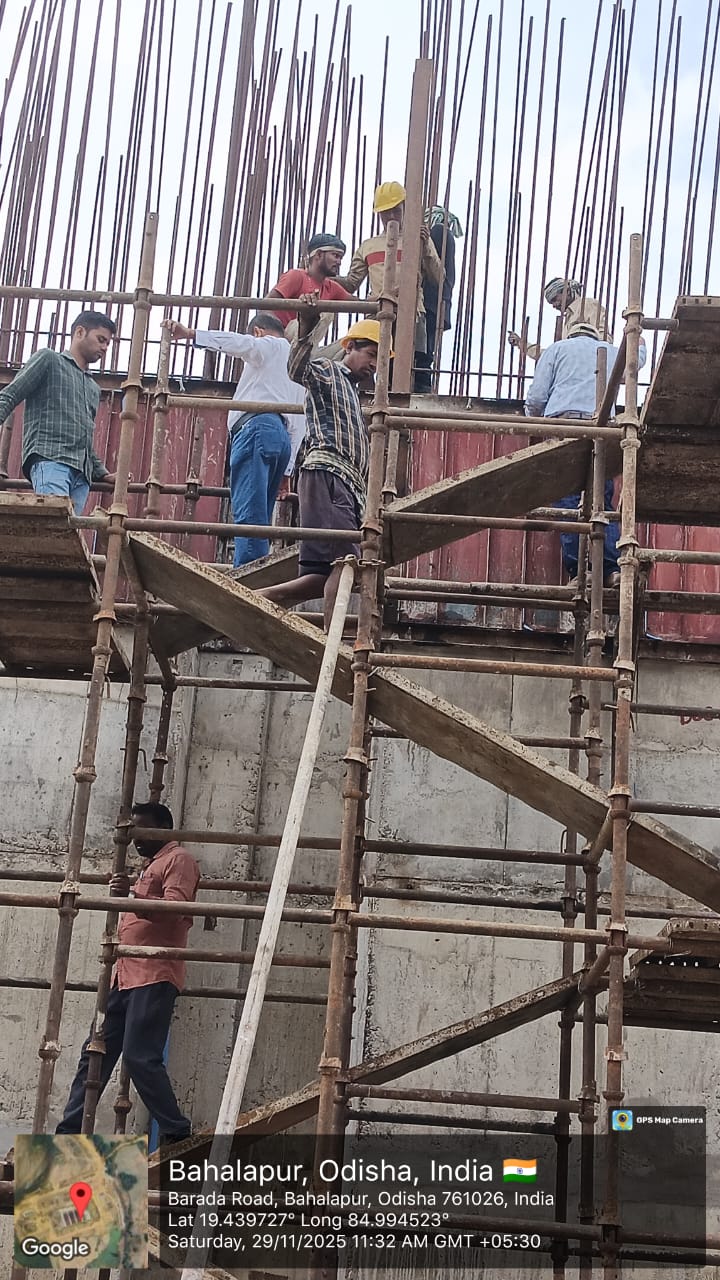

60/100
Instream Storage Structure, Kushabhadra
Canal road cleaning work is under progress.
61/100
Instream Storage Structure, Kushabhadra
Inspection of O&M building construction work by DTL & Team.
62/100
Instream Storage Structure, Kushabhadra
O&M Building 1st floor Lintel beam Beam with sunshade shuttering work is under progress.
63/100
Instream Storage Structure, Kushabhadra
Flood water level RL 12.70m.
64/100
Instream Storage Structure, Kushabhadra
Flood water level RL 13.10m.
65/100
Instream Storage Structure, Kushabhadra

O&M Building 1st floor brick work is under progress.
66/100

UGPL, Left Lower Suktel Canal Division

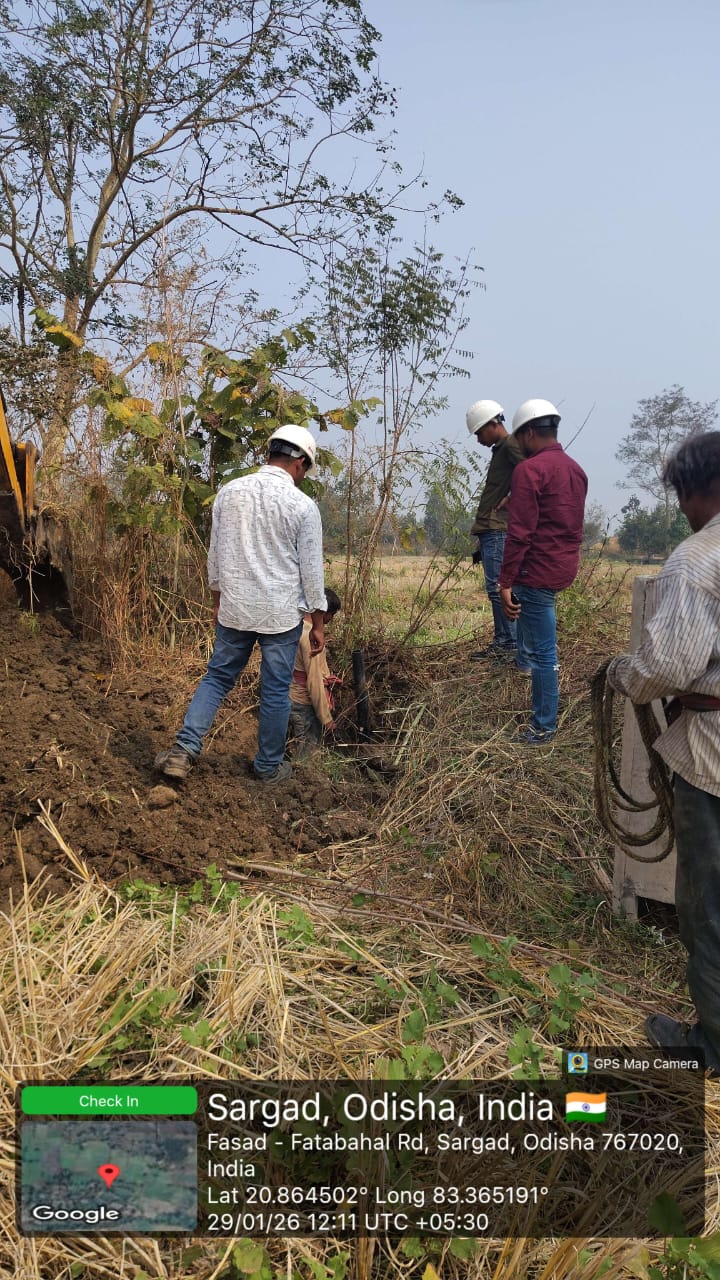

Tree plantation by CCE, SE, Dam division SE, Canal Division No.-I SE, RR division SE, SDO of DoWR, TLs of (PES & PSS) and MEIL Project manager at Left Command Pump House LSIP.

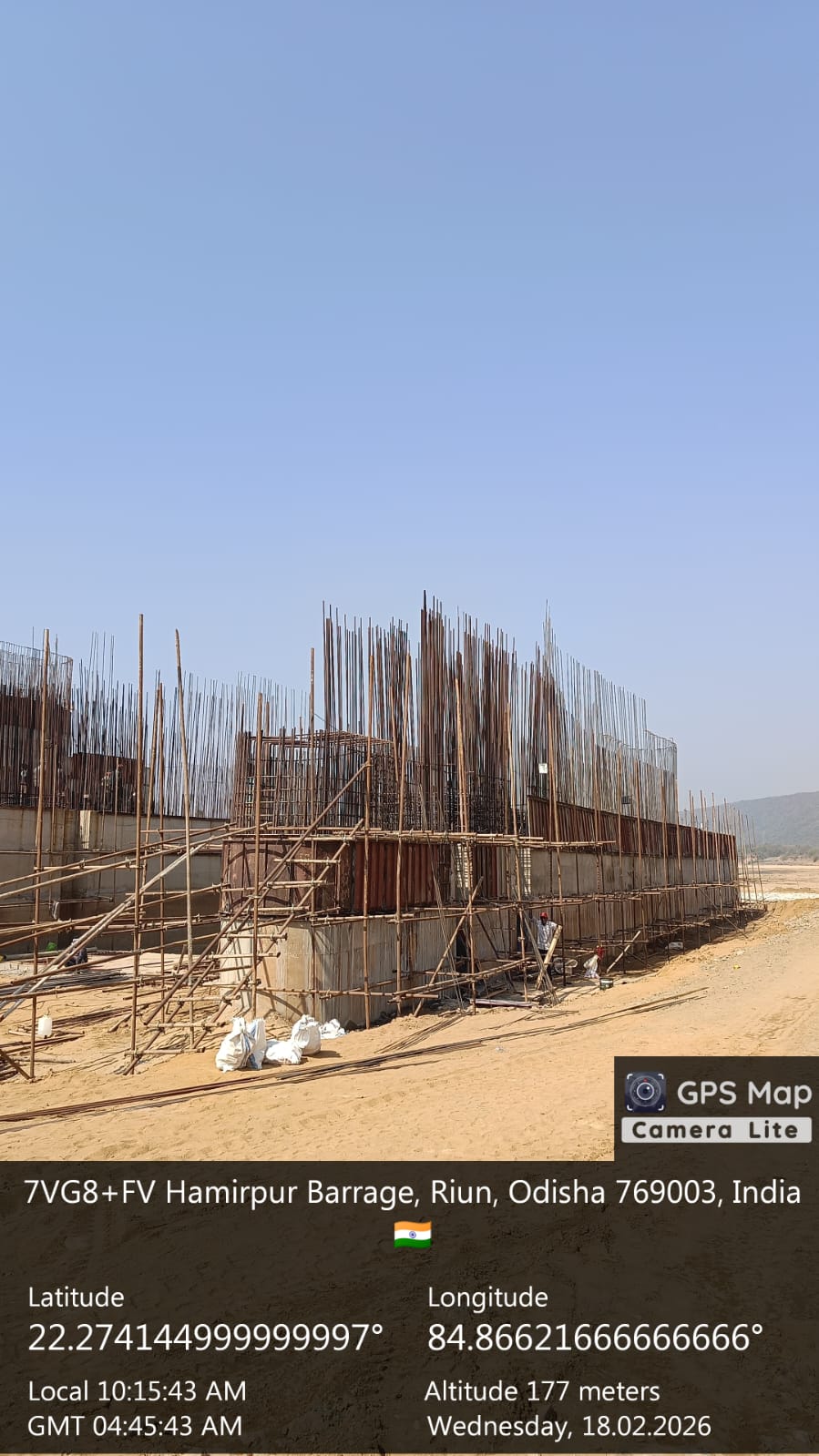

67/100

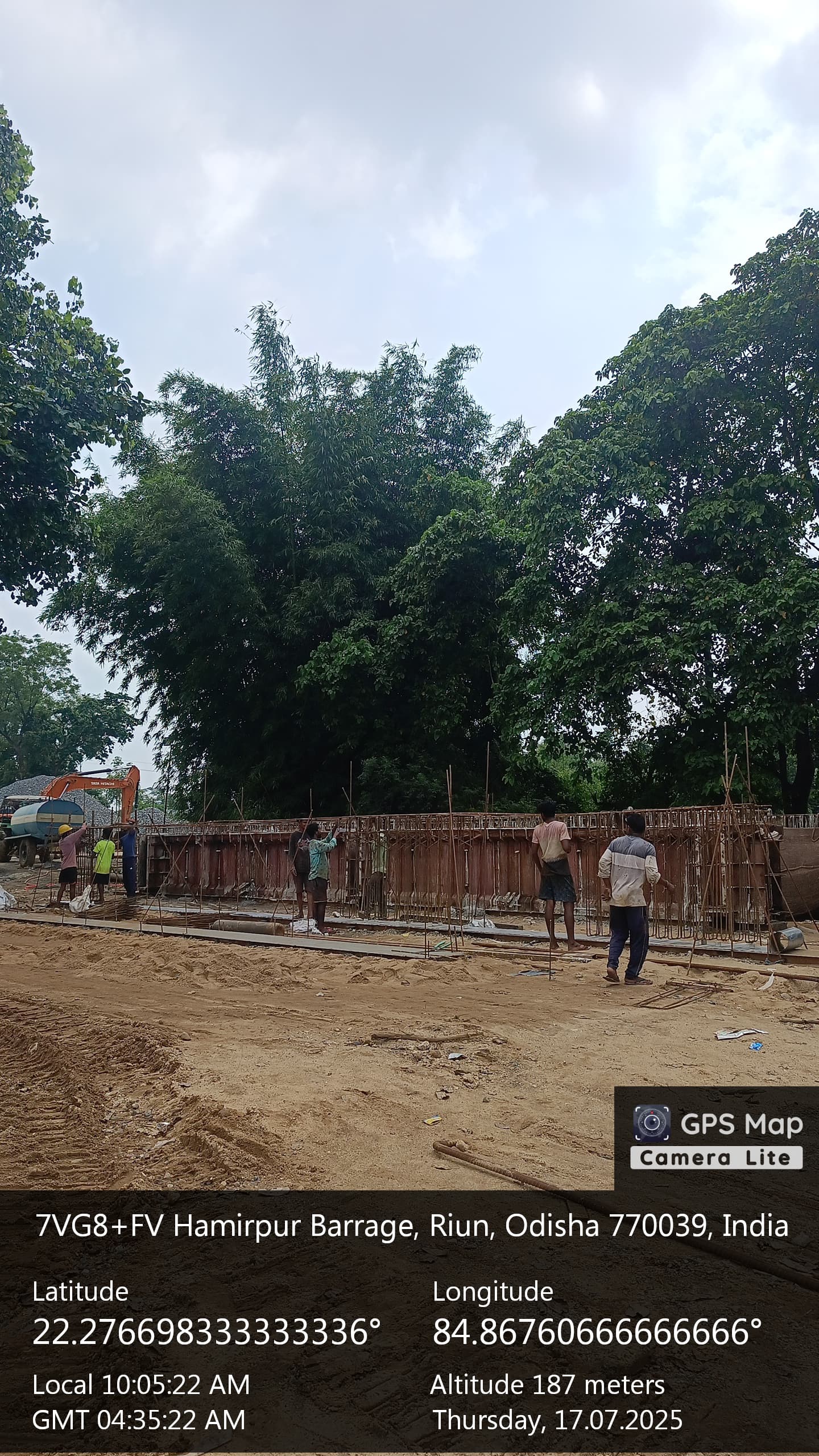

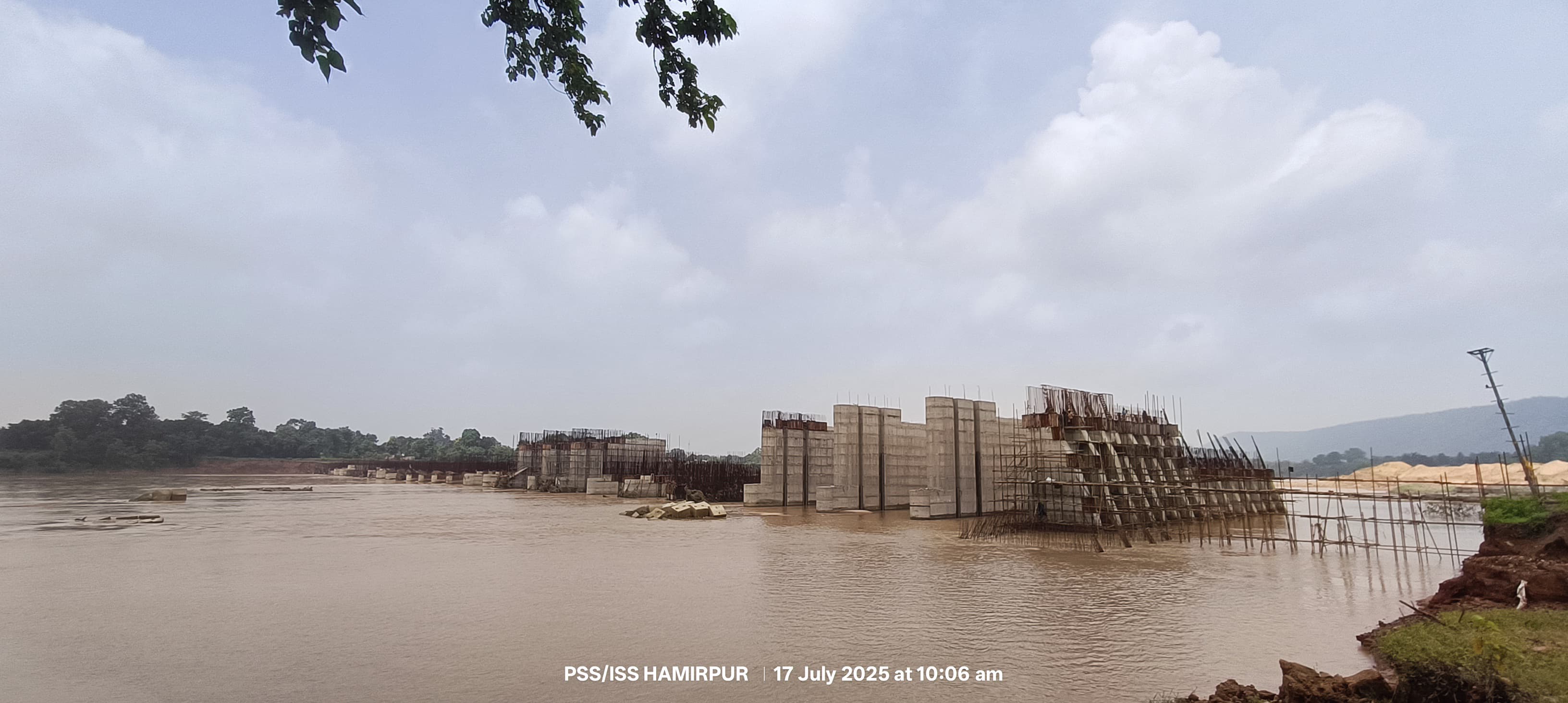

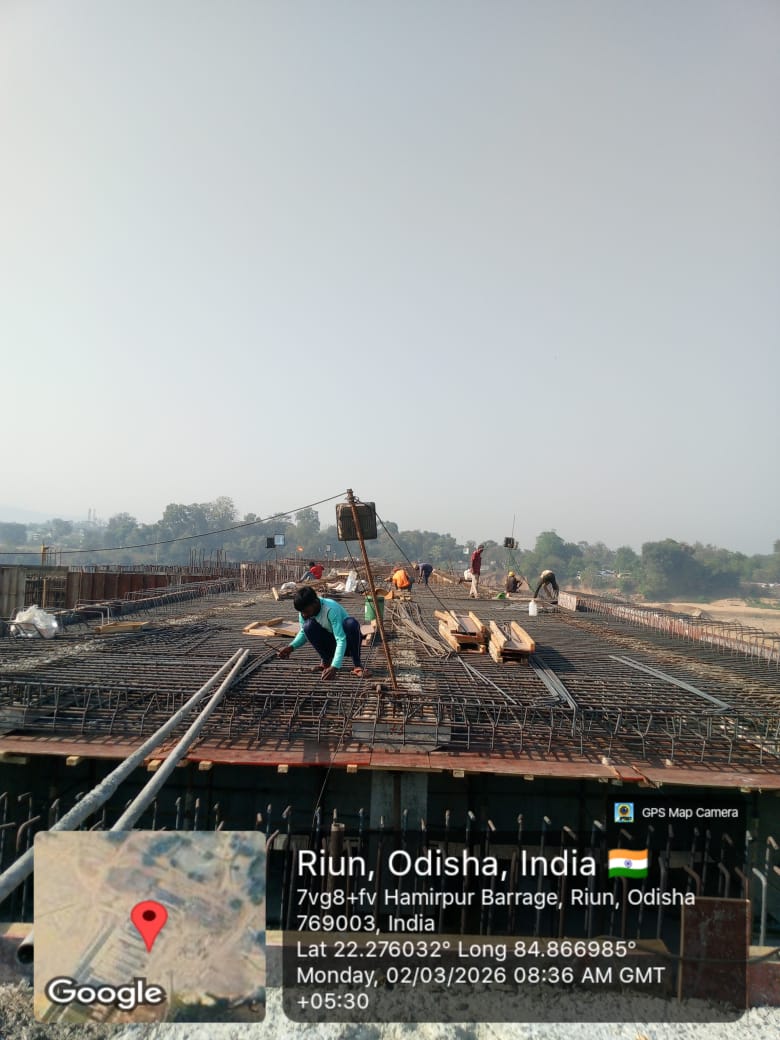

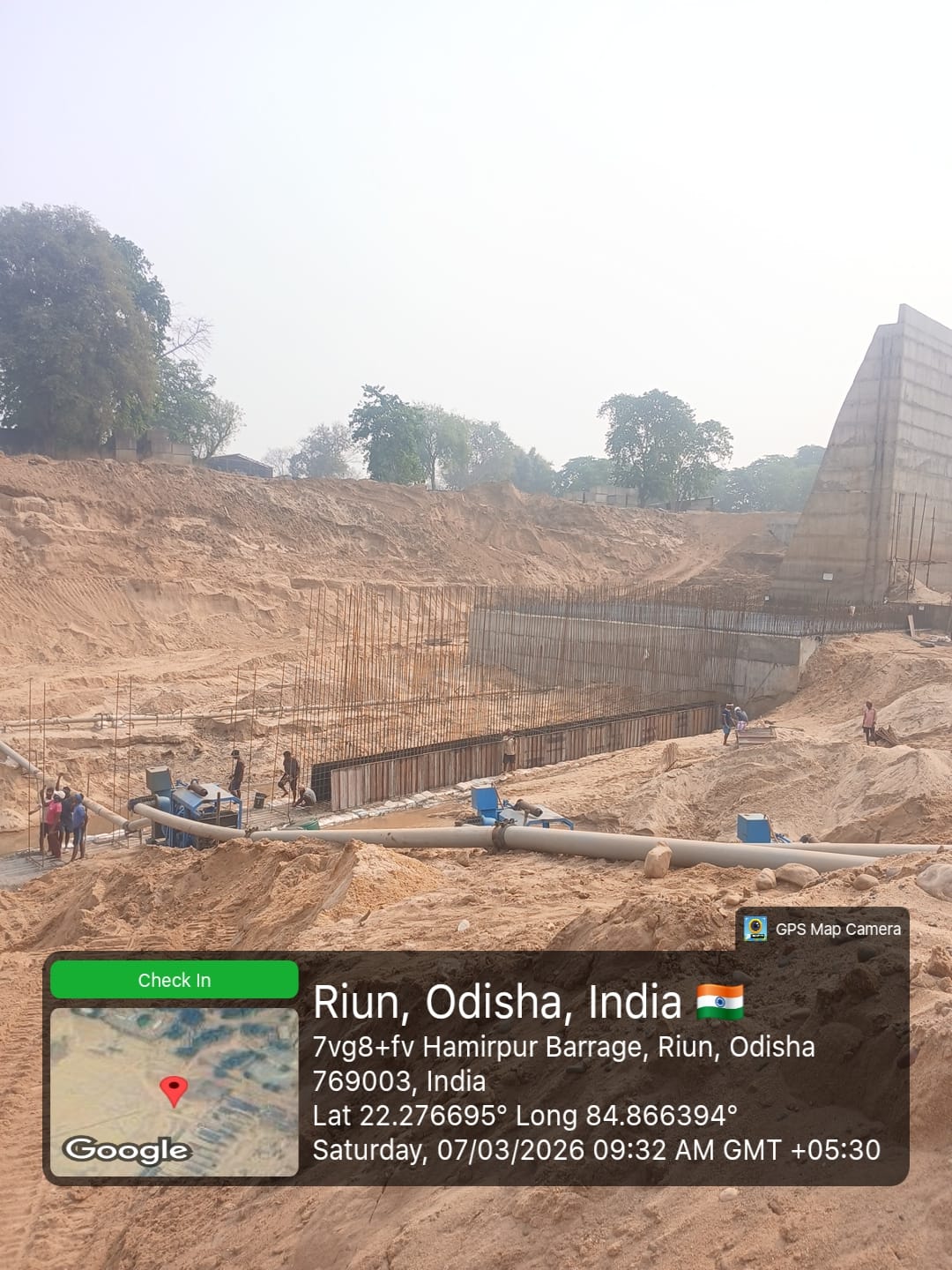

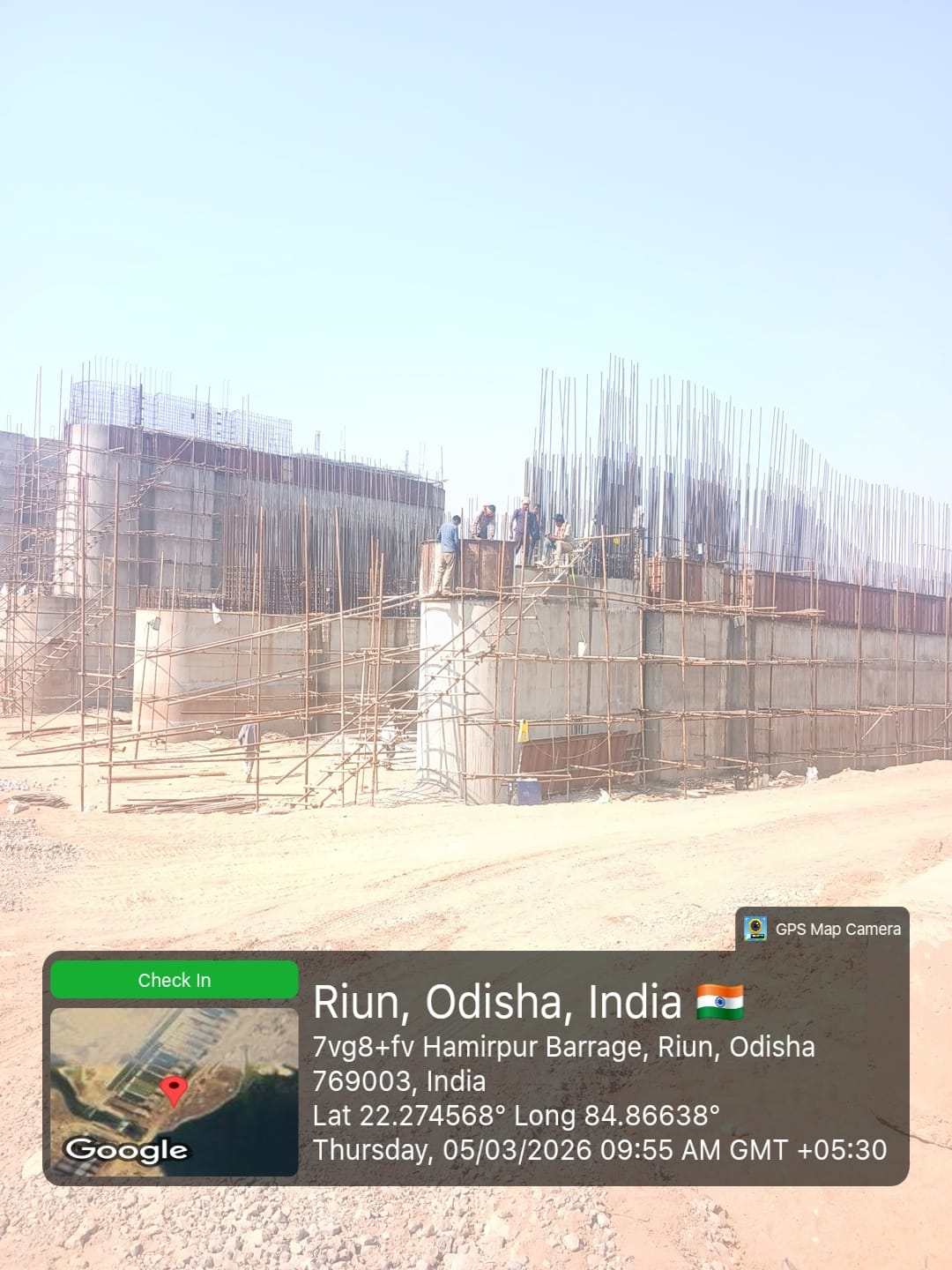

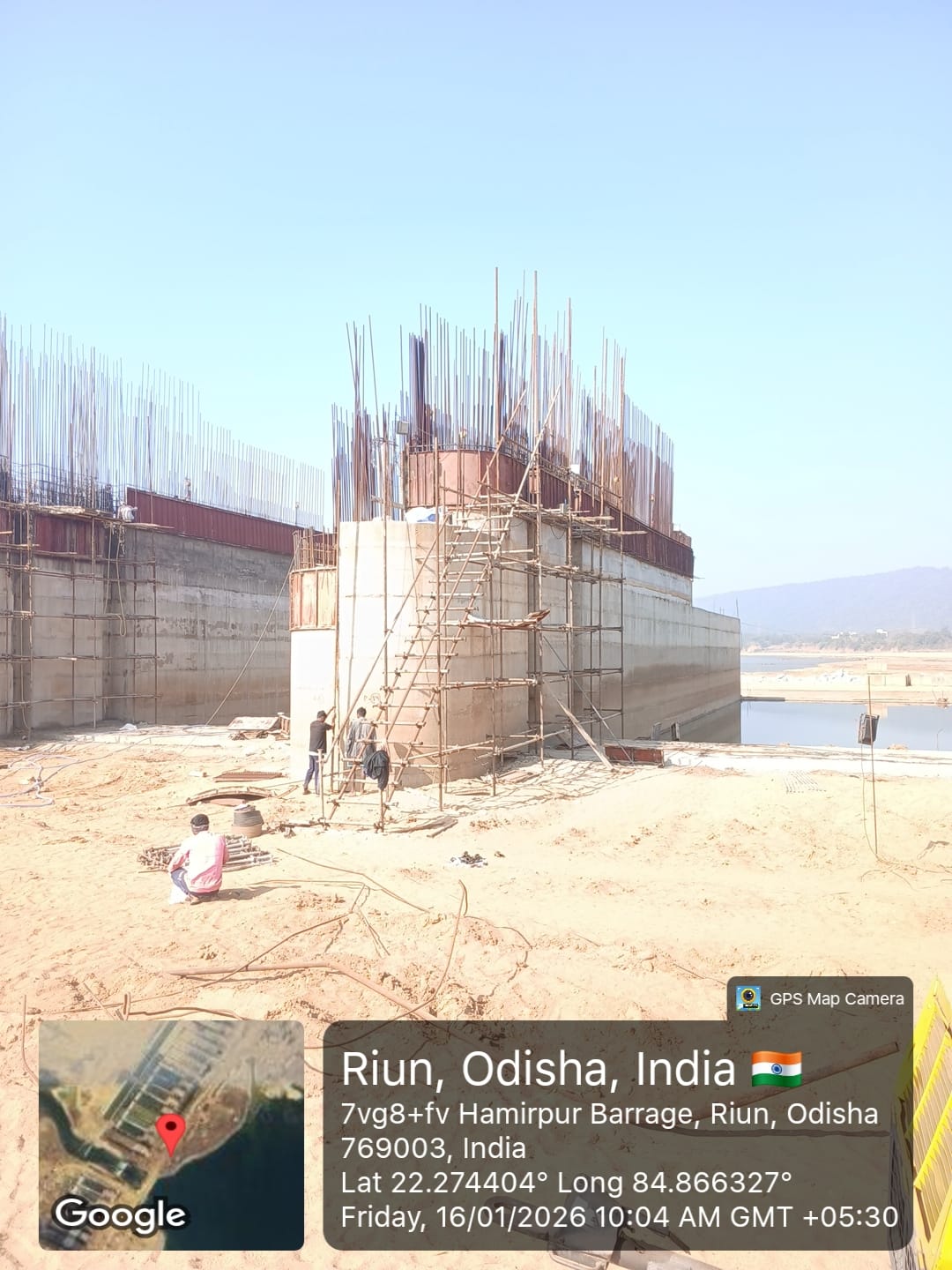

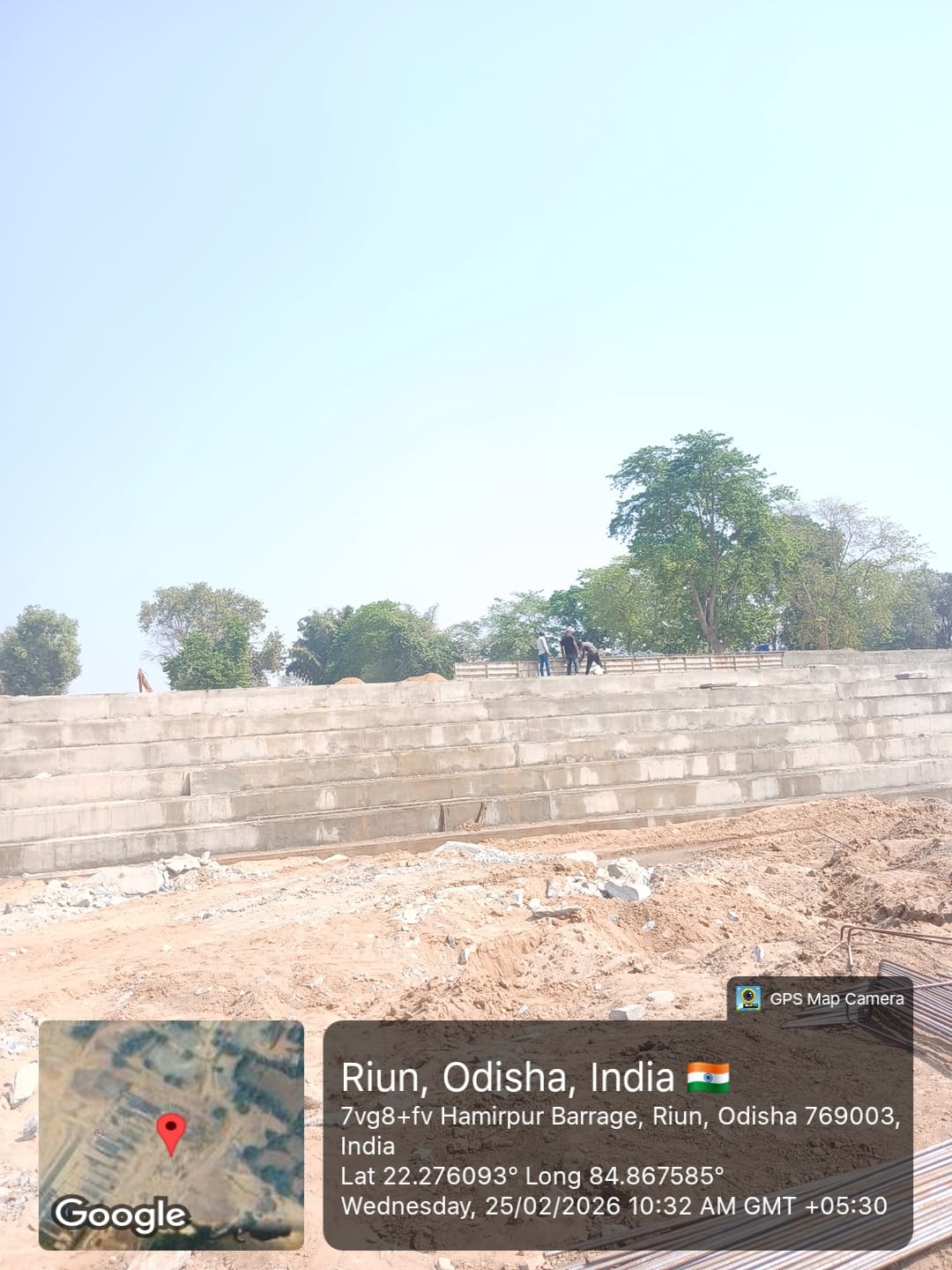

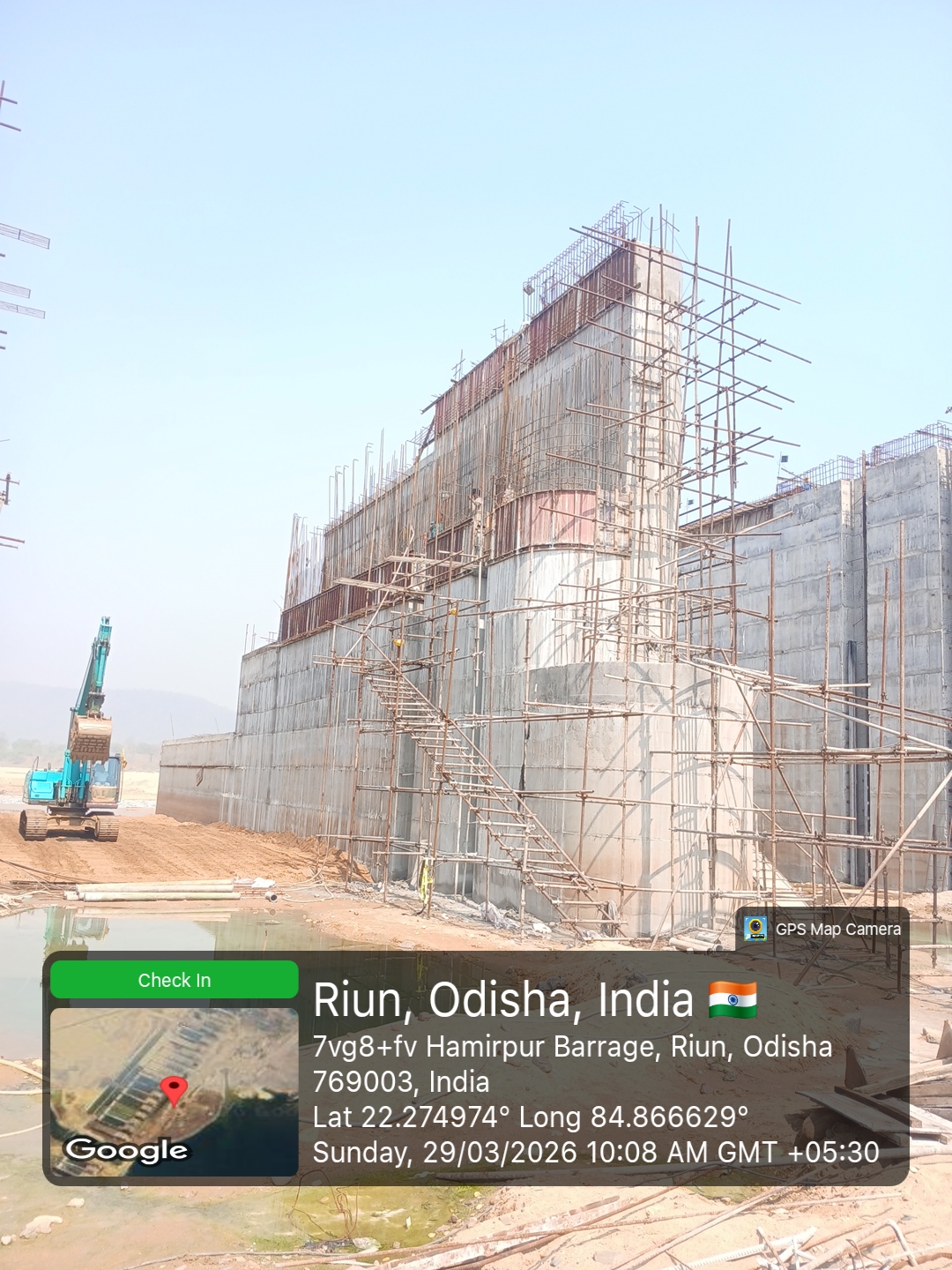

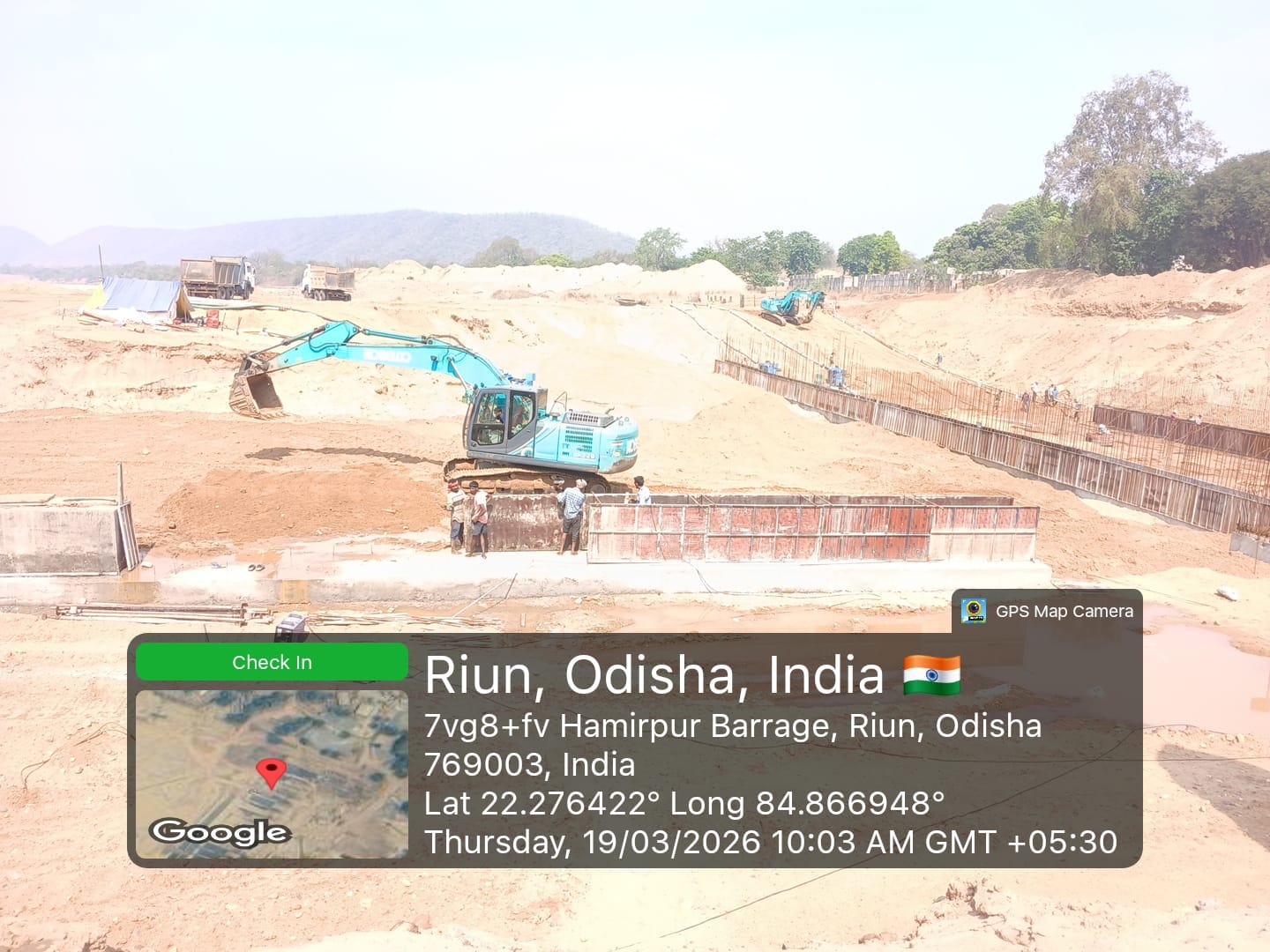

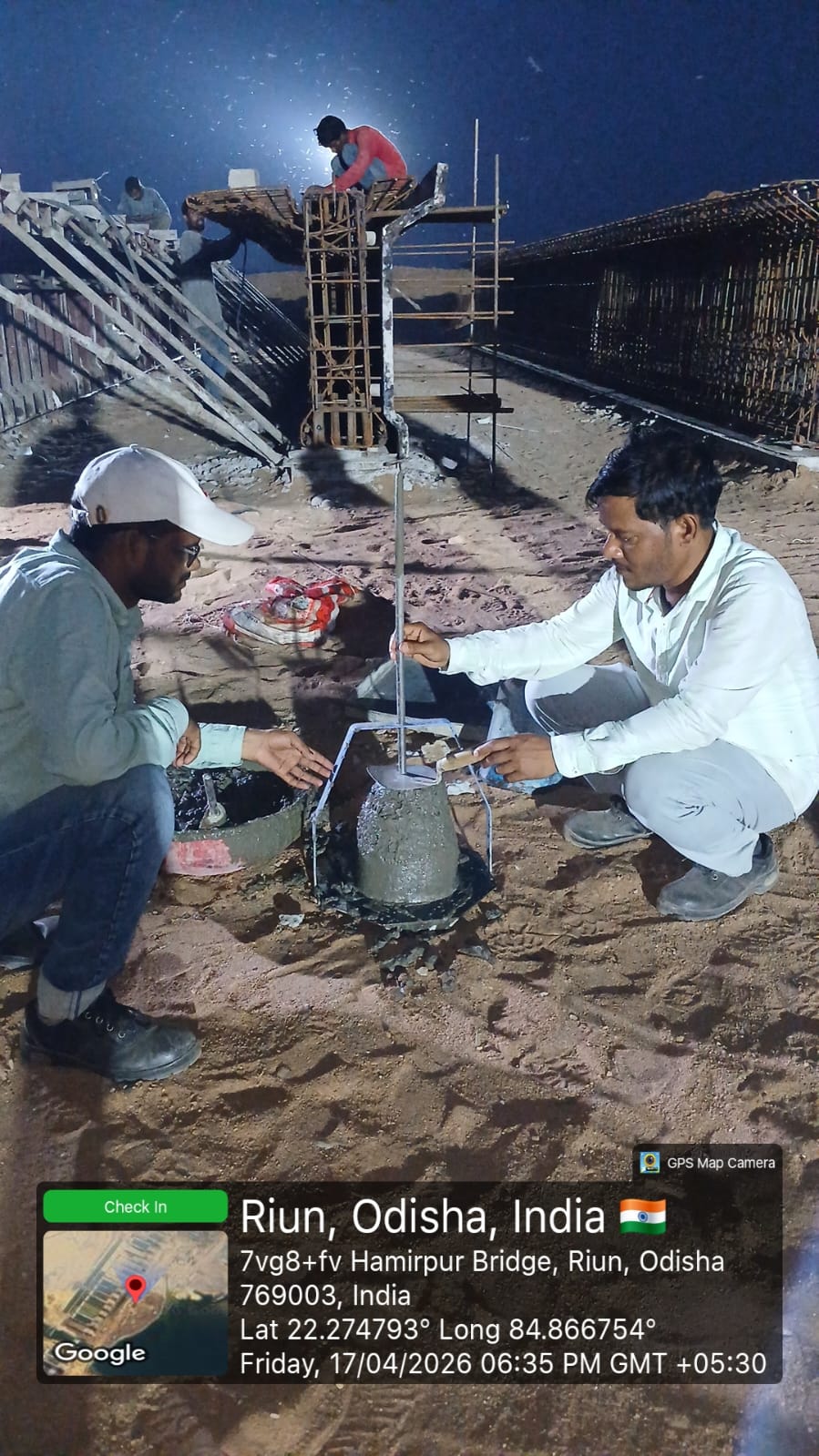

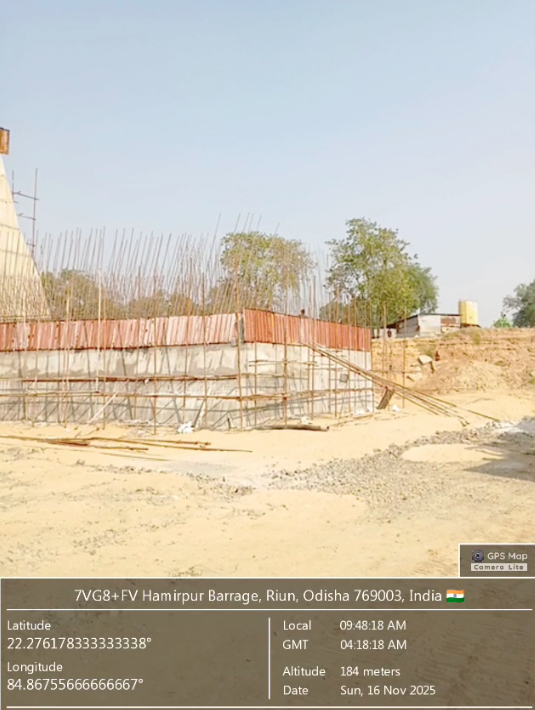

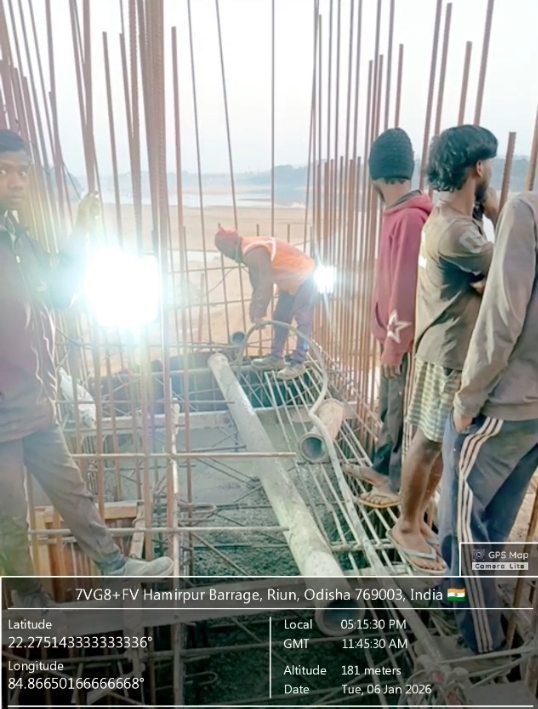

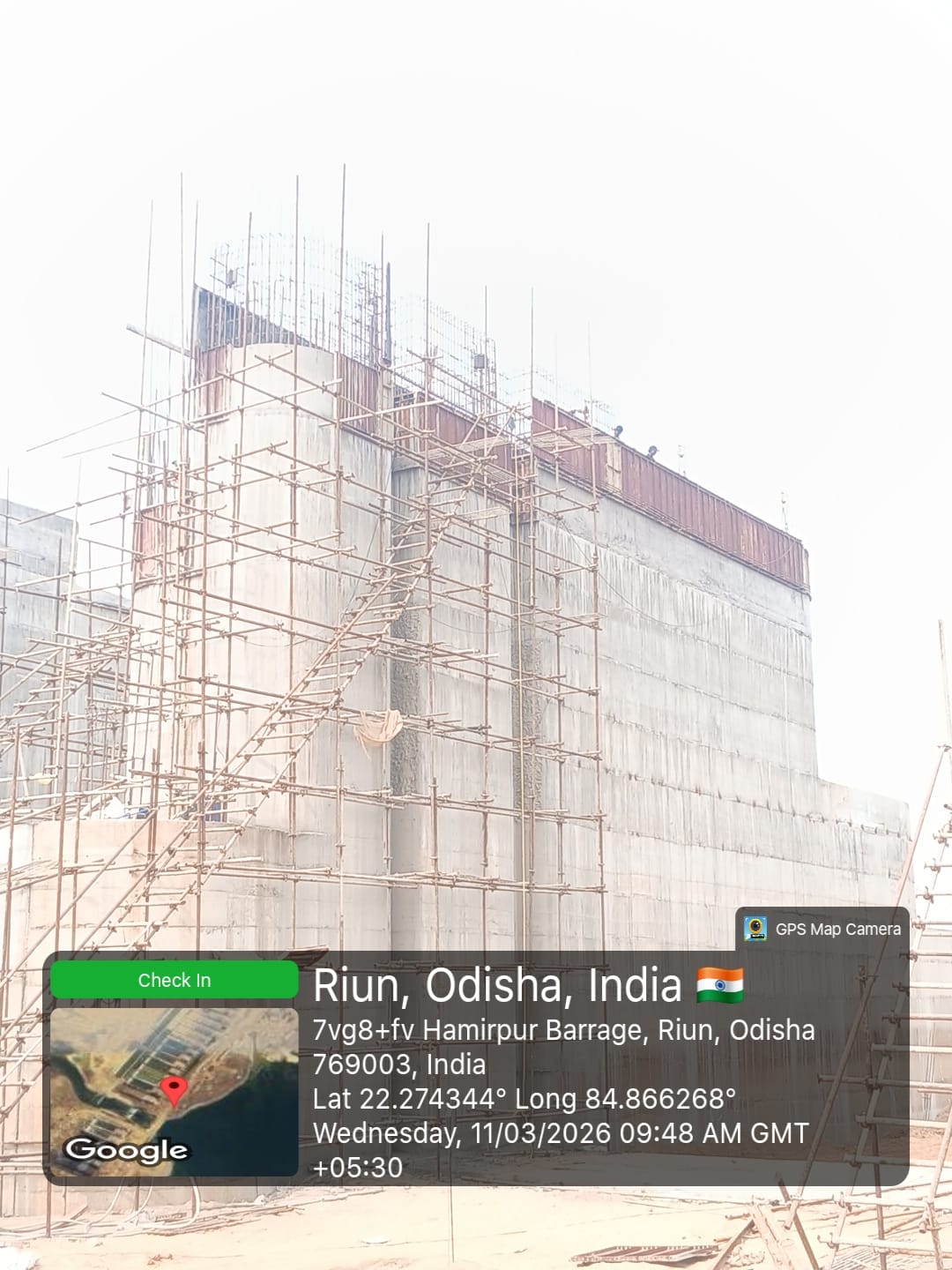

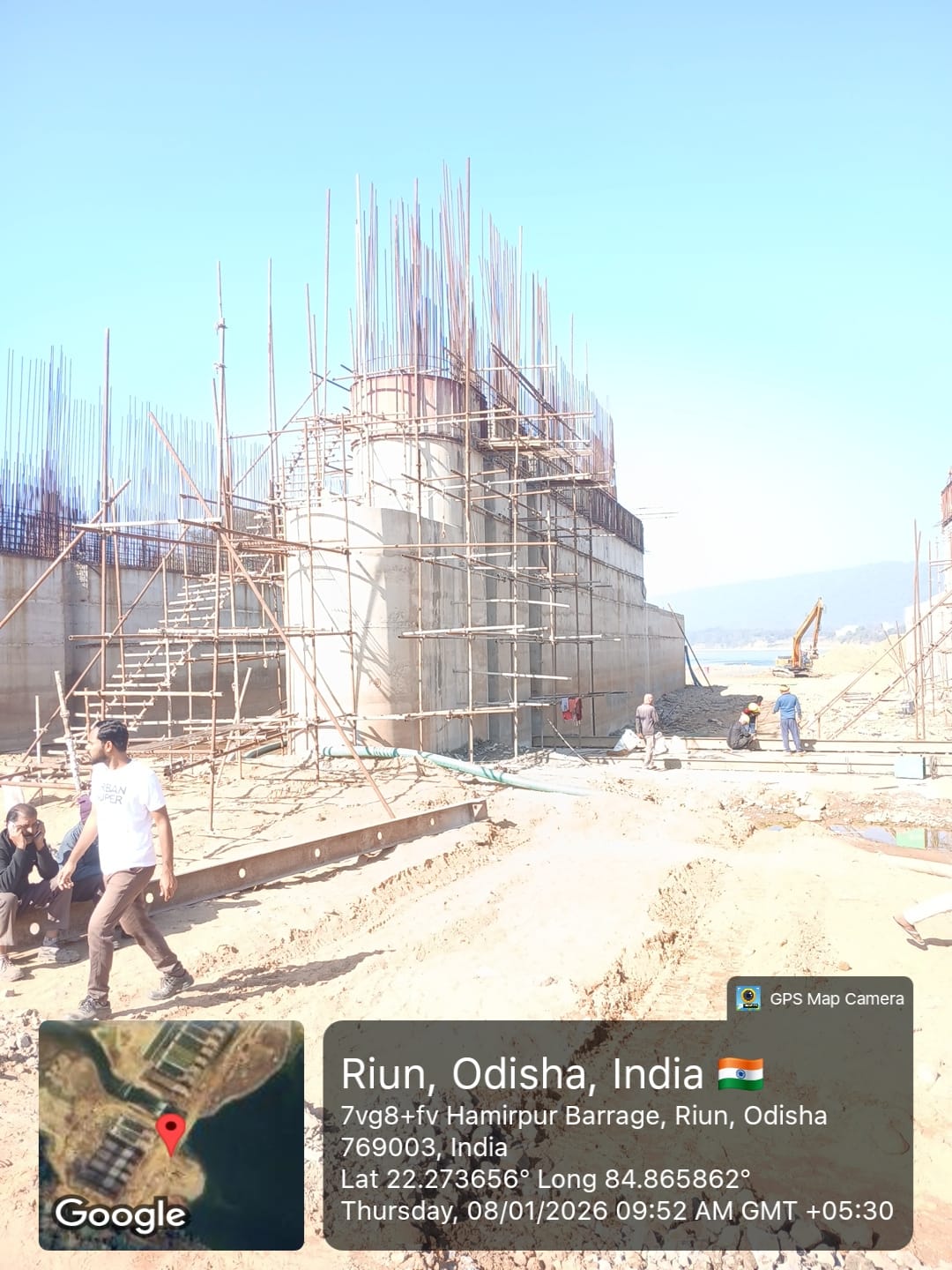

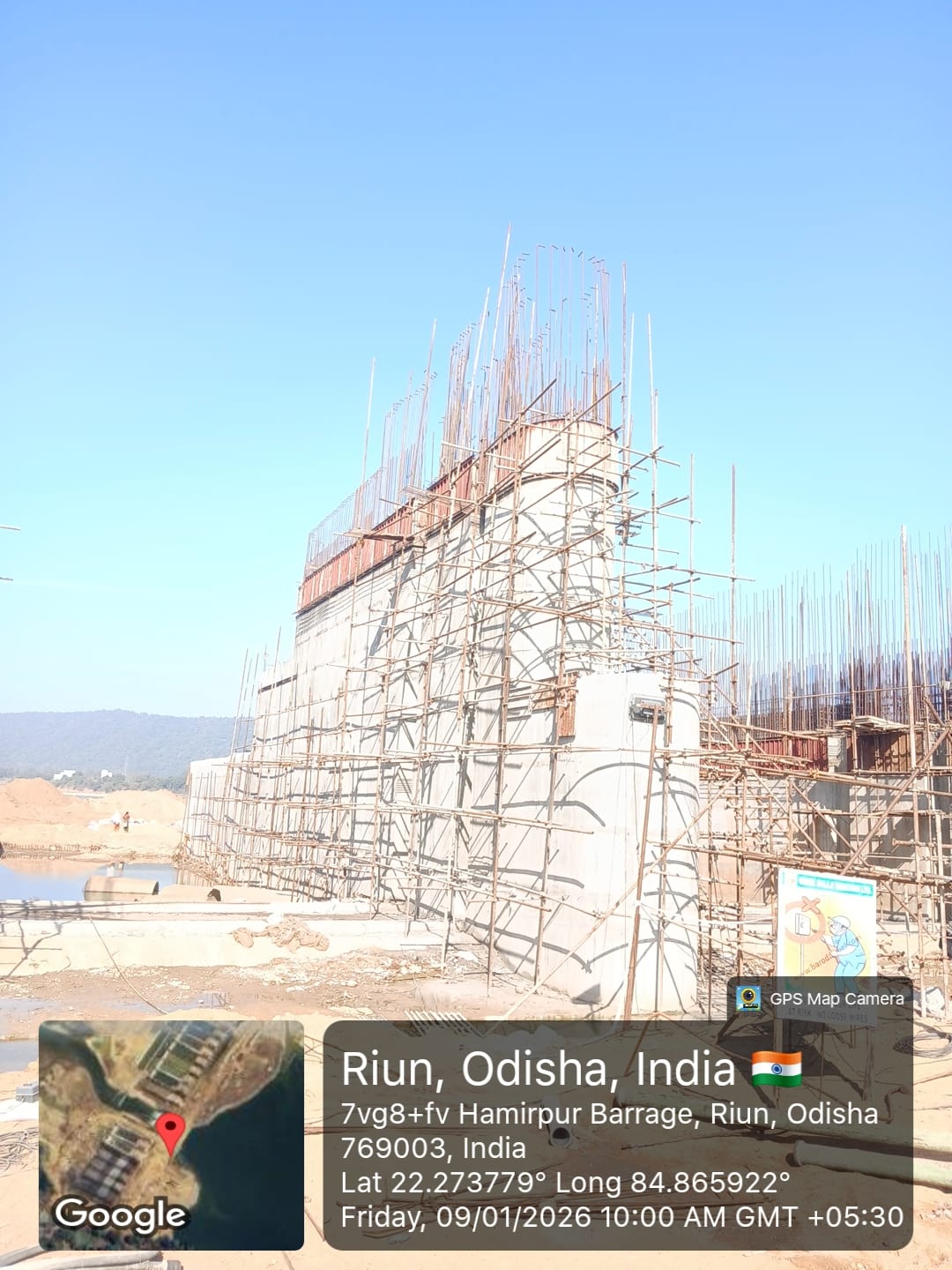

Instream Storage Structure, Hamirpur

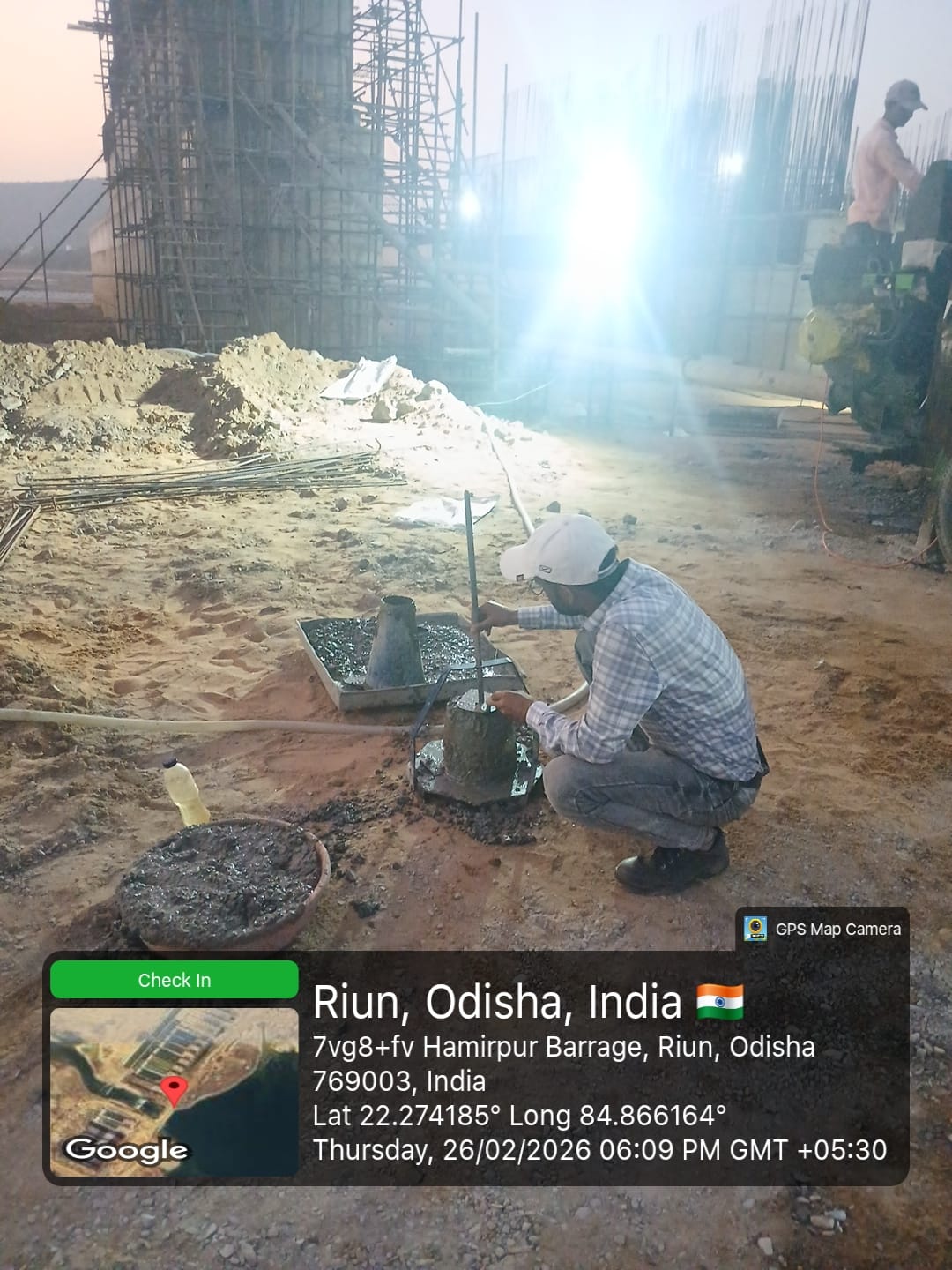

Present flow condition of river at Hamirpur site water level RL 179.610m.
68/100

Instream Storage Structure, Hamirpur
Present flow condition of river at Hamirpur site water level RL 179.760m.
69/100
Instream Storage Structure, Hamirpur

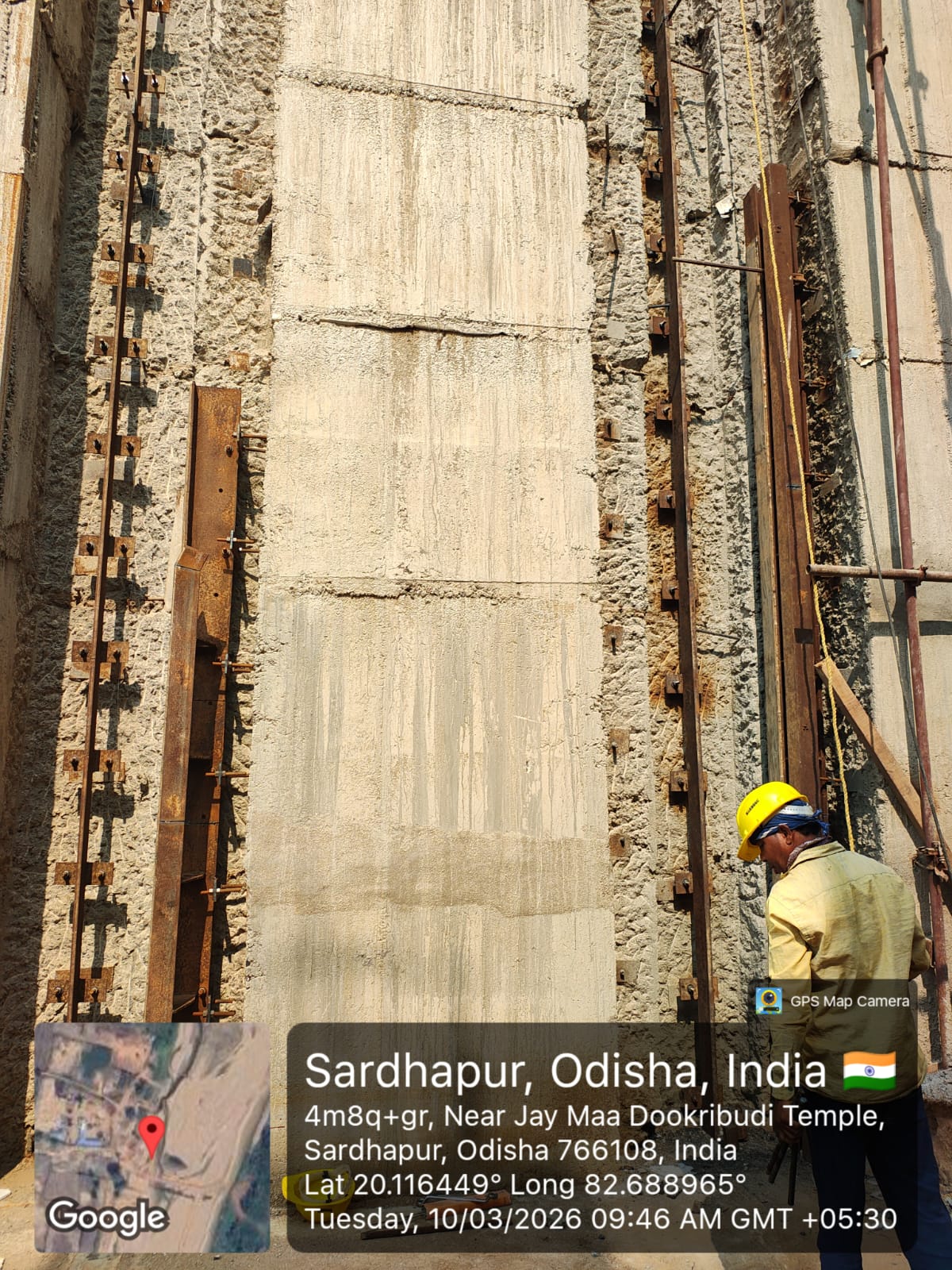

Slump testing M25A20 (Value 85 mm) of D/S Flank wall, 10th lift at Block No-5 done in presence of Client & PSS Team.
70/100
Instream Storage Structure, Hamirpur

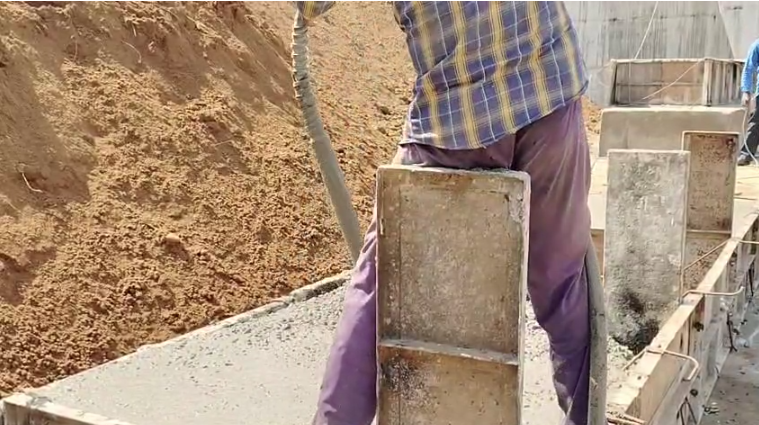

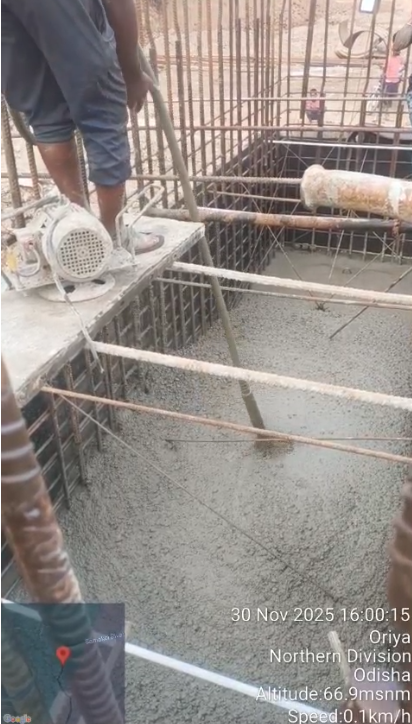

Concreting M25A20 of D/S Flank wall, 10th lift at Block No-5 is under progress in presence of Client & PSS Team.
71/100

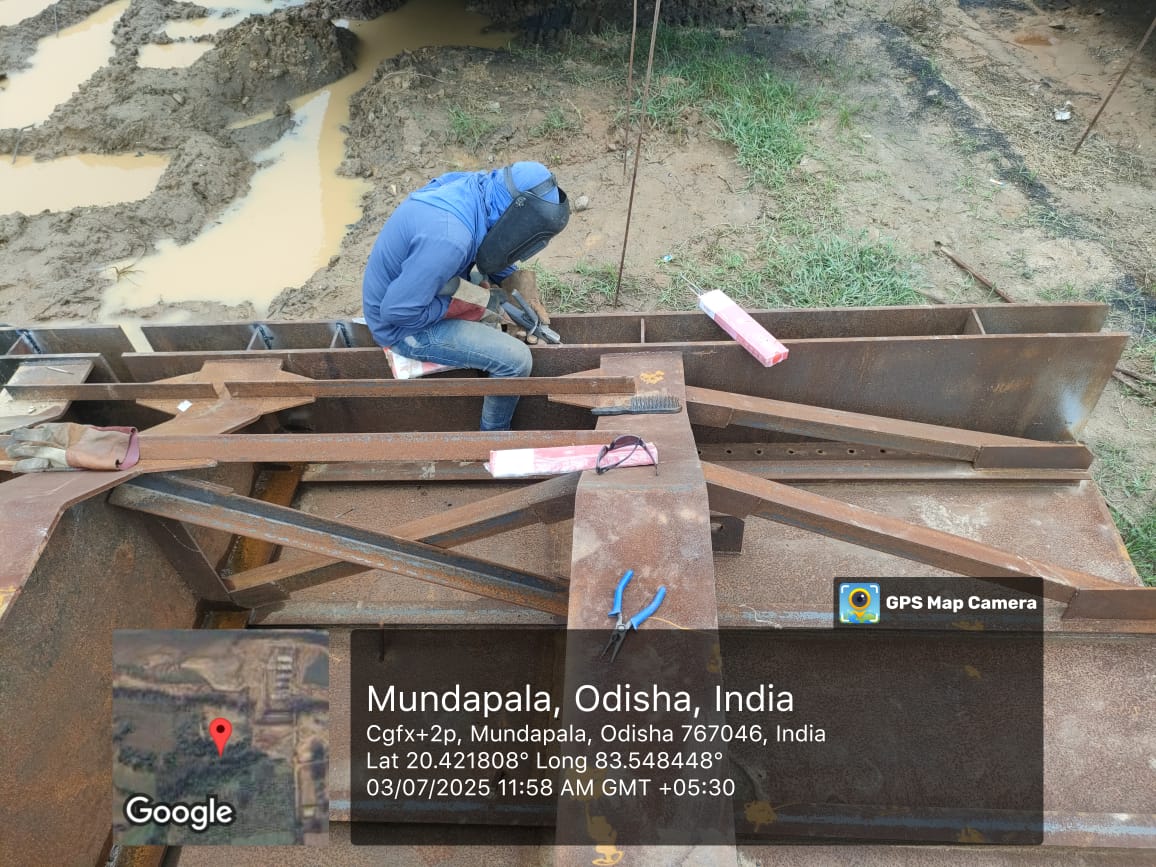

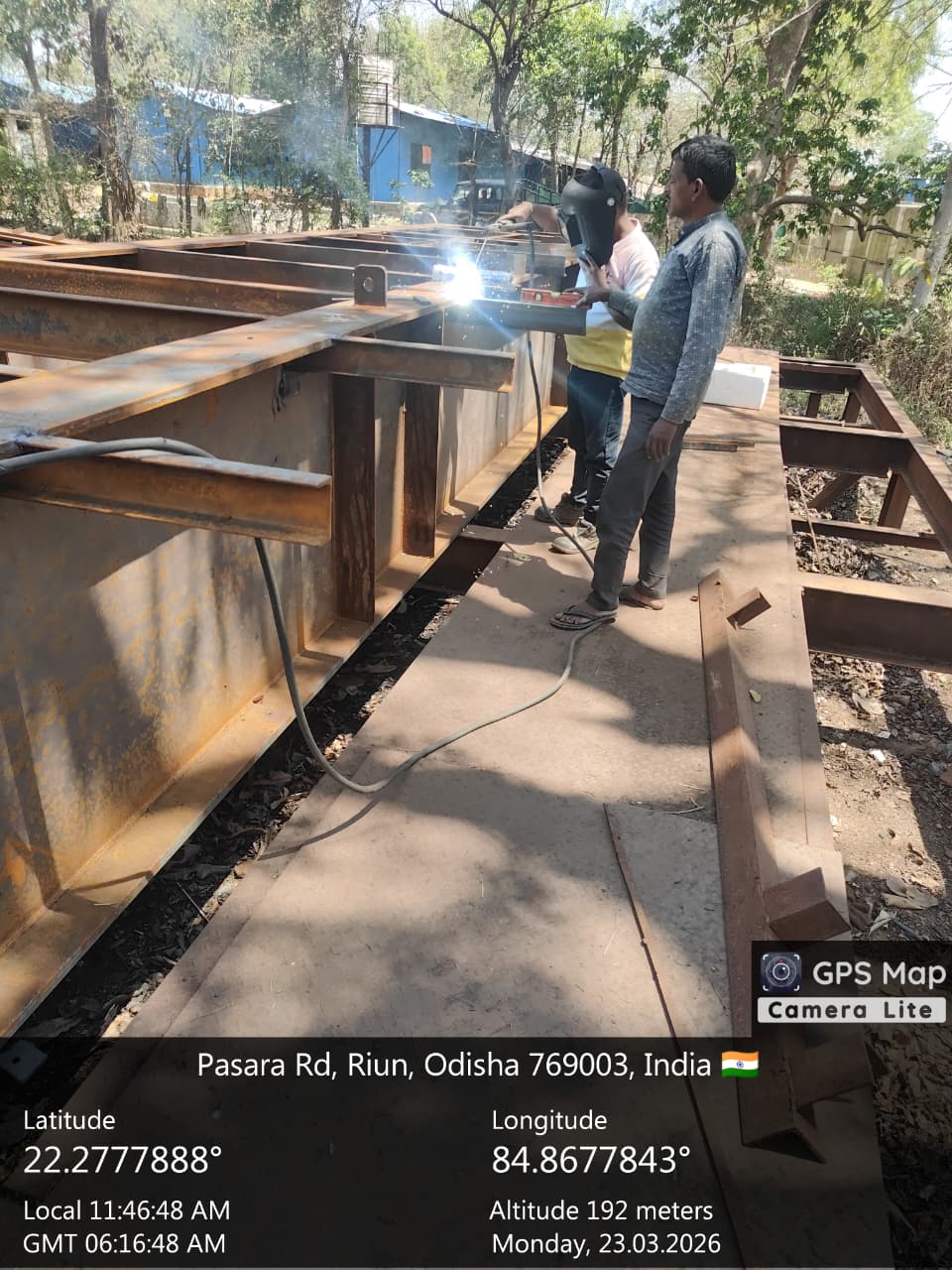

Instream Storage Structure, Hamirpur

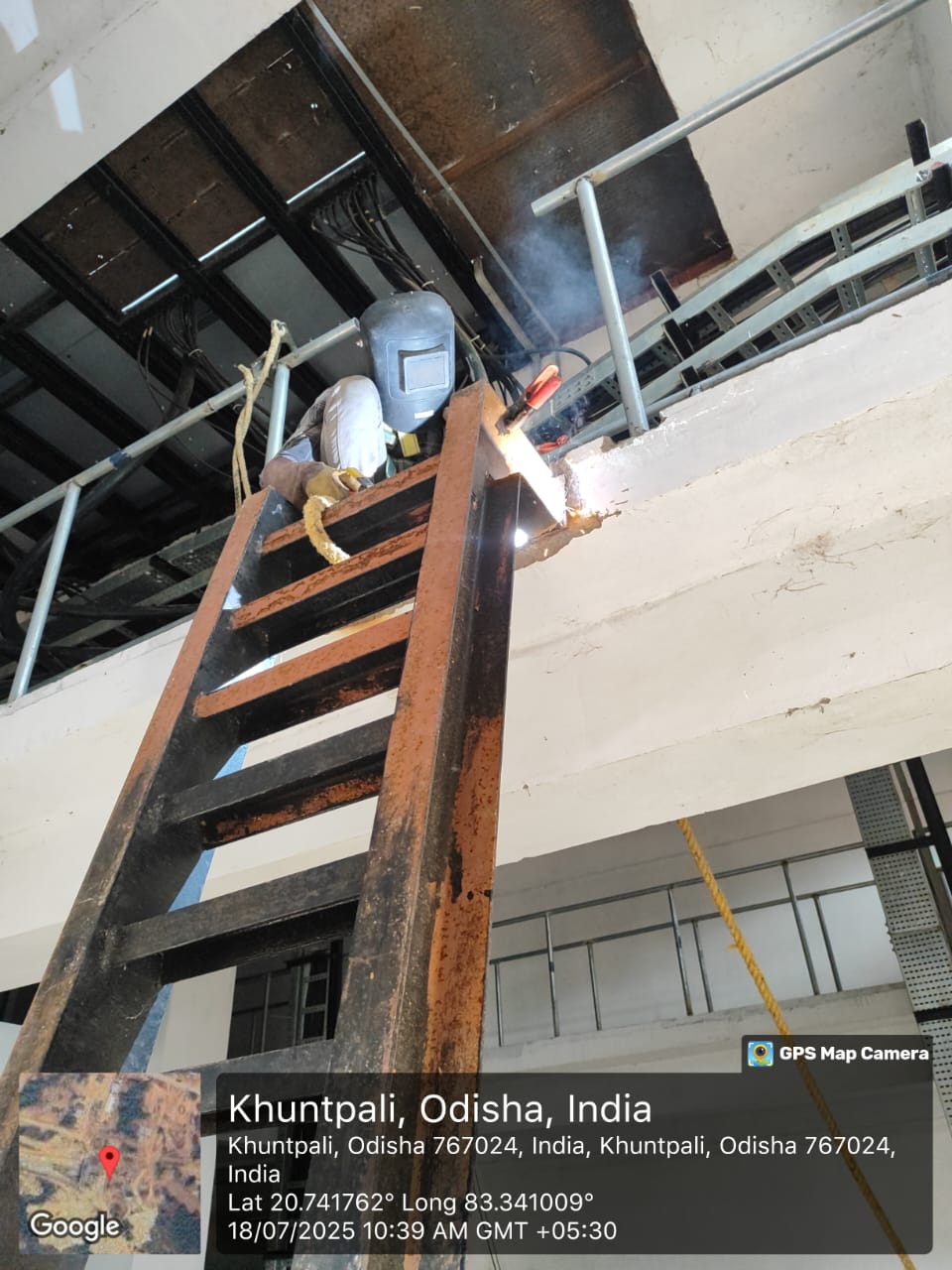

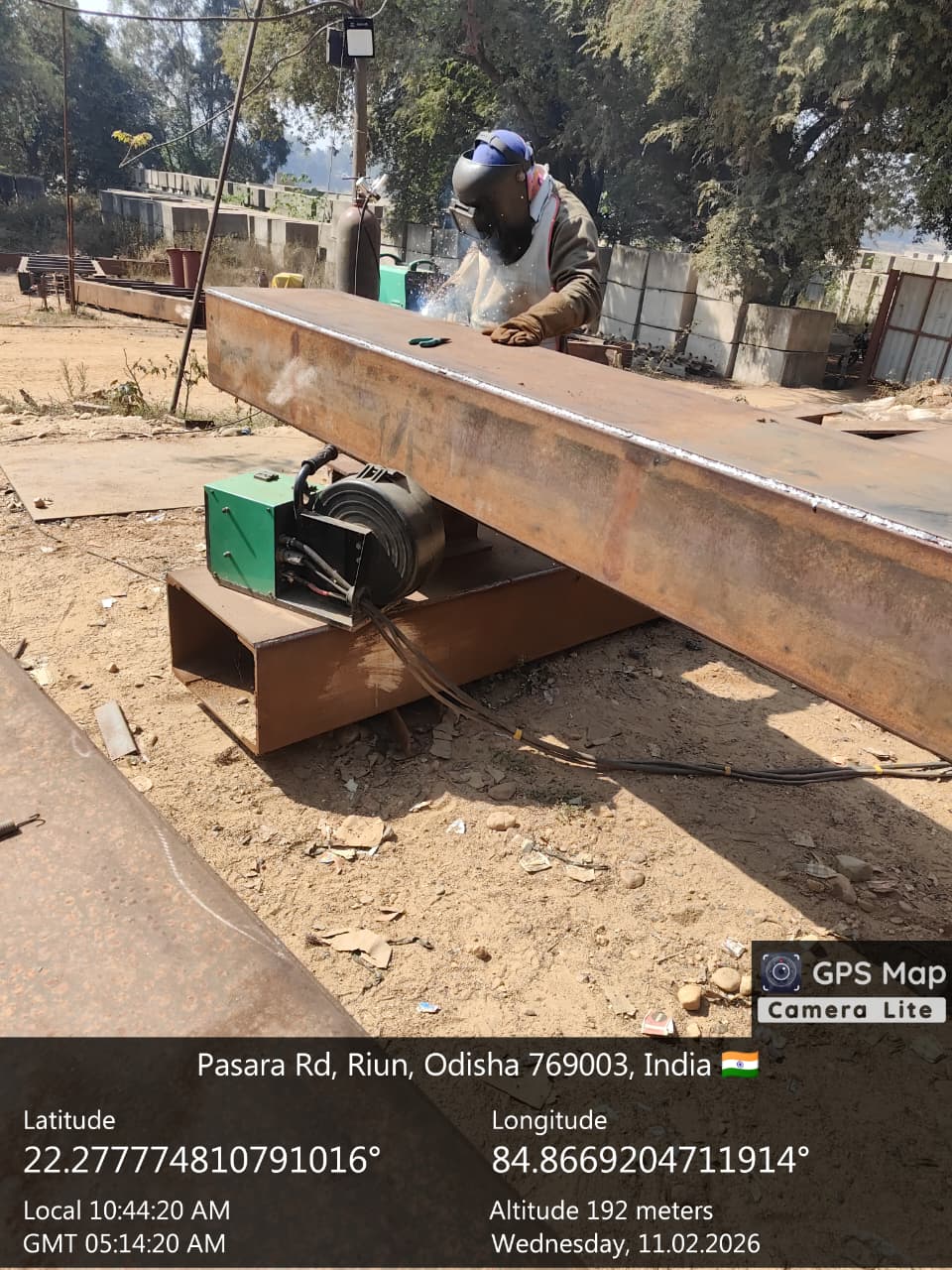

Rope drum Hoist bottom block bracket welding work is in progress.

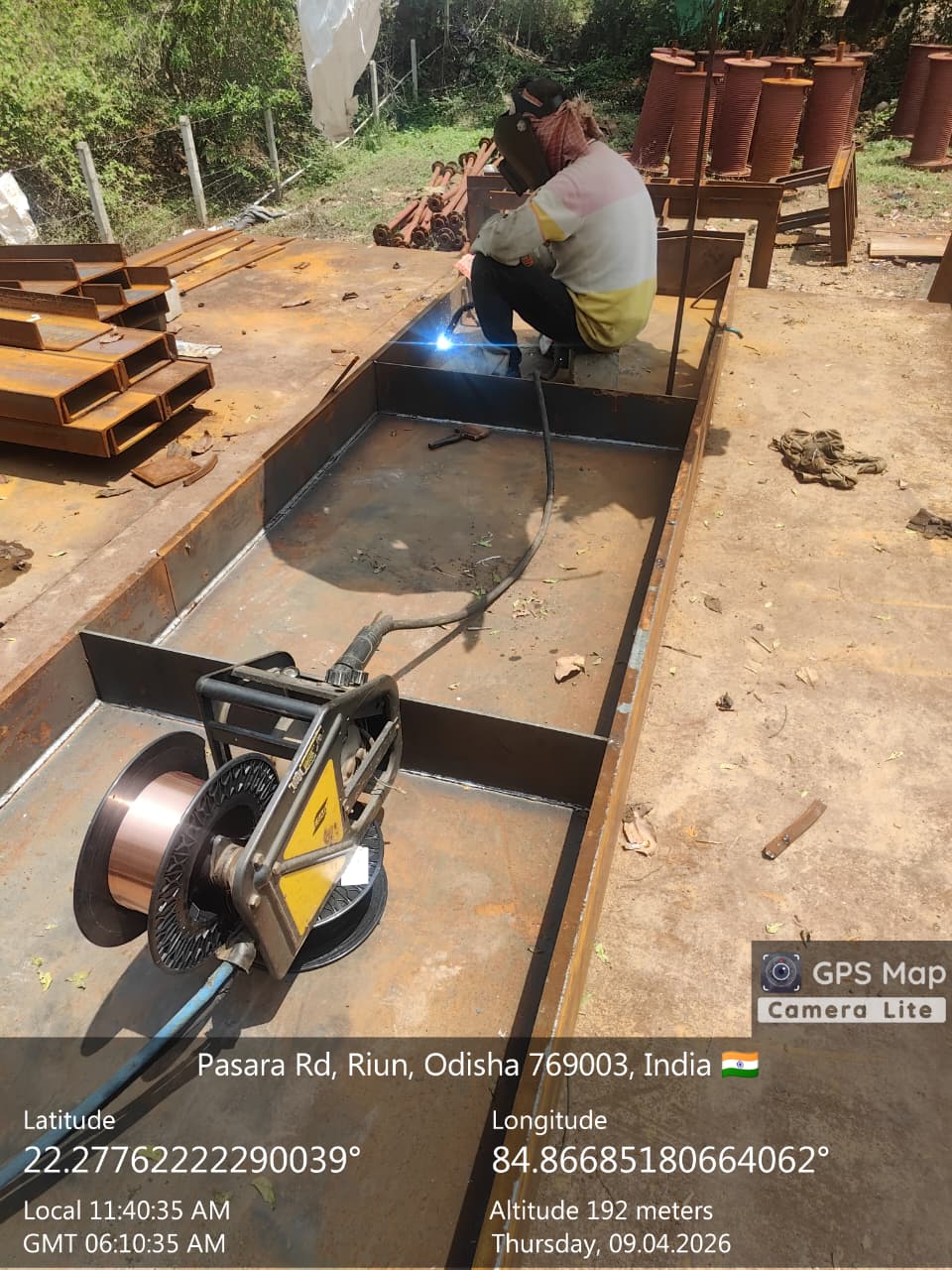

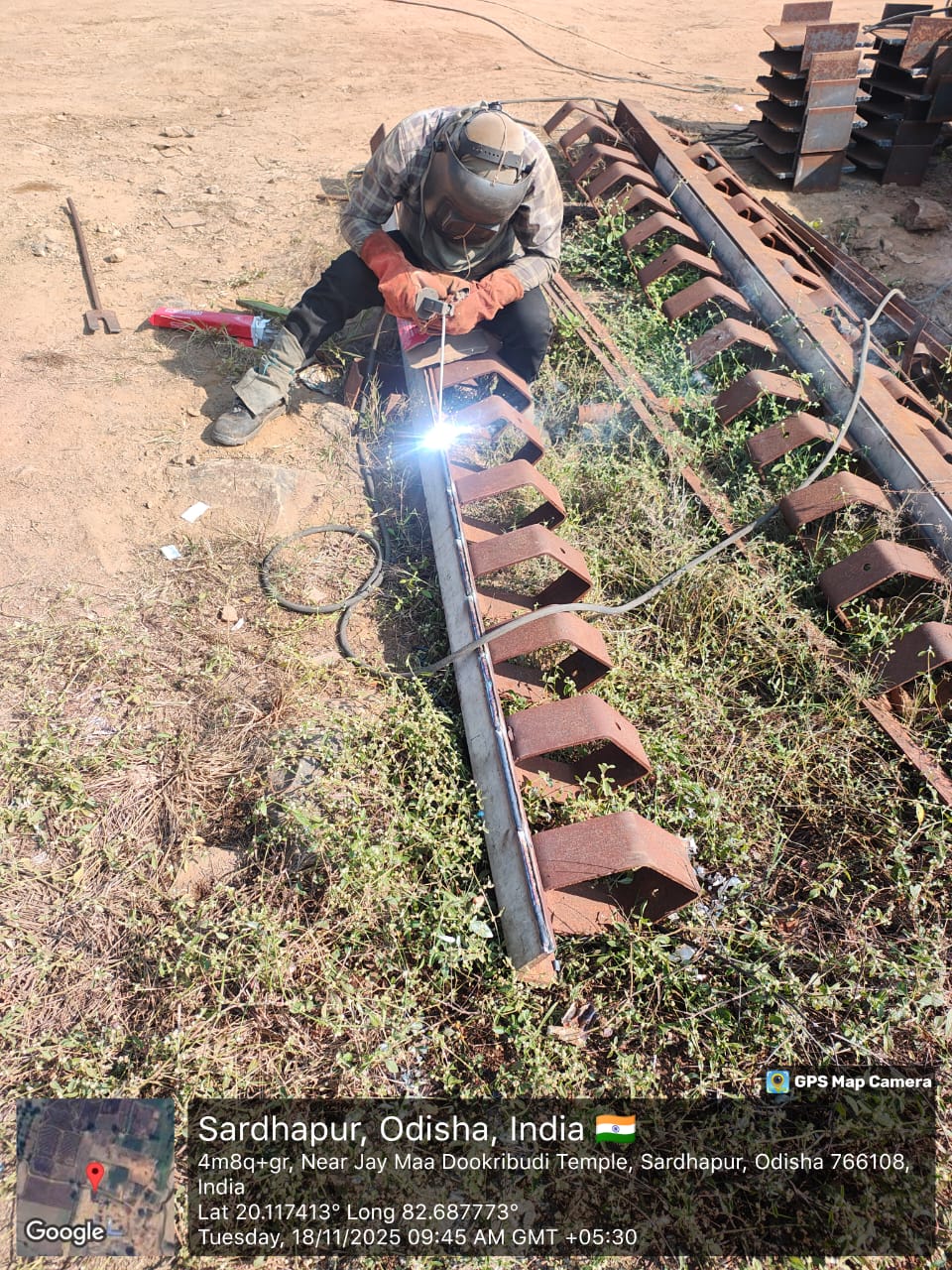

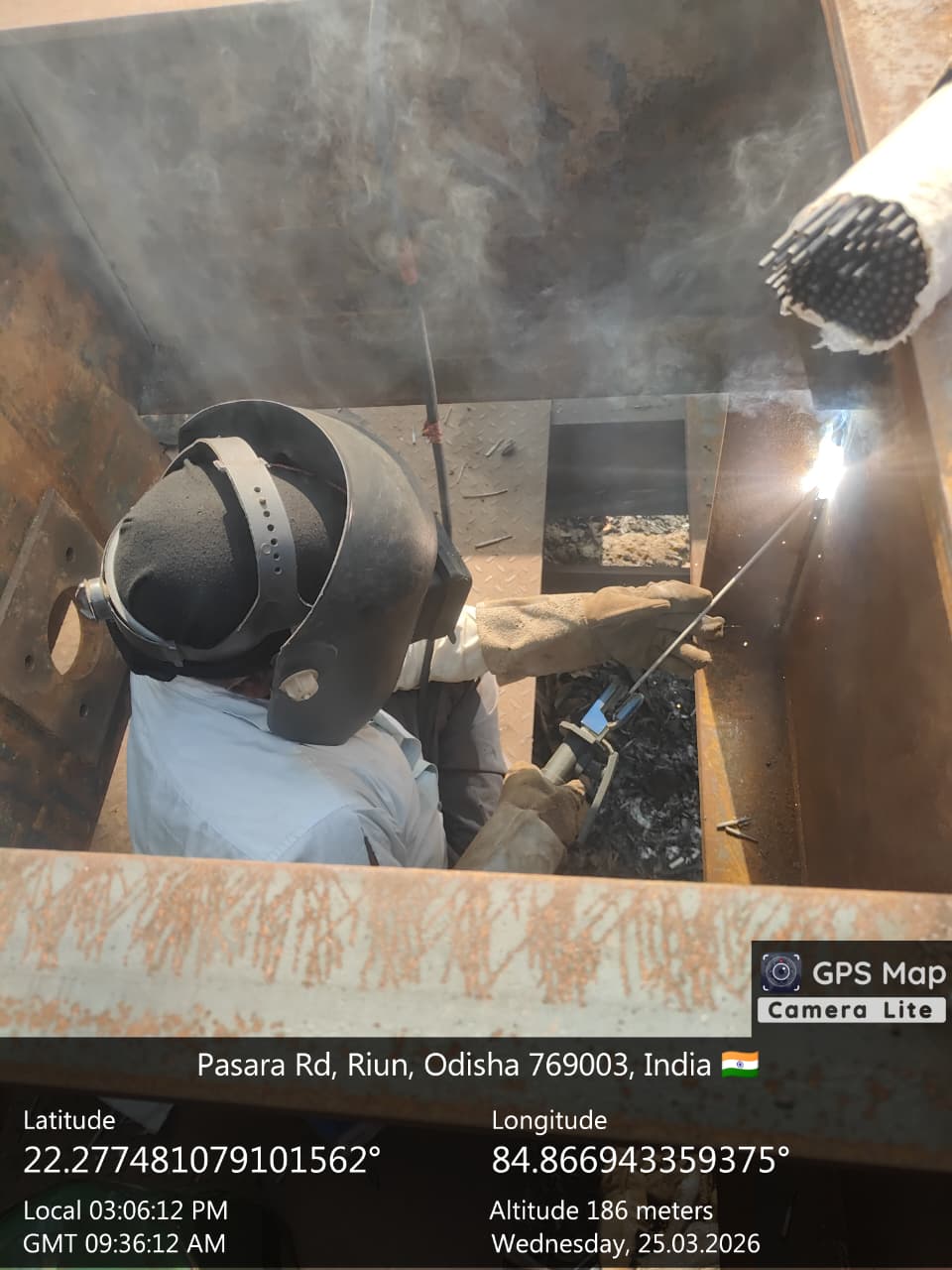

72/100

Instream Storage Structure, Hamirpur
Column Trestle No-25 bracing welding work is in progress.
73/100
Instream Storage Structure, Hamirpur

Slump testing M35A20 (Value 85 mm) of Deck slab (Bay No-18) done in presence of Client & PSS Team.

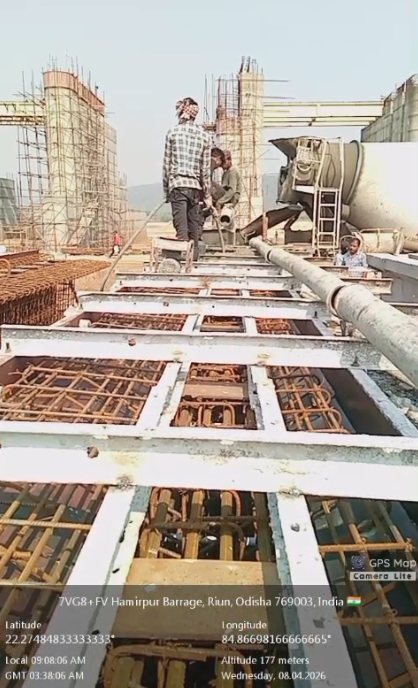

74/100

Instream Storage Structure, Hamirpur

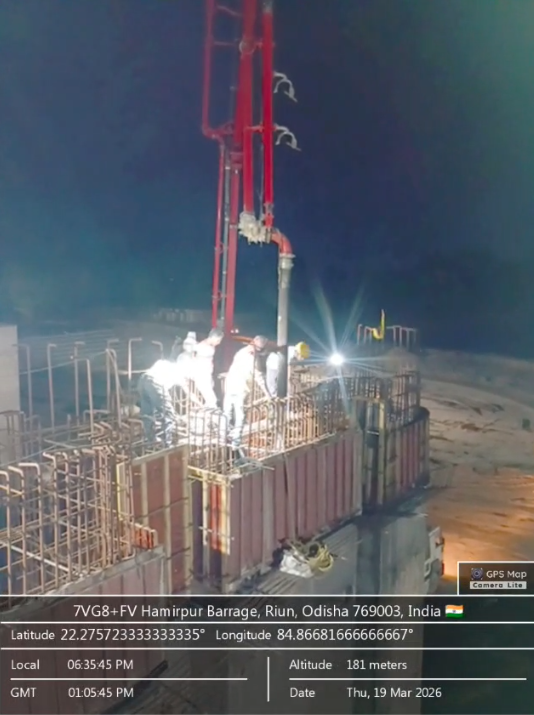

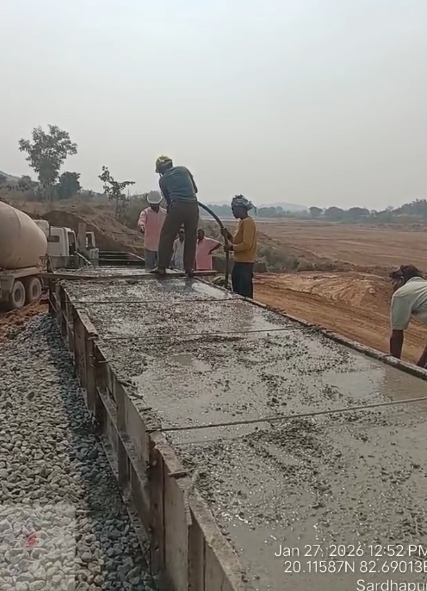

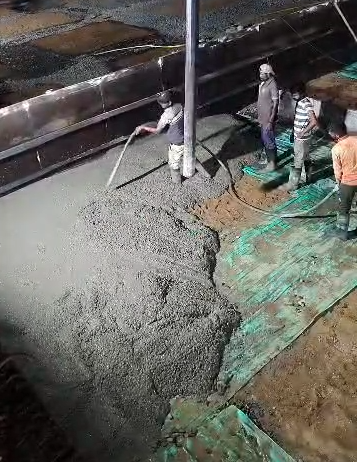

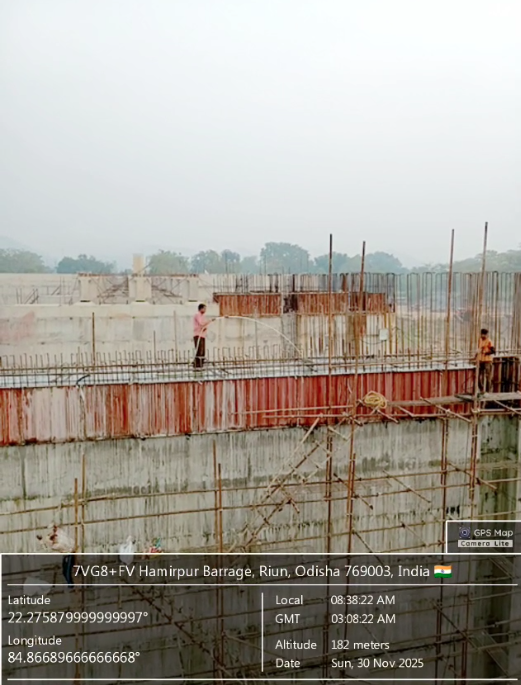

Concreting M35A20 of Deck slab (Bay No-18) is under progress in presence of Client & PSS Team.
75/100

Instream Storage Structure, Hamirpur
Cleaning of reinforcement for Deck slab (Bay No-18) is under progress by Sand blasting method.
76/100
Instream Storage Structure, Hamirpur

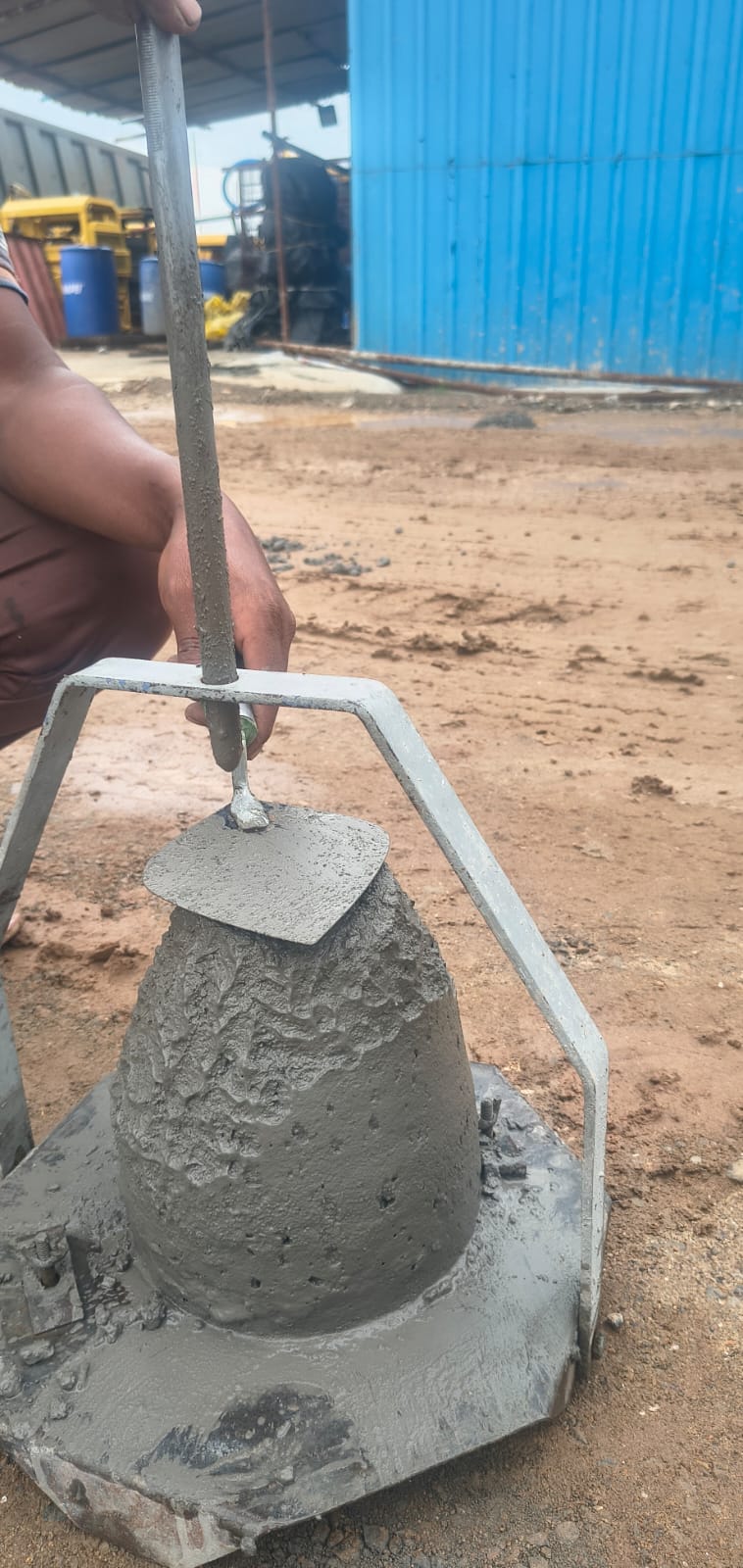

Testing of Compressive M25A20 (Strength is 31.11/mm2 for 28 days) of Hand Rail Beam Bay No-26,27,28 & 29 at Block No-5 and M35A20 (Strength is 42.44/mm2 for 28 days) of Gantry Girder No-59,60,61 & 62 and (Strength is 37.48/mm2 for 07 days) of Gantry Cross Girder has done in presence of Client & PSS team.
77/100
Instream Storage Structure, Hamirpur
Mud cleaning from Watchman Quater footing Area is under progress.
78/100
Instream Storage Structure, Hamirpur
Present flow condition of river at Hamirpur site water level RL 179.870m.
79/100

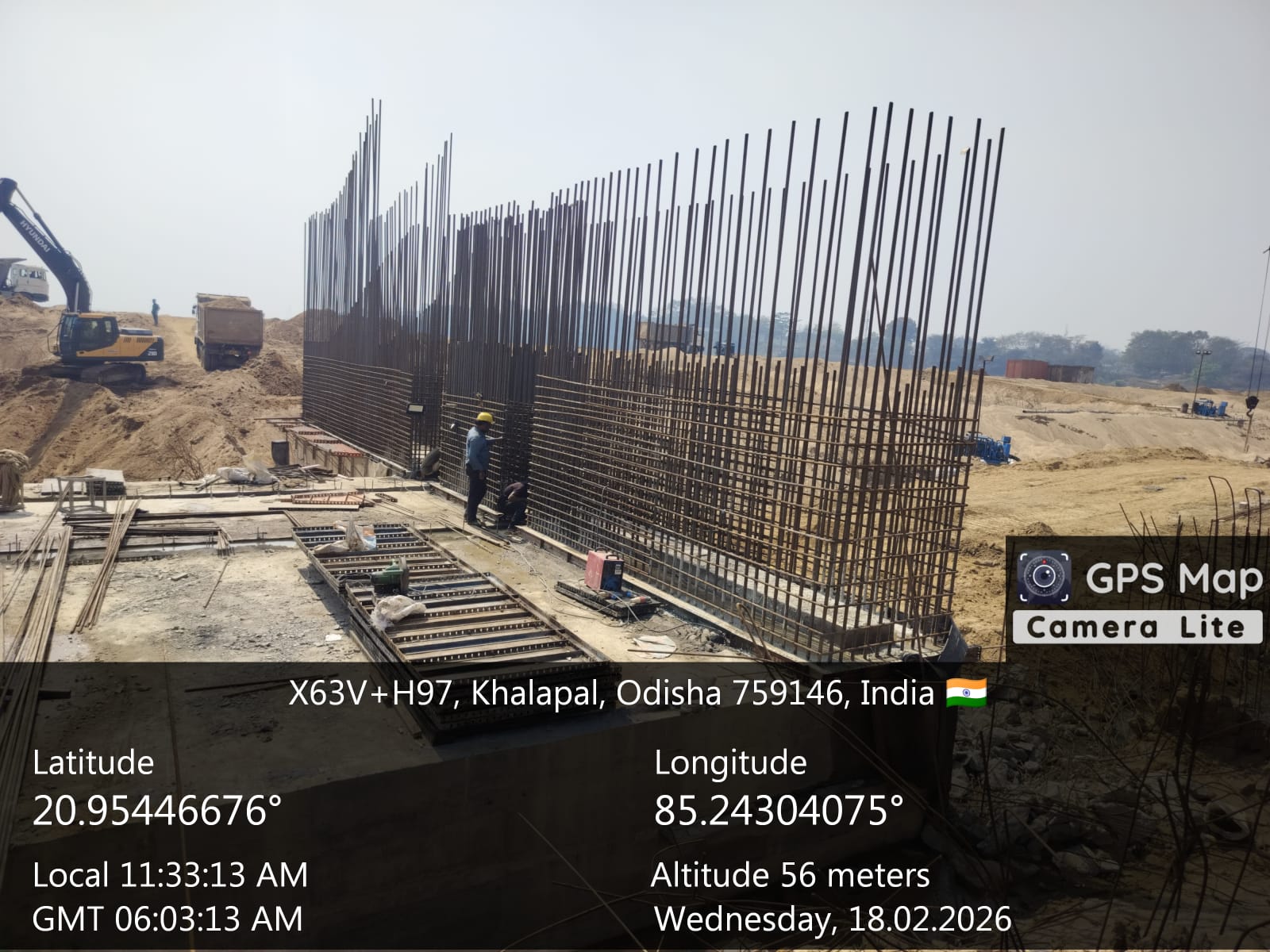

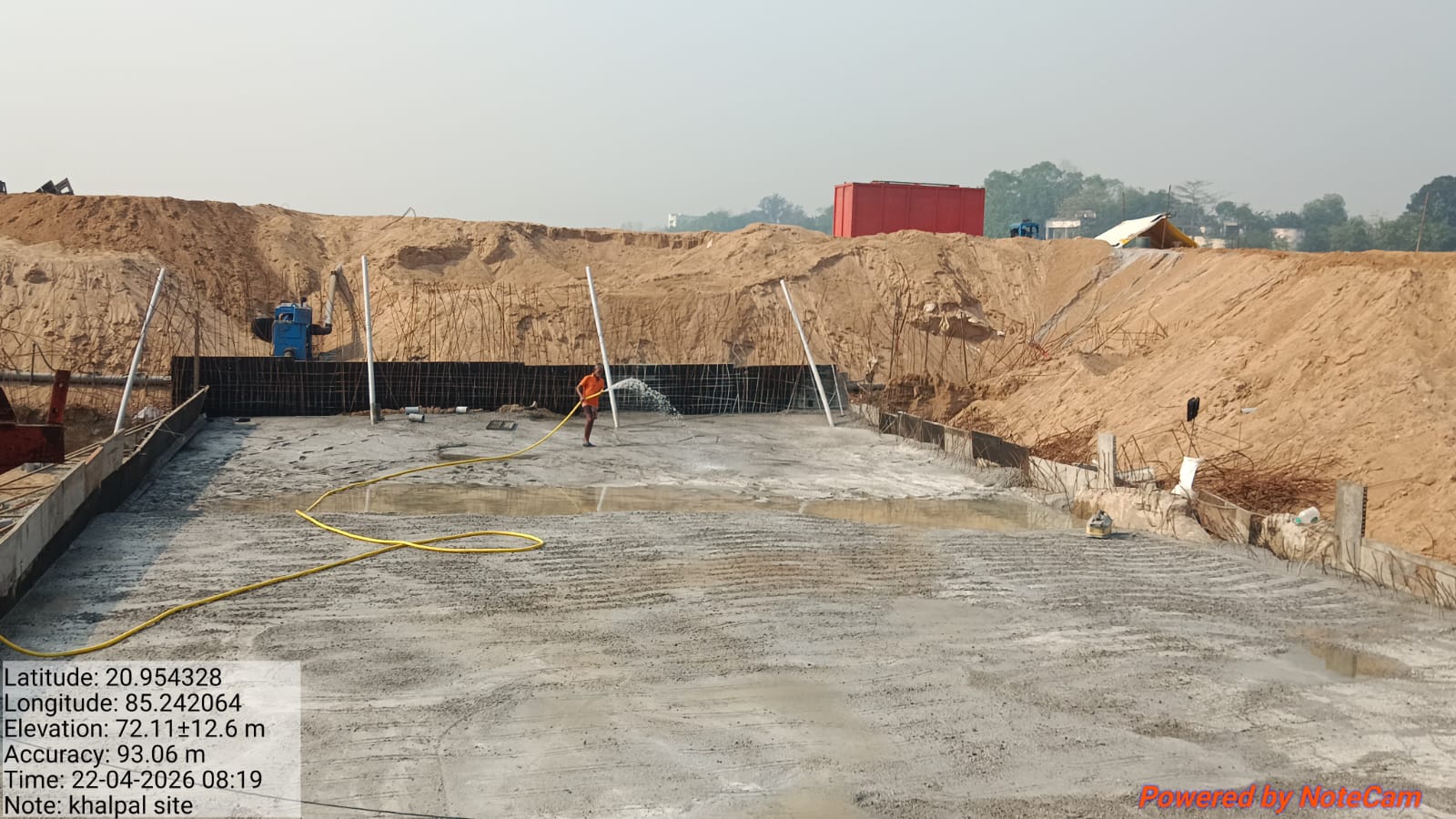

Instream Storage Structure, Khalpal

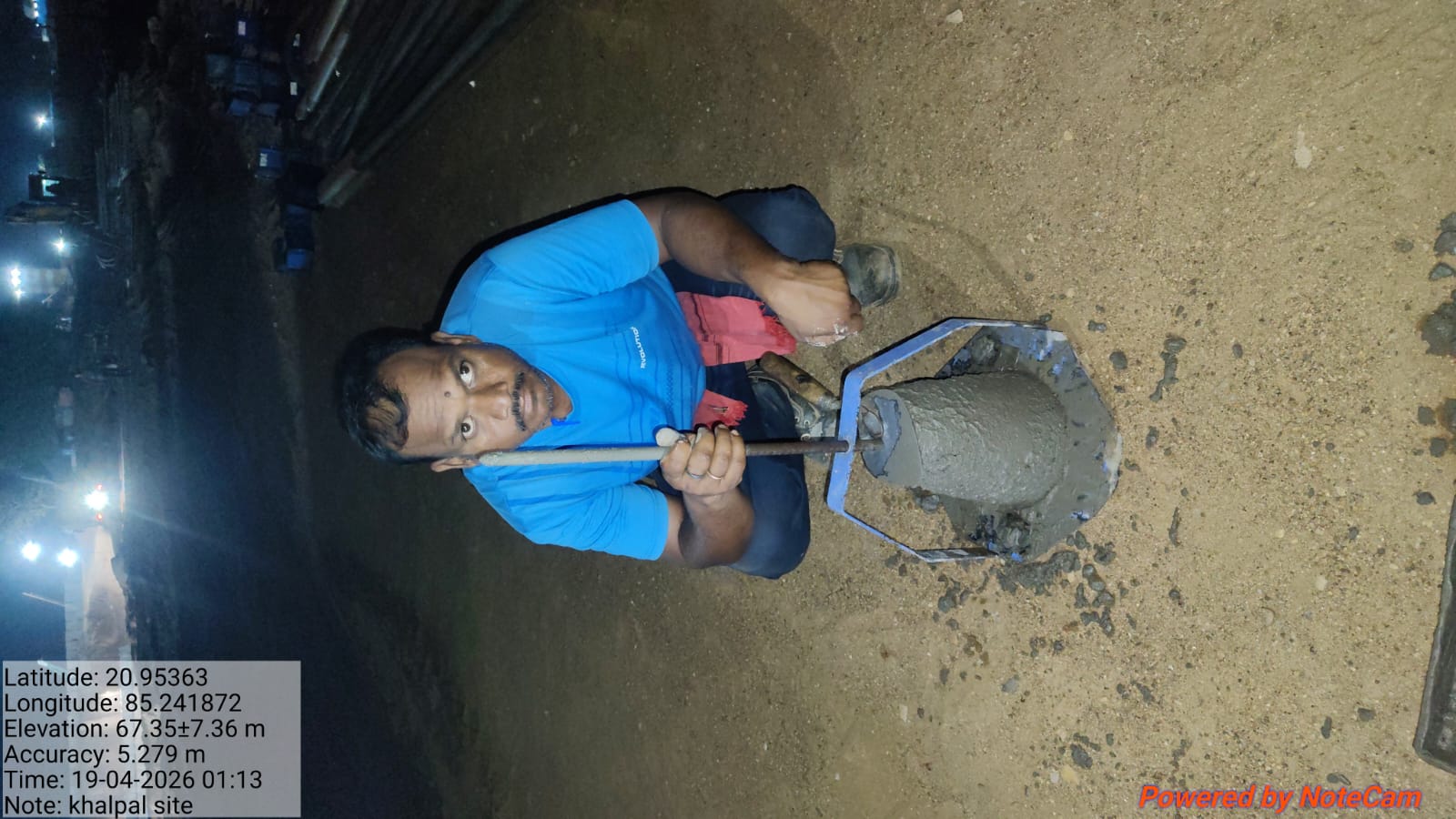

Curing of Girders is under progress.
80/100
Instream Storage Structure, Khalpal

Present flow condition of river at Khalpal site level RL 56.9m.
81/100

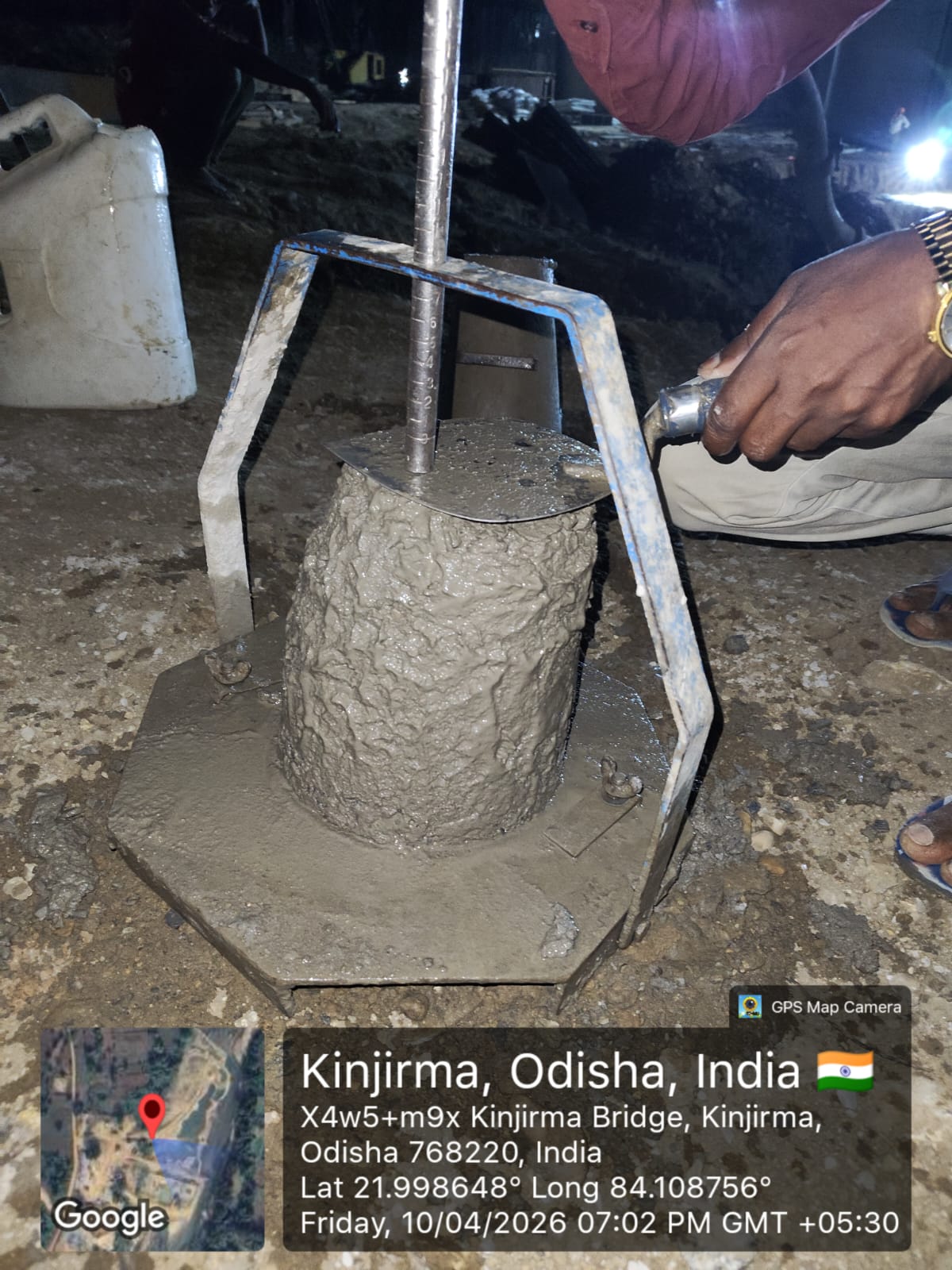

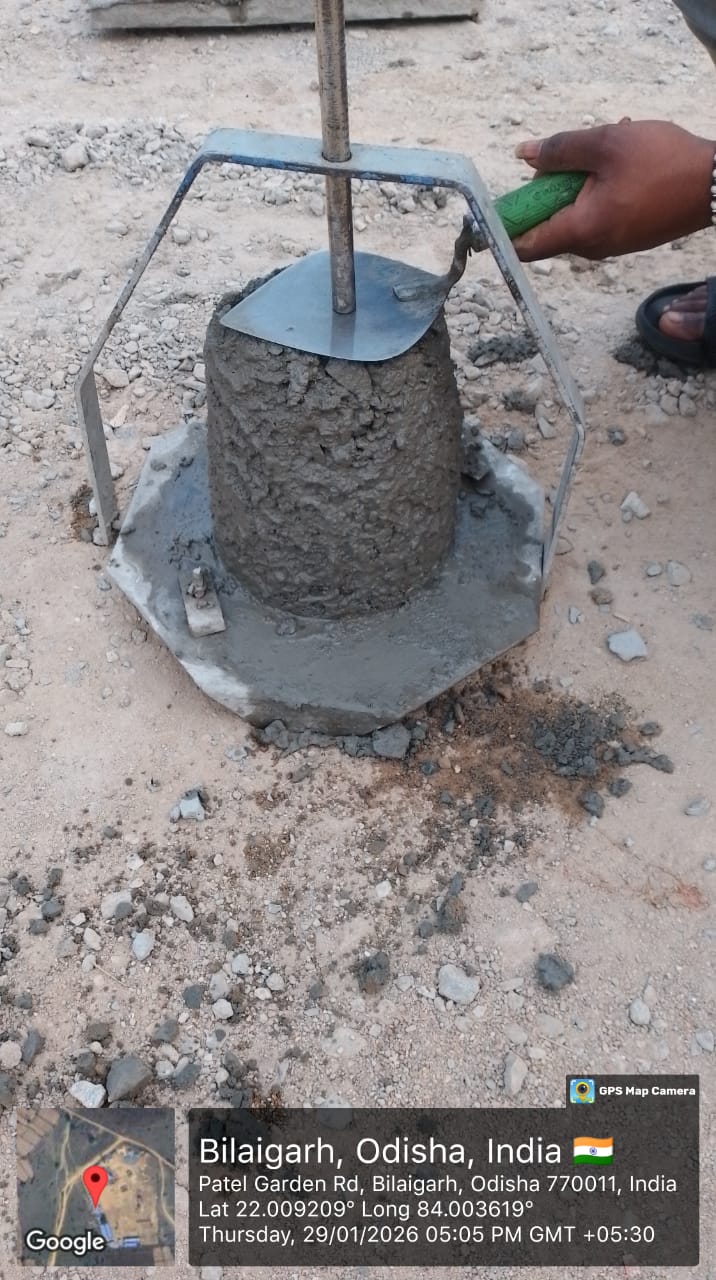

Instream Storage Structure, Khalpal

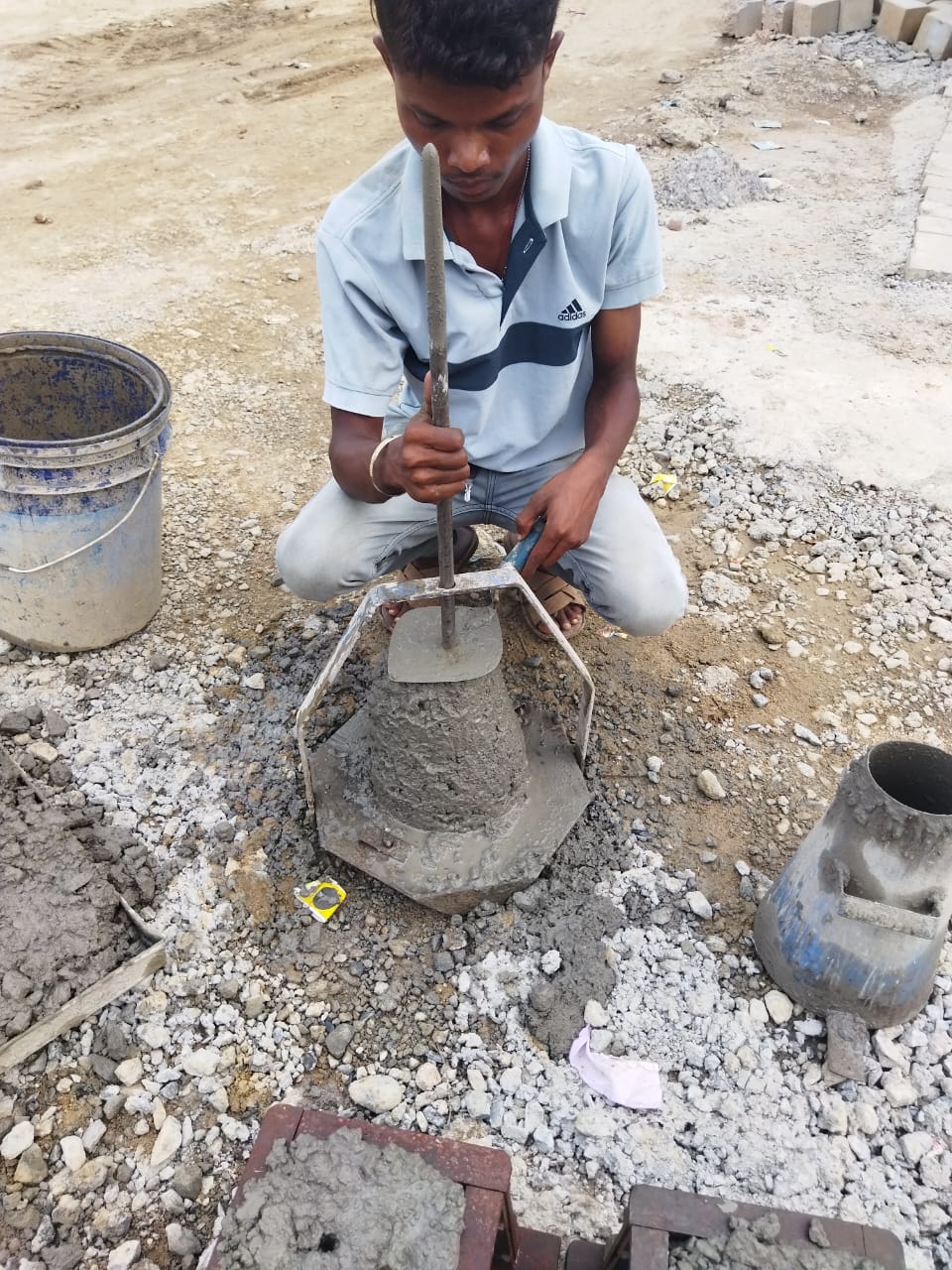

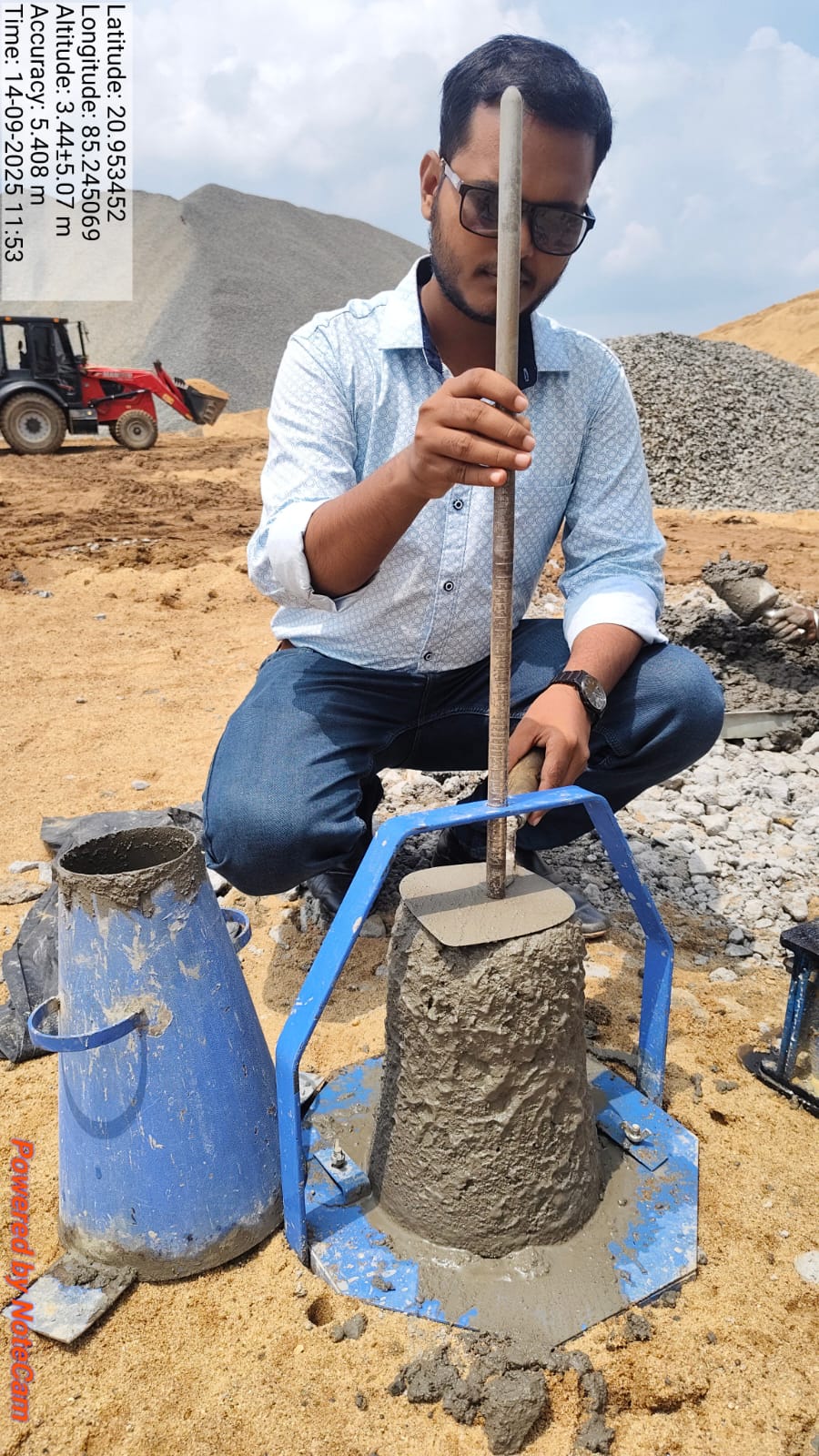

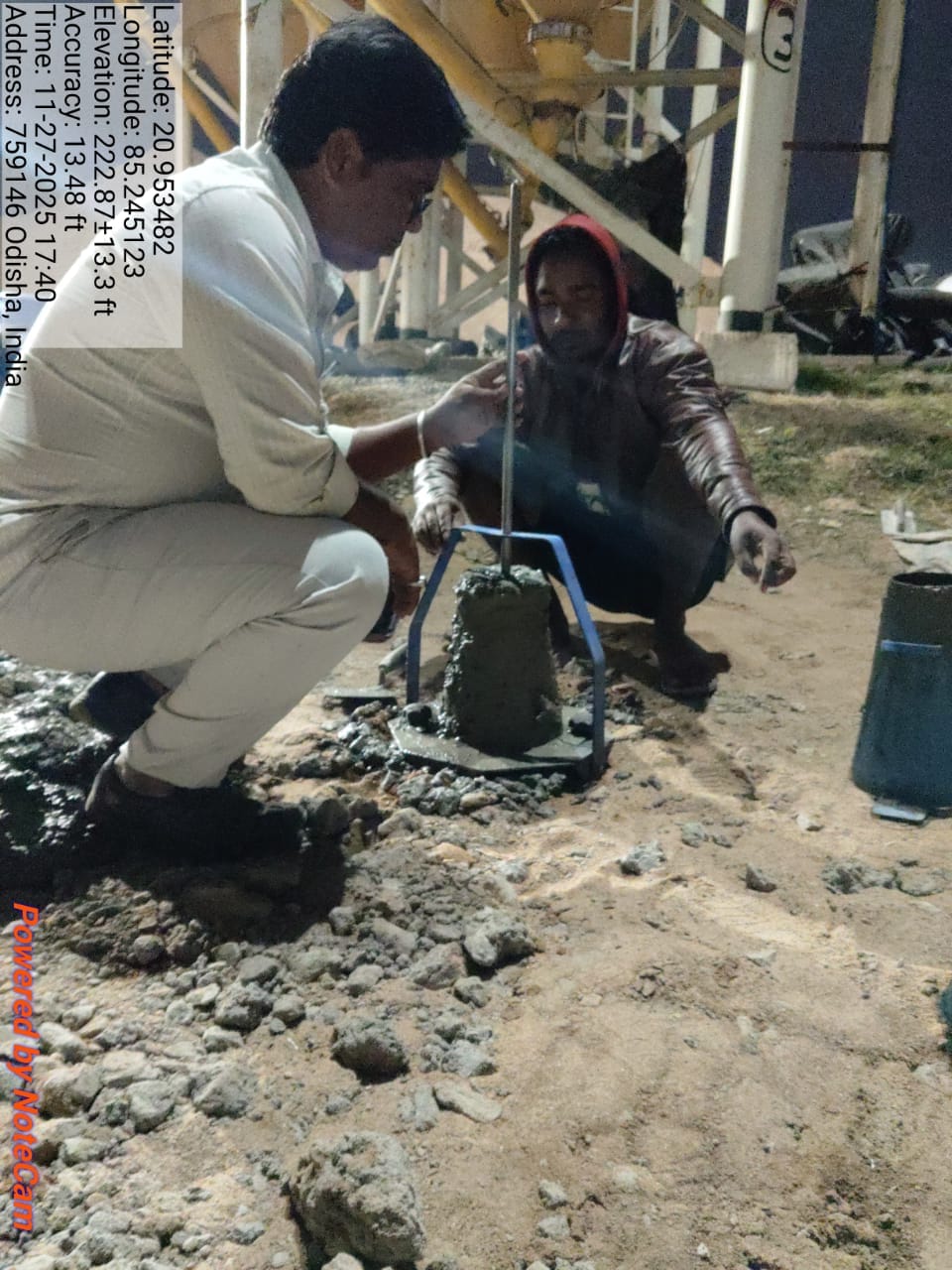

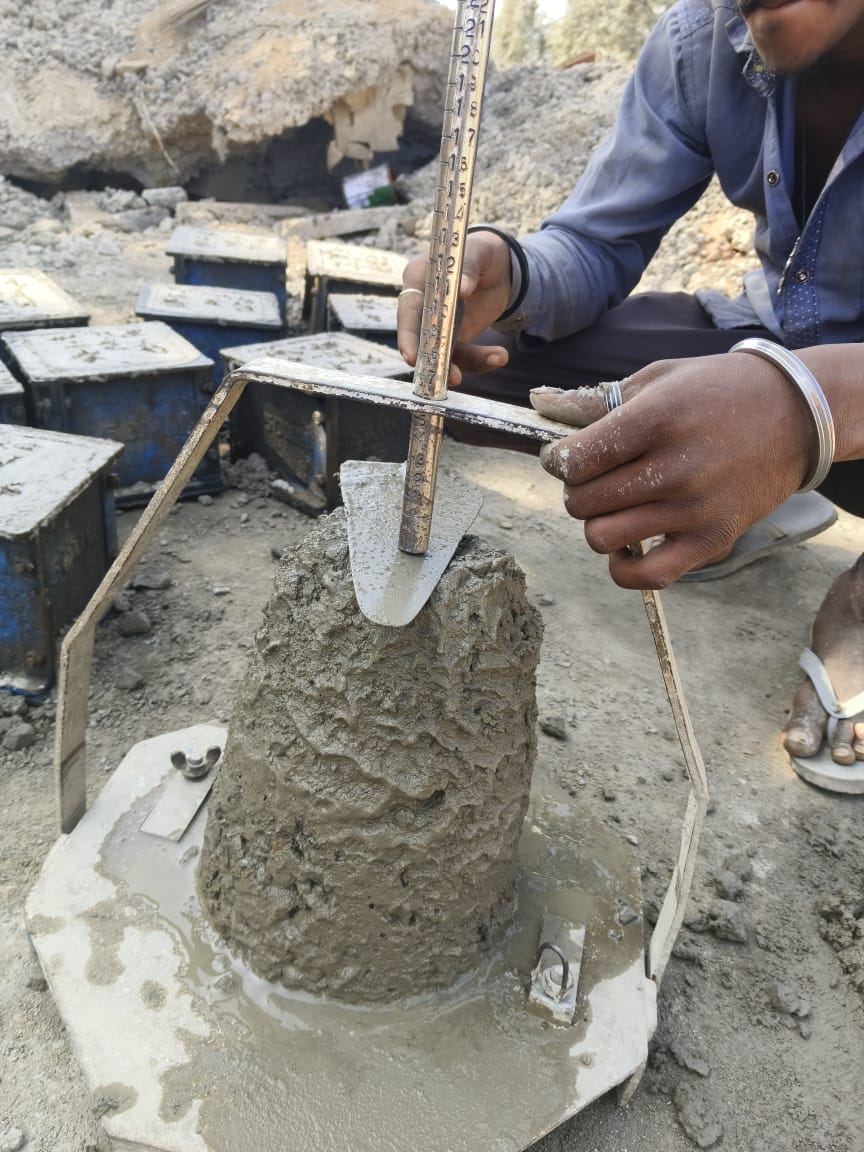

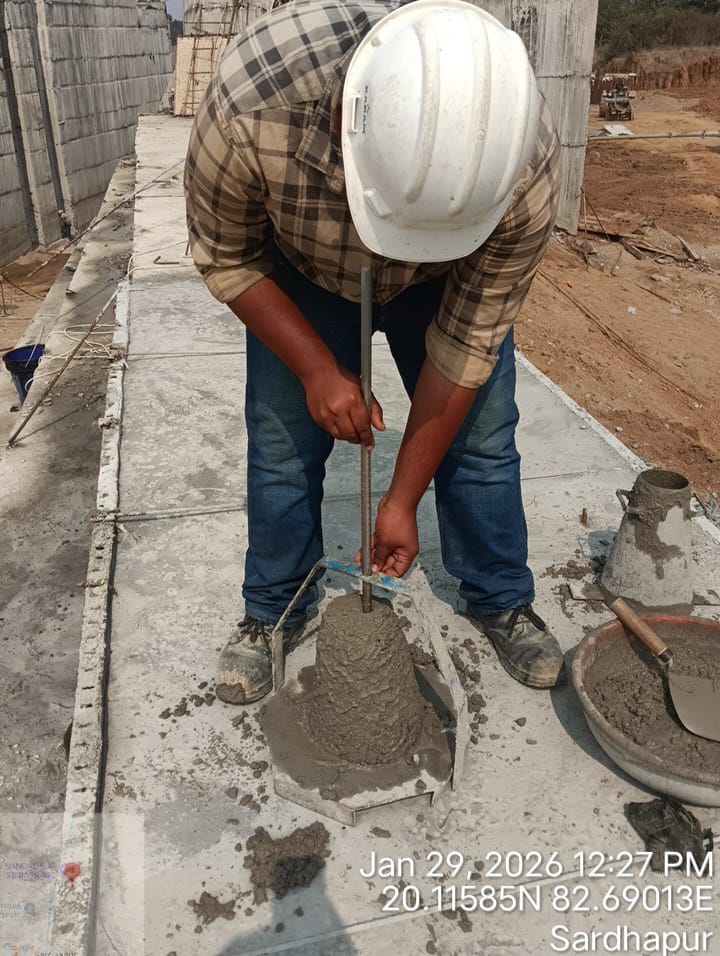

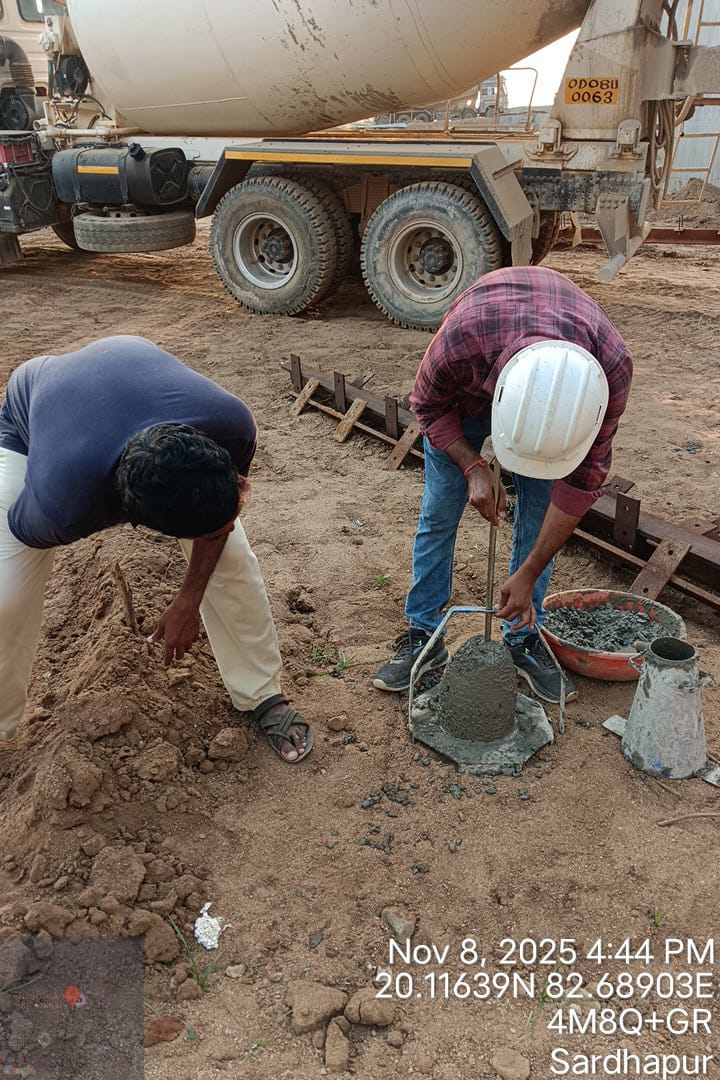

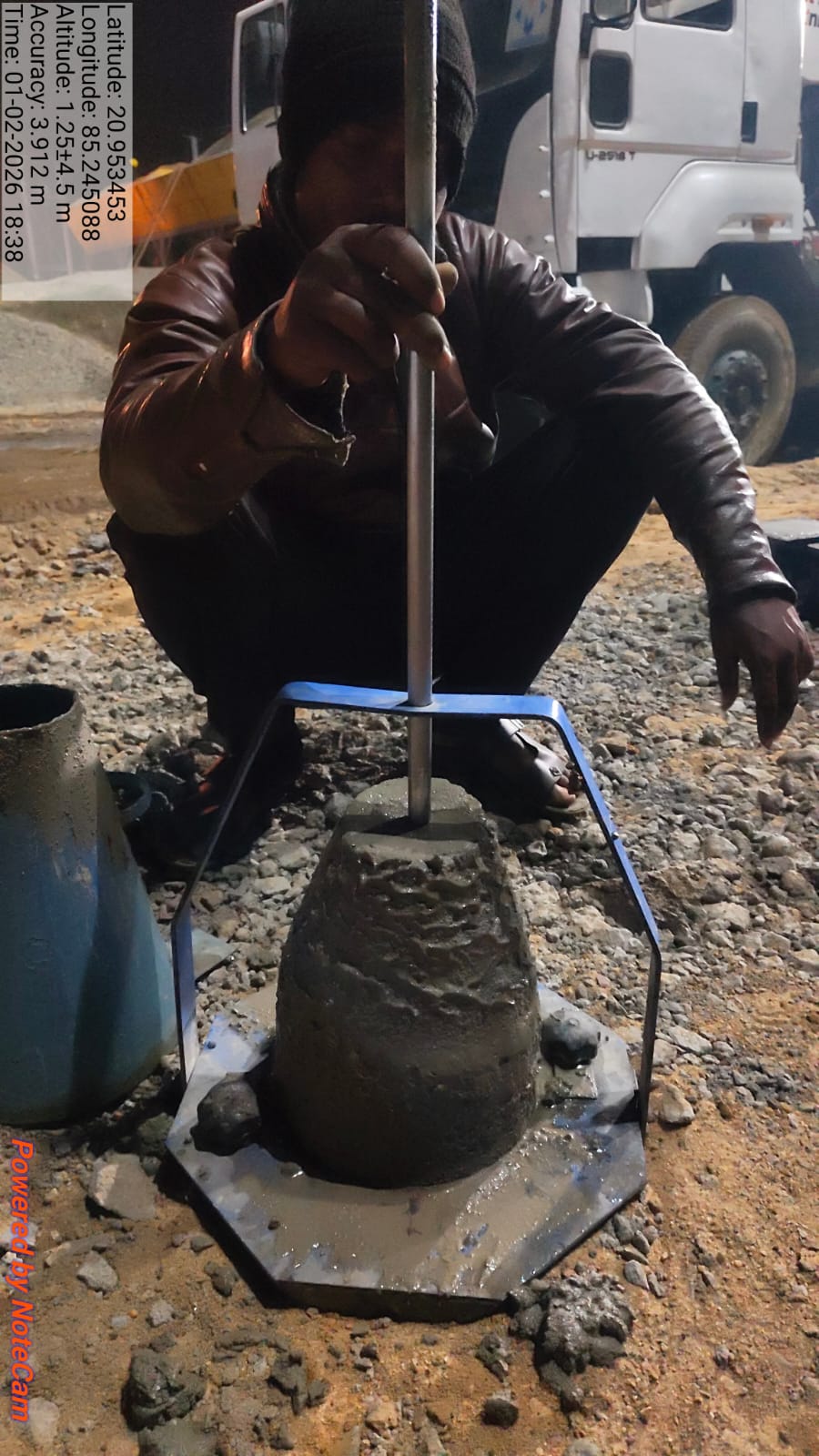

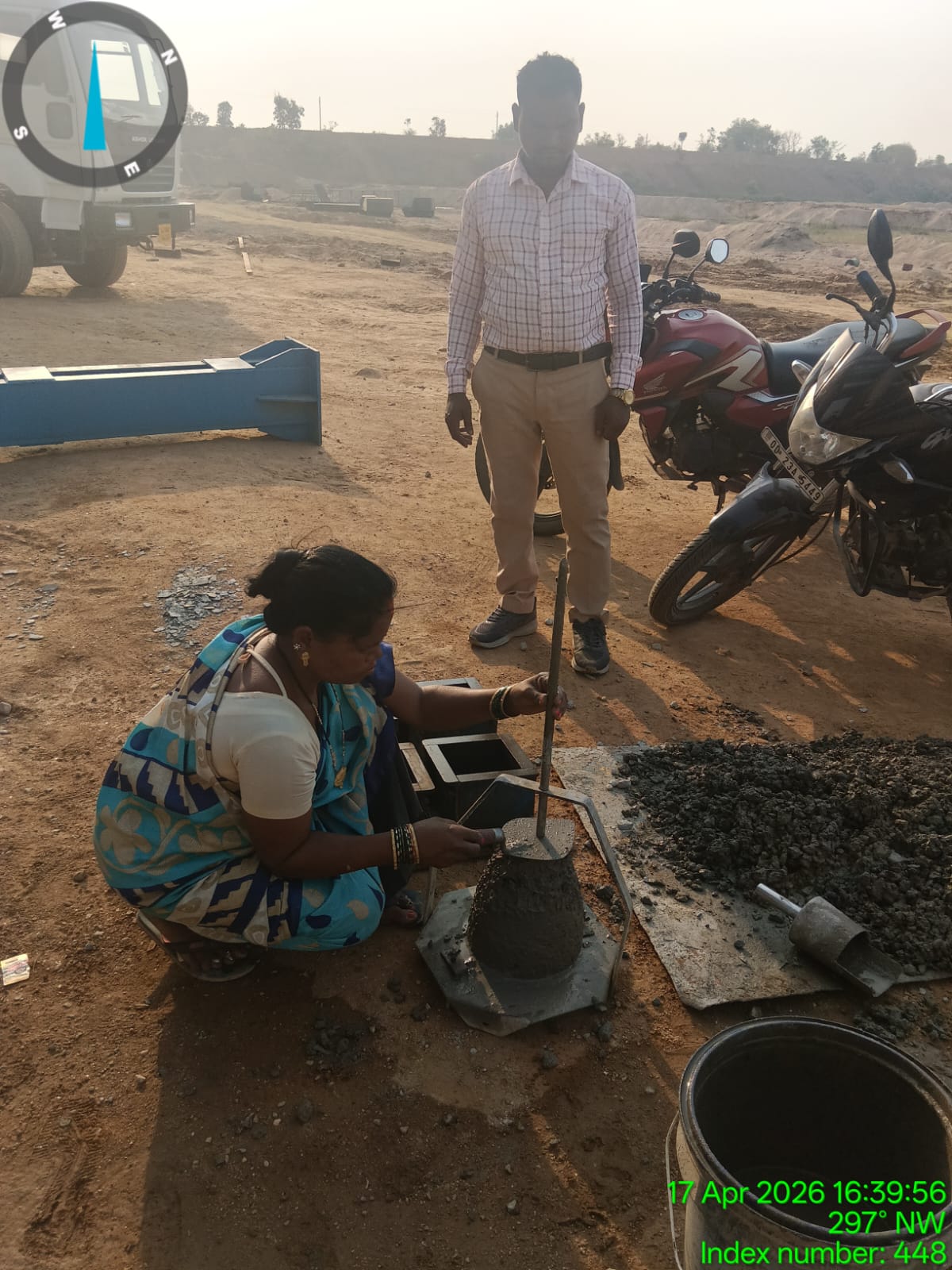

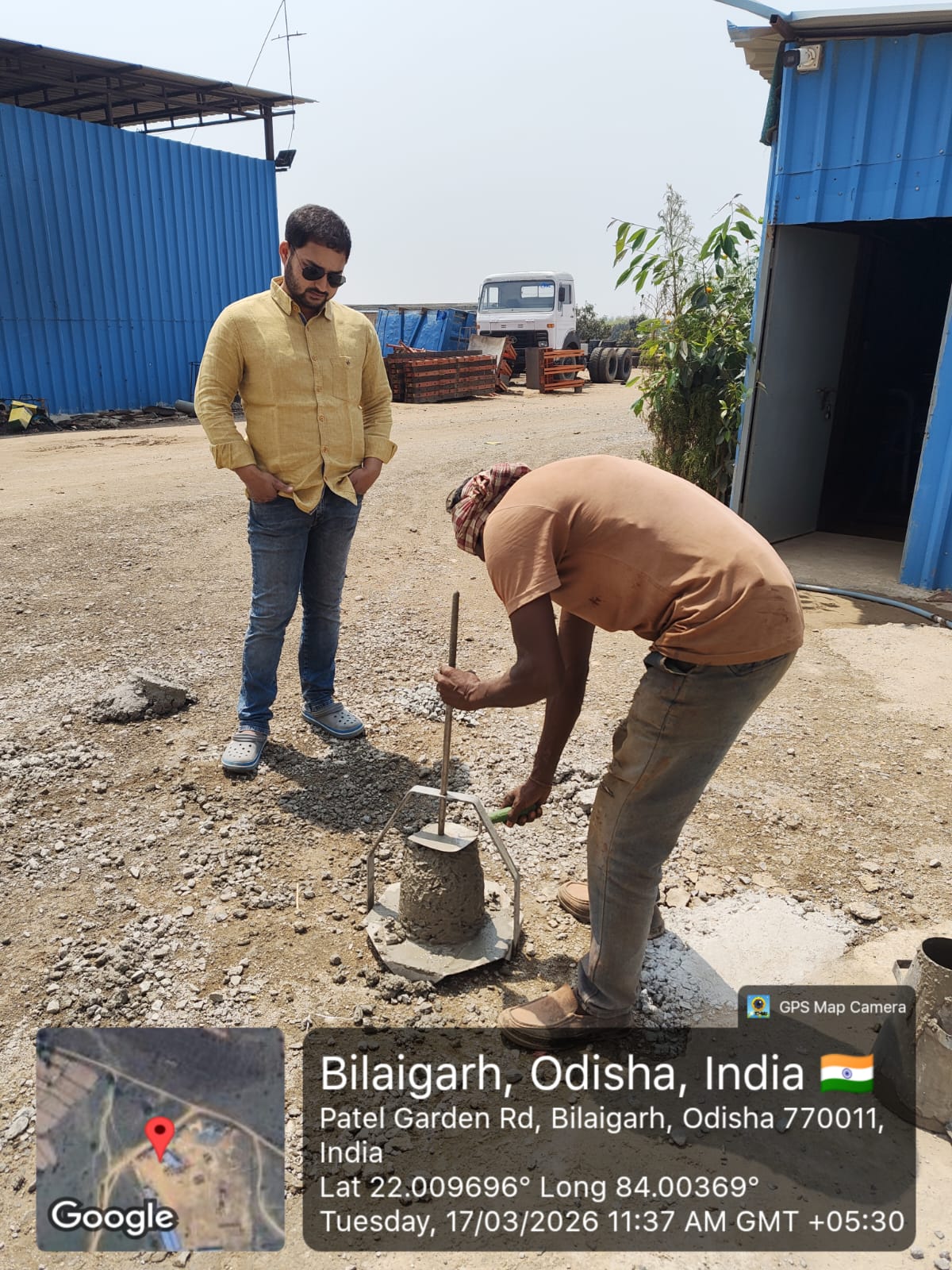

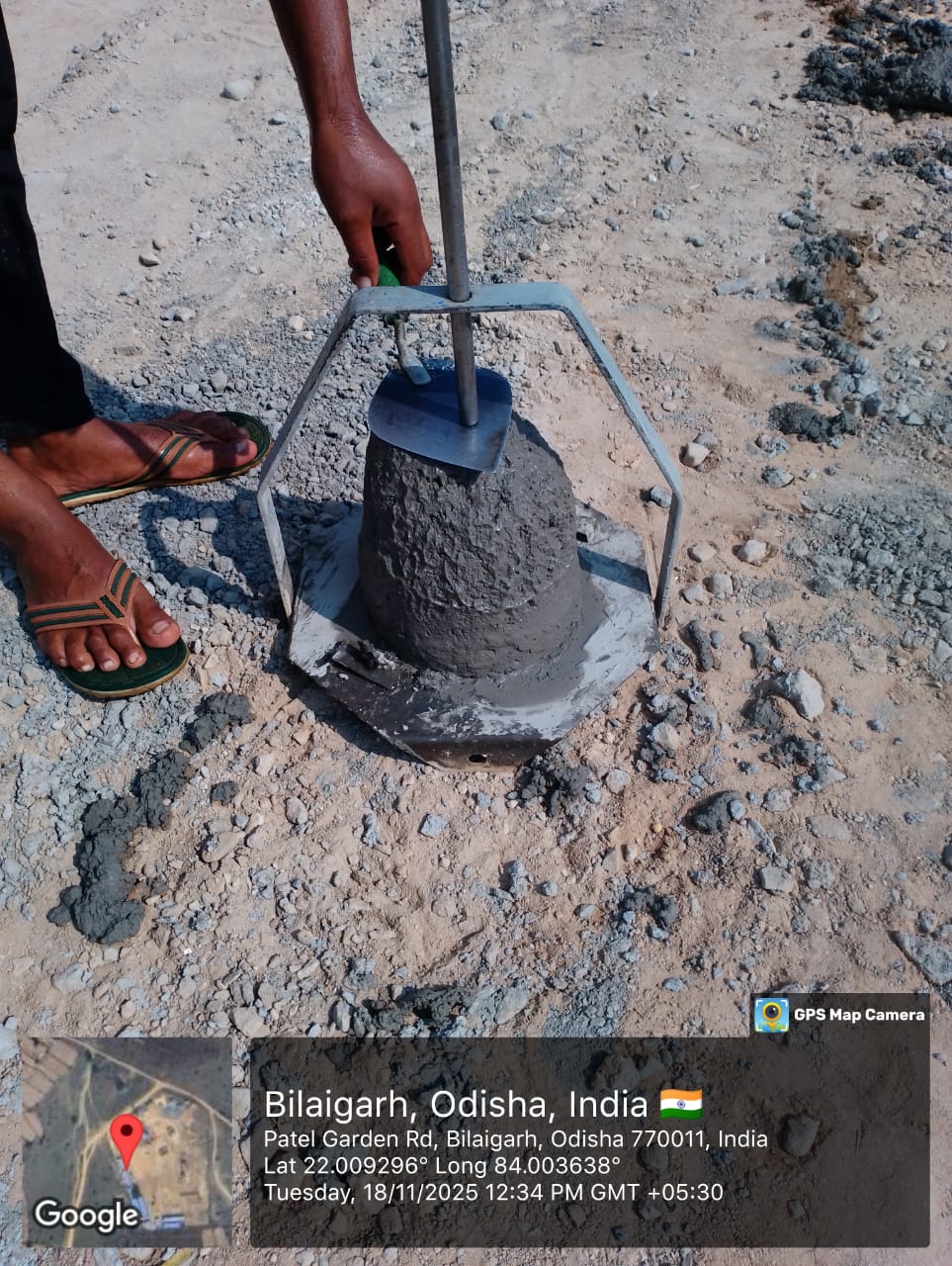

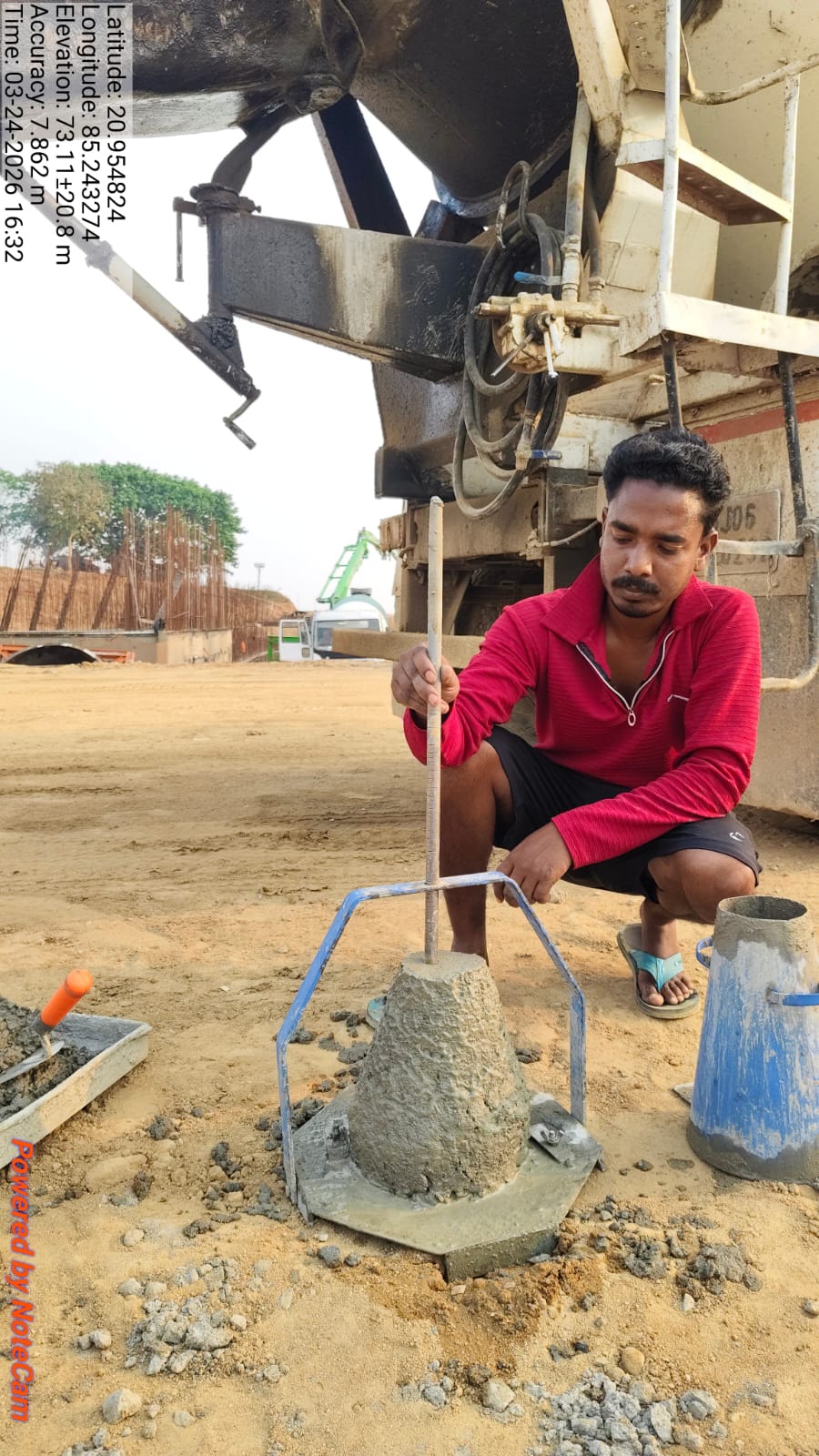

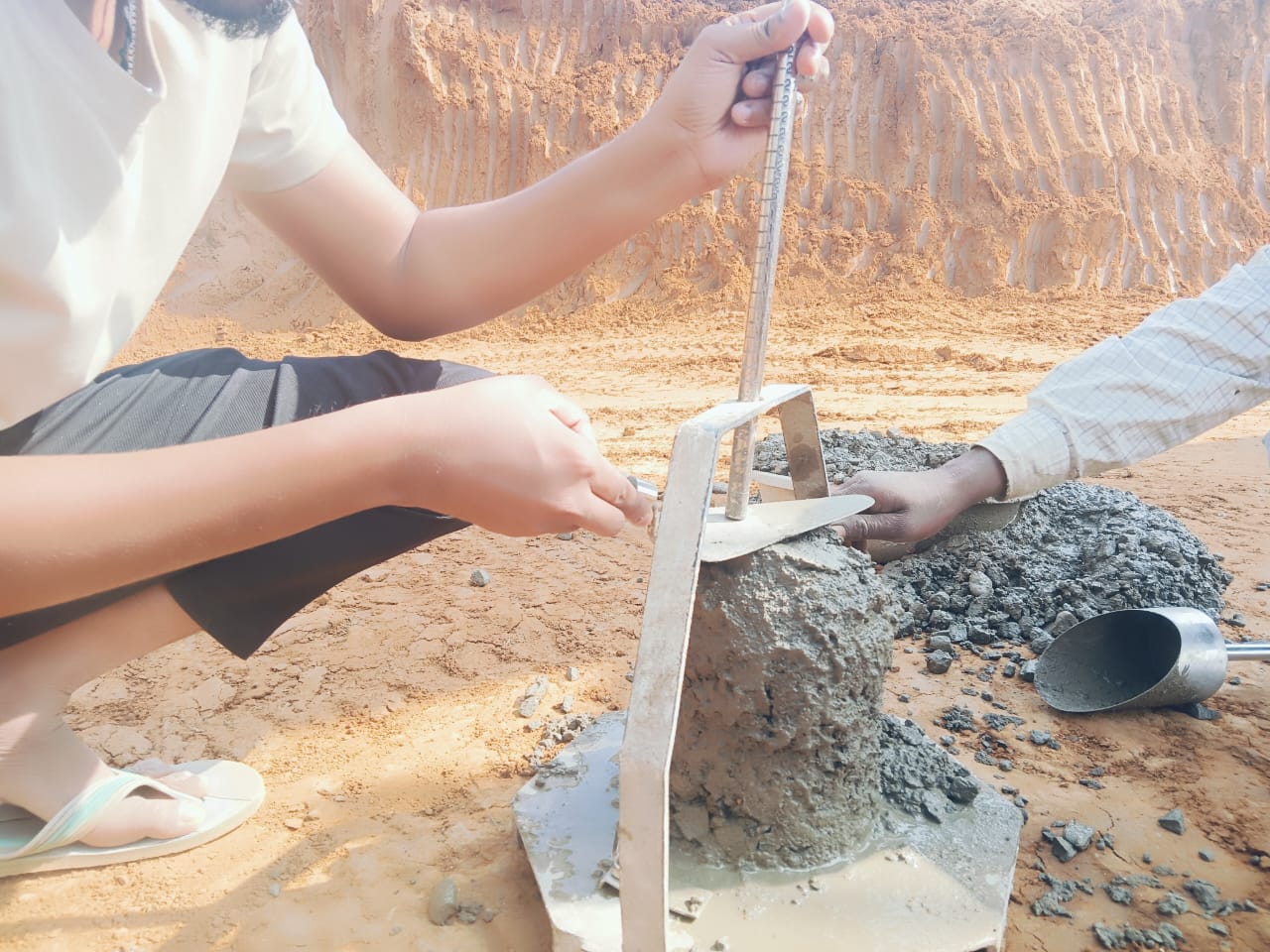

Slump testing M35A20 (Value 80 mm) of Girder No-63 done in presence of Client & PSS Team.
82/100
Instream Storage Structure, Khalpal

Concreting M35A20 of Girder No-63 is under progress in presence of Client & PSS Team.
83/100
Instream Storage Structure, Khalpal
Shuttering of Girder No-63 is under progress.
84/100
Instream Storage Structure, Khalpal
Curing of Girders is under progress.
85/100
Instream Storage Structure, Khalpal
Present flow condition of river at Khalpal site level RL 56.62m.
86/100
Instream Storage Structure, Khalpal
Curing of Girders is under progress.
87/100

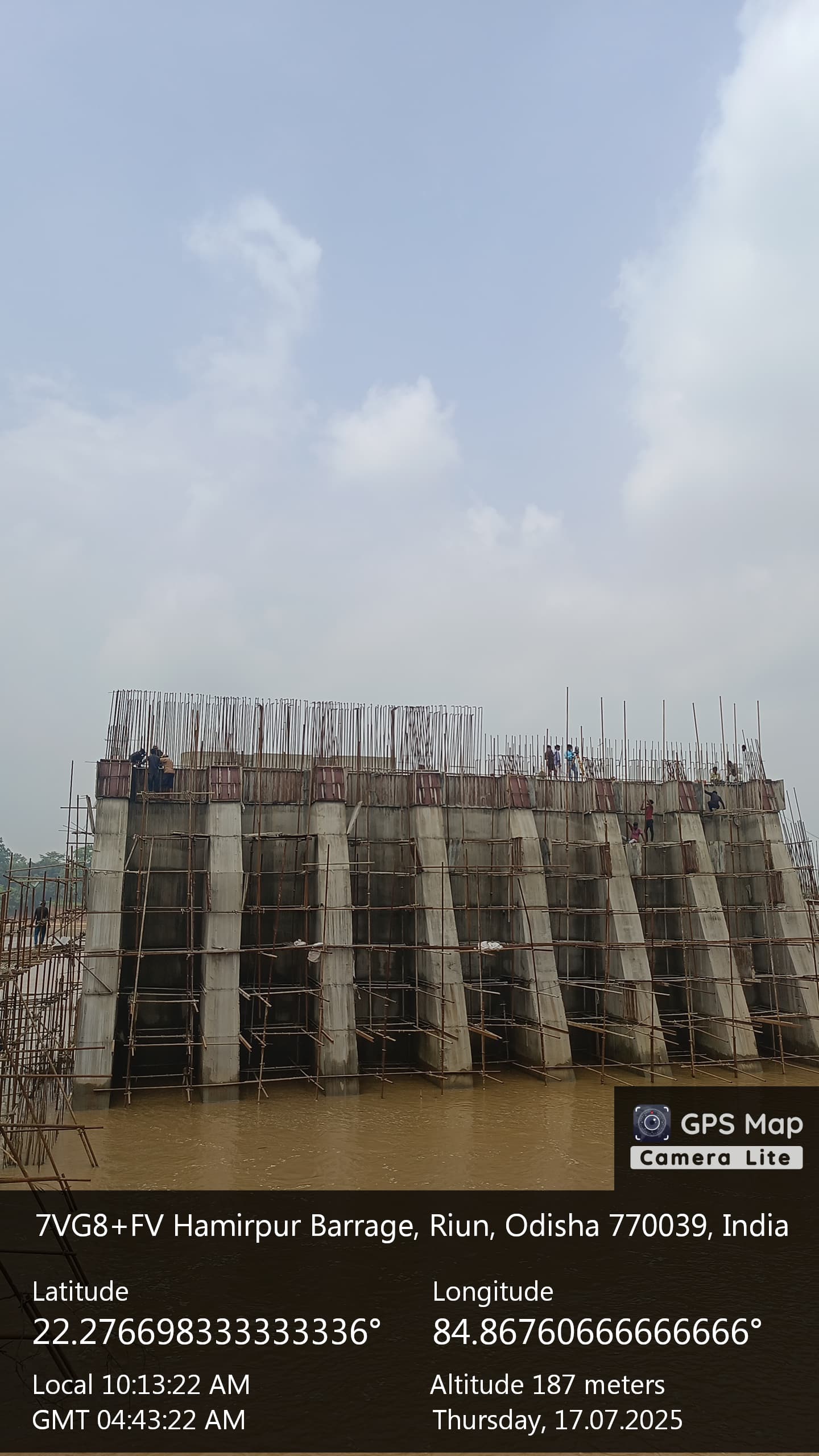

Instream Storage Structure, Hamirpur
Testing of Compressive M25A20 (Strength is 21.93/mm2 for 07 days) of Handling No-27 to 29 and M25A20 (Strength is 21.18/mm2 for 07 days) of Railing beam at Block No-5 has done in presence of Client & PSS team.
88/100
Instream Storage Structure, Hamirpur
Shuttering of D/S Flank wall, 10th lift at Block No-5 is under progress.
89/100
Instream Storage Structure, Hamirpur
Present flow condition of river at Hamirpur site water level RL 179.800m.
90/100
Instream Storage Structure, Khalpal
Slump testing M35A20 (Value 90 mm) of Girder No-62 done in presence of Client & PSS Team.
91/100
Instream Storage Structure, Khalpal
Concreting M35A20 of Girder No-62 is under progress in presence of Client & PSS Team.
92/100
Instream Storage Structure, Khalpal
Curing of Girders is under progress.
93/100
Instream Storage Structure, Khalpal
Present flow condition of river at Khalpal site level RL 56.82m.
94/100

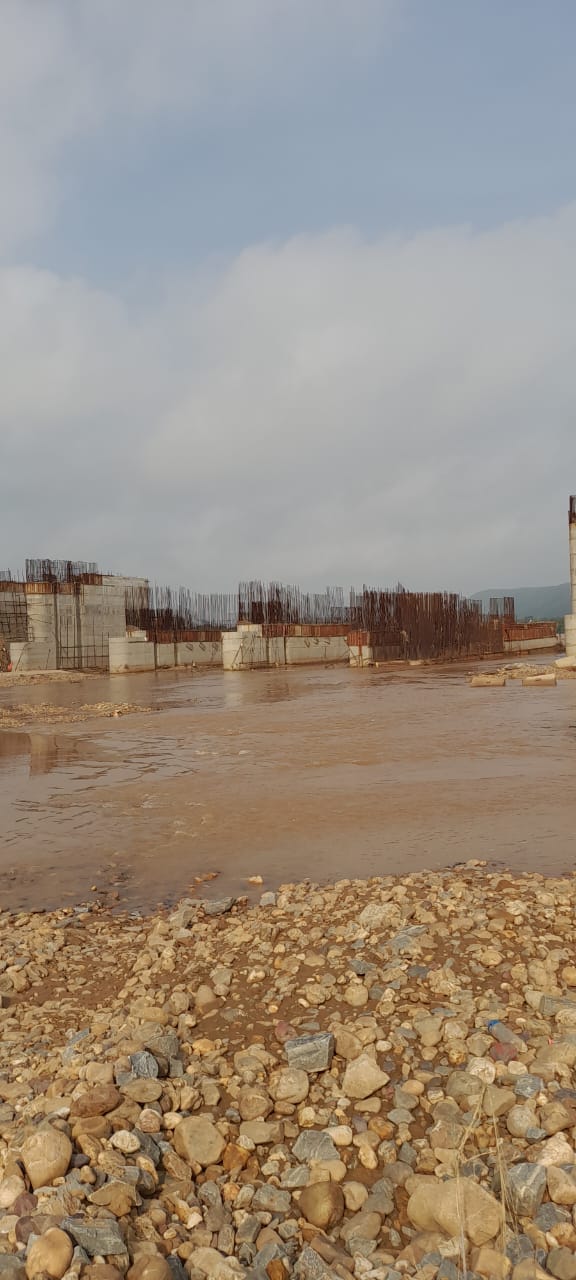

Integrated Barrage across river Kochila and across river Baitarini

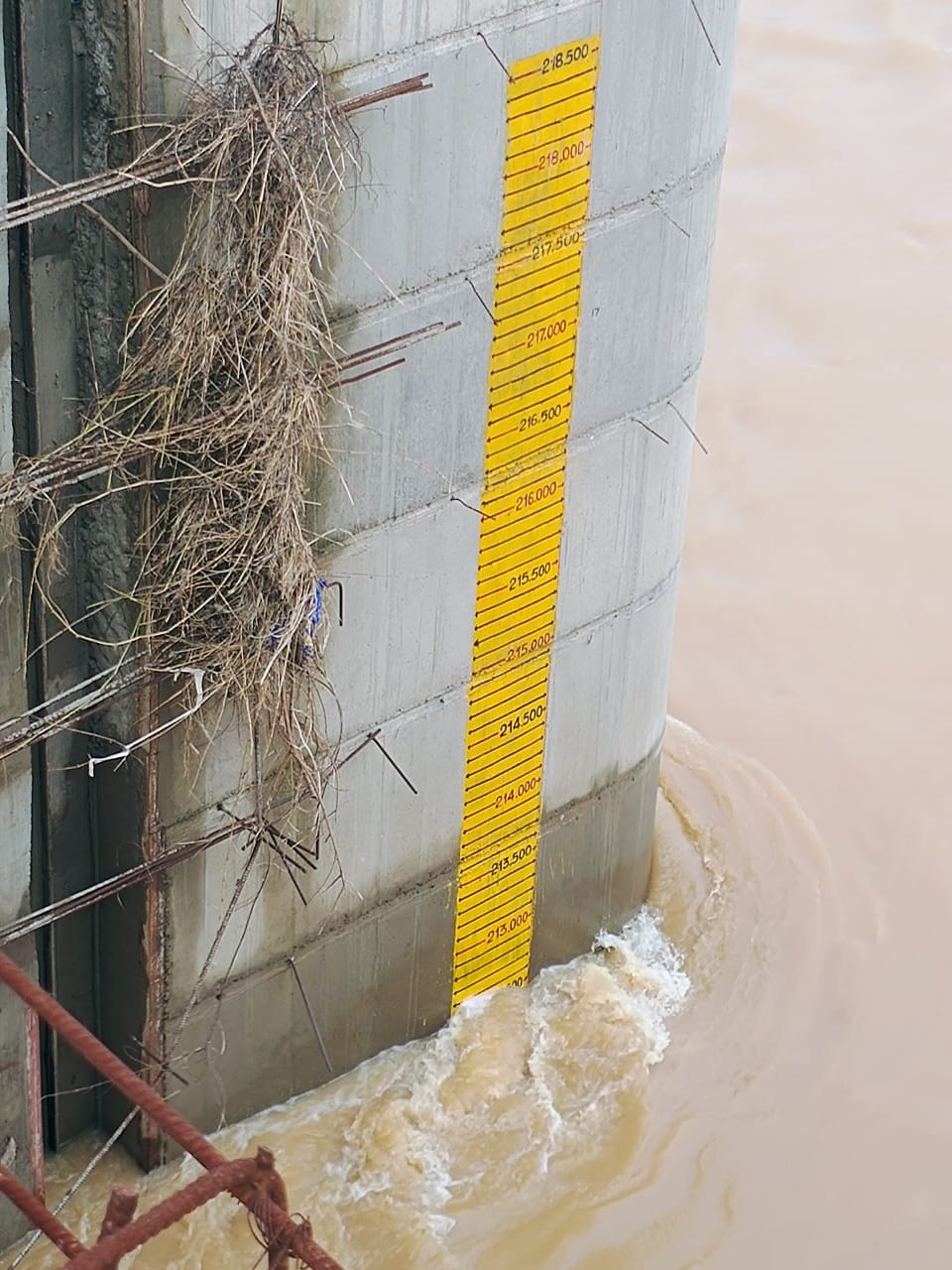

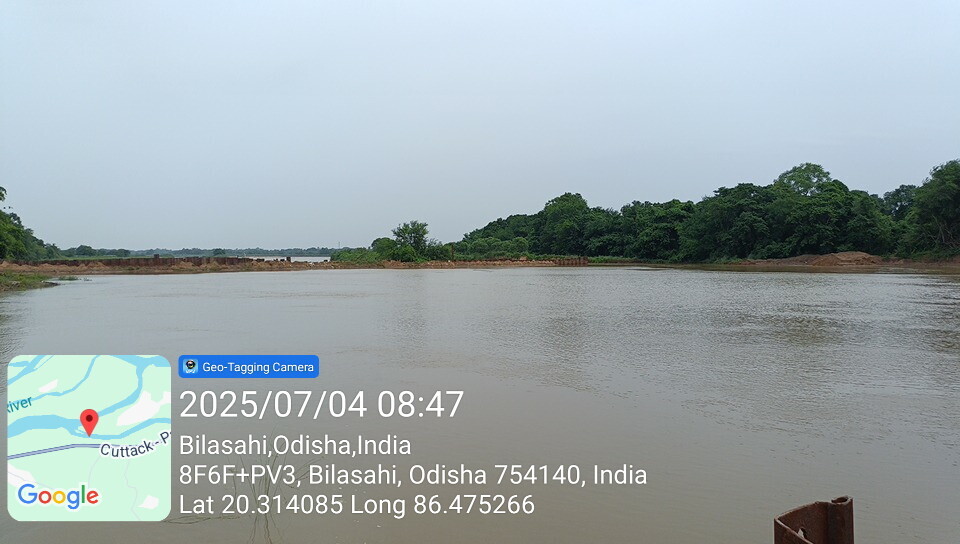

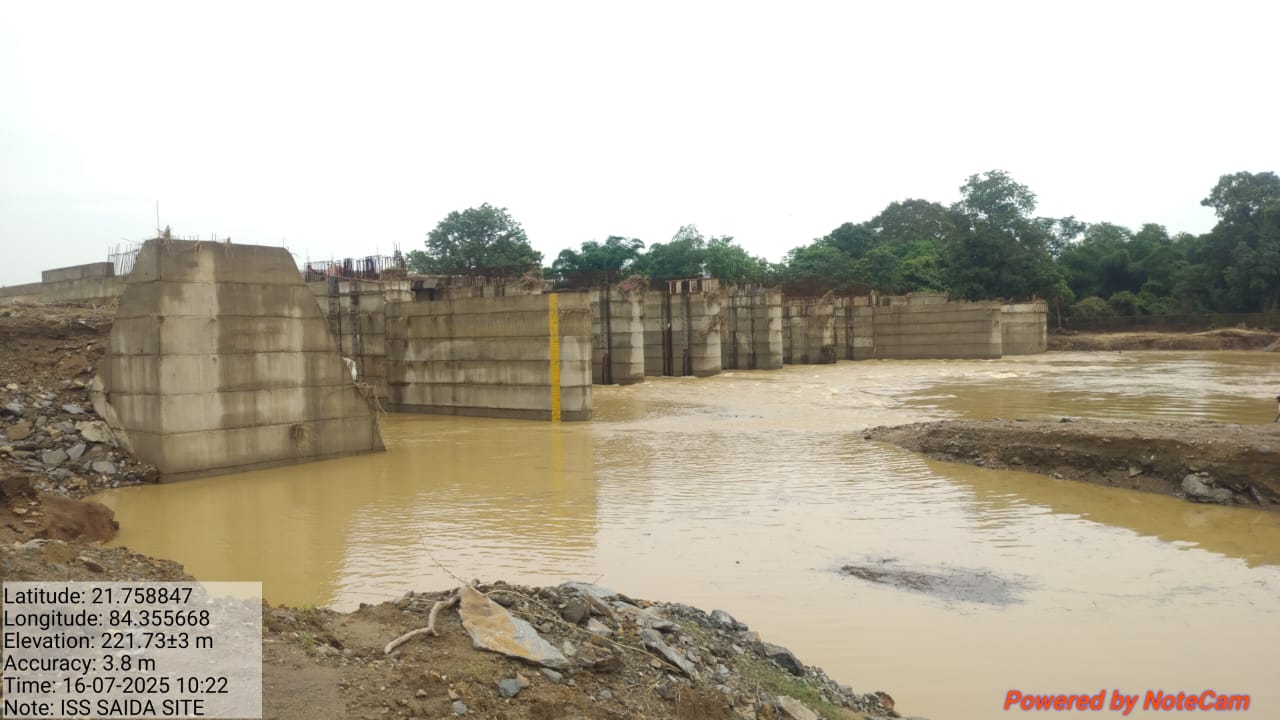

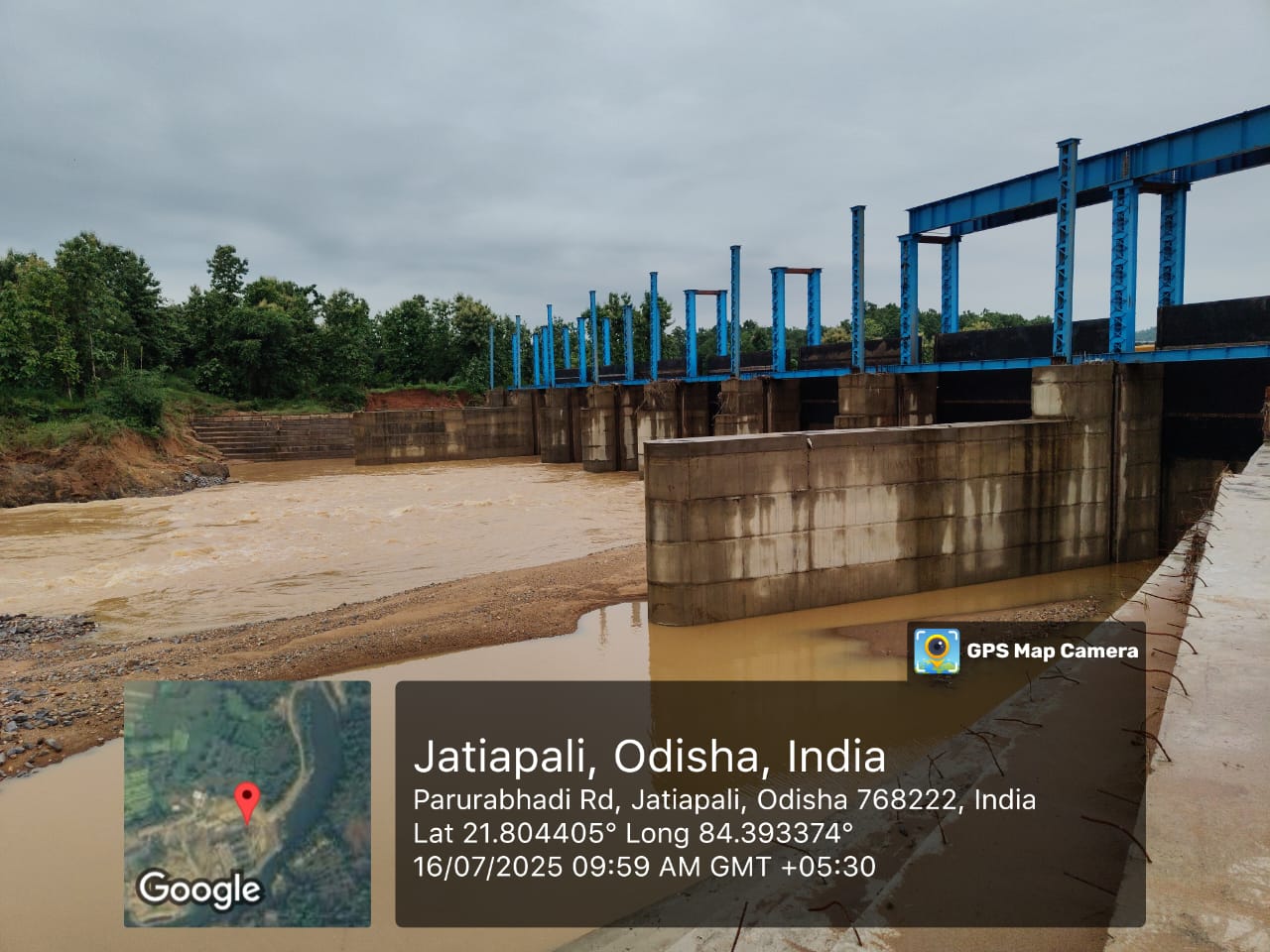

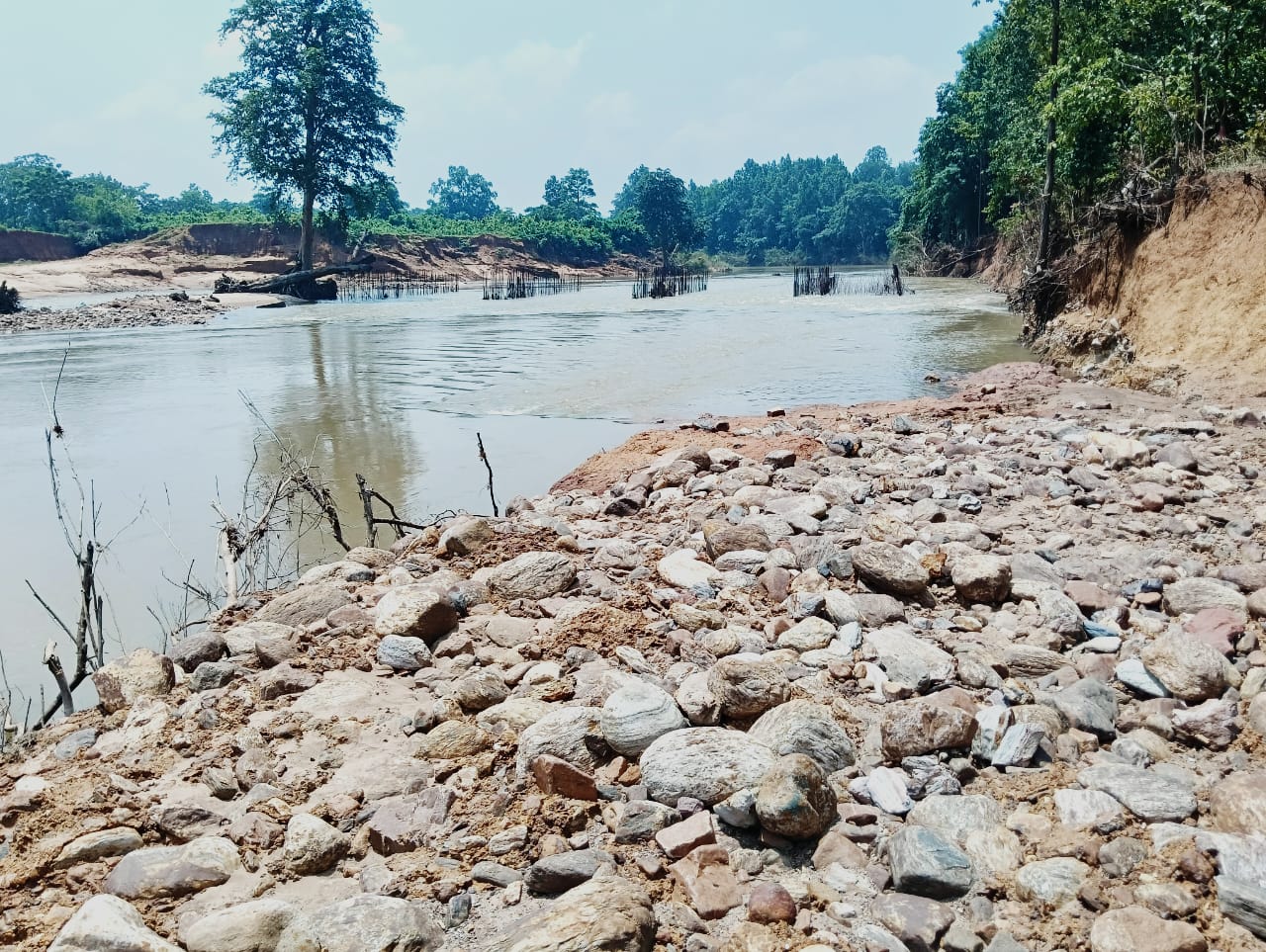

Baitarani ISS water level is 7.40m.
95/100
Integrated Barrage across river Kochila and across river Baitarini
Baitarani ISS water level is 6.10m.
96/100
Integrated Barrage across river Kochila and across river Baitarini

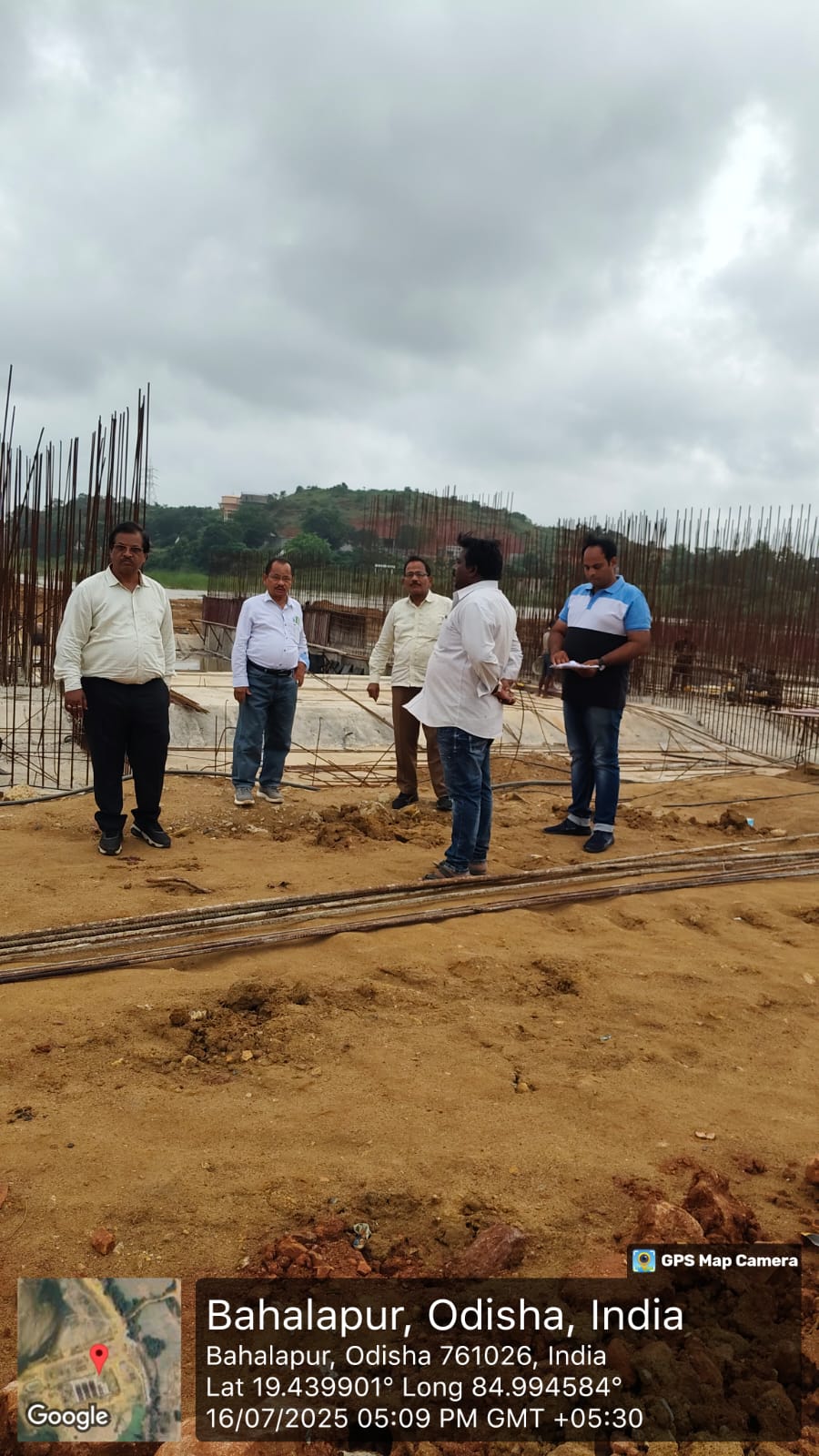

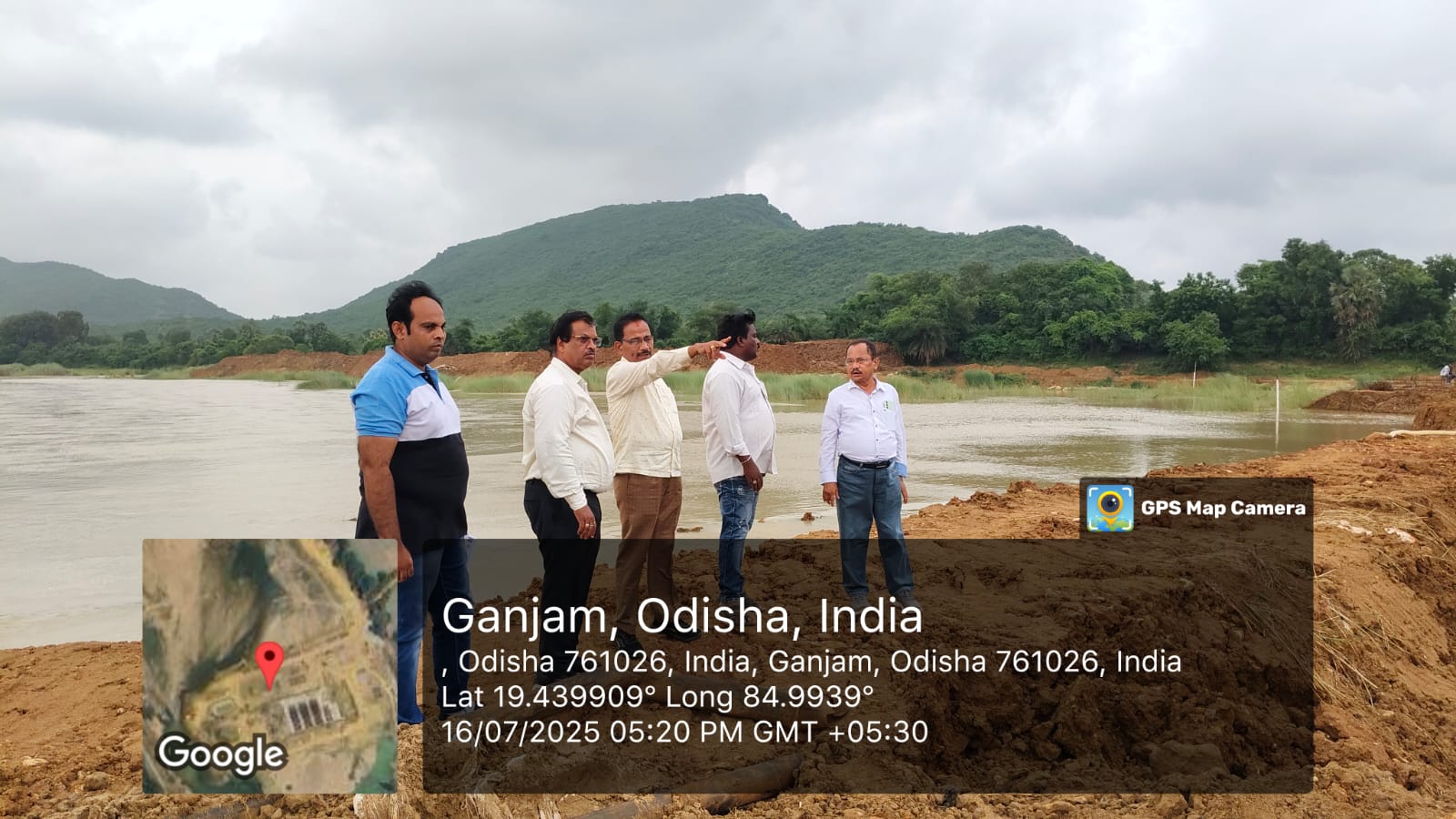

C.E.,Designs,CE MBBS,Chandikhole,S.E.,AEE,AE of Akhuapada Irrigation Division,PMC team visited Baitarani ISS.
97/100
Integrated Barrage across river Kochila and across river Baitarini
Baitarani ISS water level is 6.10m
98/100
Integrated Barrage across river Kochila and across river Baitarini

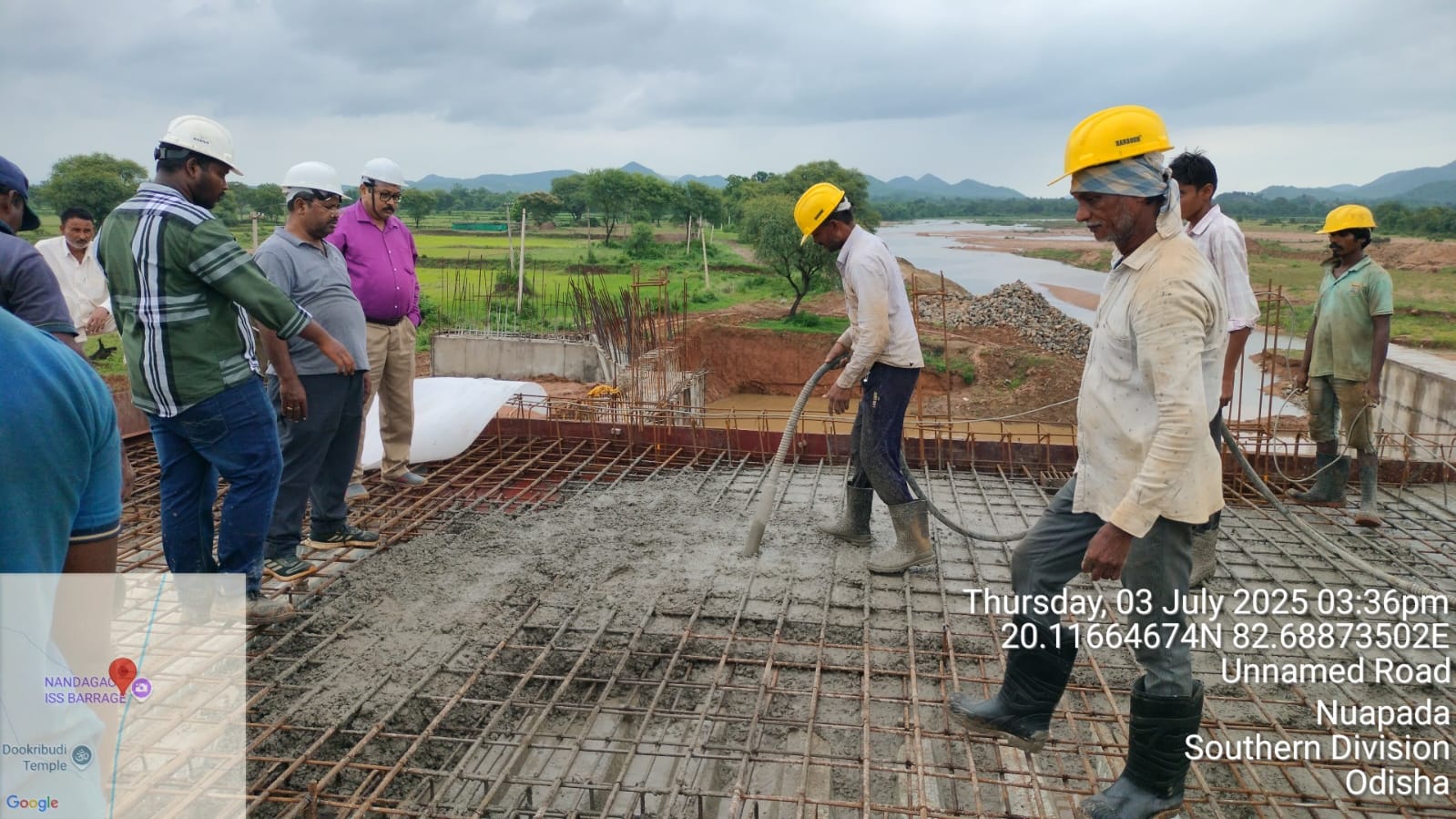

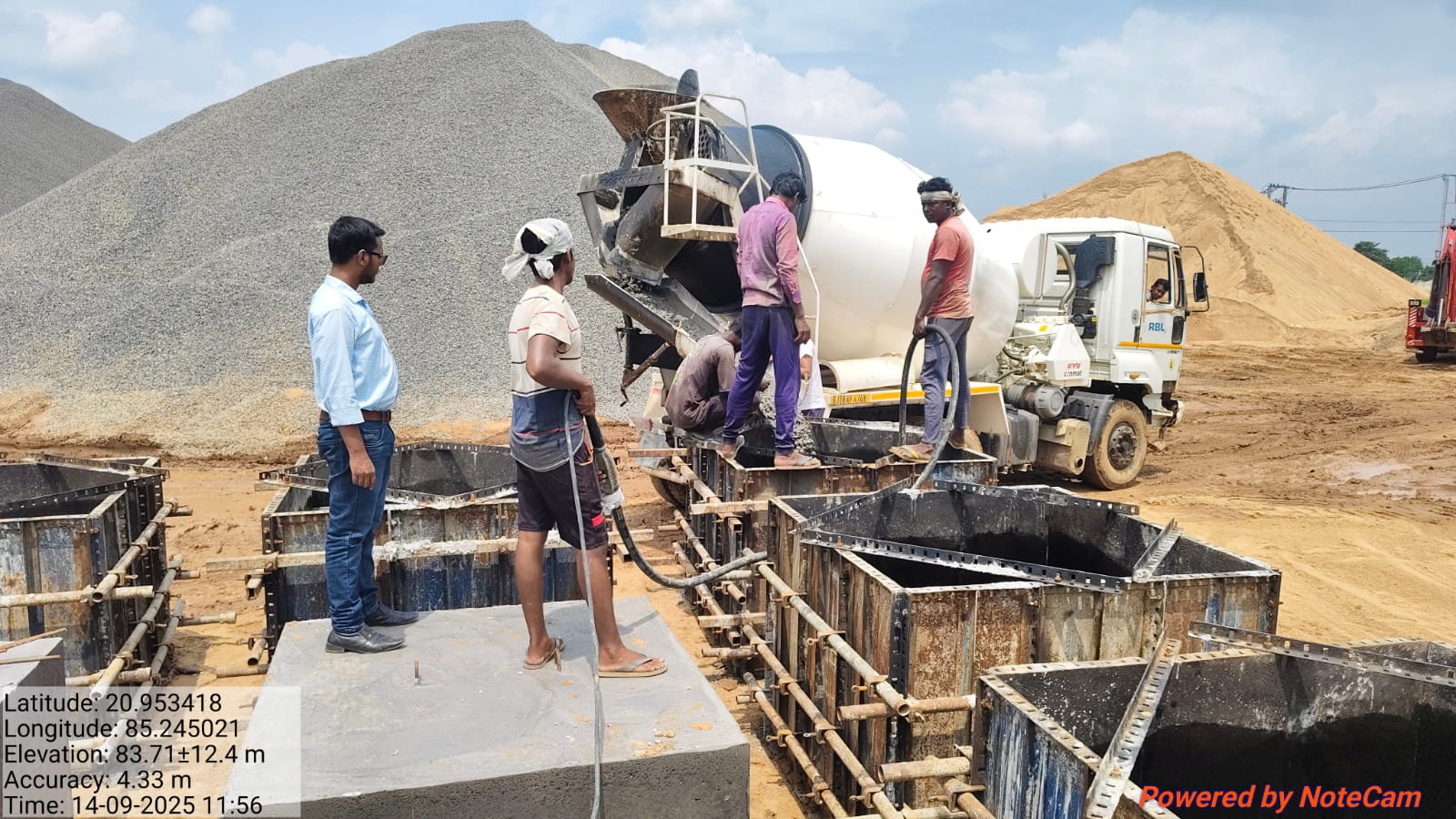

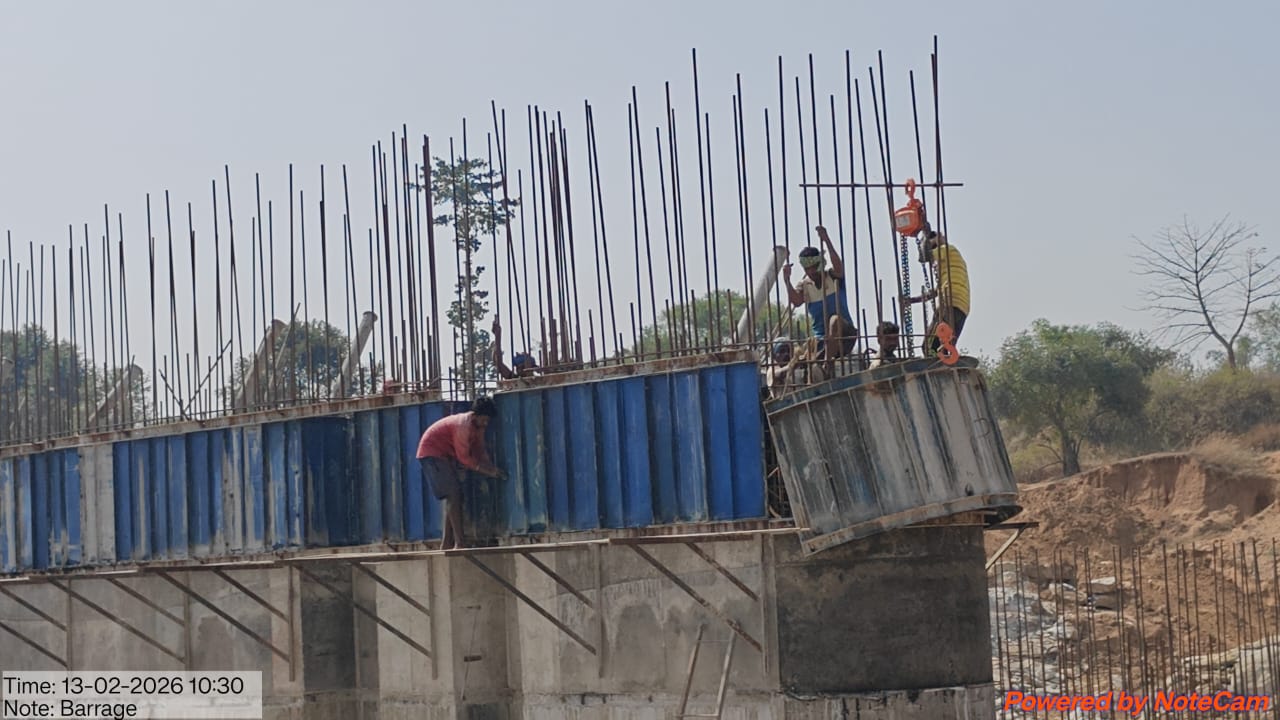

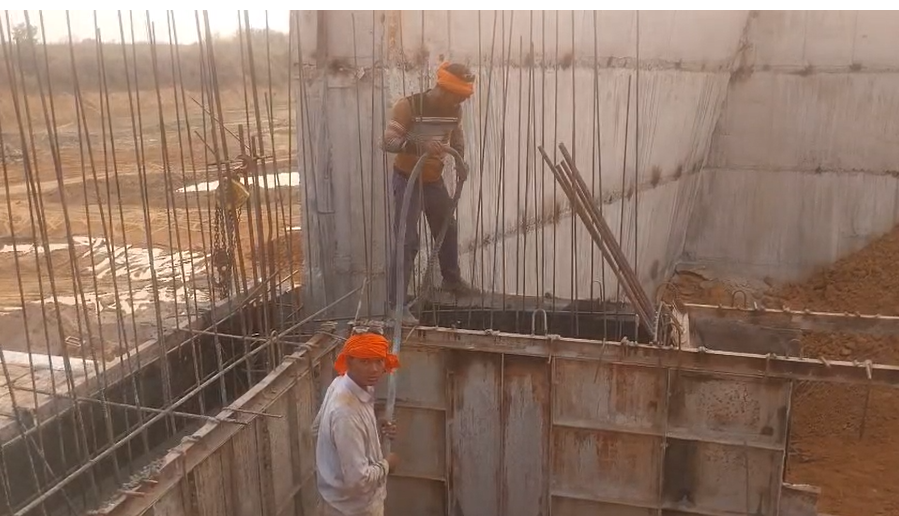

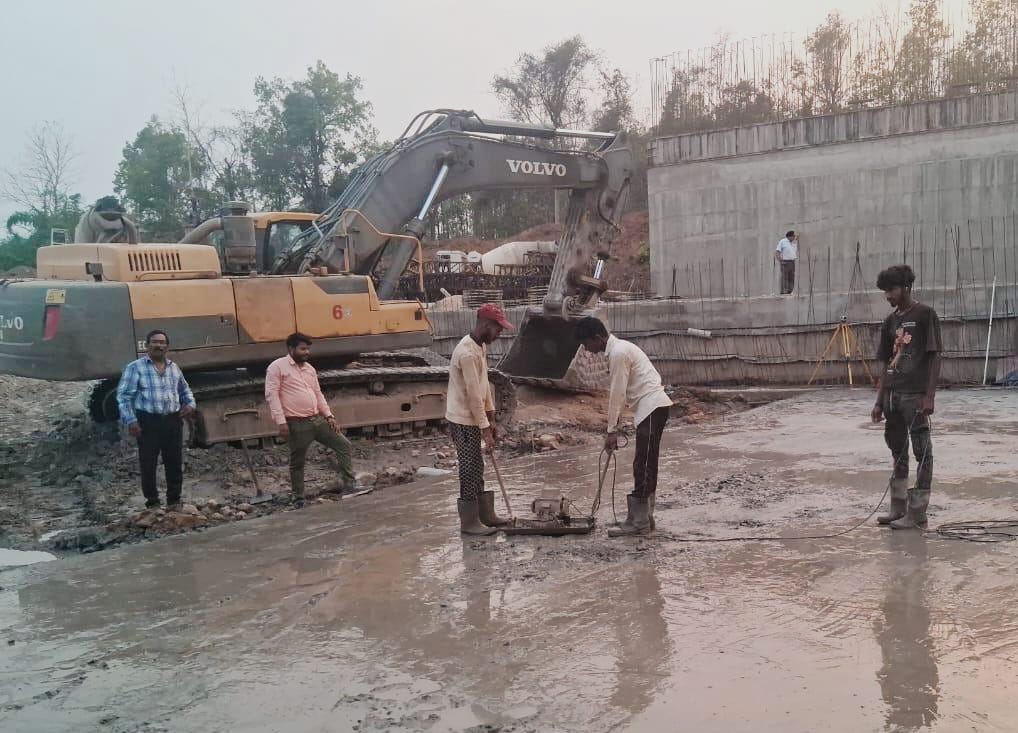

CC Block casting work at Baitarani ISS is in progress.
99/100
Integrated Barrage across river Kochila and across river Baitarini
Baitarani ISS water level is 6.30m.
100/100
Integrated Barrage across river Kochila and across river Baitarini
CC Block casting work at Baitarani ISS is in progress.
